Scaling agile with

Portfolio for Jira
BREE DAVIES | PRODUCT MANAGER | @BREEDAVIES
Scaled agile feels
Source: Shutterstock
It’s not just

about tools;

it’s about
people*
THE STORY OF A SCALED AGILE JOURNEY
*but tools help a bunch
Agenda
Keep Jira simple
Optimise your hierarchy for comms
Plan to plan
Takeaways
Agenda
Why should I scale agile?
Keep Jira simple
Optimise your hierarchy for comms
Plan to plan
Takeaways
How did a fast-growing

auto insurance company

scale their agile operations?
Source: Shutterstock

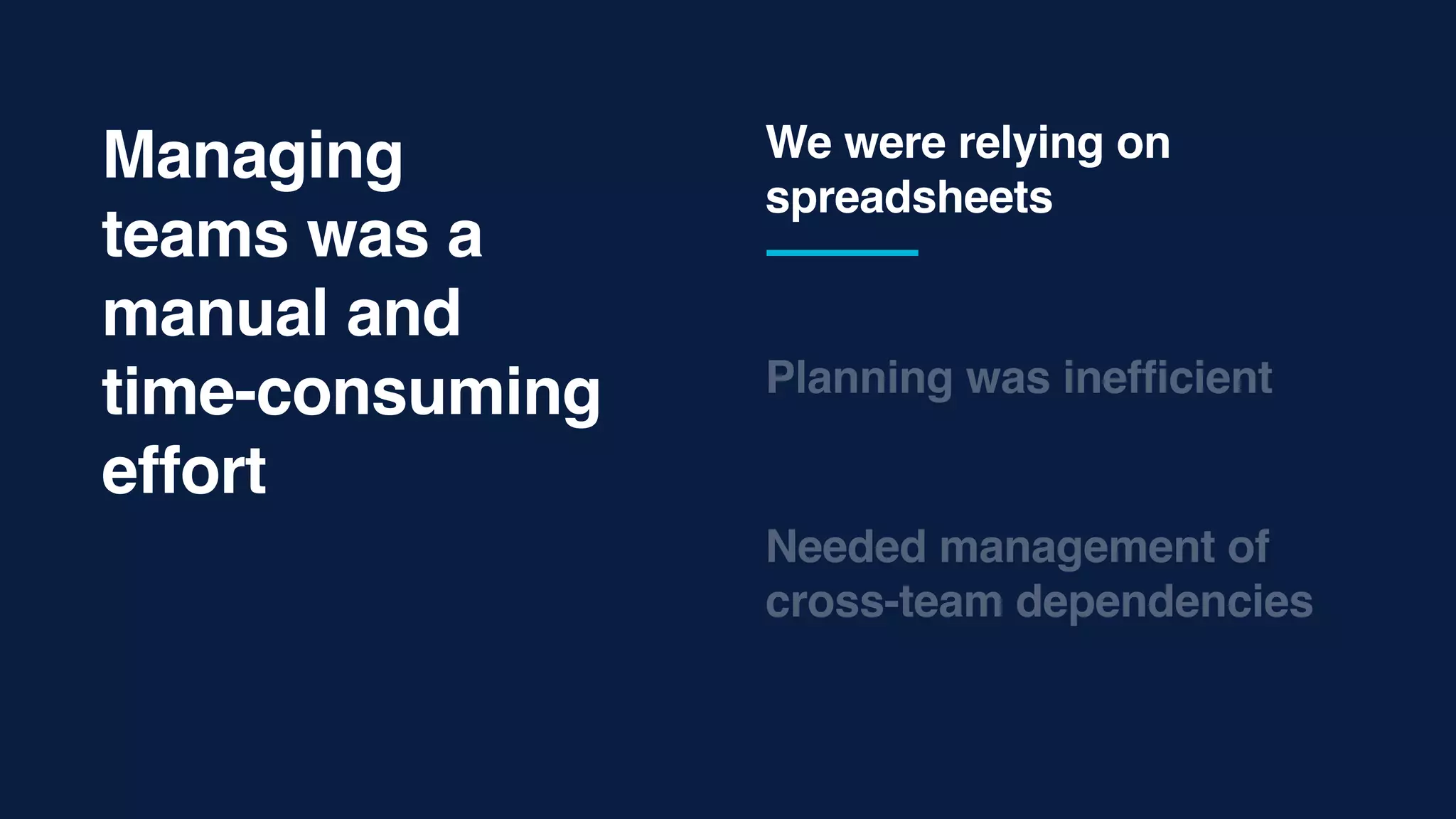

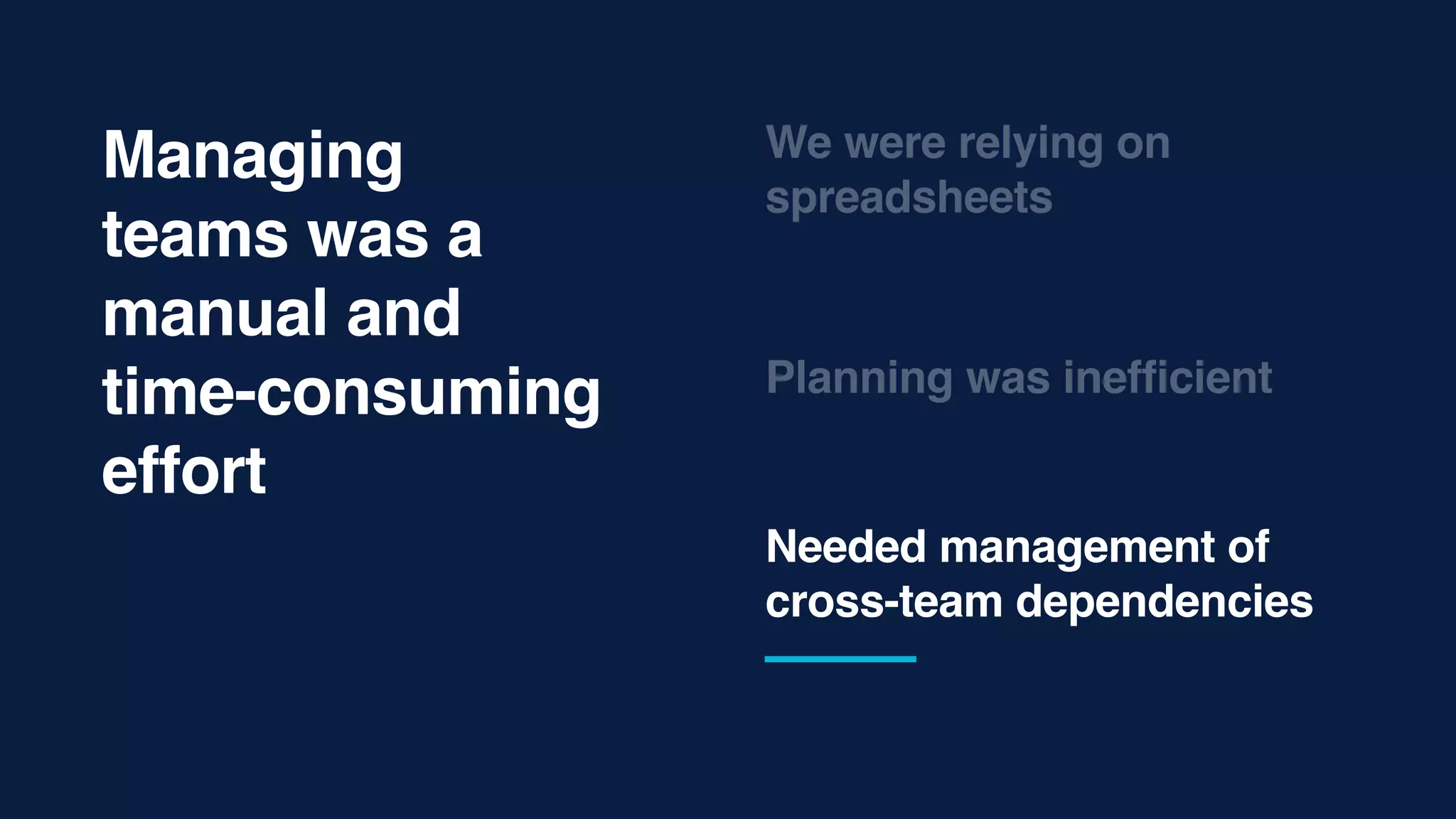

Needed management of
cross-team dependencies
Planning was inefficient
We were relying on
spreadsheets

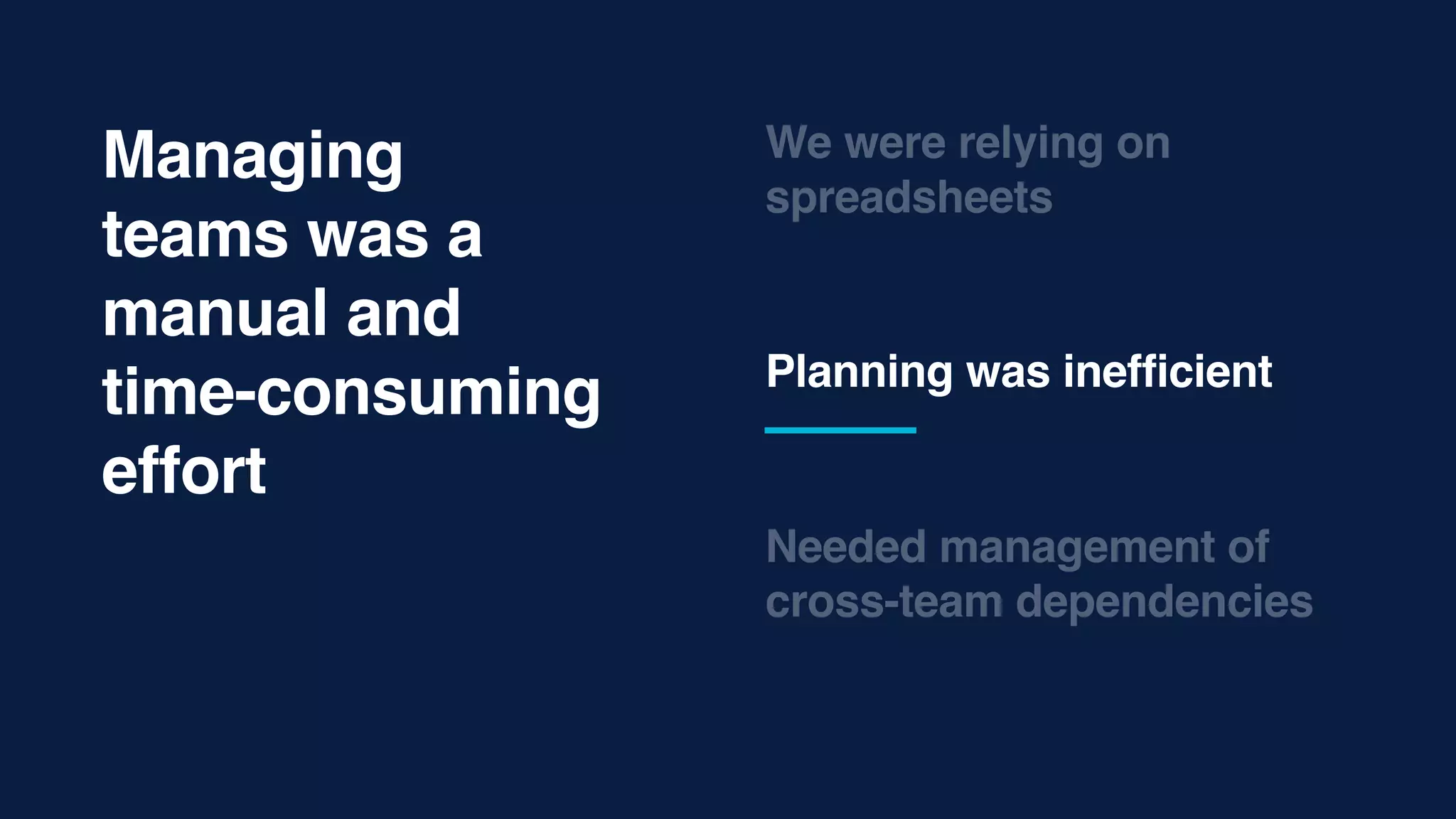

Managing
teams was a
manual and
time-consuming
effort
Needed management of
cross-team dependencies
Planning was inefficient
We were relying on
spreadsheets
Managing
teams was a
manual and
time-consuming
effort
Needed management of
cross-team dependencies
Planning was inefficient
We were relying on
spreadsheets
Managing
teams was a
manual and
time-consuming
effort
Scaled agile allowed
the management and
coordination of
multiple teams that
work on all stages of

a large project
Source: Shutterstock

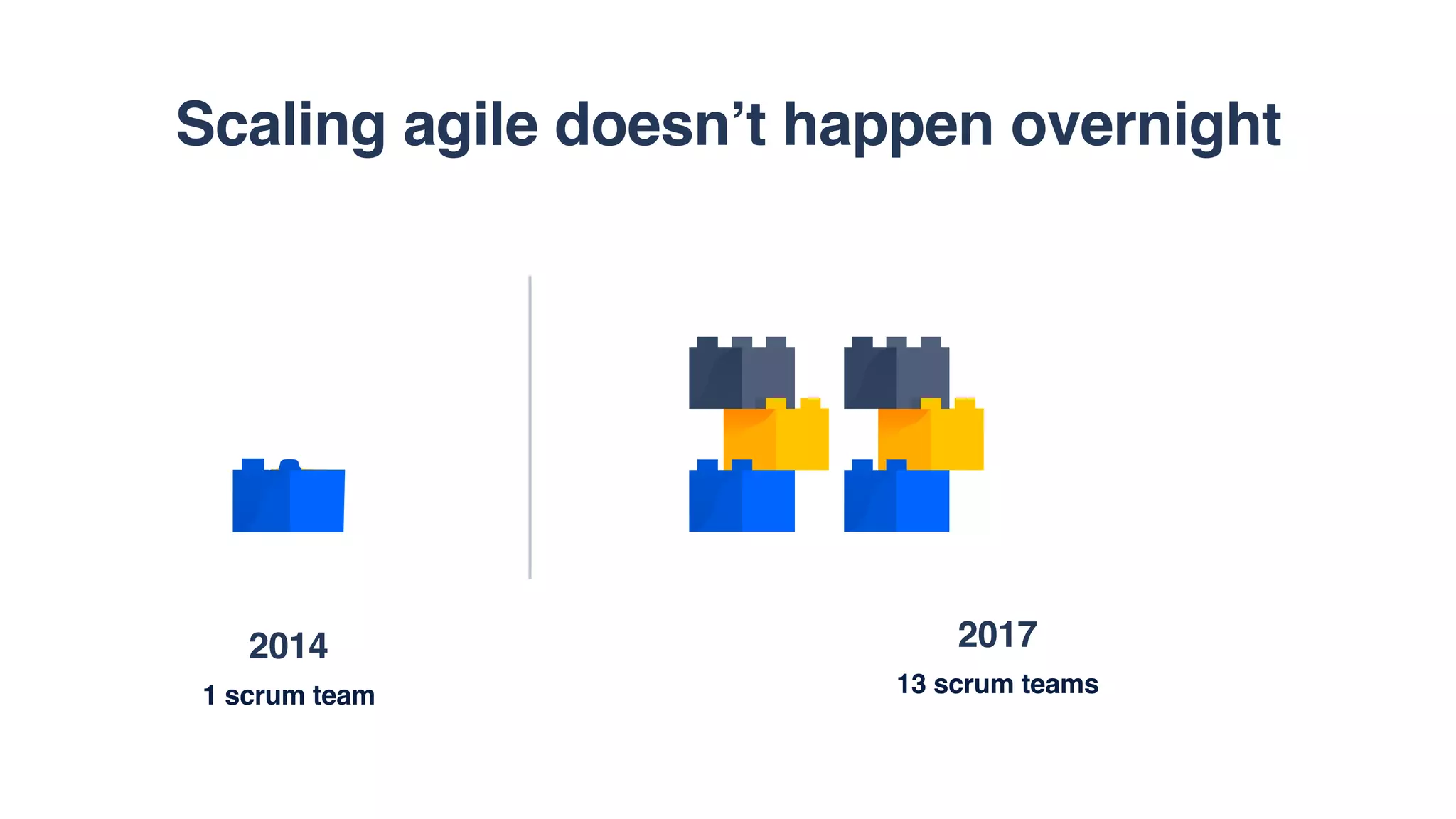

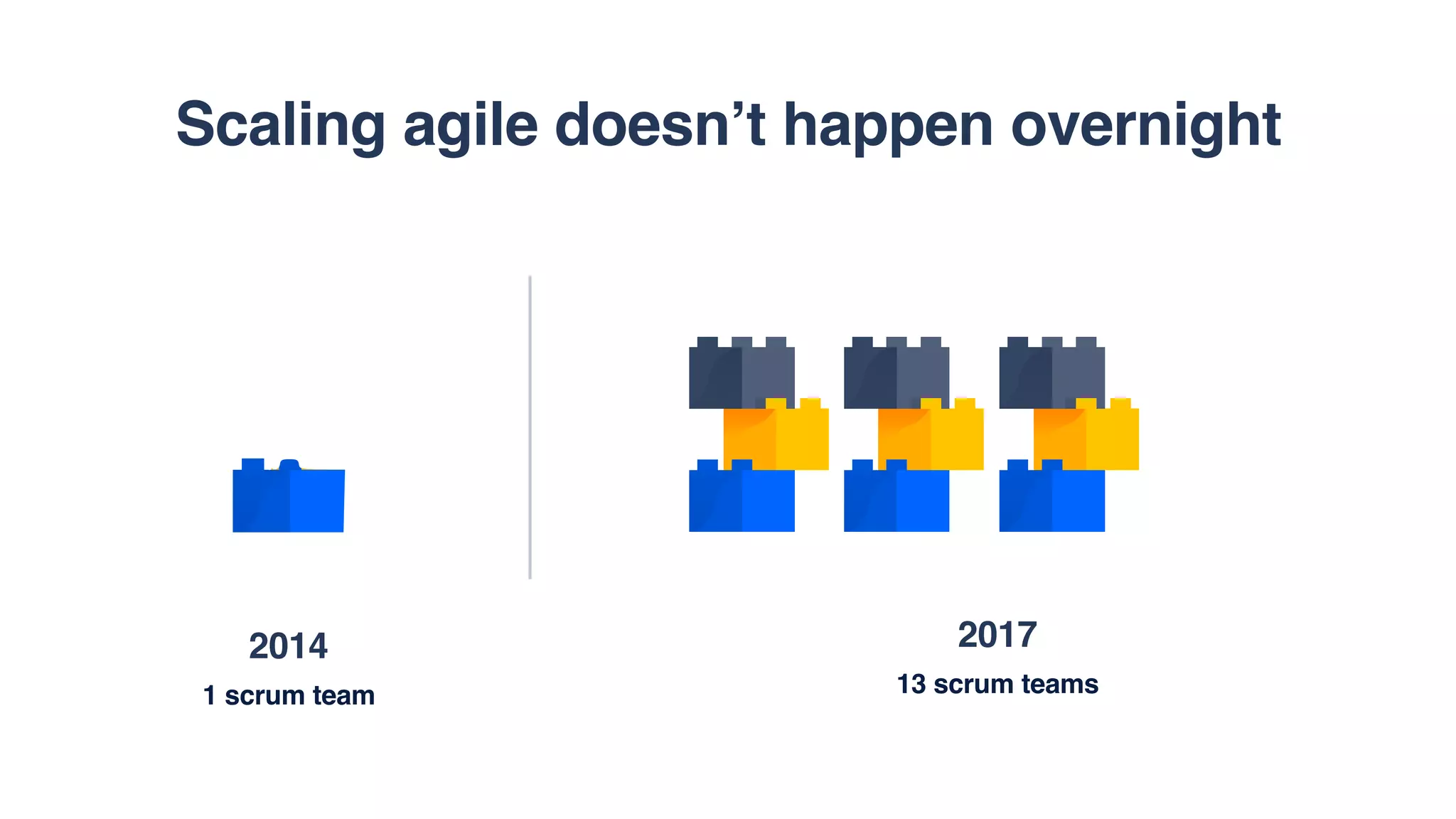

2014
1 scrum team
Scaling agile doesn’t happen overnight
2014
1 scrum team

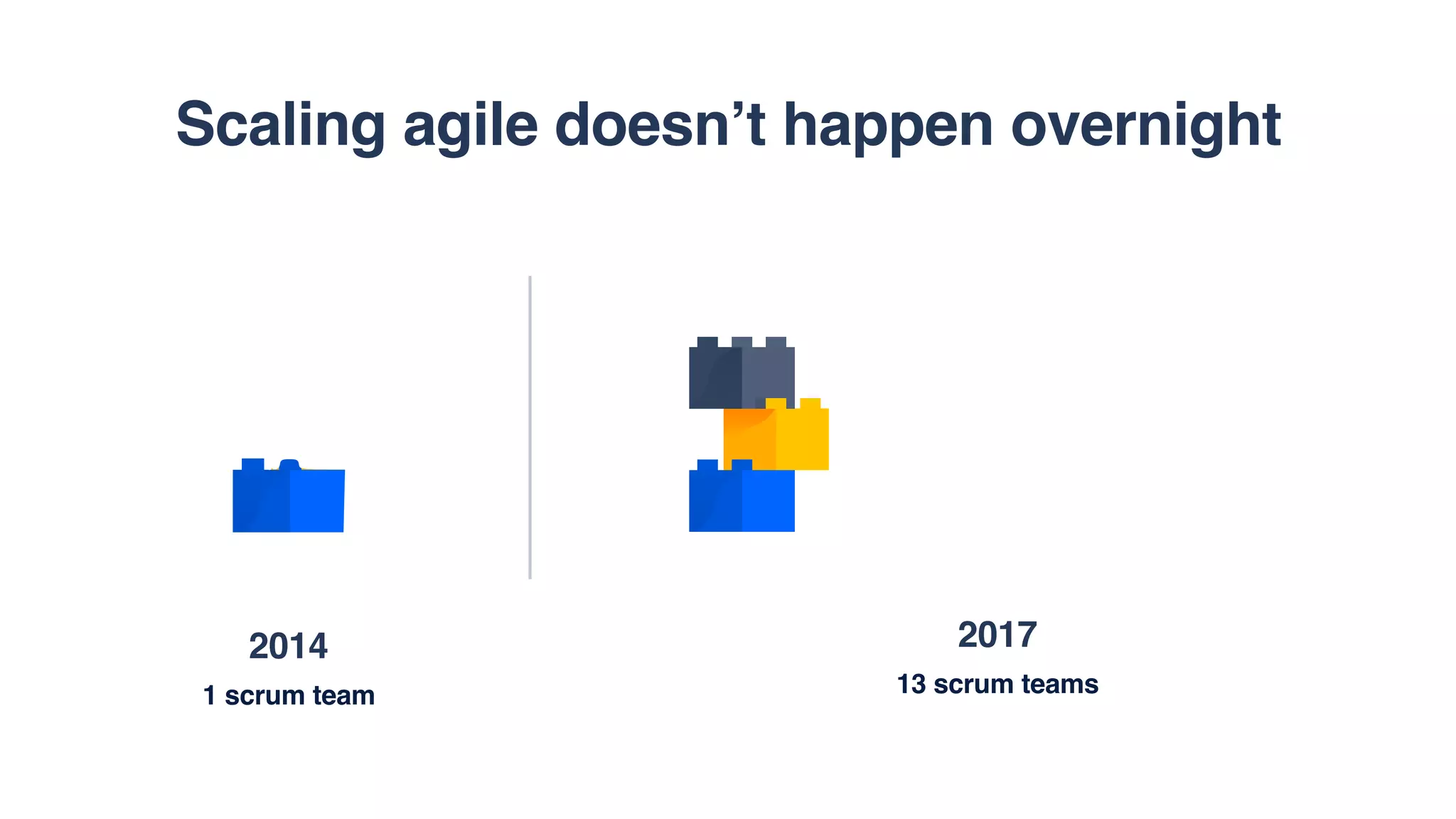

2017
13 scrum teams
Scaling agile doesn’t happen overnight
2014
1 scrum team
2017
13 scrum teams
Scaling agile doesn’t happen overnight
2014
1 scrum team
2017
13 scrum teams
Scaling agile doesn’t happen overnight
2014
1 scrum team
2017
13 scrum teams
Scaling agile doesn’t happen overnight

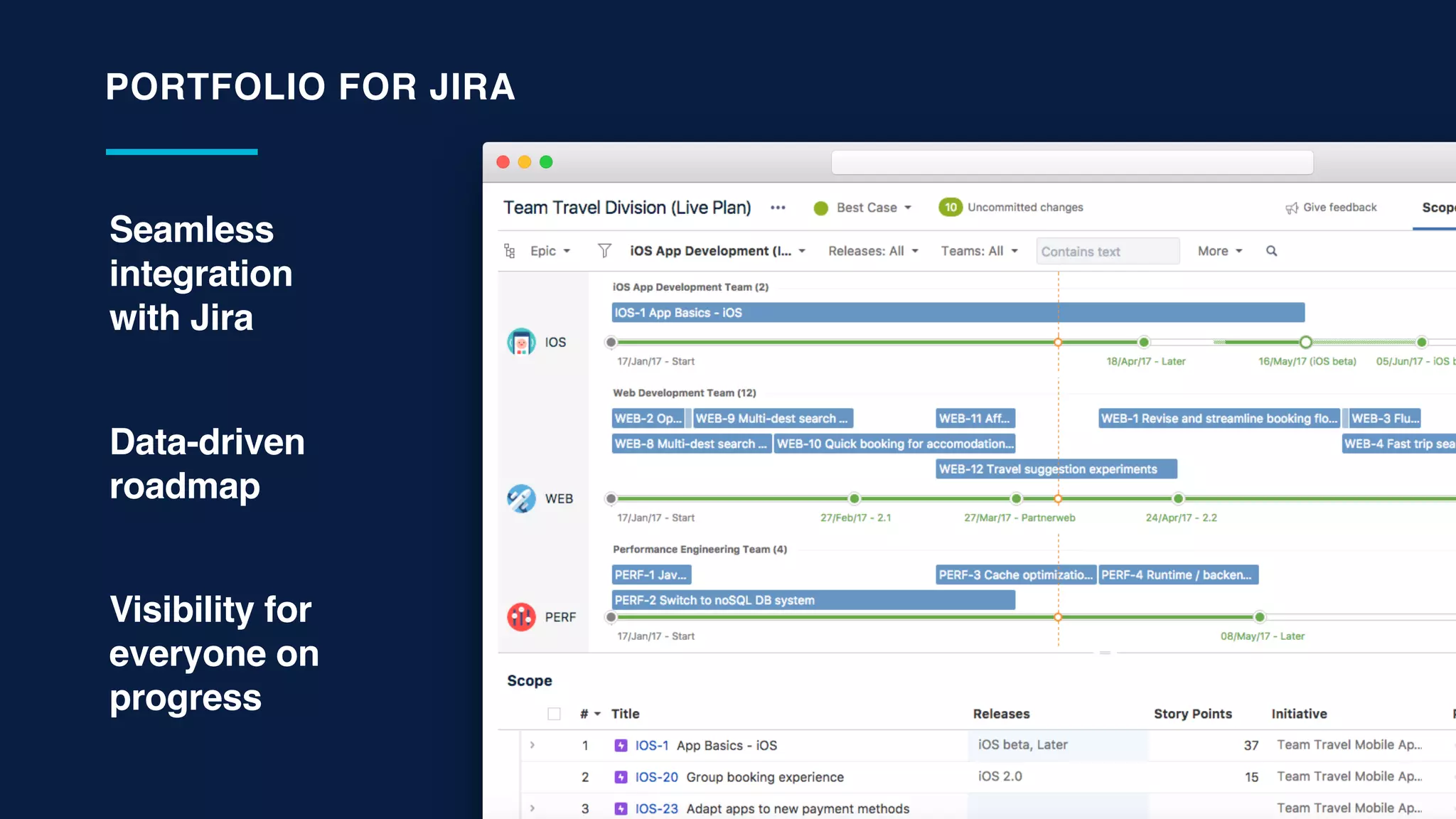

PORTFOLIO FOR JIRA
Data-driven
roadmap
Visibility for
everyone on
progress
Seamless
integration

with Jira

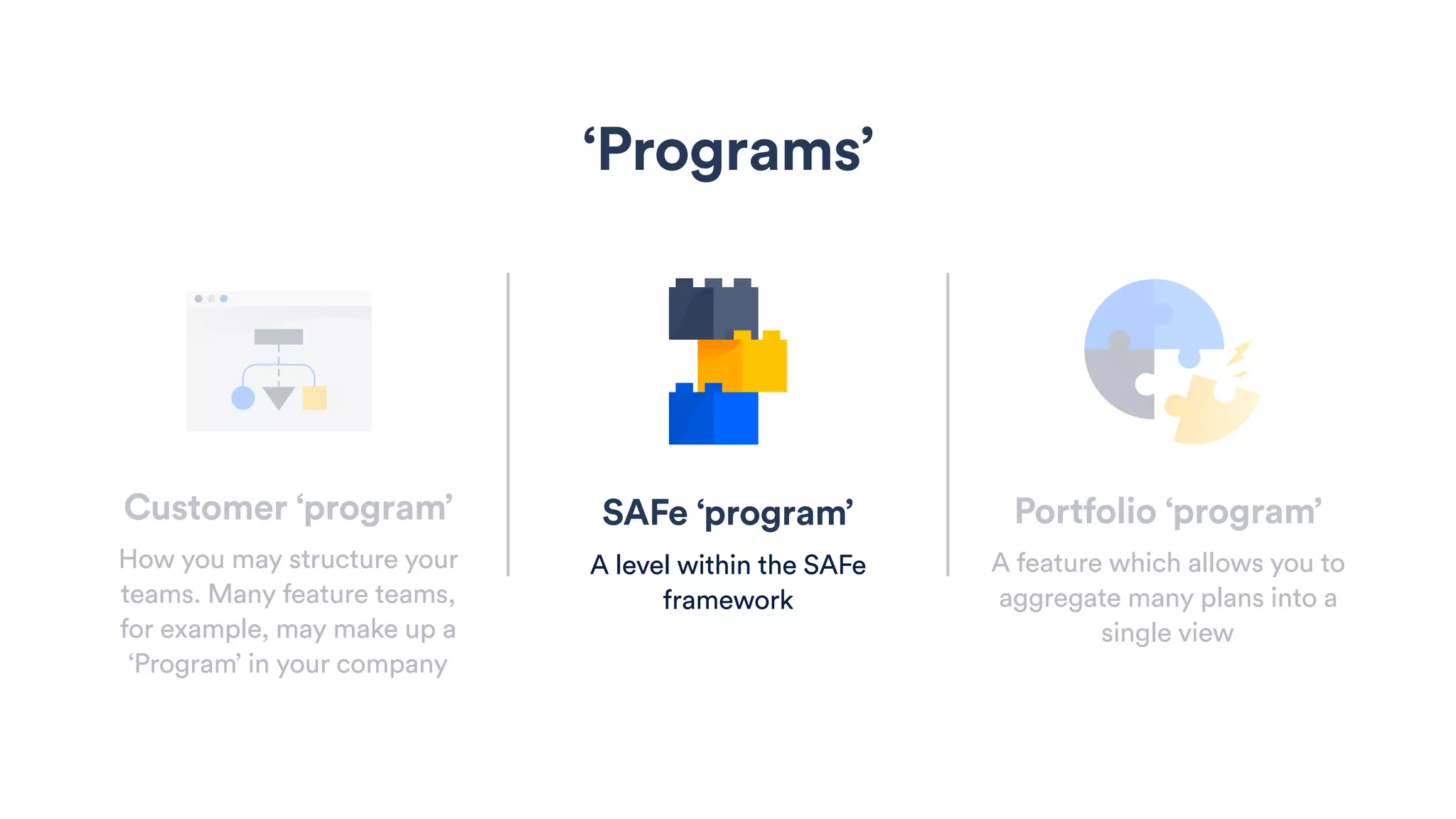

‘Programs’

= ?

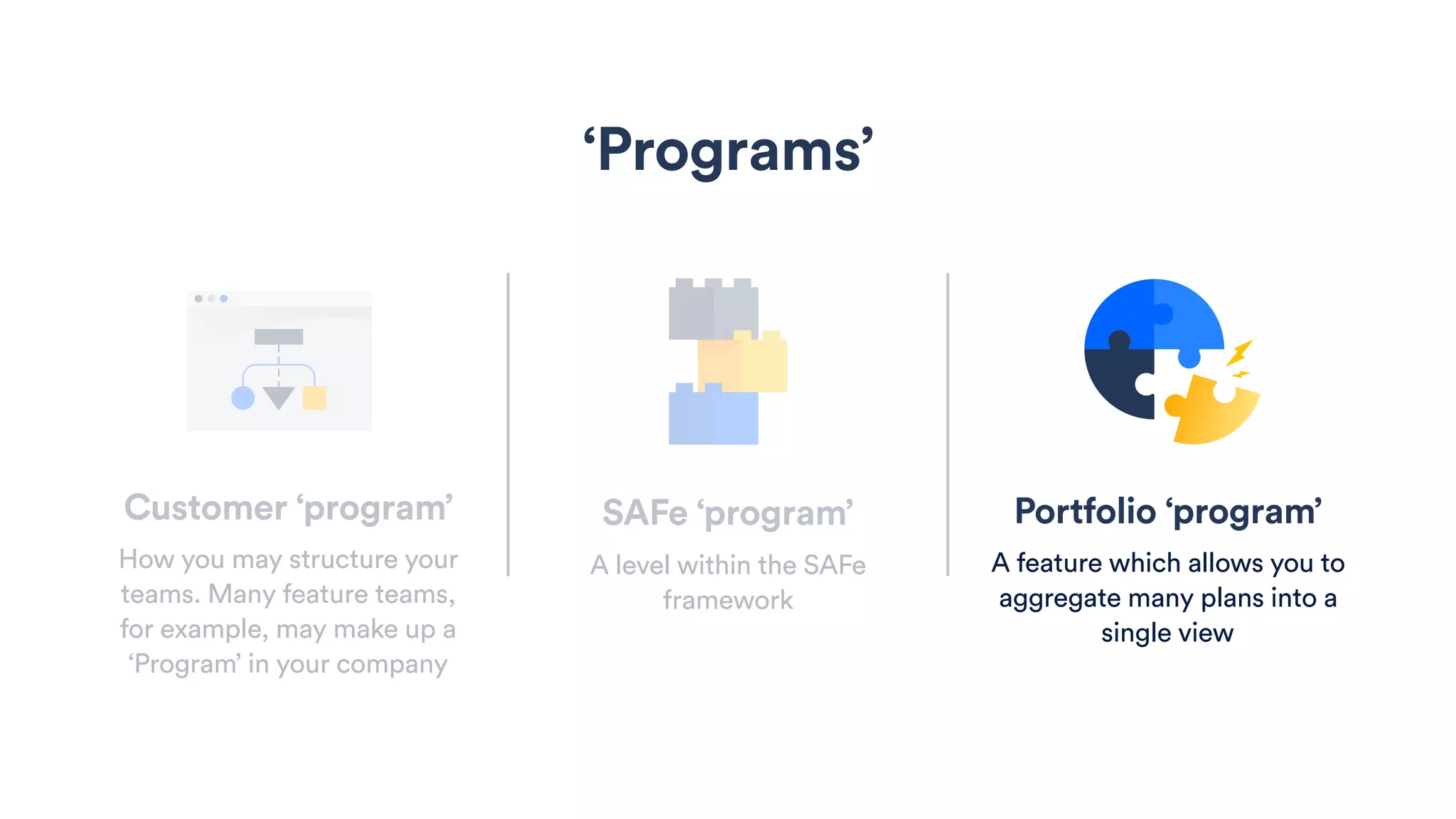

let’s clarify
SAFe ‘program’
A level within the SAFe
framework
‘Programs’
Portfolio ‘program’
A feature which allows you to
aggregate many plans into a
single view
Customer ‘program’
How you may structure your
teams. Many feature teams,
for example, may make up a
‘Program’ in your company
SAFe ‘program’
A level within the SAFe
framework
‘Programs’
Portfolio ‘program’
A feature which allows you to
aggregate many plans into a
single view
Customer ‘program’
How you may structure your
teams. Many feature teams,
for example, may make up a
‘Program’ in your company
SAFe ‘program’
A level within the SAFe
framework
‘Programs’
Portfolio ‘program’
A feature which allows you to
aggregate many plans into a
single view
Customer ‘program’
How you may structure your
teams. Many feature teams,
for example, may make up a
‘Program’ in your company
Agenda
Why should I scale agile?
Optimise your hierarchy for comms
Plan to plan
Takeaways
Agenda
Why should I scale agile?
Keep Jira simple
Optimise your hierarchy for comms
Plan to plan
Takeaways
Be clear how you will
organize your teams

before you put tools

around them.
SET STRONG FOUNDATIONS
What’s under our customer’s Jira hood?
Each board is based based on a filter using a custom
field for ‘Program’ and then, separated by team.
FixVersion
Essential for using

Releases in Portfolio
Estimate
We rely on this to
understand the size
of your work
Team Field
See and share your
team assignments
Parent Link
Surface hierarchy

on your

Jira issues

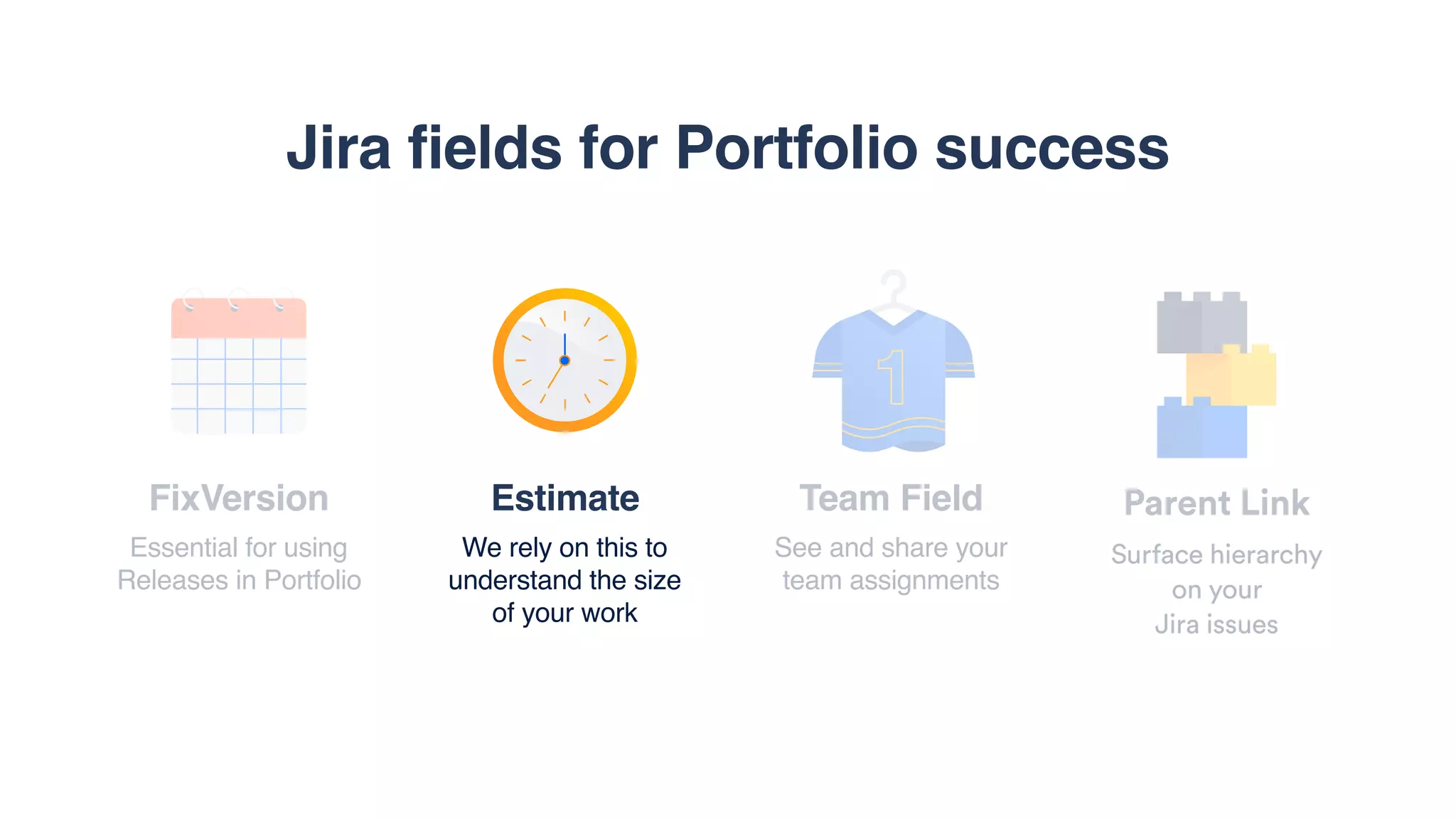

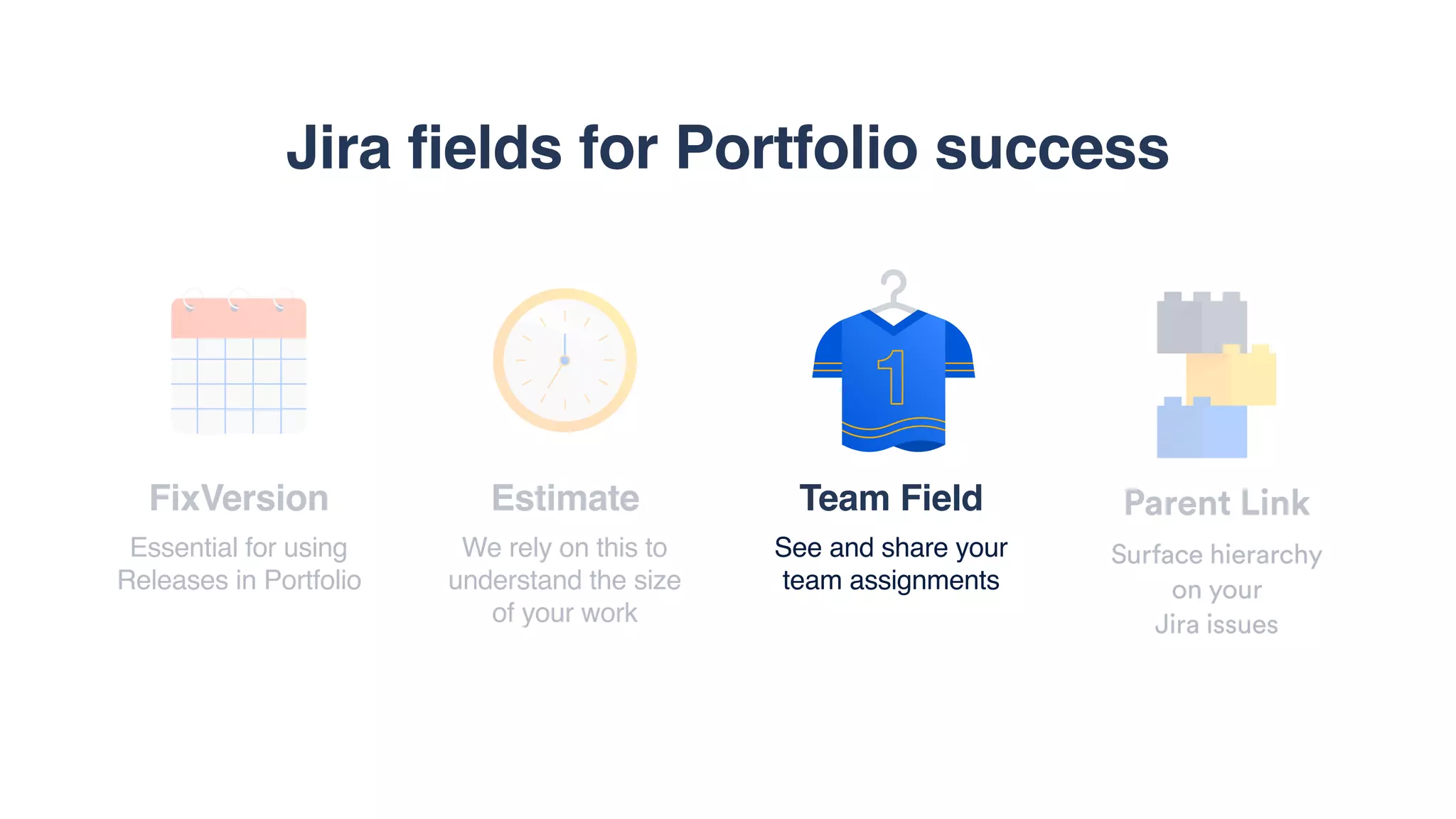

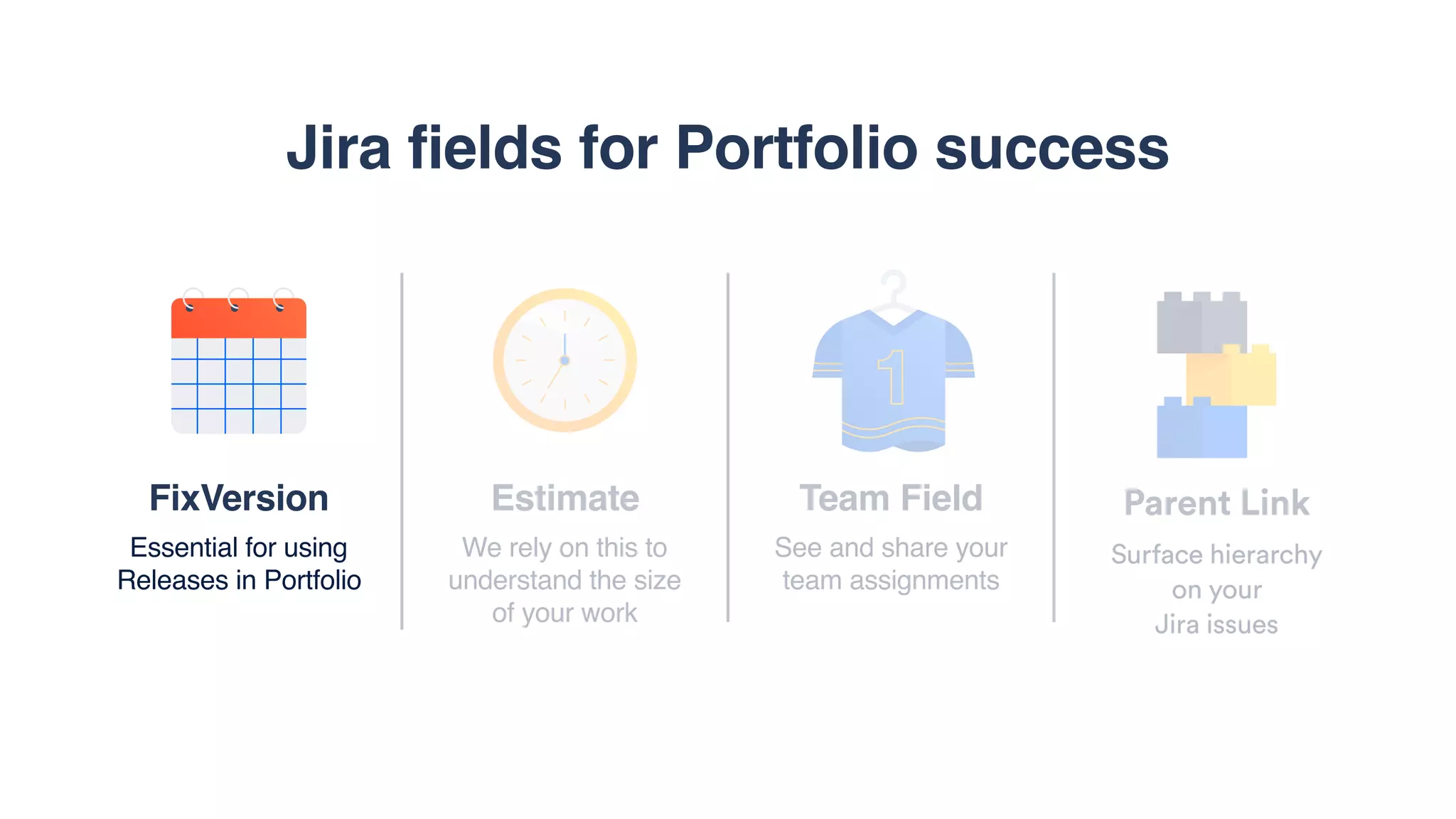

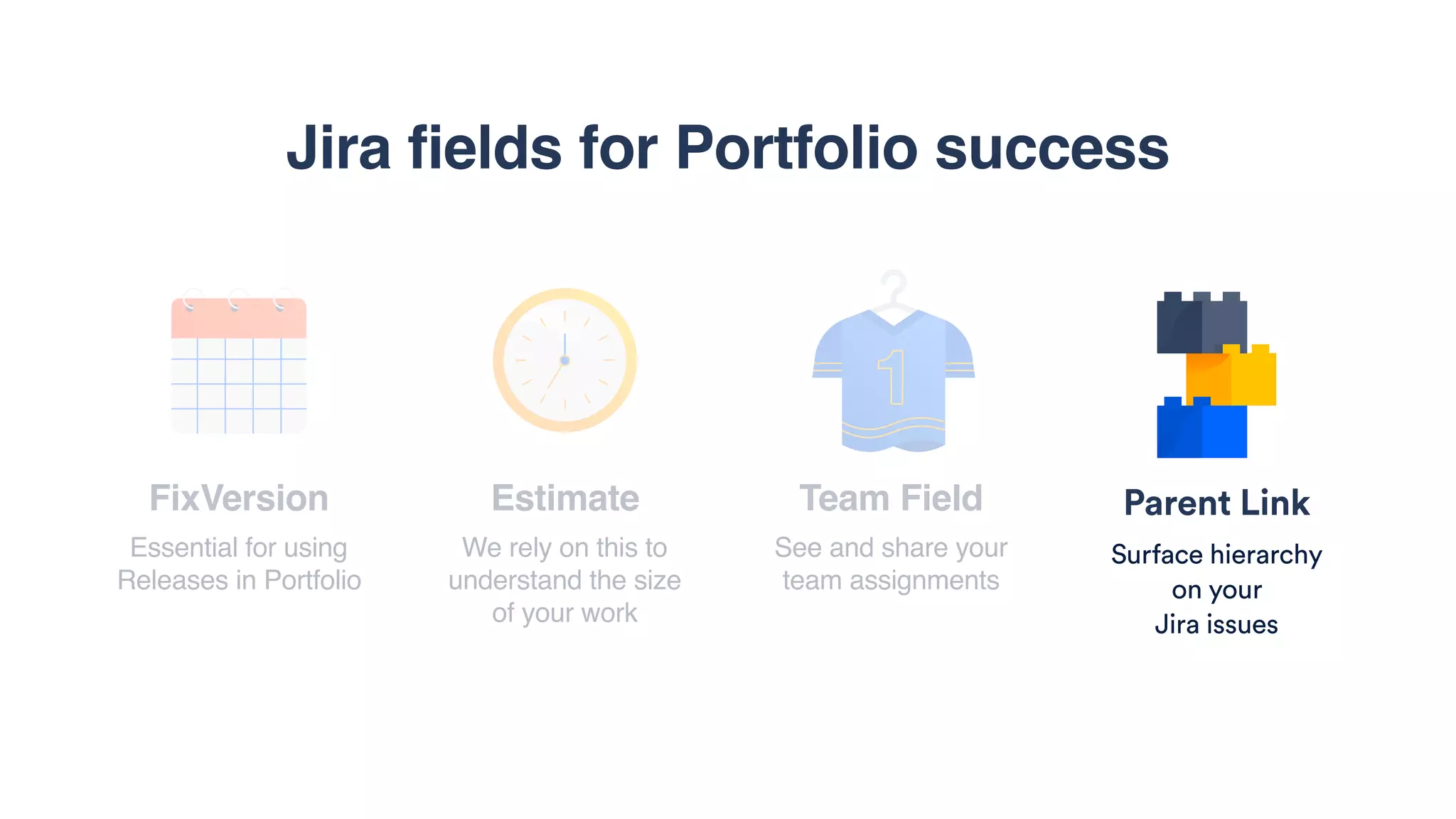

Jira fields for Portfolio success

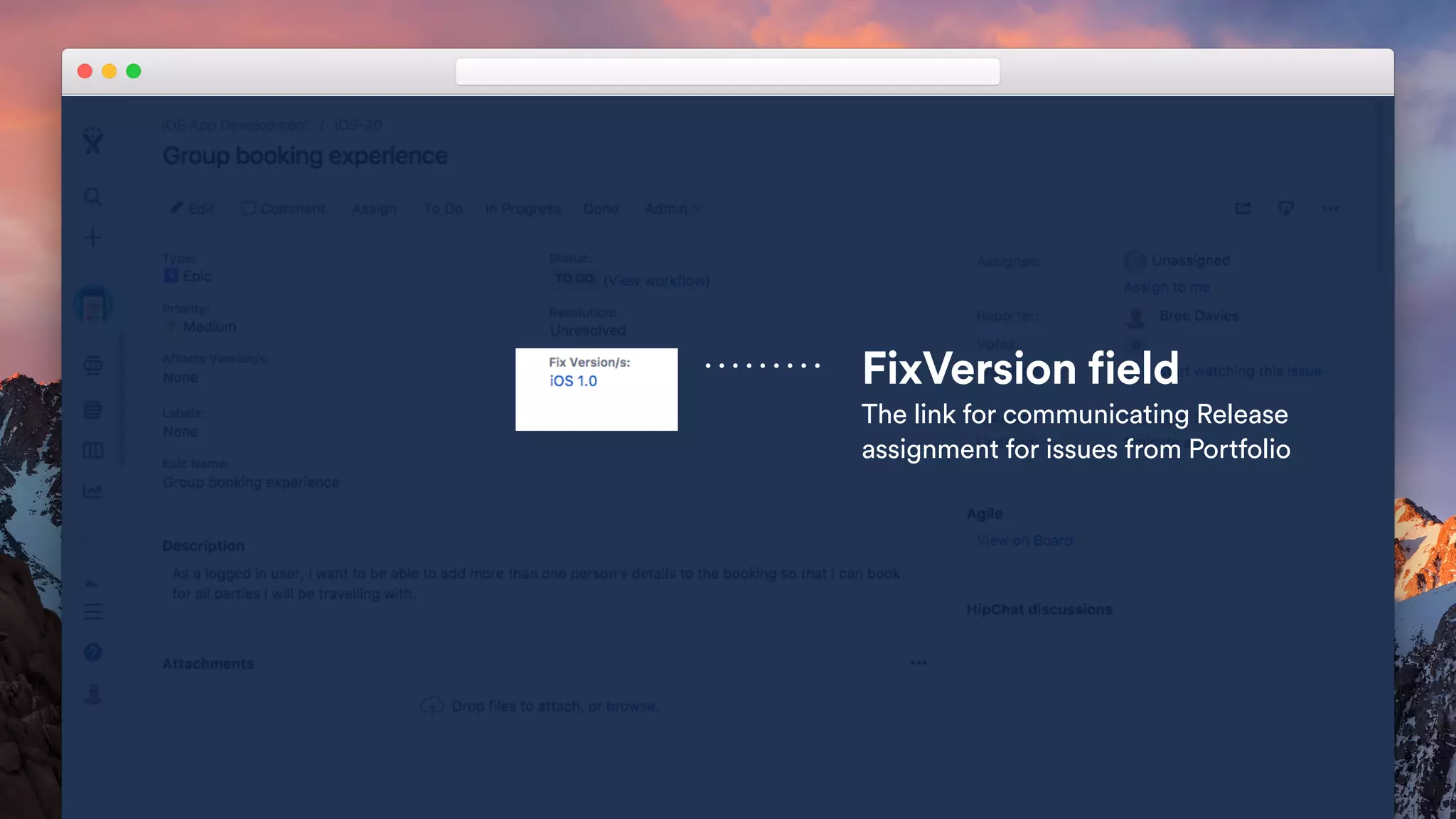

FixVersion field
The link for communicating Release
assignment for issues from Portfolio
FixVersion
Essential for using

Releases in Portfolio
Estimate
We rely on this to
understand the size
of your work
Team Field
See and share your
team assignments
Parent Link
Surface hierarchy

on your

Jira issues
Jira fields for Portfolio success

Creating a call-out
Watch the tutorial in the Presentation
Guidelines Keynote to learn how to
create call-outs on screenshots within
this template.

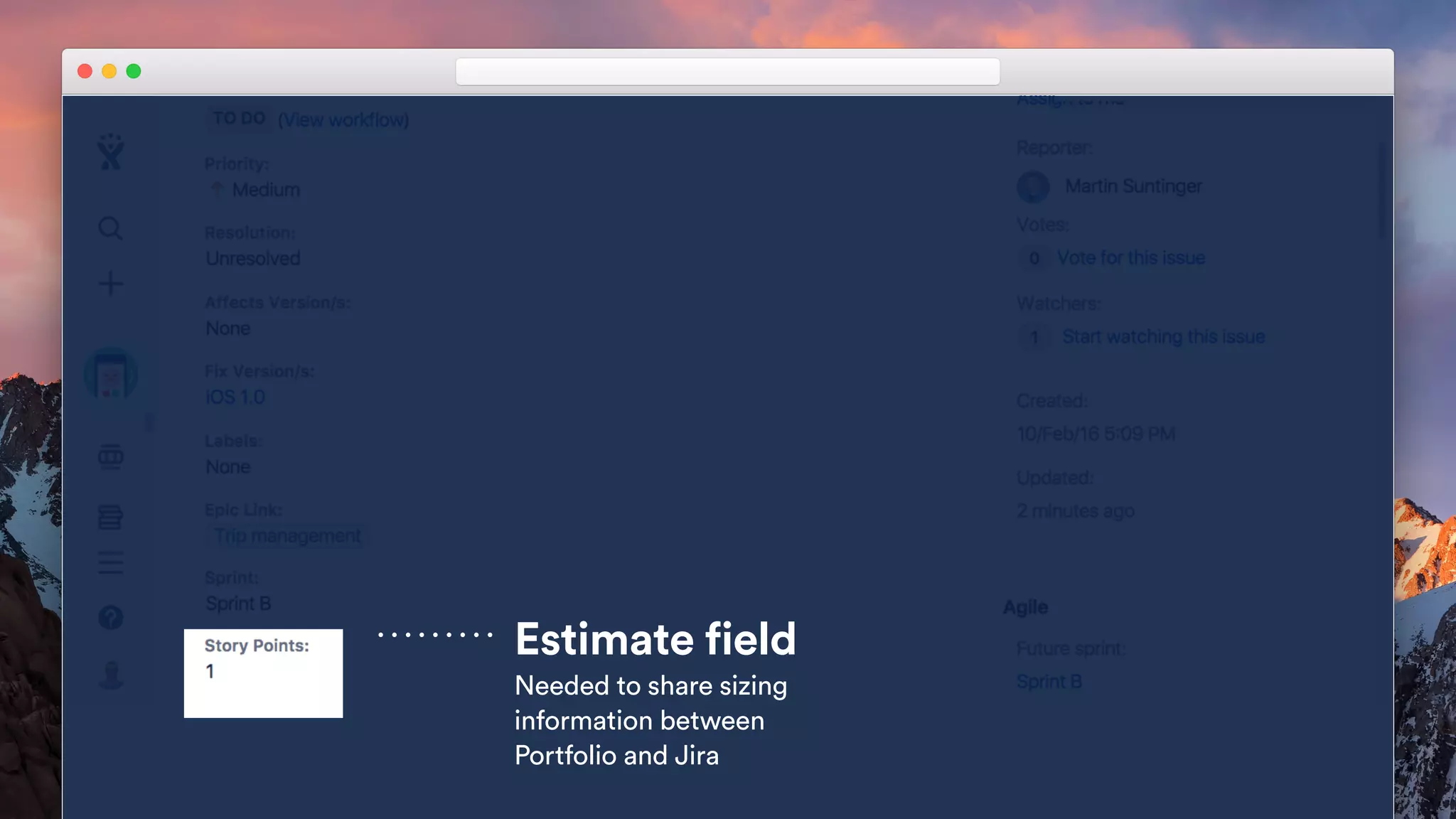

Estimate field
Needed to share sizing
information between
Portfolio and Jira
FixVersion
Essential for using

Releases in Portfolio
Estimate
We rely on this to
understand the size
of your work
Team Field
See and share your
team assignments
Parent Link
Surface hierarchy

on your

Jira issues
Jira fields for Portfolio success

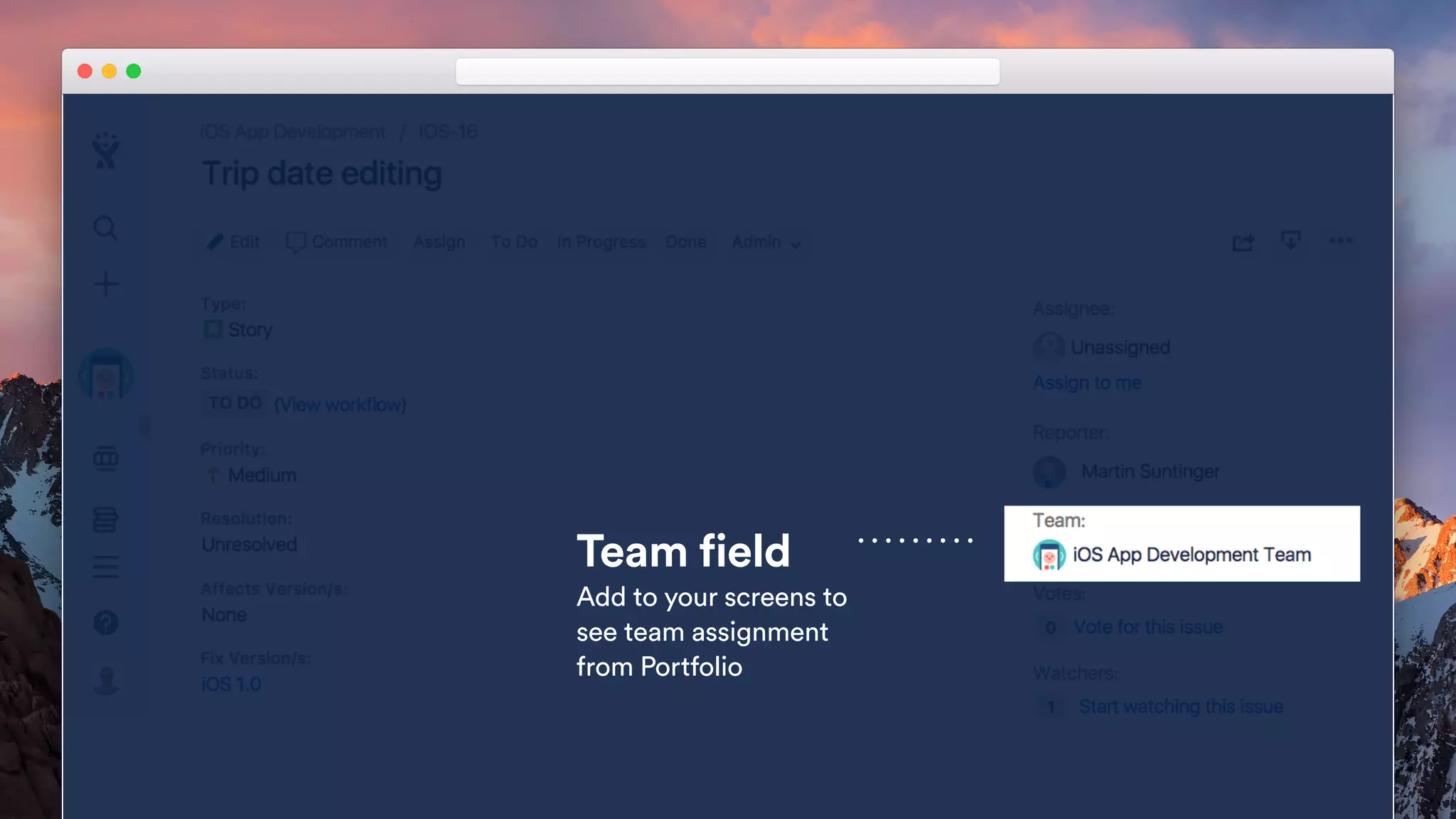

Team field
Add to your screens to

see team assignment
from Portfolio
FixVersion
Essential for using

Releases in Portfolio
Estimate
We rely on this to
understand the size
of your work
Team Field
See and share your
team assignments
Parent Link
Surface hierarchy

on your

Jira issues
Jira fields for Portfolio success

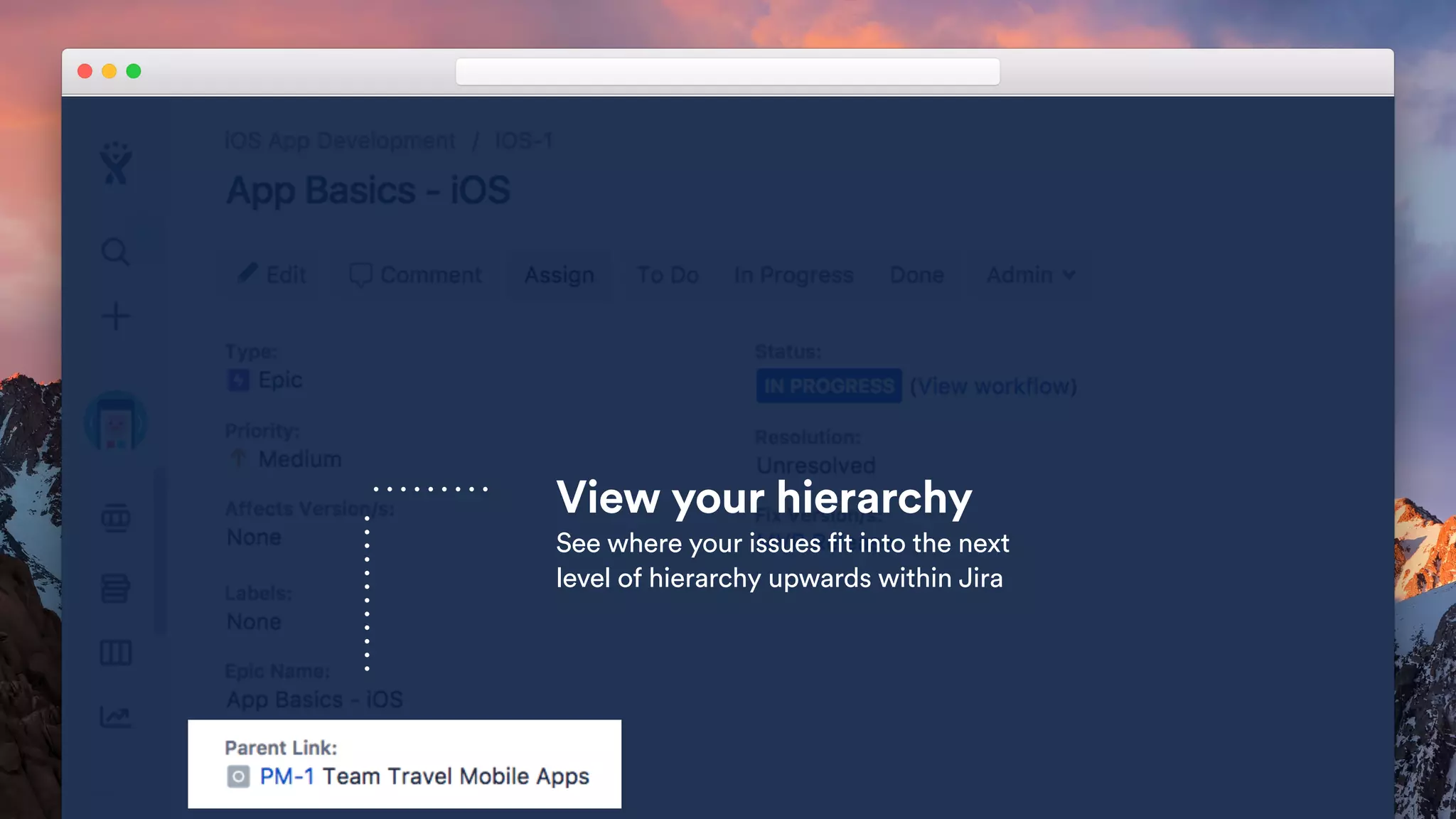

View your hierarchy
See where your issues fit into the next
level of hierarchy upwards within Jira
Creating a call-out
Watch the tutorial in the Presentation
Guidelines Keynote to learn how to
create call-outs on screenshots within
this template.

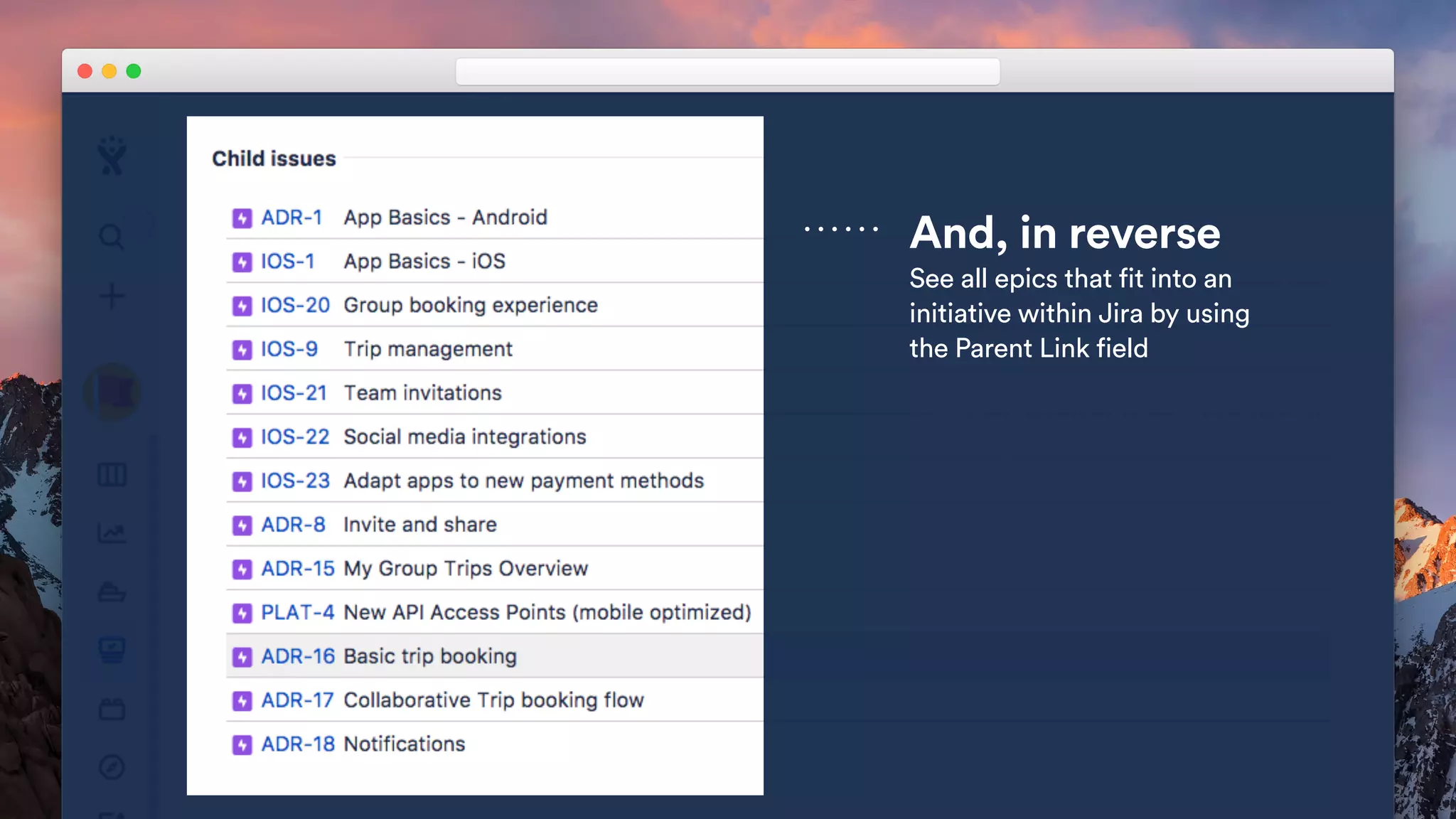

And, in reverse
See all epics that fit into an
initiative within Jira by using
the Parent Link field

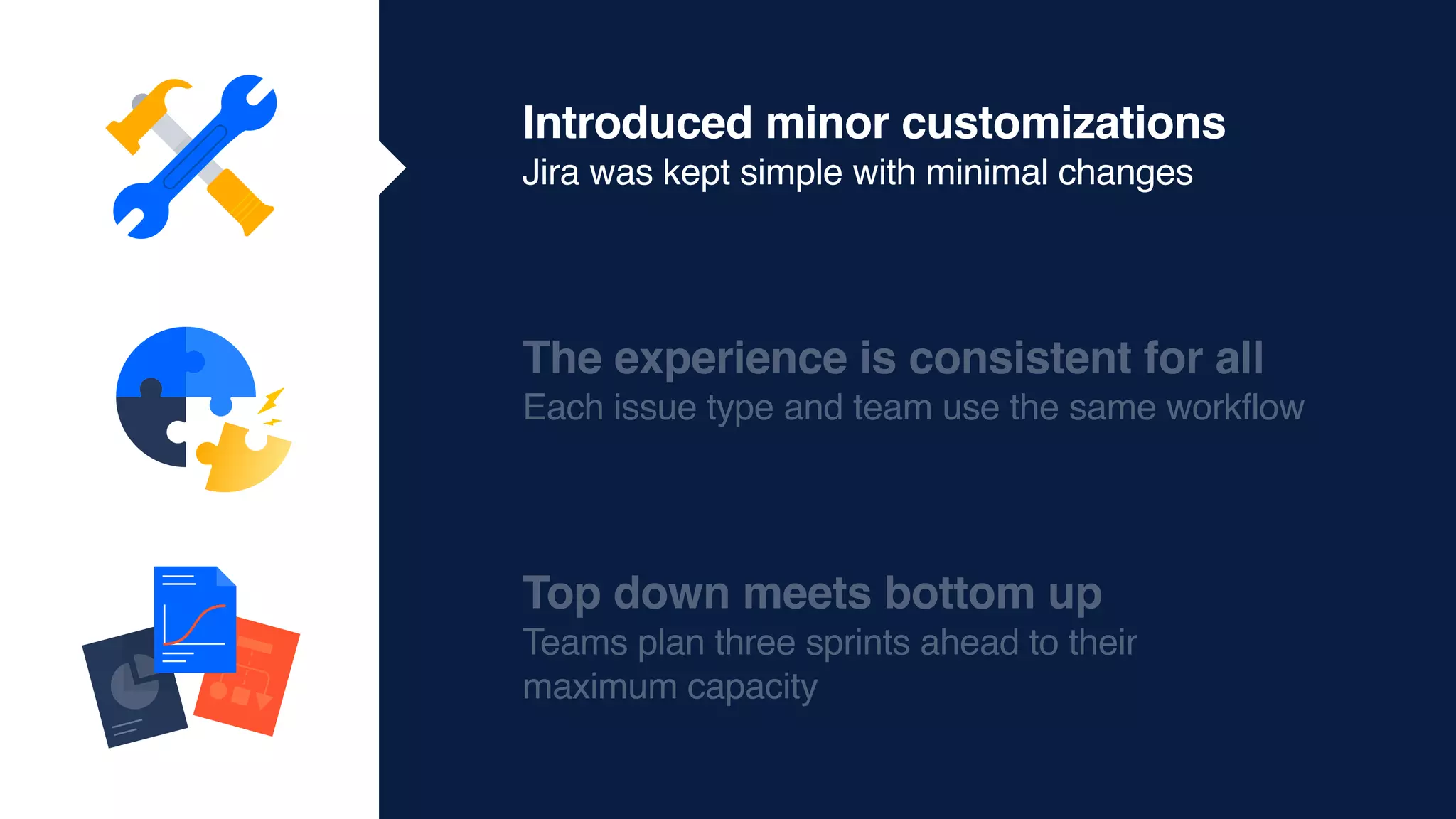

Introduced minor customizations
Jira was kept simple with minimal changes
The experience is consistent for all
Each issue type and team use the same workflow
Top down meets bottom up
Teams plan three sprints ahead to their

maximum capacity

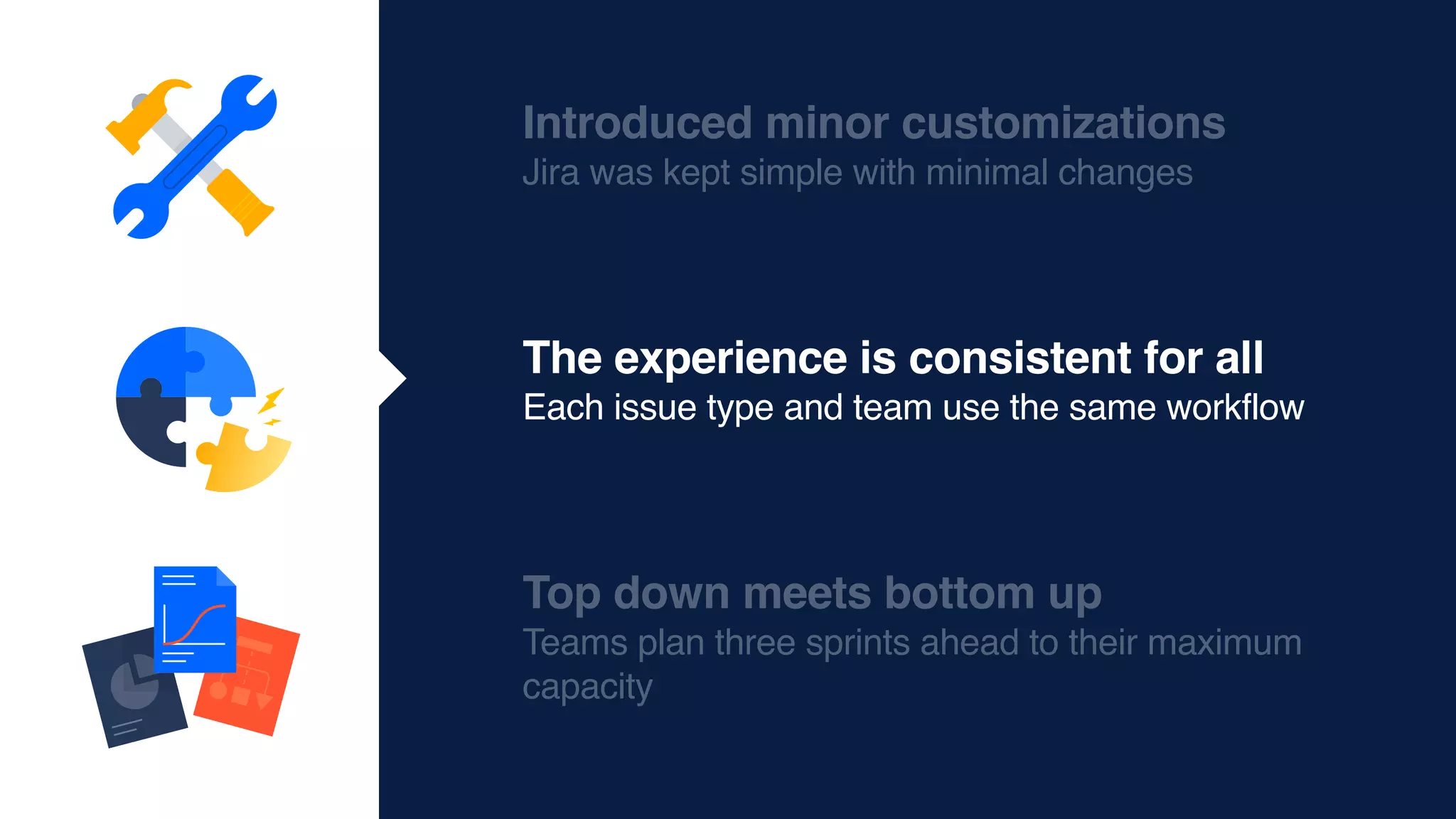

Introduced minor customizations
Jira was kept simple with minimal changes
The experience is consistent for all
Each issue type and team use the same workflow
Top down meets bottom up
Teams plan three sprints ahead to their maximum
capacity
Introduced minor customizations
Jira was kept simple with minimal changes
The experience is consistent for all
Each issue type and team use the same workflow
Top down meets bottom up
Teams plan three sprints ahead to their maximum
capacity
Custom fields are powerful.
But think carefully before

re-creating standard Jira
fields with your own.
CUSTOM FIELD WARNING
Determine what’s essential
Keep it simple
Audit your customizations
I’m worried
we are

not set up
for success

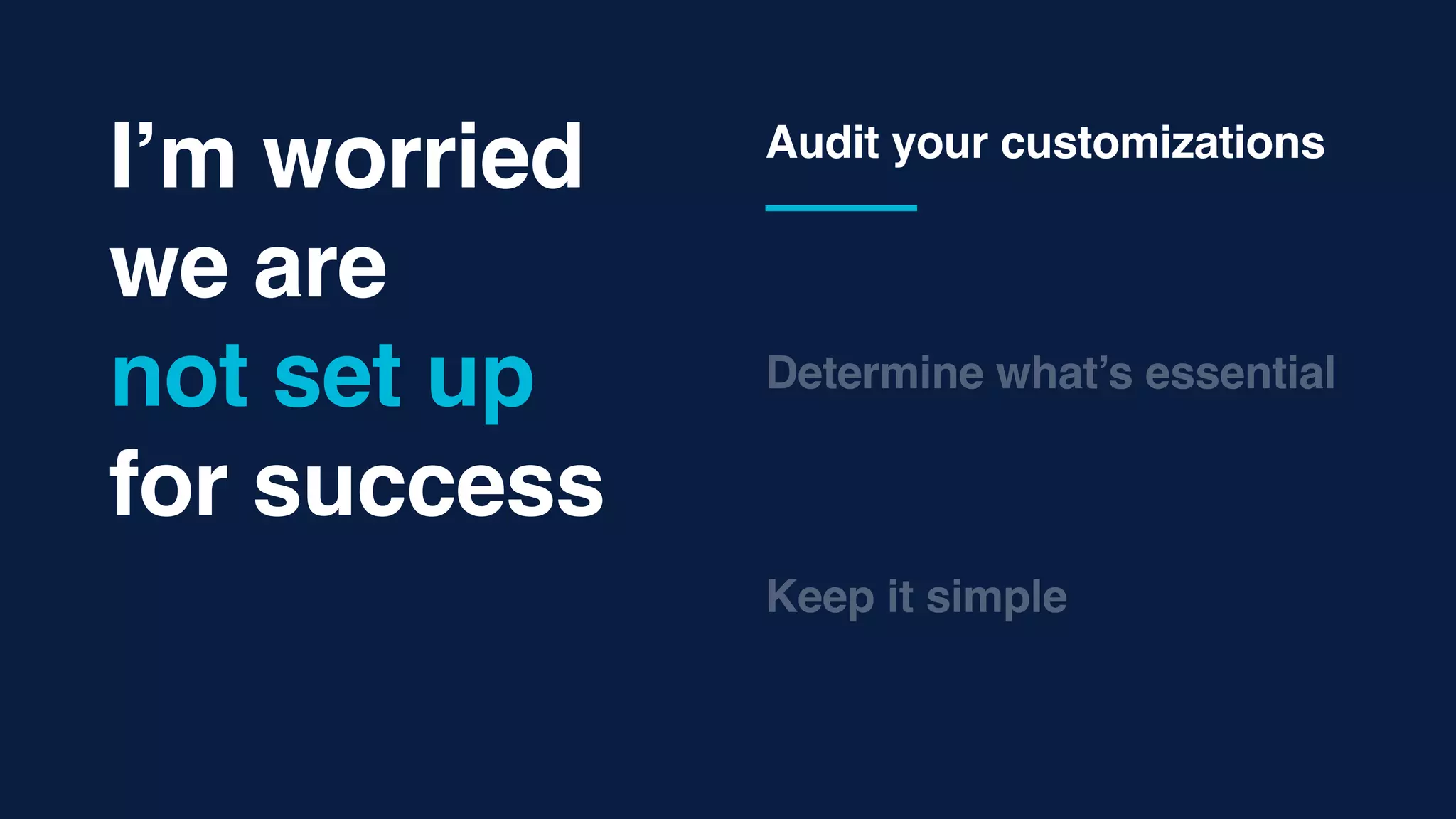

Determine what’s essential
Keep it simple
Audit your customizations
I’m worried
we are

not set up
for success
Determine what’s essential
Keep it simple
Audit your customizations
I’m worried
we are

not set up
for success
Agenda
Why should I scale agile?
Keep Jira simple
Plan to plan
Takeaways
Agenda
Why should I scale agile?
Keep Jira simple
Optimise your hierarchy for comms
Plan to plan
Takeaways

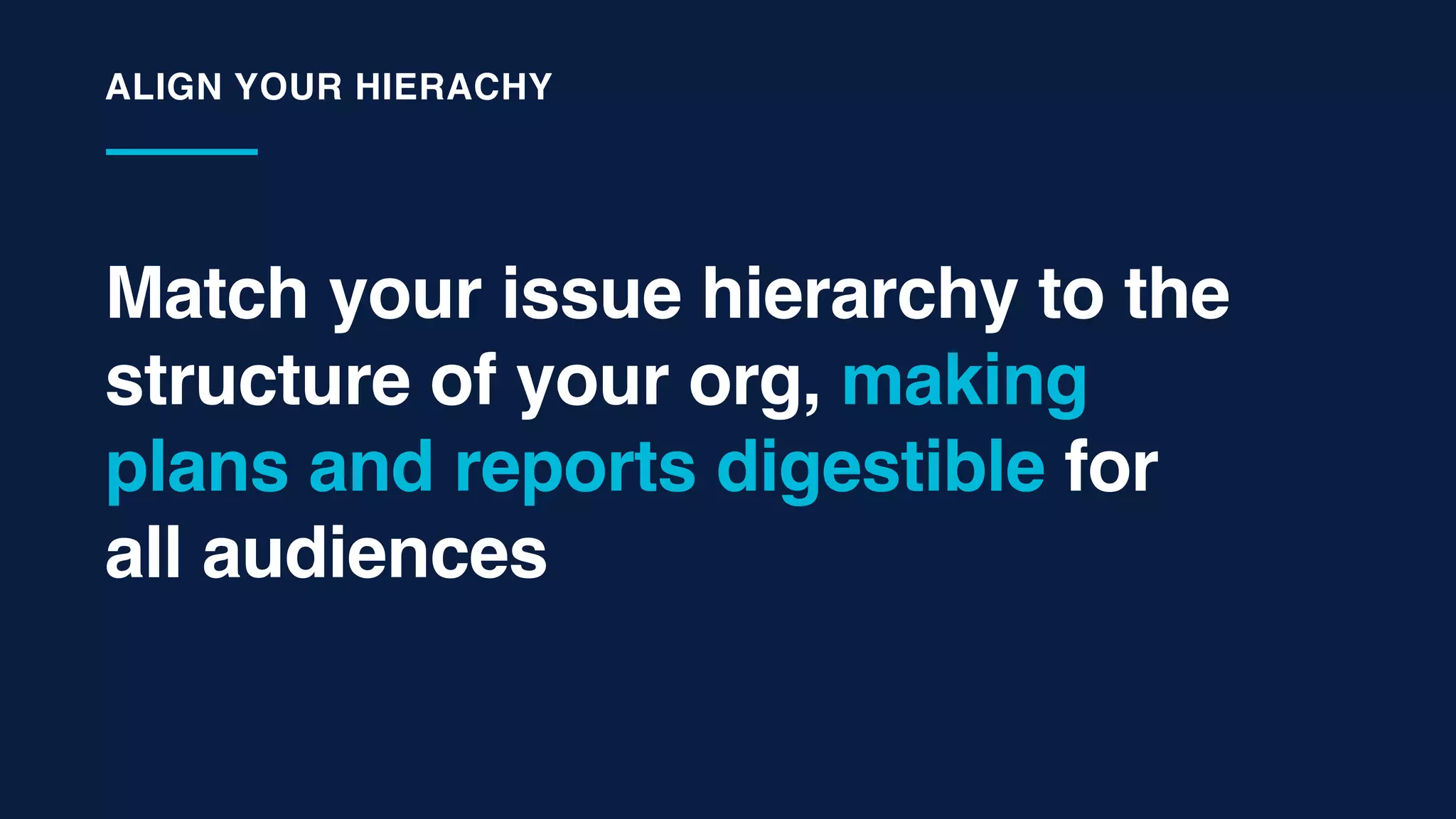

Match your issue hierarchy to the
structure of your org, making

plans and reports digestible for

all audiences
ALIGN YOUR HIERACHY
Match your issue hierarchy to your org
Product Owner Product Owner
Product Managers &
Business Partners
Scrum Master & Team Scrum Master & Team
Product Owner
Scrum Master & Team

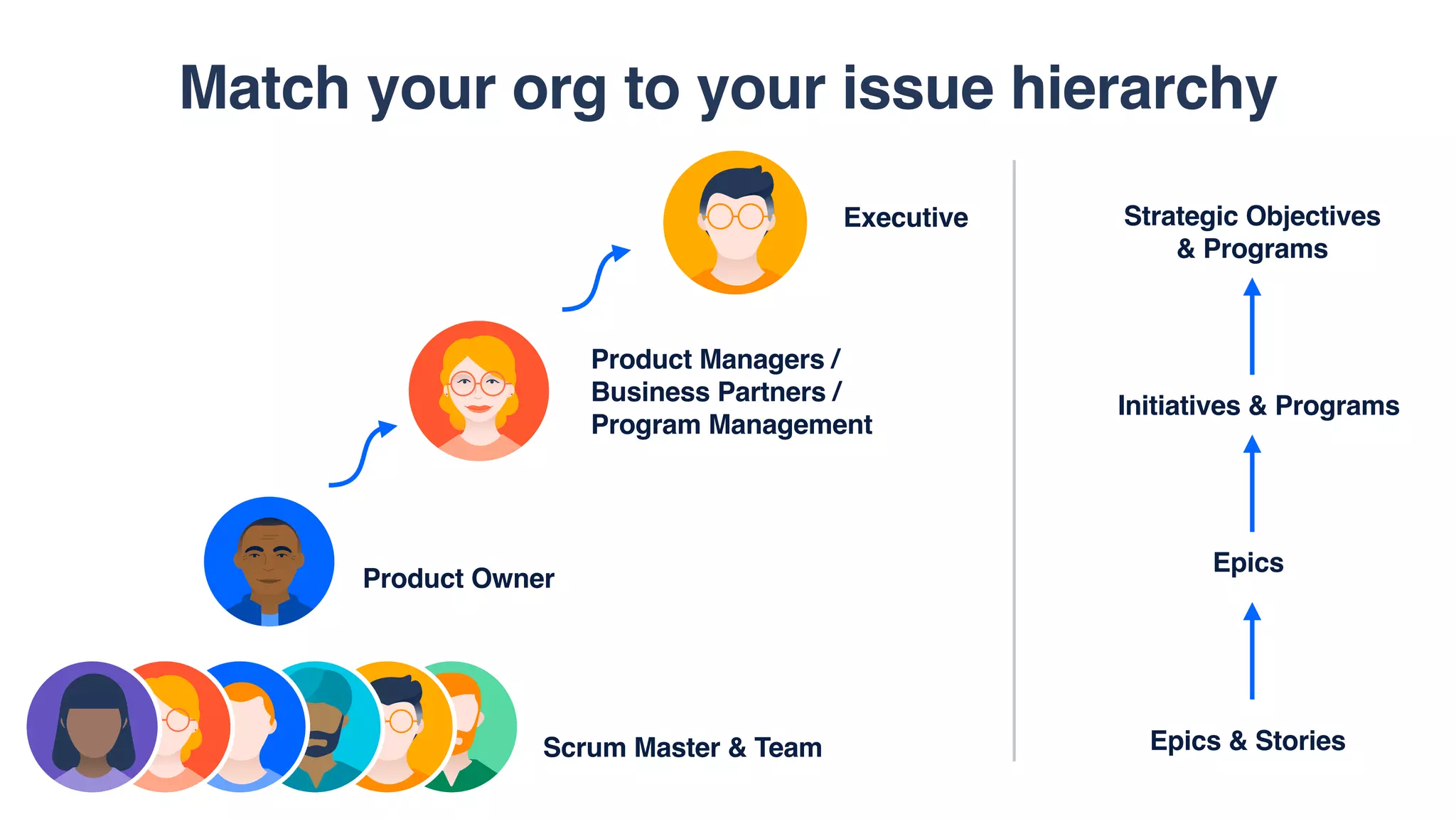

Match your org to your issue hierarchy
Product Managers /
Business Partners /
Program Management
Executive Strategic Objectives

& Programs
Initiatives & Programs
Epics
Epics & Stories

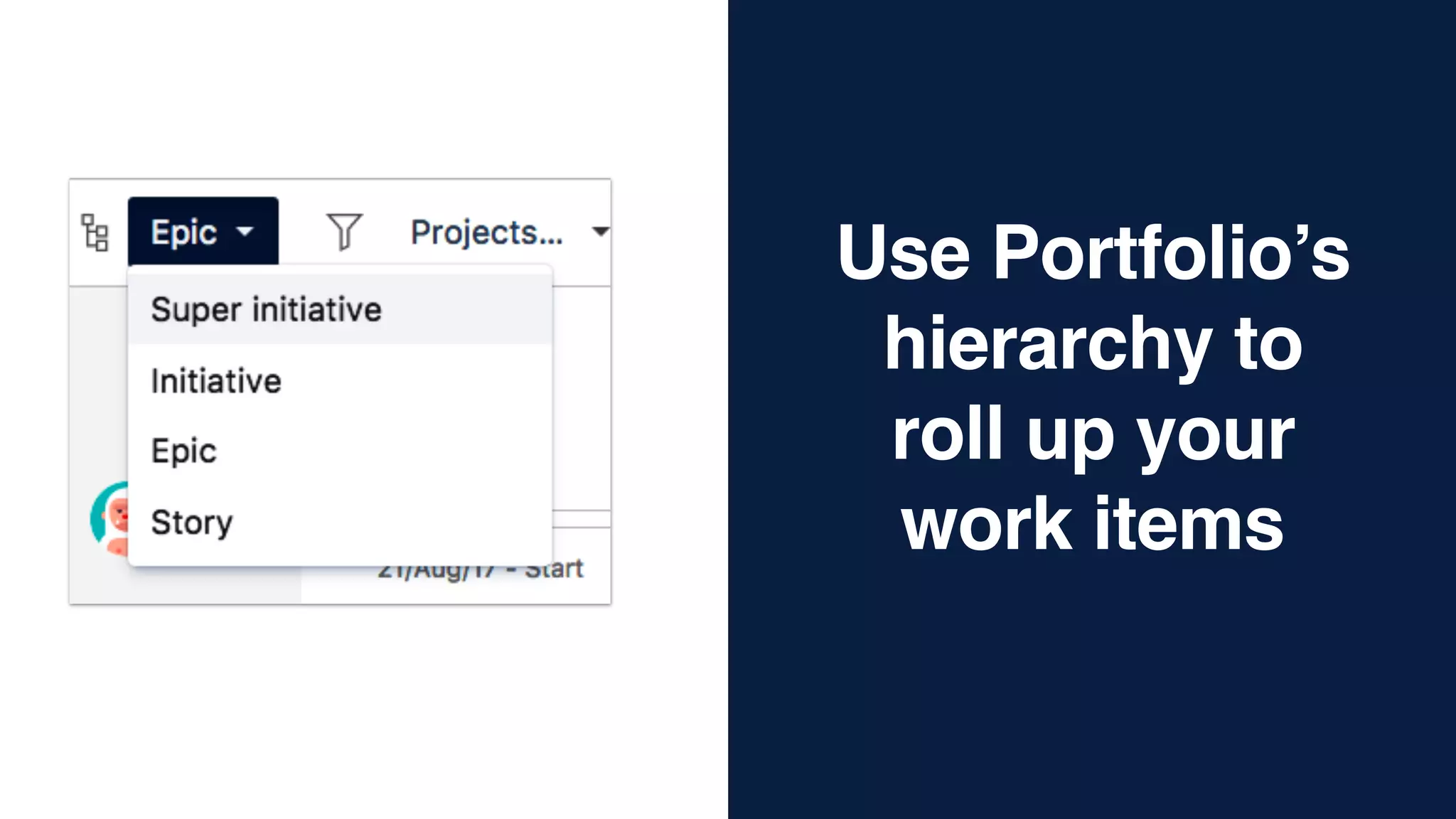

Use Portfolio’s
hierarchy to

roll up your

work items
It’s a lot of people to keep aligned

especially when your program is
moving quickly
Source: Shutterstock
Supporting
team
collaboration
Inspect, adapt and plan

Product Mangers, Product Owners and Business
Partners meet regularly throughout the month.
Bi-weekly
portfolio planning
Review the next three
releases, including;
• Work release
• Work per sprint
• Work per team
Adjust for priority,

team velocity and
cross-team
dependencies
EPIC LEVEL
Source: Shutterstock
INITIATIVE LEVEL
Supporting
team
collaboration

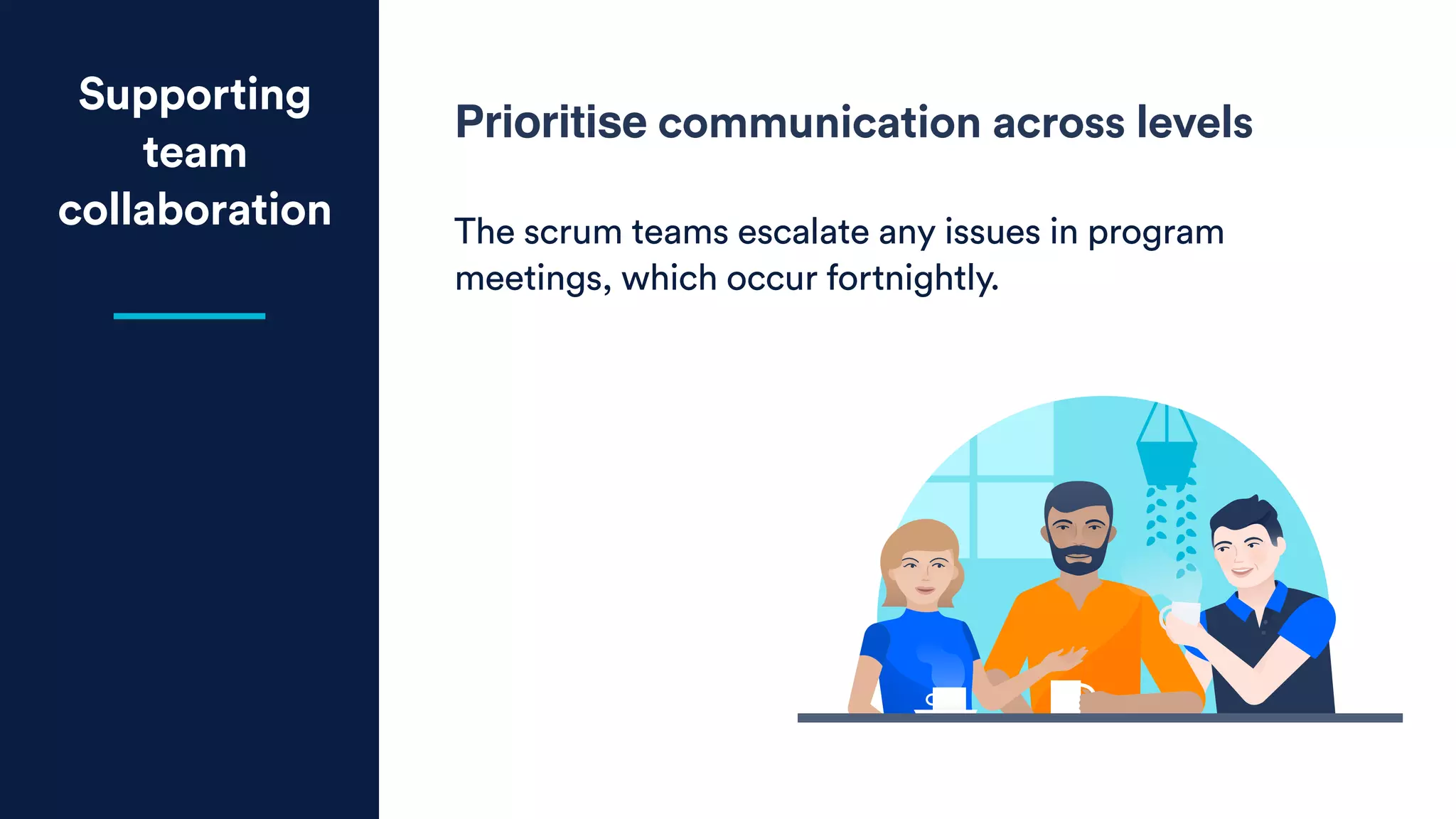

Prioritise communication across levels

The scrum teams escalate any issues in program
meetings, which occur fortnightly.

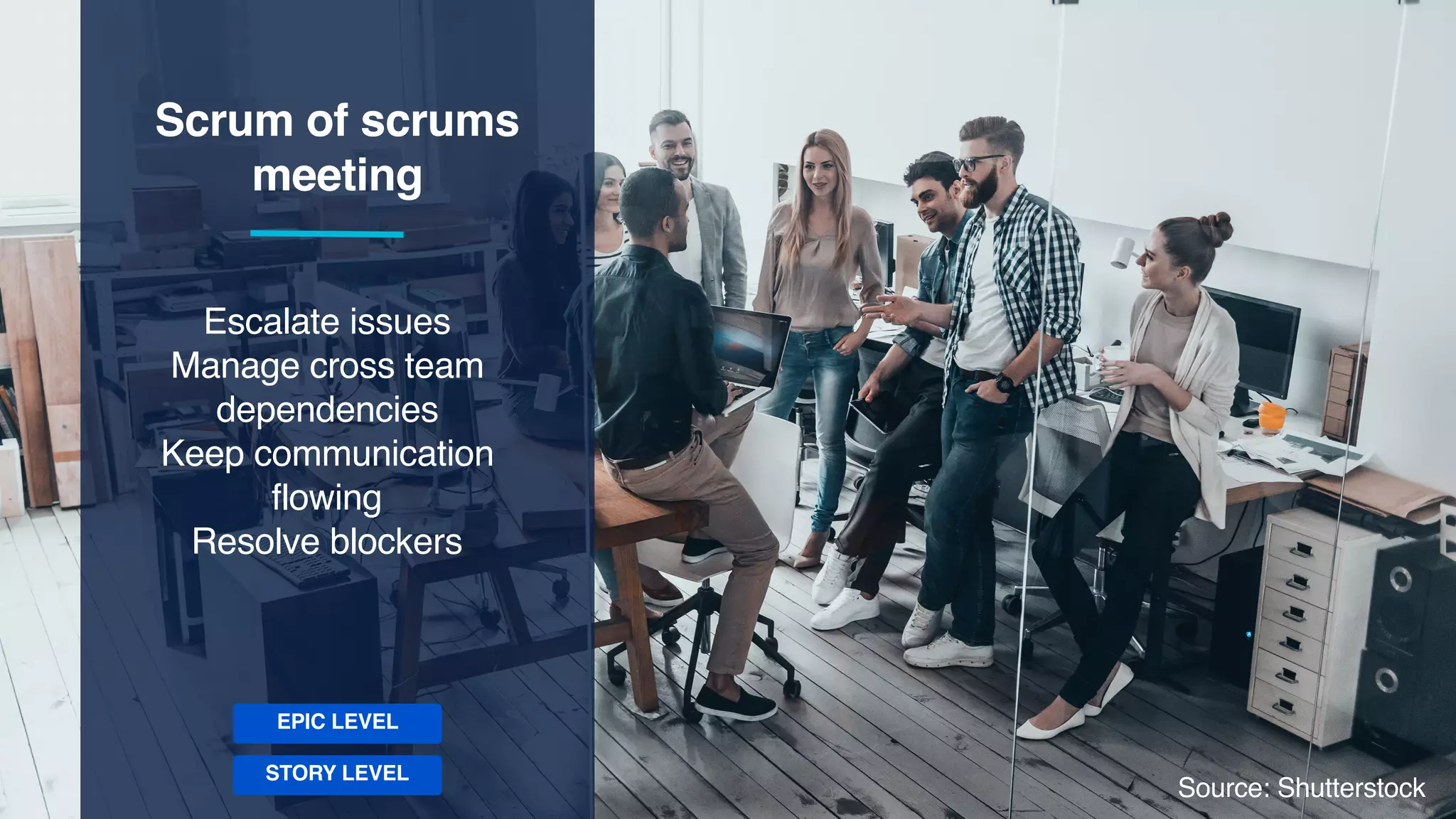

Scrum of scrums
meeting
Escalate issues
Manage cross team
dependencies
Keep communication
flowing
Resolve blockers
STORY LEVEL
EPIC LEVEL
Source: Shutterstock
Agenda
Why should I scale agile?
Keep Jira simple
Optimise your hierarchy for comms
Takeaways
Agenda
Why should I scale agile?
Keep Jira simple
Optimise your hierarchy for comms
Plan to plan
Takeaways
Think about the streams of
work and issue types you
want to see in your plan.

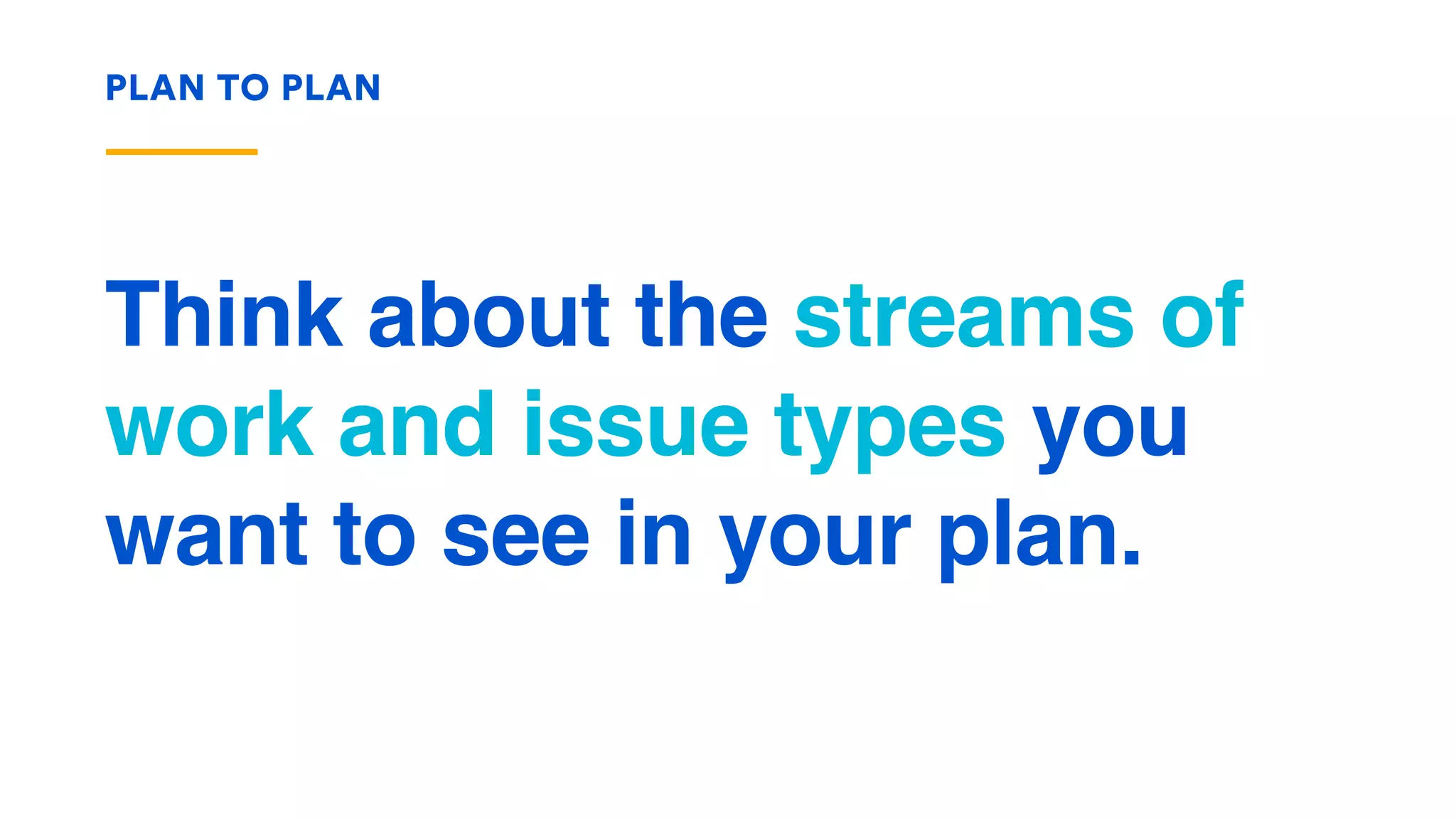

PLAN TO PLAN
Creating a call-out
Watch the tutorial in the Presentation
Guidelines Keynote to learn how to
create call-outs on screenshots within
this template.

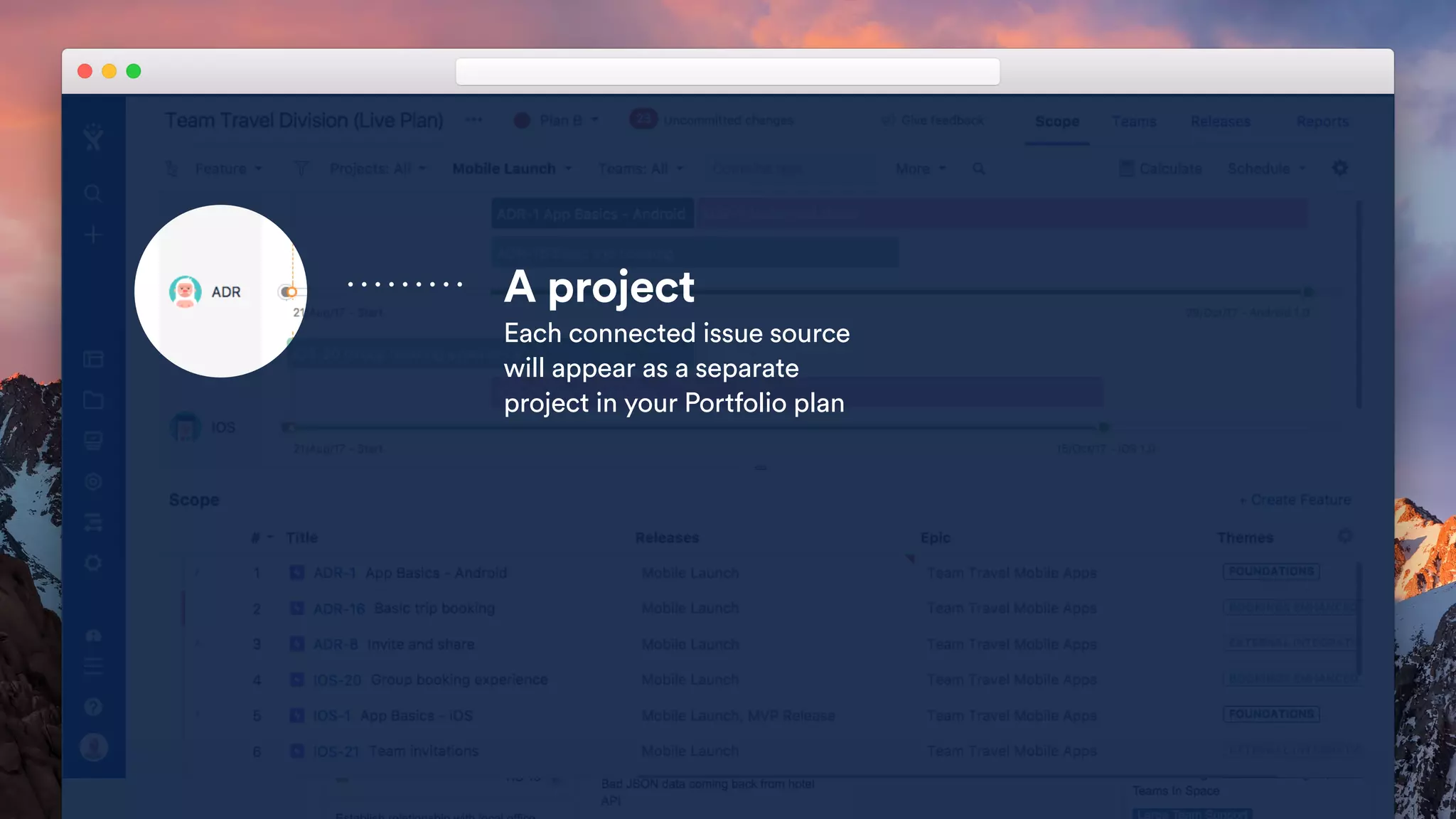

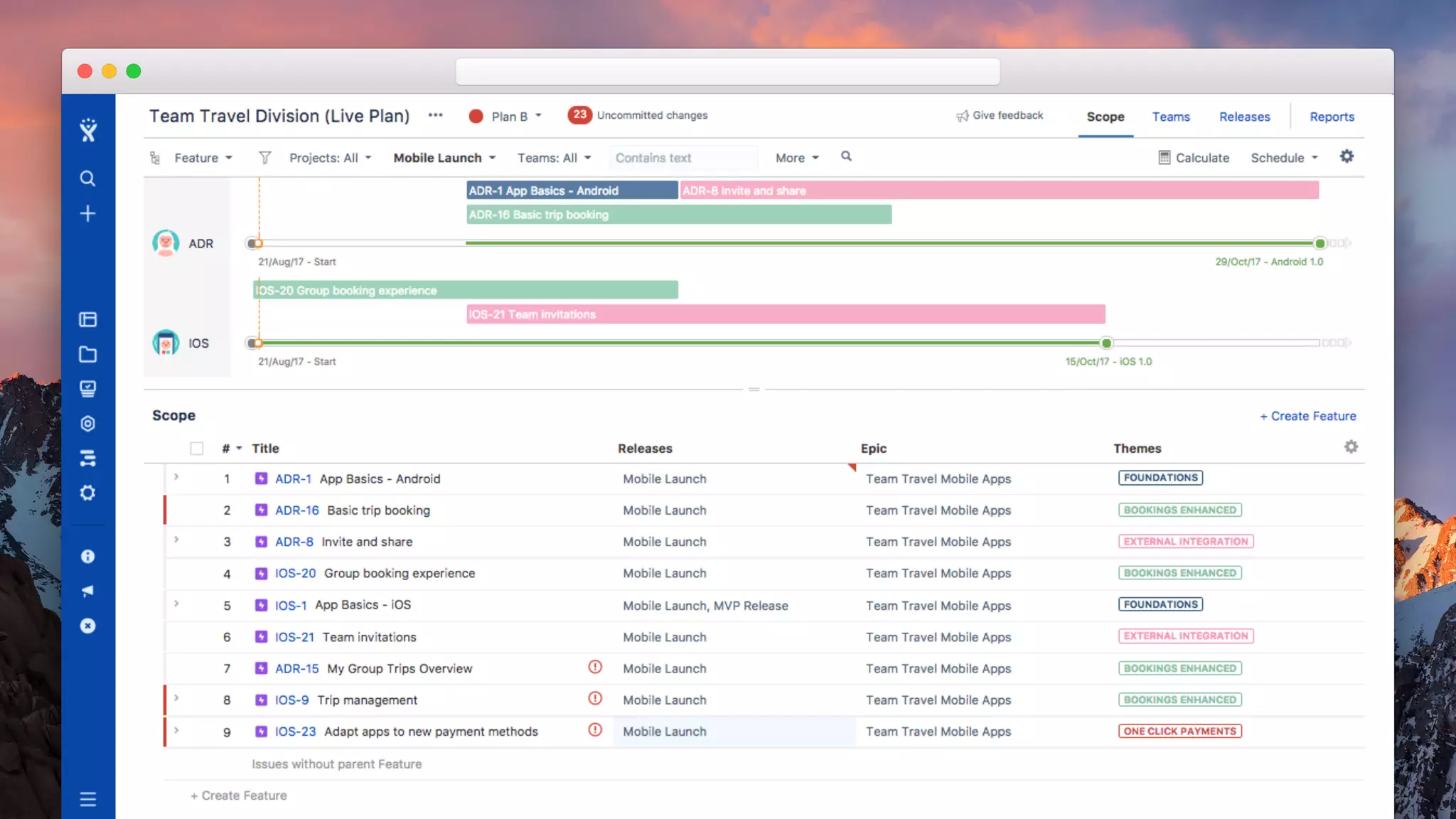

A project
Each connected issue source
will appear as a separate
project in your Portfolio plan
Releases

=
Versions

=

Time

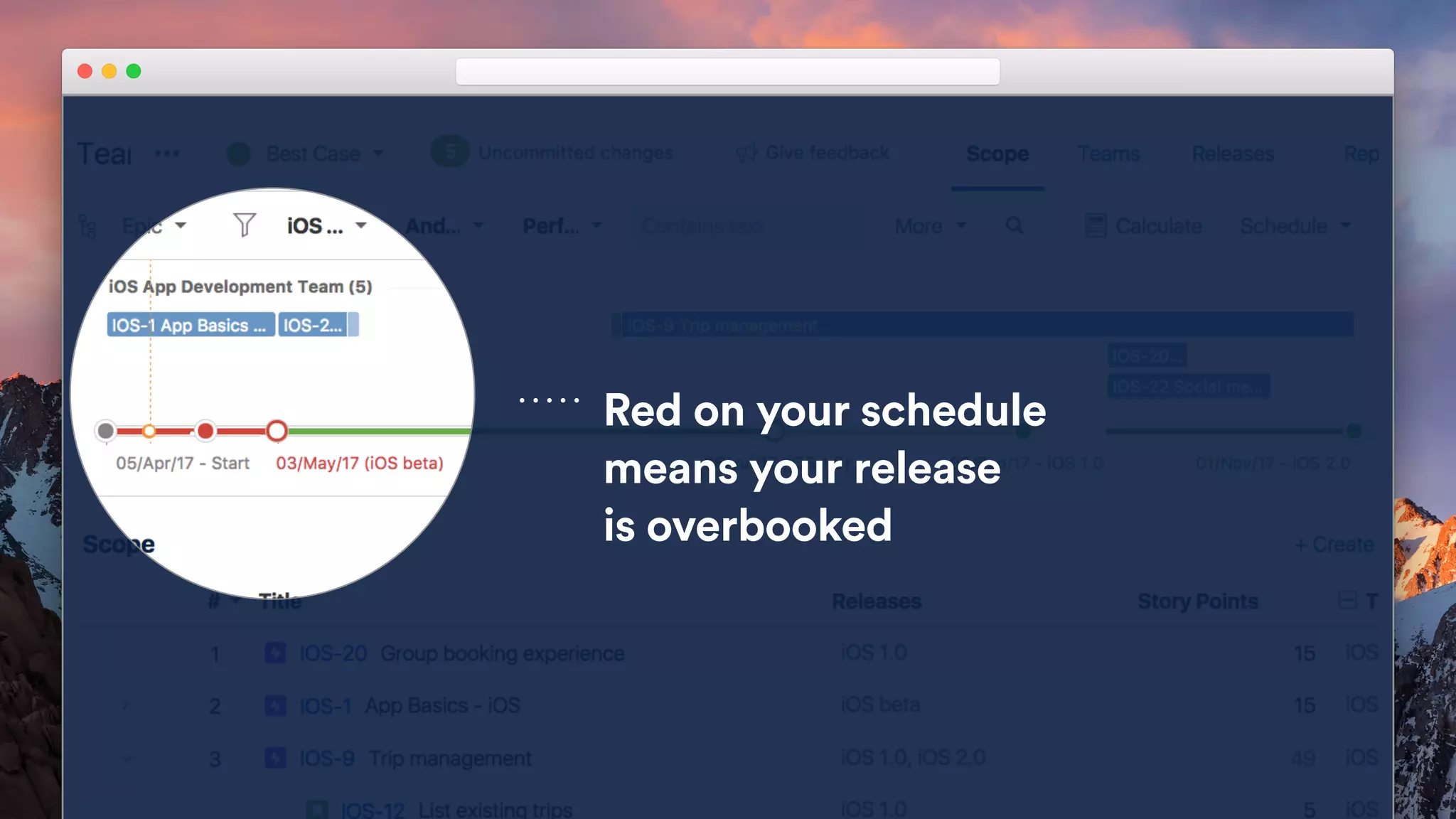

Red on your schedule
means your release

is overbooked
I want to align several
streams of work to the

same goal

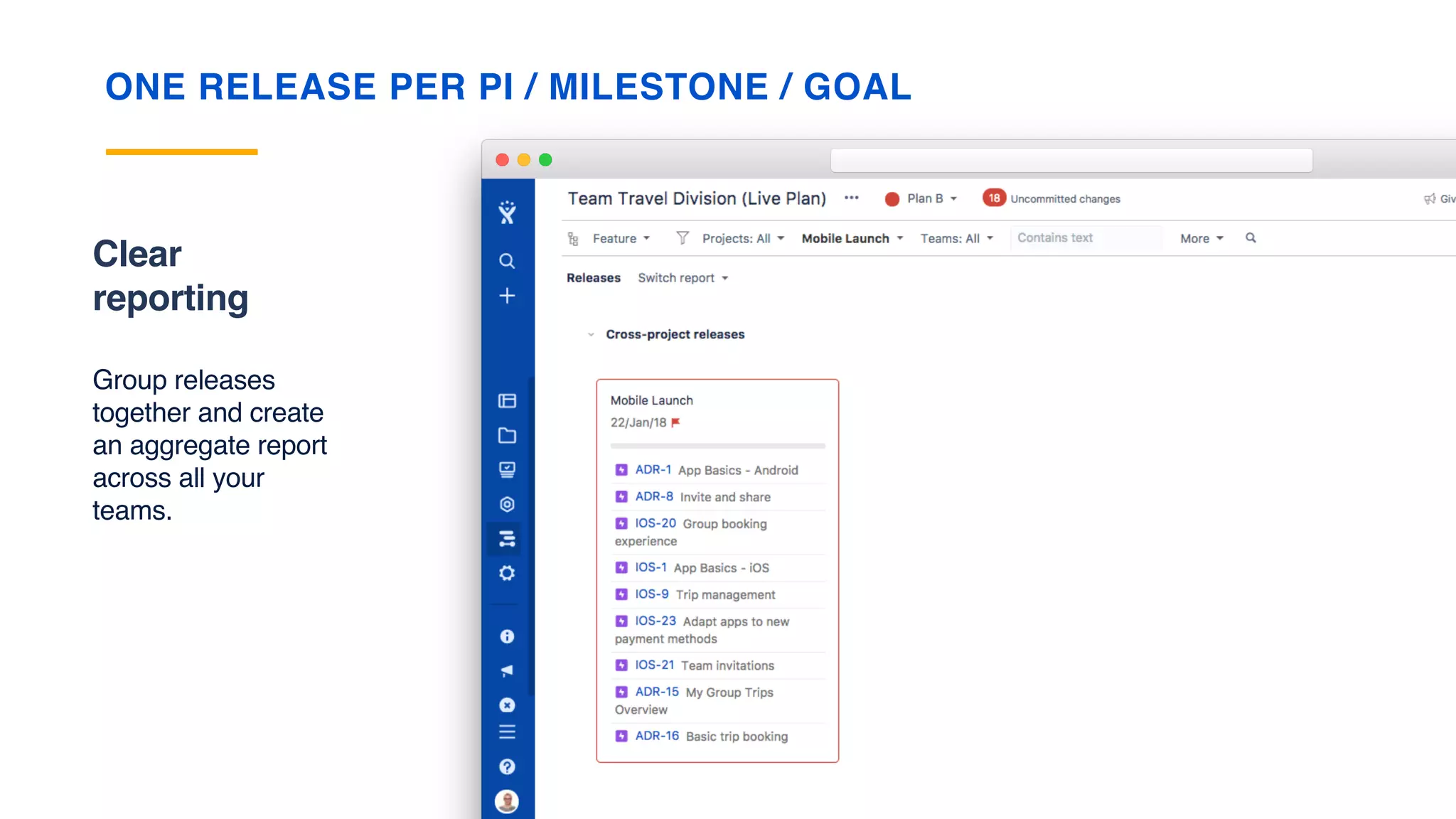

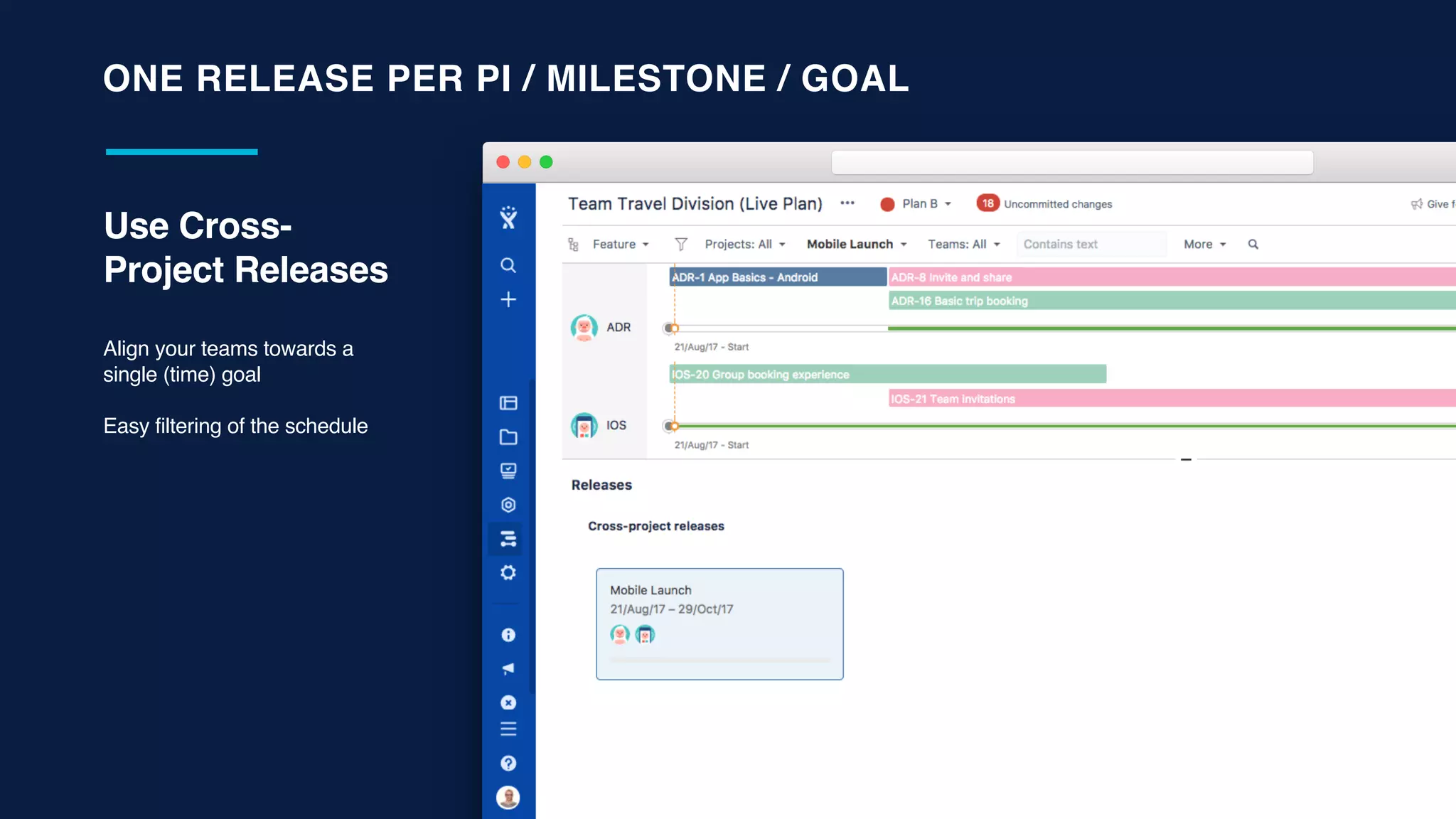

ONE RELEASE PER PI/MILESTONE/GOAL
Use Cross-
Project Releases
Align your teams towards a
single (time) goal
Easy filtering of the schedule
ONE RELEASE PER PI / MILESTONE / GOAL
ONE RELEASE PER PI / MILESTONE / GOAL
Clear
reporting
Group releases
together and create
an aggregate report
across all your
teams.
I want to clearly visualize all
the dependencies in my plan
so I can manage them

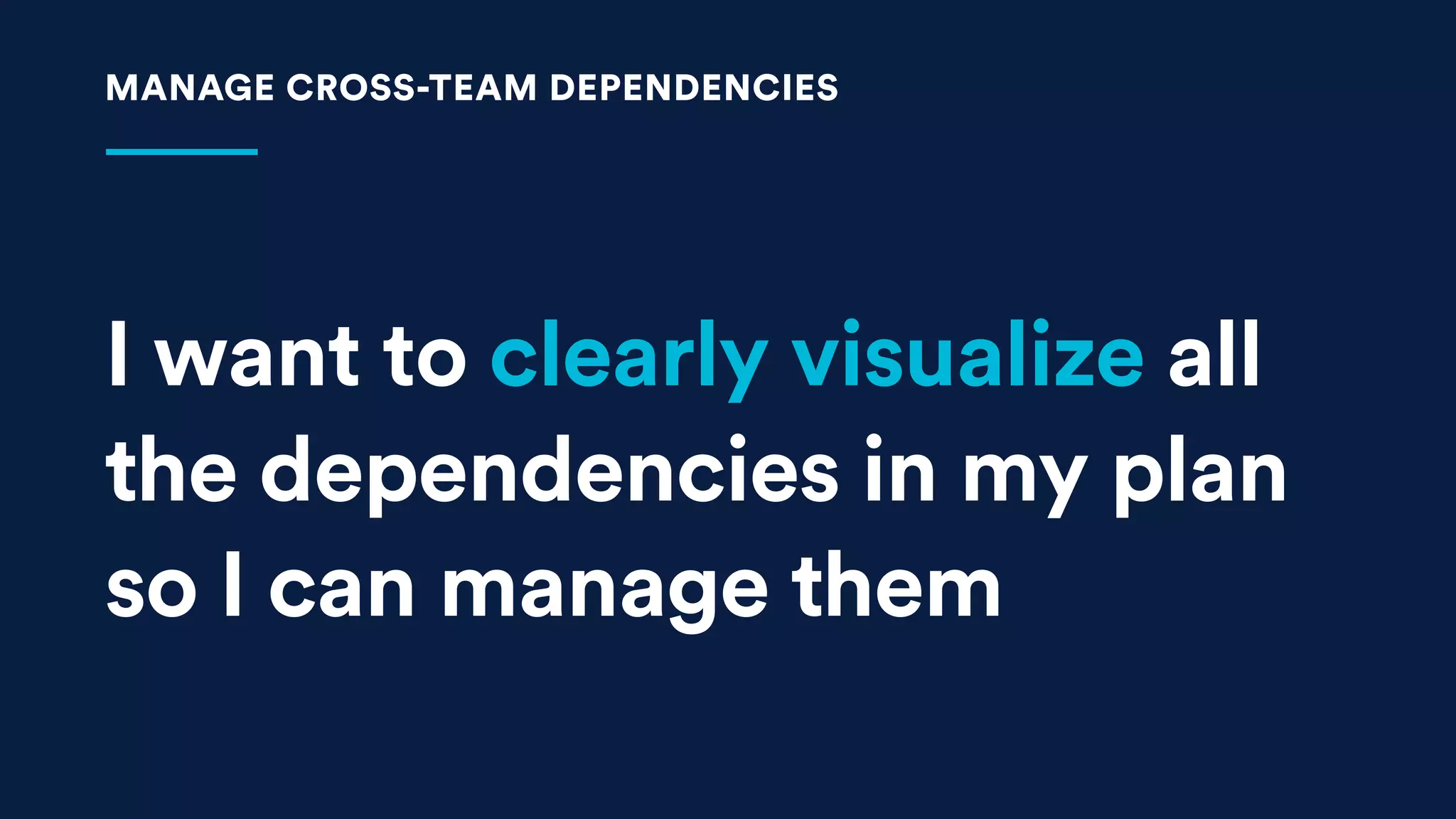

MANAGE CROSS-TEAM DEPENDENCIES

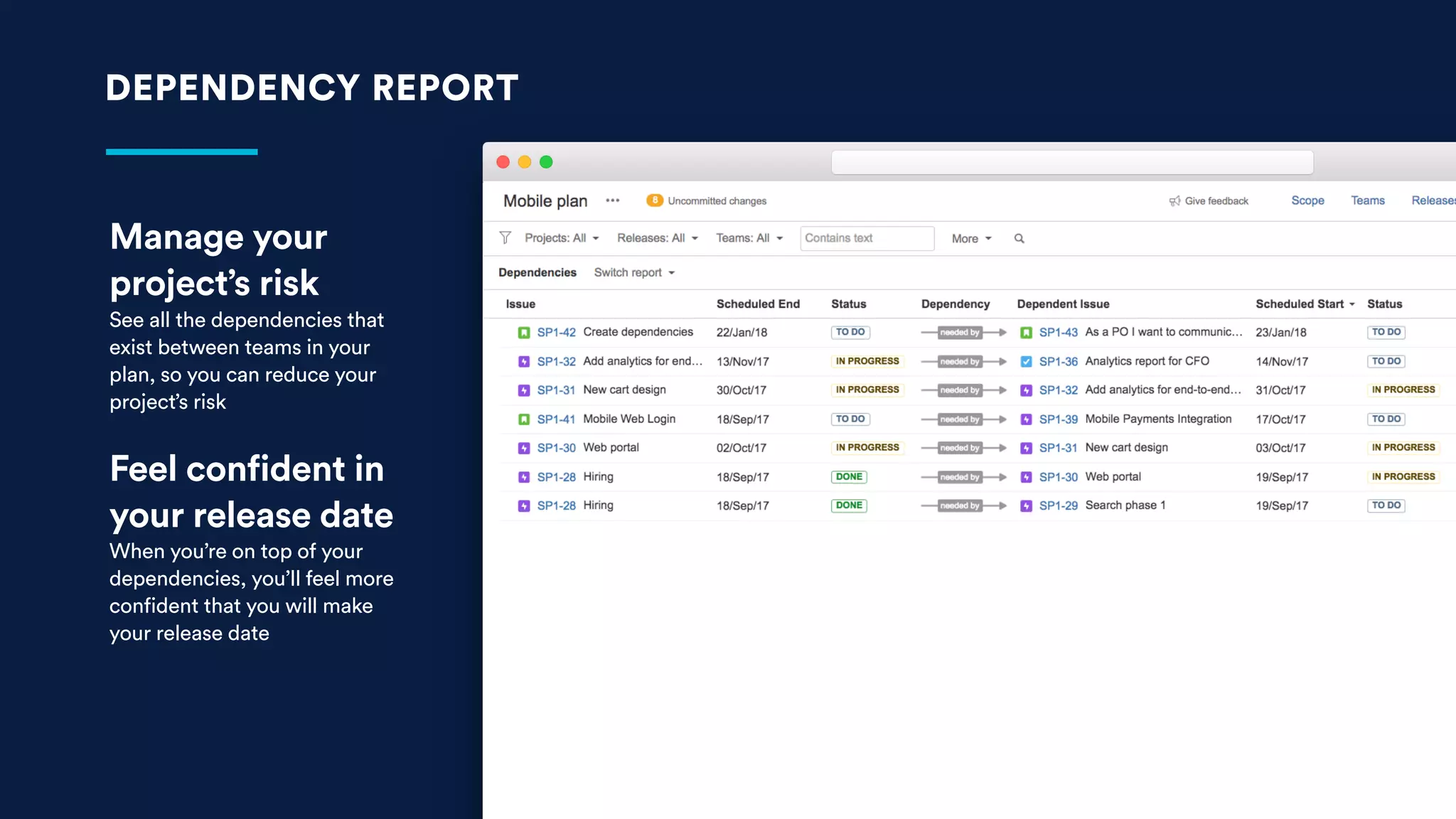

DEPENDENCY REPORT
Manage your
project’s risk
See all the dependencies that
exist between teams in your
plan, so you can reduce your
project’s risk
Feel confident in
your release date
When you’re on top of your
dependencies, you’ll feel more
confident that you will make
your release date
I want to connect the

team’s work to strategy

so execs know we are
working on the right things

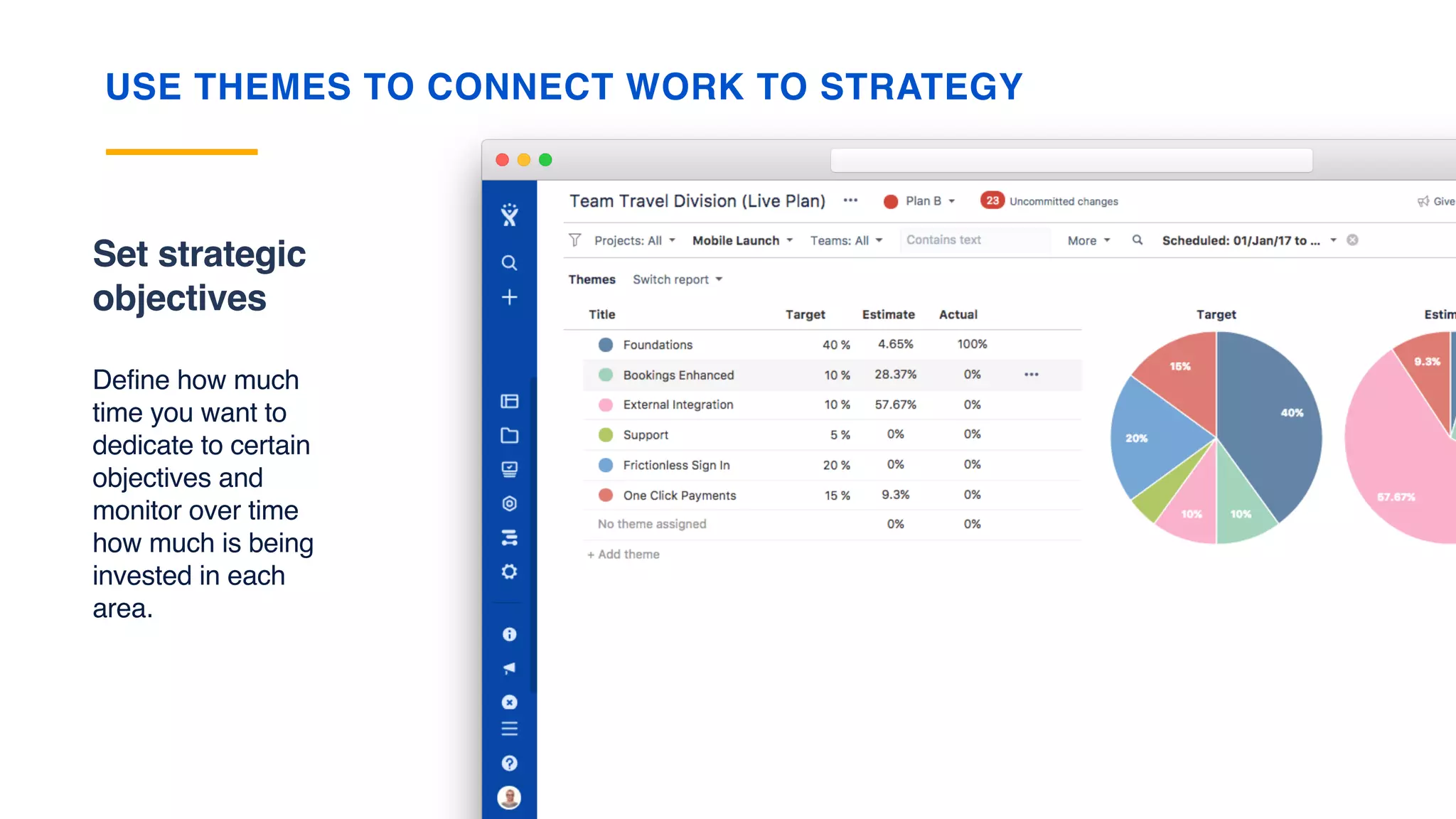

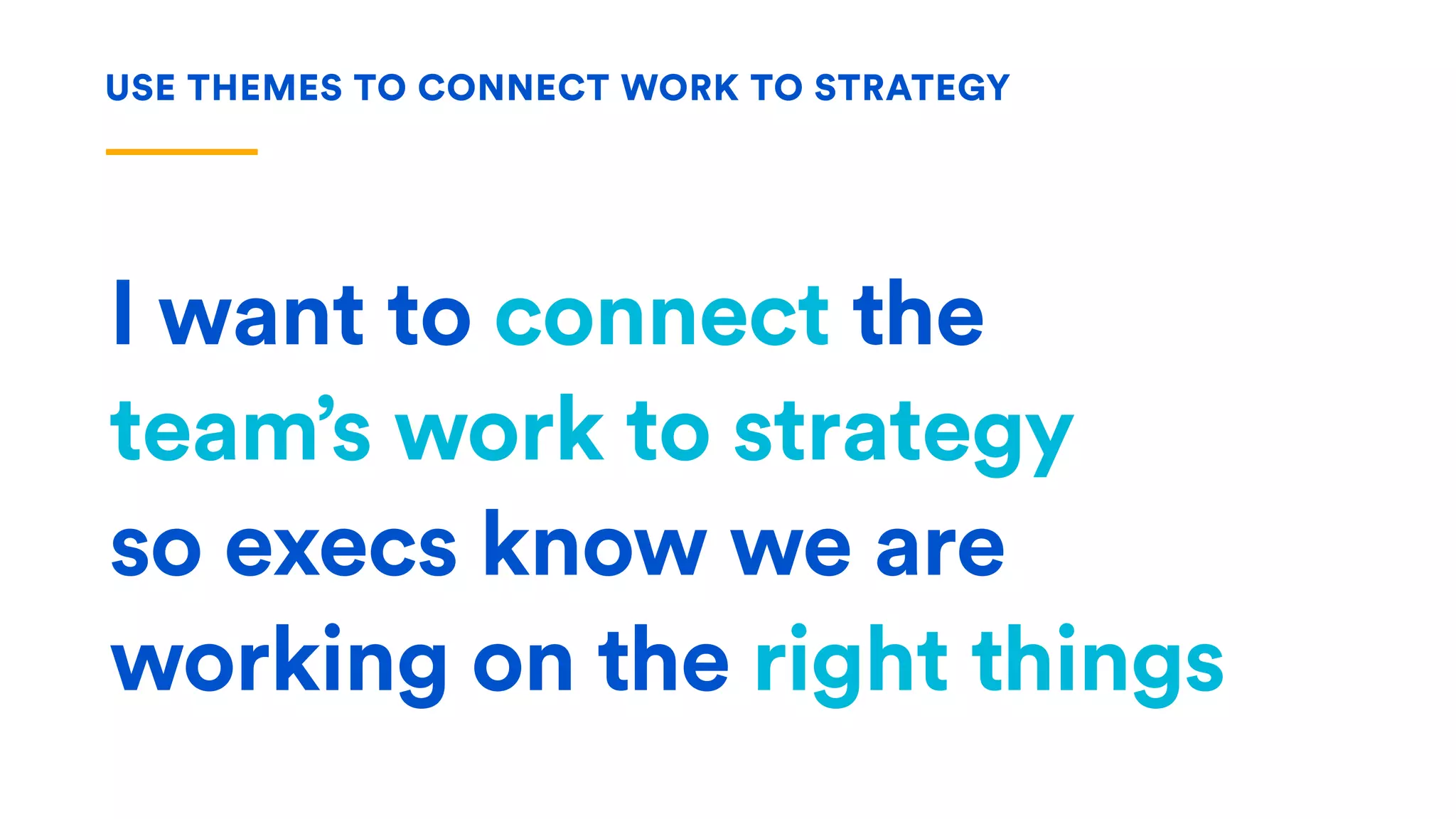

USE THEMES TO CONNECT WORK TO STRATEGY
Set strategic
objectives
Define how much
time you want to
dedicate to certain
objectives and
monitor over time
how much is being
invested in each
area.
USE THEMES TO CONNECT WORK TO STRATEGY
Please remember
You don’t always need the line or text at all.
I want to combine

several plans into a

single view

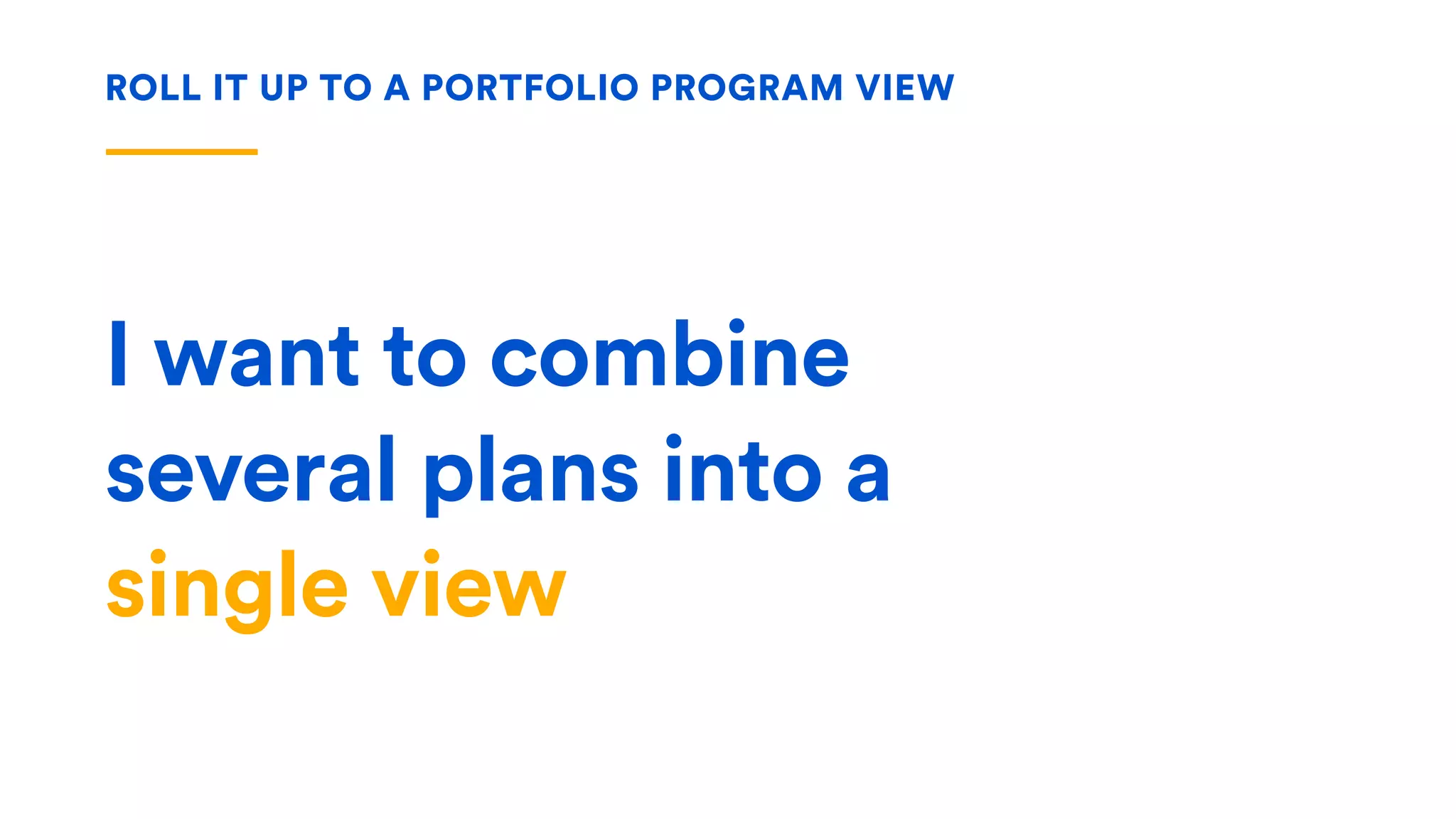

ROLL IT UP TO A PORTFOLIO PROGRAM VIEW
ROLL IT UP TO A PORTFOLIO PROGRAM VIEW

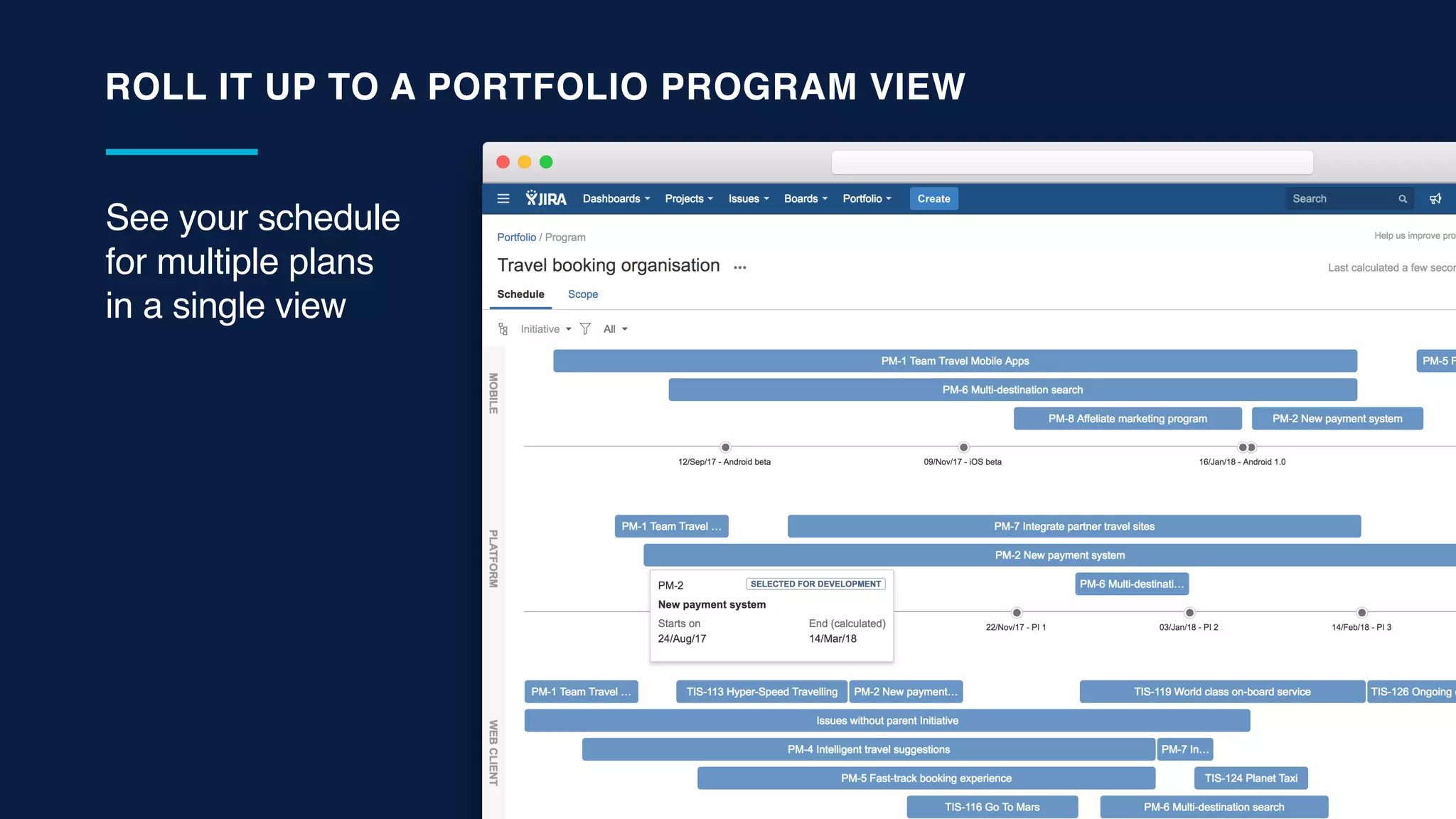

See your schedule
for multiple plans
in a single view
ROLL IT UP TO A PORTFOLIO PROGRAM VIEW

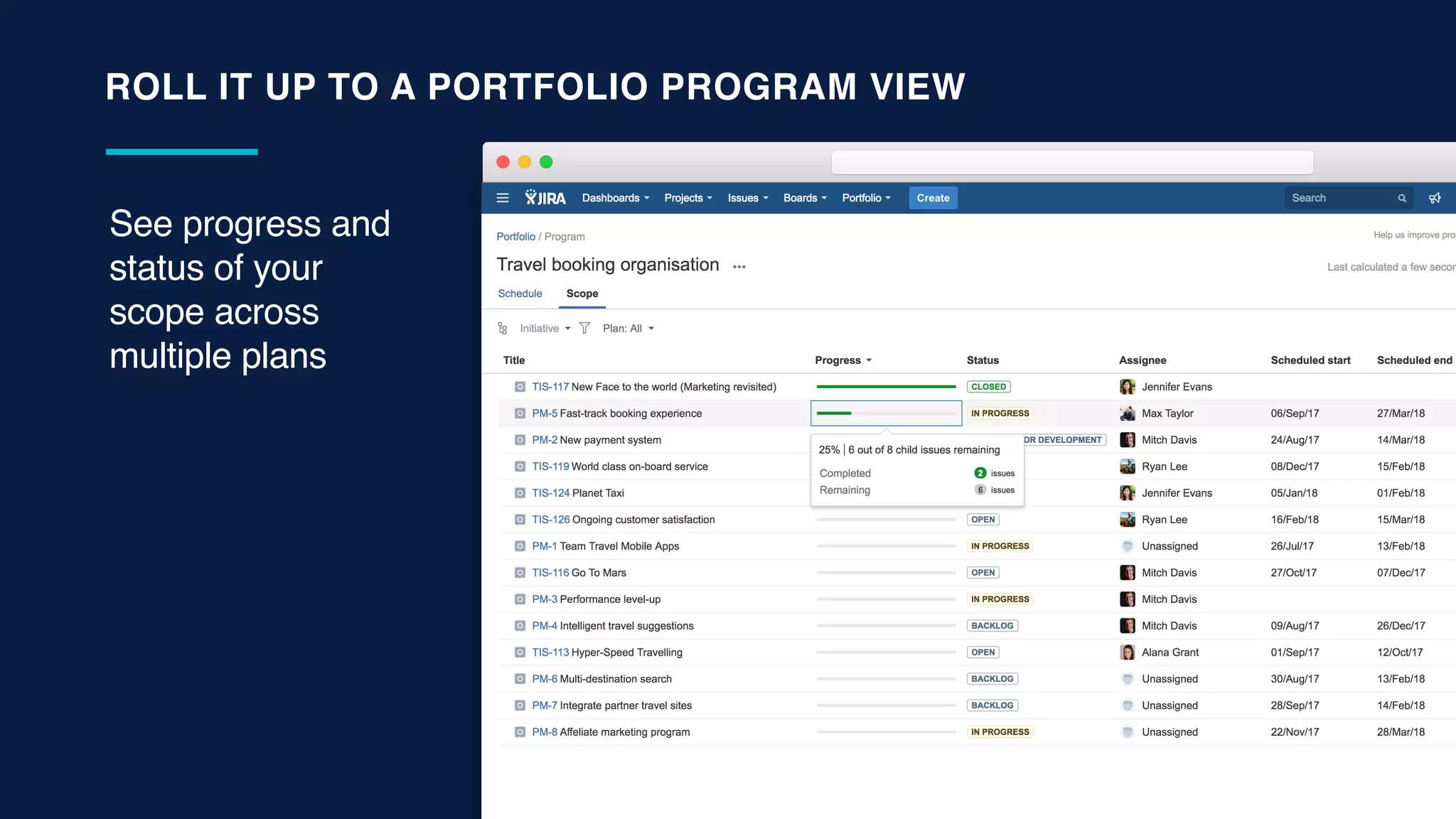

See progress and
status of your
scope across
multiple plans
I want to build a

reporting dashboard

for visibility
SHARE REPORTS IN CONFLUENCE

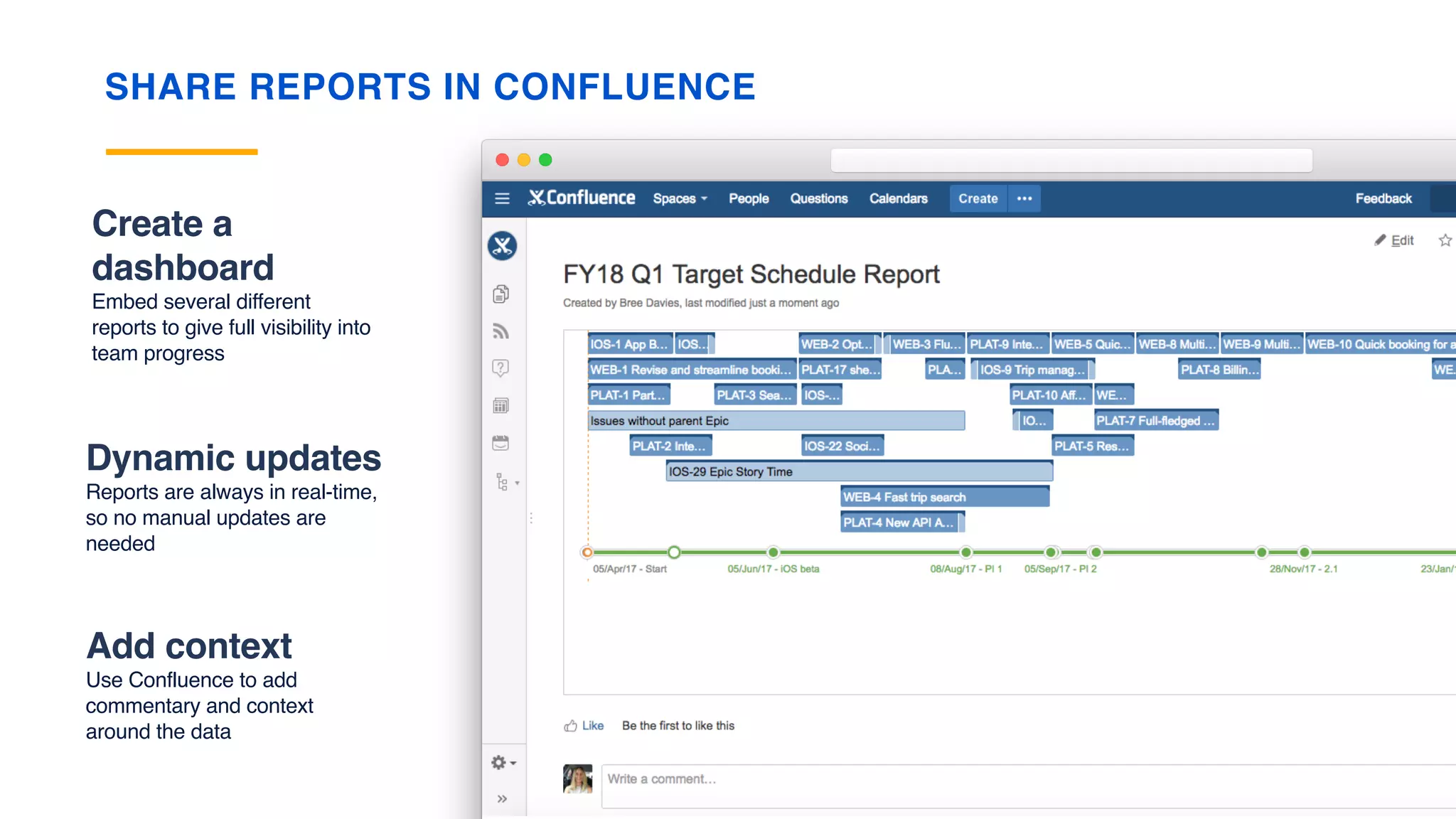

Create a
dashboard
Embed several different
reports to give full visibility into
team progress
SHARE REPORTS IN CONFLUENCE
Dynamic updates
Reports are always in real-time,
so no manual updates are
needed
Add context
Use Confluence to add
commentary and context
around the data
Please remember
You don’t always need the line or text at all.
Source of Truth
Product Managers and
Owners use this view to make
sure the right work is going to
be executed
Collaboration
Teams can see what’s been
scheduled. Work can be
easily shared across teams if
capacity and velocity allows
Visibility
One plan per program allows
a clear view of the work

in each sprint

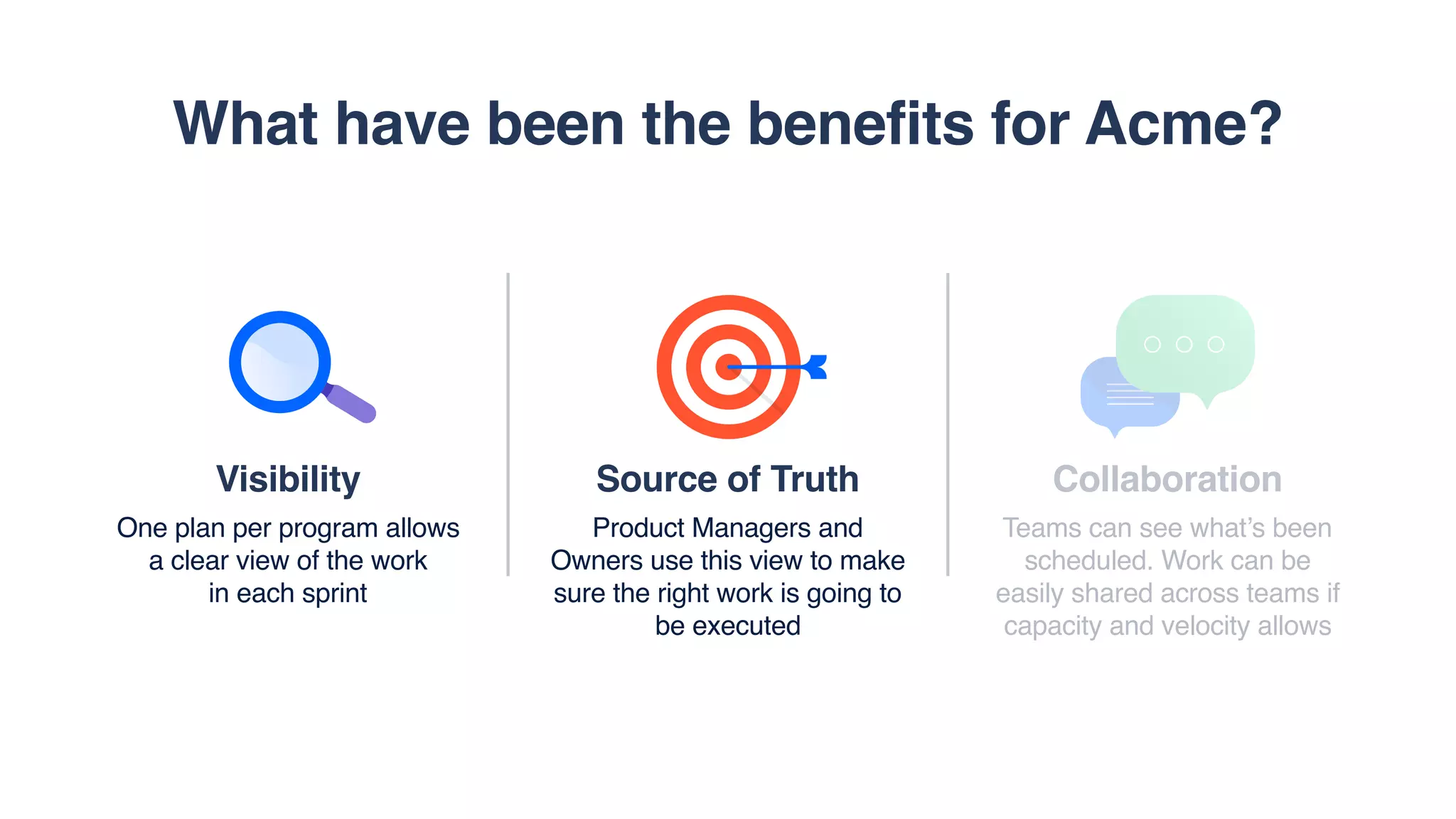

What have been the benefits for Acme?
Source of Truth
Product Managers and
Owners use this view to make
sure the right work is going to
be executed
Collaboration
Teams can see what’s been
scheduled. Work can be
easily shared across teams if
capacity and velocity allows
Visibility
One plan per program allows
a clear view of the work

in each sprint
What have been the benefits for Acme?
Source of Truth
Product Managers and
Owners use this view to make
sure the right work is going to
be executed
Collaboration
Teams can see what’s been
scheduled. Work can be
easily shared across teams if
capacity and velocity allows
Visibility
One plan per program allows
a clear view of the work

in each sprint
What have been the benefits for Acme?
There’s different
ways to scale agile
Do your research and understand
which is the best framework for your
company. It might not be just one.
Scrum of Scrums
Next ‘level’ up from one-team scrum, with a daily
meeting of ambassadors from each team to
emphasise communication and coordination
Large Scale Scrum
Takes the scrum ceremonies and has two
frameworks to scale across different sized teams
Disciplined Agile
A decision making framework which is a
modification of scrum and also borrows from Agile
Modeling, XP, Kanban and Lean
Scrum of Scrums
Next ‘level’ up from one-team scrum, with a daily
meeting of ambassadors from each team to
emphasise communication and coordination
Large Scale Scrum
Takes the scrum ceremonies and has two
frameworks to scale across different sized teams
Disciplined Agile
A decision making framework which is a
modification of scrum and also borrows from Agile
Modeling, XP, Kanban and Lean
Scrum of Scrums
Next ‘level’ up from one-team scrum, with a daily
meeting of ambassadors from each team to
emphasise communication and coordination
Large Scale Scrum
Takes the scrum ceremonies and has two
frameworks to scale across different sized teams
Disciplined Agile
A decision making framework which is a
modification of scrum and also borrows from Agile
Modeling, XP, Kanban and Lean
When scaling agile across
an entire organization,
focus on “just enough”
DAN RADIGAN - THE AGILE COACH
Agenda
Why should I scale agile?
Keep Jira simple
Optimise your hierarchy for comms
Plan to plan
Agenda
Why should I scale agile?
Keep Jira simple
Optimise your hierarchy for comms
Plan to plan
Takeaways
Keep Jira
simple
Match your
hierarchy to
your org
Plan to plan Scaling is
more than just
a set of tools
Takeaways
Thank you!
BREE DAVIES | PRODUCT MANAGER | @BREEDAVIES

Scaling Agile with Portfolio for Jira

  • 1.
    Scaling agile with
 Portfolio for Jira BREE DAVIES | PRODUCT MANAGER | @BREEDAVIES
  • 2.
  • 3.
    It’s not just
 about tools;
 it’s about people* THE STORY OF A SCALED AGILE JOURNEY *but tools help a bunch
  • 4.
    Agenda Keep Jira simple Optimiseyour hierarchy for comms Plan to plan Takeaways
  • 5.
    Agenda Why should Iscale agile? Keep Jira simple Optimise your hierarchy for comms Plan to plan Takeaways
  • 6.
    How did afast-growing
 auto insurance company
 scale their agile operations? Source: Shutterstock
  • 7.
    Needed management of cross-teamdependencies Planning was inefficient We were relying on spreadsheets Managing teams was a manual and time-consuming effort
  • 8.
    Needed management of cross-teamdependencies Planning was inefficient We were relying on spreadsheets Managing teams was a manual and time-consuming effort
  • 9.
    Needed management of cross-teamdependencies Planning was inefficient We were relying on spreadsheets Managing teams was a manual and time-consuming effort
  • 10.

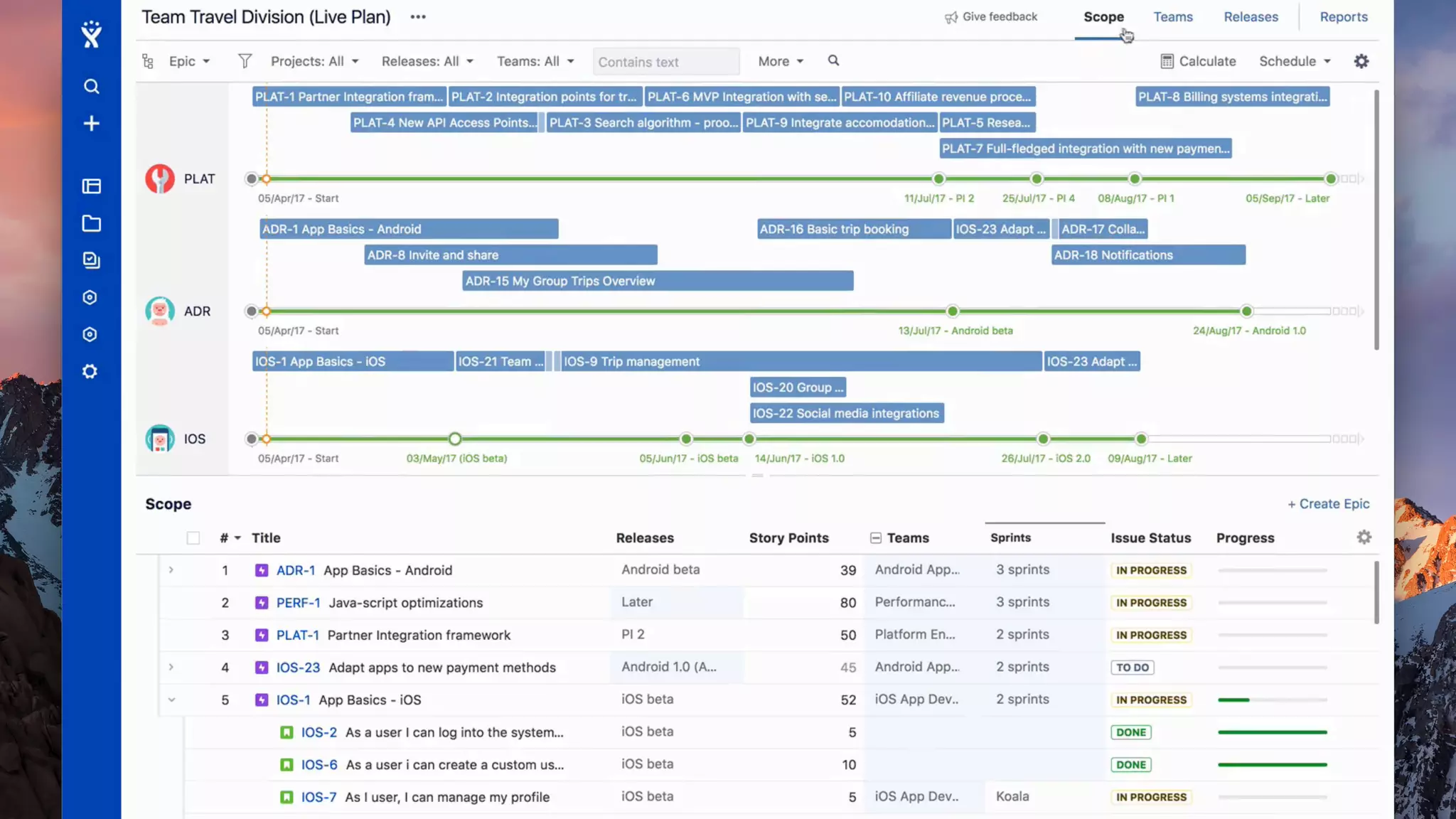

    Scaled agile allowed themanagement and coordination of multiple teams that work on all stages of
 a large project Source: Shutterstock
  • 11.
    2014 1 scrum team Scalingagile doesn’t happen overnight
  • 12.
    2014 1 scrum team 2017 13scrum teams Scaling agile doesn’t happen overnight
  • 13.
    2014 1 scrum team 2017 13scrum teams Scaling agile doesn’t happen overnight
  • 14.
    2014 1 scrum team 2017 13scrum teams Scaling agile doesn’t happen overnight
  • 15.
    2014 1 scrum team 2017 13scrum teams Scaling agile doesn’t happen overnight
  • 16.
    PORTFOLIO FOR JIRA Data-driven roadmap Visibilityfor everyone on progress Seamless integration
 with Jira
  • 18.
  • 19.
    SAFe ‘program’ A levelwithin the SAFe framework ‘Programs’ Portfolio ‘program’ A feature which allows you to aggregate many plans into a single view Customer ‘program’ How you may structure your teams. Many feature teams, for example, may make up a ‘Program’ in your company
  • 20.
    SAFe ‘program’ A levelwithin the SAFe framework ‘Programs’ Portfolio ‘program’ A feature which allows you to aggregate many plans into a single view Customer ‘program’ How you may structure your teams. Many feature teams, for example, may make up a ‘Program’ in your company
  • 21.
    SAFe ‘program’ A levelwithin the SAFe framework ‘Programs’ Portfolio ‘program’ A feature which allows you to aggregate many plans into a single view Customer ‘program’ How you may structure your teams. Many feature teams, for example, may make up a ‘Program’ in your company
  • 22.
    Agenda Why should Iscale agile? Optimise your hierarchy for comms Plan to plan Takeaways
  • 23.
    Agenda Why should Iscale agile? Keep Jira simple Optimise your hierarchy for comms Plan to plan Takeaways
  • 24.
    Be clear howyou will organize your teams
 before you put tools
 around them. SET STRONG FOUNDATIONS
  • 25.
    What’s under ourcustomer’s Jira hood? Each board is based based on a filter using a custom field for ‘Program’ and then, separated by team.
  • 26.
    FixVersion Essential for using
 Releases in Portfolio Estimate We rely on this to understand the size of your work Team Field See and share your team assignments Parent Link Surface hierarchy
 on your
 Jira issues Jira fields for Portfolio success
  • 28.
    FixVersion field The linkfor communicating Release assignment for issues from Portfolio
  • 29.
    FixVersion Essential for using
 Releases in Portfolio Estimate We rely on this to understand the size of your work Team Field See and share your team assignments Parent Link Surface hierarchy
 on your
 Jira issues Jira fields for Portfolio success
  • 30.
    Creating a call-out Watchthe tutorial in the Presentation Guidelines Keynote to learn how to create call-outs on screenshots within this template. Estimate field Needed to share sizing information between Portfolio and Jira
  • 31.
    FixVersion Essential for using
 Releases in Portfolio Estimate We rely on this to understand the size of your work Team Field See and share your team assignments Parent Link Surface hierarchy
 on your
 Jira issues Jira fields for Portfolio success
  • 32.
    Team field Add toyour screens to
 see team assignment from Portfolio
  • 33.
    FixVersion Essential for using
 Releases in Portfolio Estimate We rely on this to understand the size of your work Team Field See and share your team assignments Parent Link Surface hierarchy
 on your
 Jira issues Jira fields for Portfolio success
  • 34.
    View your hierarchy Seewhere your issues fit into the next level of hierarchy upwards within Jira
  • 35.
    Creating a call-out Watchthe tutorial in the Presentation Guidelines Keynote to learn how to create call-outs on screenshots within this template. And, in reverse See all epics that fit into an initiative within Jira by using the Parent Link field
  • 36.
    Introduced minor customizations Jirawas kept simple with minimal changes The experience is consistent for all Each issue type and team use the same workflow Top down meets bottom up Teams plan three sprints ahead to their
 maximum capacity
  • 37.
    Introduced minor customizations Jirawas kept simple with minimal changes The experience is consistent for all Each issue type and team use the same workflow Top down meets bottom up Teams plan three sprints ahead to their maximum capacity
  • 38.
    Introduced minor customizations Jirawas kept simple with minimal changes The experience is consistent for all Each issue type and team use the same workflow Top down meets bottom up Teams plan three sprints ahead to their maximum capacity
  • 39.
    Custom fields arepowerful. But think carefully before
 re-creating standard Jira fields with your own. CUSTOM FIELD WARNING
  • 40.
    Determine what’s essential Keepit simple Audit your customizations I’m worried we are
 not set up for success
  • 41.
    Determine what’s essential Keepit simple Audit your customizations I’m worried we are
 not set up for success
  • 42.
    Determine what’s essential Keepit simple Audit your customizations I’m worried we are
 not set up for success
  • 43.
    Agenda Why should Iscale agile? Keep Jira simple Plan to plan Takeaways
  • 44.
    Agenda Why should Iscale agile? Keep Jira simple Optimise your hierarchy for comms Plan to plan Takeaways
  • 45.
    Match your issuehierarchy to the structure of your org, making
 plans and reports digestible for
 all audiences ALIGN YOUR HIERACHY
  • 46.
    Match your issuehierarchy to your org Product Owner Product Owner Product Managers & Business Partners Scrum Master & Team Scrum Master & Team
  • 47.
    Product Owner Scrum Master& Team Match your org to your issue hierarchy Product Managers / Business Partners / Program Management Executive Strategic Objectives
 & Programs Initiatives & Programs Epics Epics & Stories
  • 48.
    Use Portfolio’s hierarchy to
 roll up your
 work items
  • 49.
    It’s a lotof people to keep aligned
 especially when your program is moving quickly Source: Shutterstock
  • 50.
    Supporting team collaboration Inspect, adapt andplan
 Product Mangers, Product Owners and Business Partners meet regularly throughout the month.
  • 51.
    Bi-weekly portfolio planning Review thenext three releases, including; • Work release • Work per sprint • Work per team Adjust for priority,
 team velocity and cross-team dependencies EPIC LEVEL Source: Shutterstock INITIATIVE LEVEL
  • 52.
    Supporting team collaboration Prioritise communication acrosslevels
 The scrum teams escalate any issues in program meetings, which occur fortnightly.
  • 53.
    Scrum of scrums meeting Escalateissues Manage cross team dependencies Keep communication flowing Resolve blockers STORY LEVEL EPIC LEVEL Source: Shutterstock
  • 54.
    Agenda Why should Iscale agile? Keep Jira simple Optimise your hierarchy for comms Takeaways
  • 55.
    Agenda Why should Iscale agile? Keep Jira simple Optimise your hierarchy for comms Plan to plan Takeaways
  • 56.
    Think about thestreams of work and issue types you want to see in your plan. PLAN TO PLAN
  • 57.
    Creating a call-out Watchthe tutorial in the Presentation Guidelines Keynote to learn how to create call-outs on screenshots within this template. A project Each connected issue source will appear as a separate project in your Portfolio plan
  • 58.
  • 59.
    Red on yourschedule means your release
 is overbooked
  • 60.
    I want toalign several streams of work to the
 same goal ONE RELEASE PER PI/MILESTONE/GOAL
  • 61.
    Use Cross- Project Releases Alignyour teams towards a single (time) goal Easy filtering of the schedule ONE RELEASE PER PI / MILESTONE / GOAL
  • 62.
    ONE RELEASE PERPI / MILESTONE / GOAL Clear reporting Group releases together and create an aggregate report across all your teams.
  • 63.
    I want toclearly visualize all the dependencies in my plan so I can manage them MANAGE CROSS-TEAM DEPENDENCIES
  • 64.
    DEPENDENCY REPORT Manage your project’srisk See all the dependencies that exist between teams in your plan, so you can reduce your project’s risk Feel confident in your release date When you’re on top of your dependencies, you’ll feel more confident that you will make your release date
  • 65.
    I want toconnect the
 team’s work to strategy
 so execs know we are working on the right things USE THEMES TO CONNECT WORK TO STRATEGY
  • 66.
    Set strategic objectives Define howmuch time you want to dedicate to certain objectives and monitor over time how much is being invested in each area. USE THEMES TO CONNECT WORK TO STRATEGY Please remember You don’t always need the line or text at all.
  • 68.
    I want tocombine
 several plans into a
 single view ROLL IT UP TO A PORTFOLIO PROGRAM VIEW
  • 69.
    ROLL IT UPTO A PORTFOLIO PROGRAM VIEW See your schedule for multiple plans in a single view
  • 70.
    ROLL IT UPTO A PORTFOLIO PROGRAM VIEW See progress and status of your scope across multiple plans
  • 71.
    I want tobuild a
 reporting dashboard
 for visibility SHARE REPORTS IN CONFLUENCE
  • 72.
    Create a dashboard Embed severaldifferent reports to give full visibility into team progress SHARE REPORTS IN CONFLUENCE Dynamic updates Reports are always in real-time, so no manual updates are needed Add context Use Confluence to add commentary and context around the data Please remember You don’t always need the line or text at all.
  • 73.
    Source of Truth ProductManagers and Owners use this view to make sure the right work is going to be executed Collaboration Teams can see what’s been scheduled. Work can be easily shared across teams if capacity and velocity allows Visibility One plan per program allows a clear view of the work
 in each sprint What have been the benefits for Acme?
  • 74.
    Source of Truth ProductManagers and Owners use this view to make sure the right work is going to be executed Collaboration Teams can see what’s been scheduled. Work can be easily shared across teams if capacity and velocity allows Visibility One plan per program allows a clear view of the work
 in each sprint What have been the benefits for Acme?
  • 75.
    Source of Truth ProductManagers and Owners use this view to make sure the right work is going to be executed Collaboration Teams can see what’s been scheduled. Work can be easily shared across teams if capacity and velocity allows Visibility One plan per program allows a clear view of the work
 in each sprint What have been the benefits for Acme?
  • 76.
    There’s different ways toscale agile Do your research and understand which is the best framework for your company. It might not be just one.
  • 77.
    Scrum of Scrums Next‘level’ up from one-team scrum, with a daily meeting of ambassadors from each team to emphasise communication and coordination Large Scale Scrum Takes the scrum ceremonies and has two frameworks to scale across different sized teams Disciplined Agile A decision making framework which is a modification of scrum and also borrows from Agile Modeling, XP, Kanban and Lean
  • 78.
    Scrum of Scrums Next‘level’ up from one-team scrum, with a daily meeting of ambassadors from each team to emphasise communication and coordination Large Scale Scrum Takes the scrum ceremonies and has two frameworks to scale across different sized teams Disciplined Agile A decision making framework which is a modification of scrum and also borrows from Agile Modeling, XP, Kanban and Lean
  • 79.
    Scrum of Scrums Next‘level’ up from one-team scrum, with a daily meeting of ambassadors from each team to emphasise communication and coordination Large Scale Scrum Takes the scrum ceremonies and has two frameworks to scale across different sized teams Disciplined Agile A decision making framework which is a modification of scrum and also borrows from Agile Modeling, XP, Kanban and Lean
  • 80.
    When scaling agileacross an entire organization, focus on “just enough” DAN RADIGAN - THE AGILE COACH
  • 81.
    Agenda Why should Iscale agile? Keep Jira simple Optimise your hierarchy for comms Plan to plan
  • 82.
    Agenda Why should Iscale agile? Keep Jira simple Optimise your hierarchy for comms Plan to plan Takeaways
  • 83.
    Keep Jira simple Match your hierarchyto your org Plan to plan Scaling is more than just a set of tools Takeaways
  • 84.
    Thank you! BREE DAVIES| PRODUCT MANAGER | @BREEDAVIES
