Embed presentation
Downloaded 16 times

The document outlines the development project for a mobile application aimed at enhancing women's safety by allowing them to share their location and send emergency messages with a single click. It describes the project's planning, scope, objectives, and the software engineering practices to be employed, as well as the team structure, project estimation costs, milestone payments, and testing procedures. The application will operate on popular Android smartphones and aims to provide continuous location tracking to ensure quick rescue in dangerous situations.

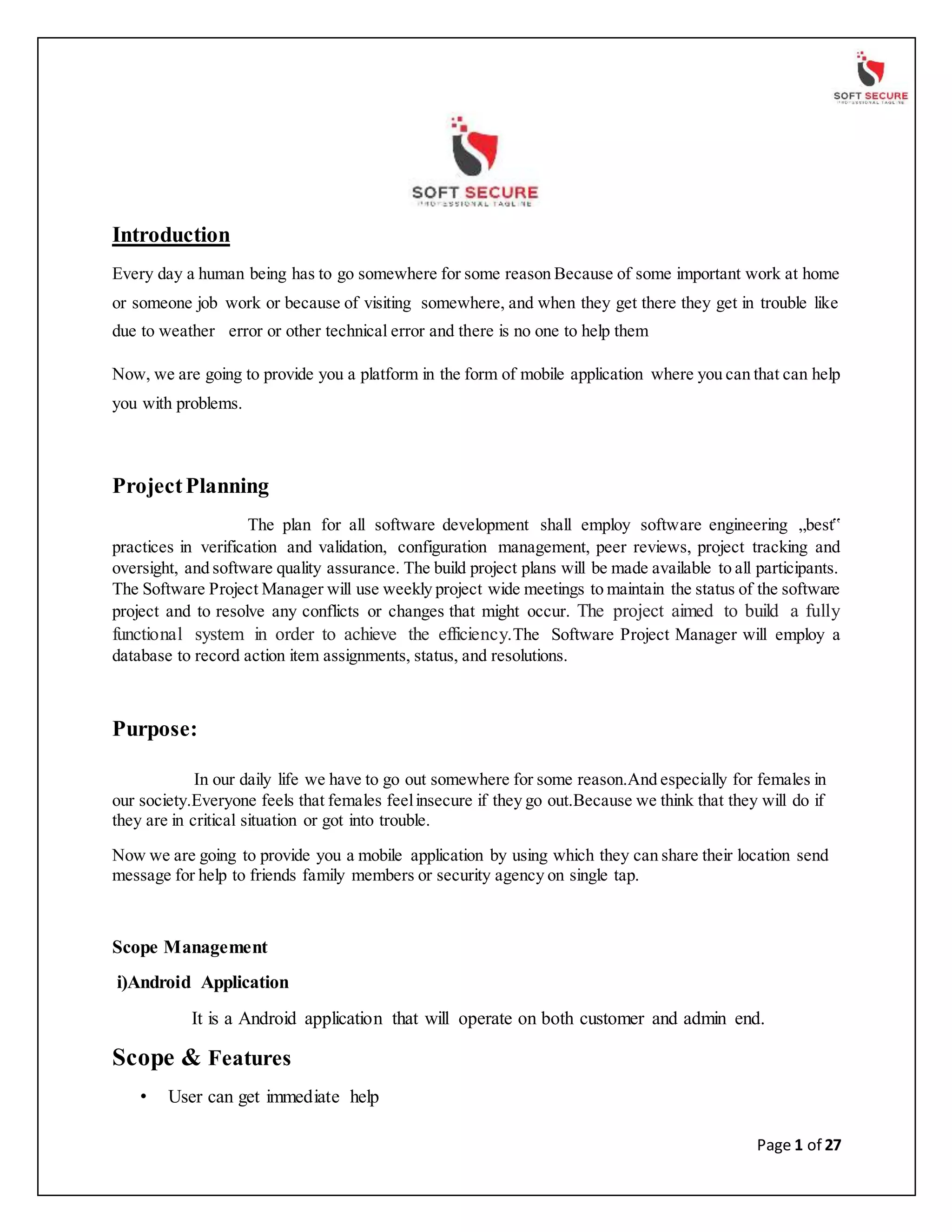

Outlines the need for a mobile application for emergency help, especially for women's safety, and introduces the project framework.

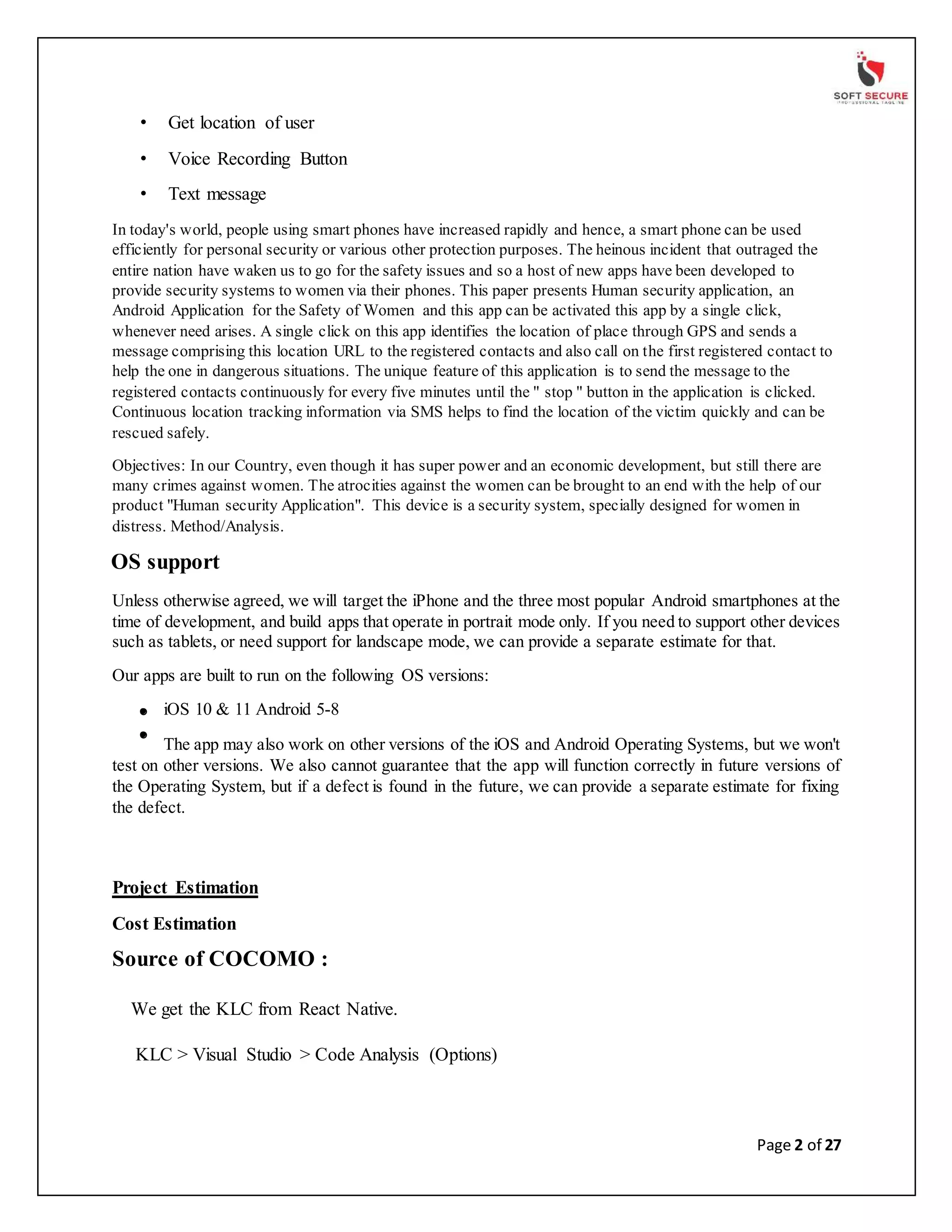

Describes key features of the Human Security Application, including GPS tracking, voice recording, and continuous location updates for user safety.

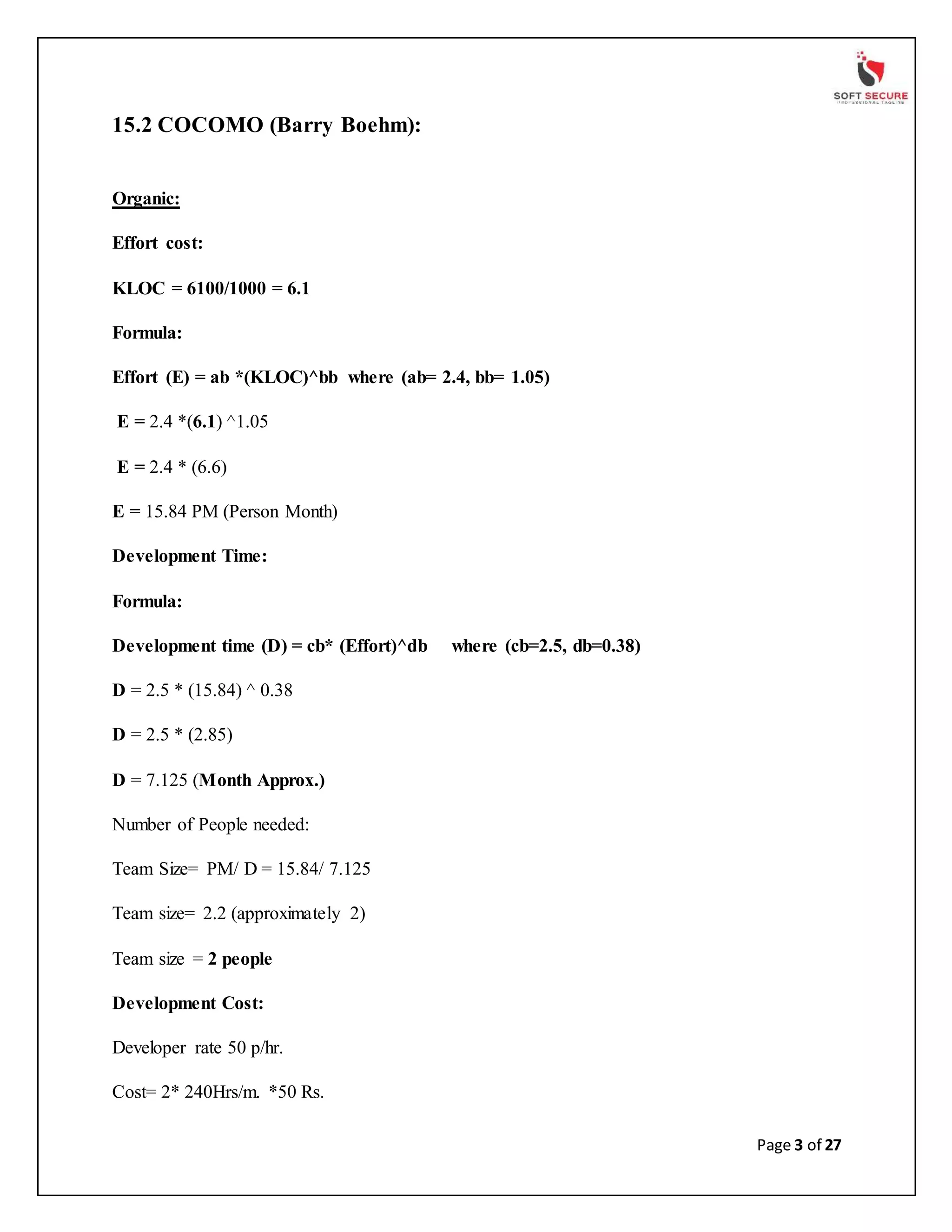

Details the COCOMO model for estimating project effort, time, and costs associated with developing the app.

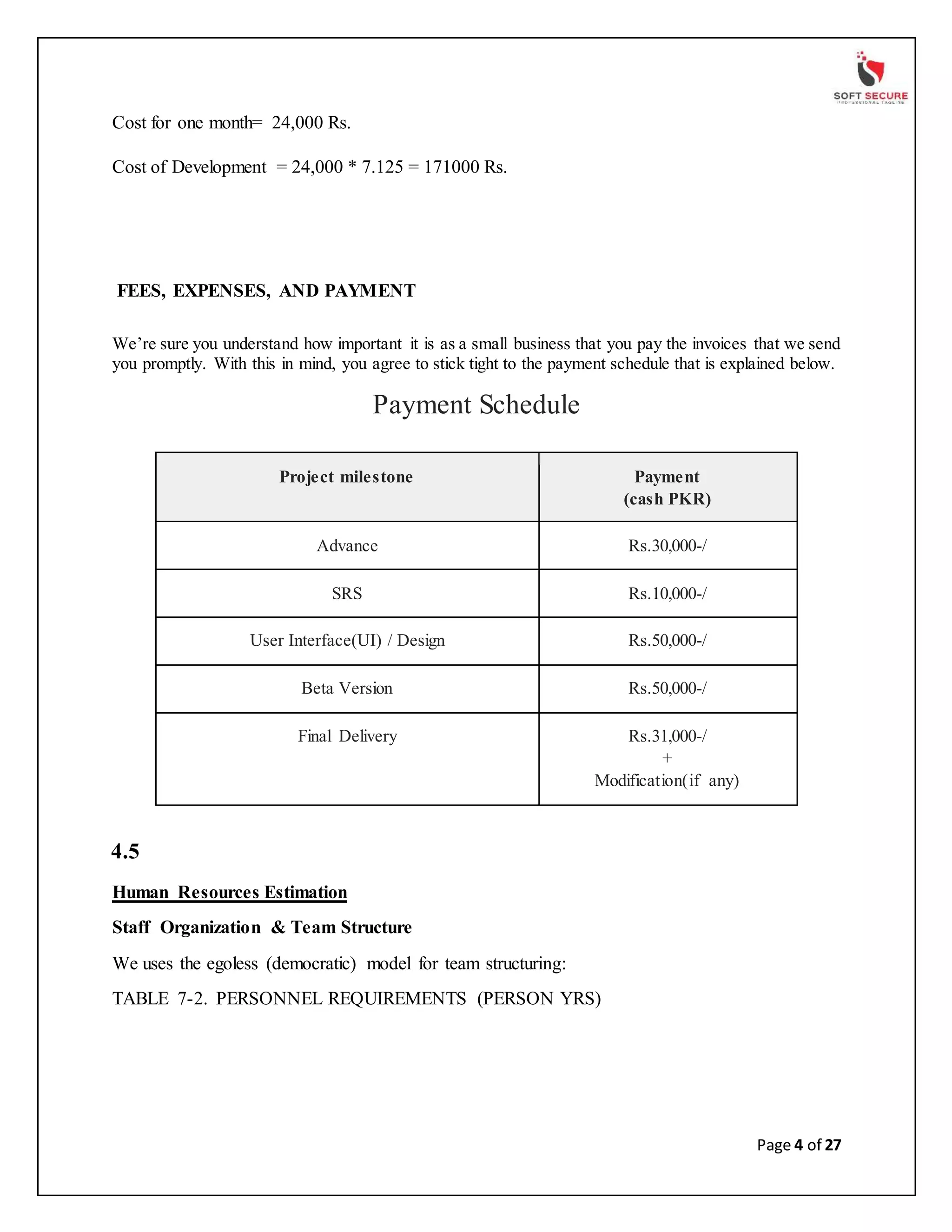

Provides the financial details including a payment schedule and overall estimated development cost of 171,000 Rs.

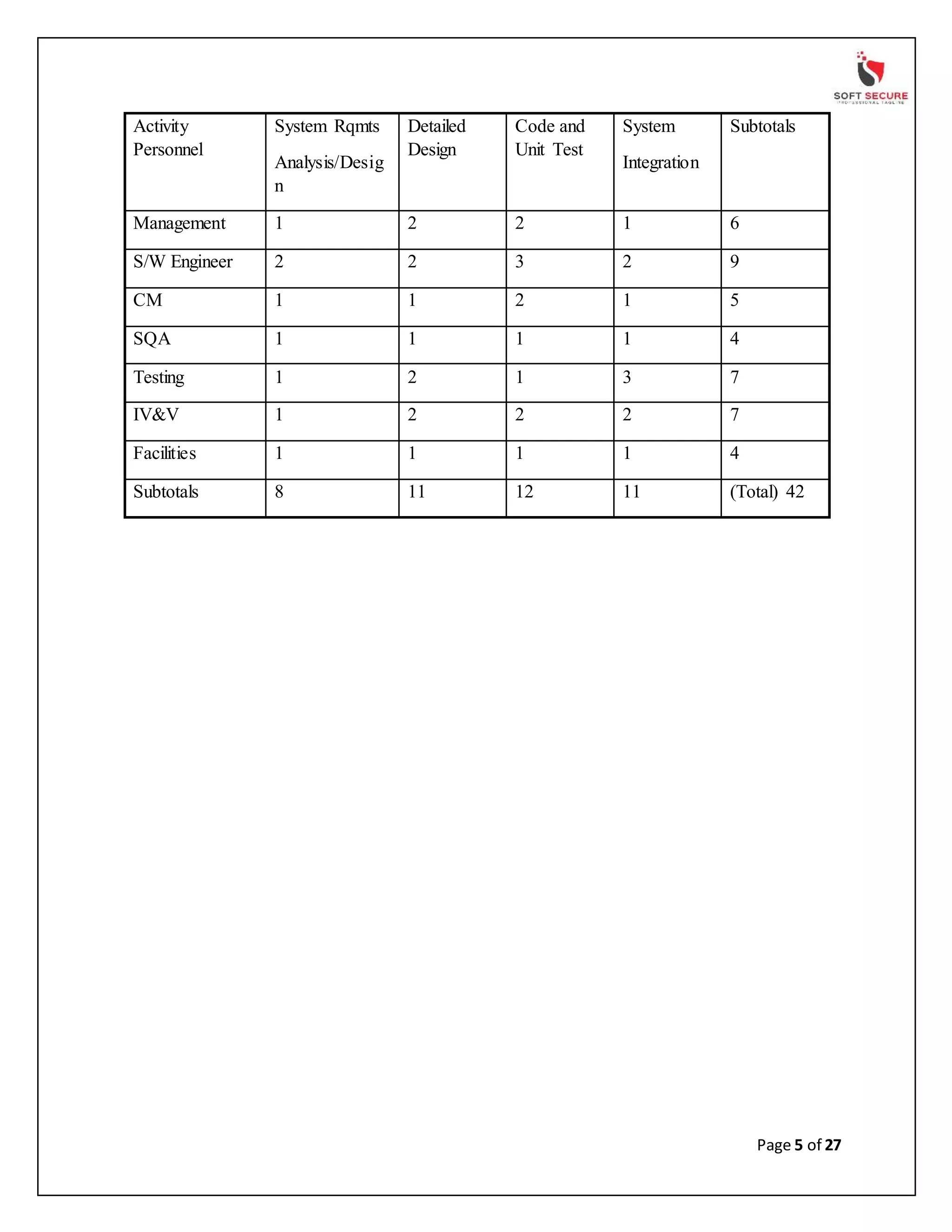

Lists required personnel for various project phases, indicating a total of 42 person-years needed for the development.

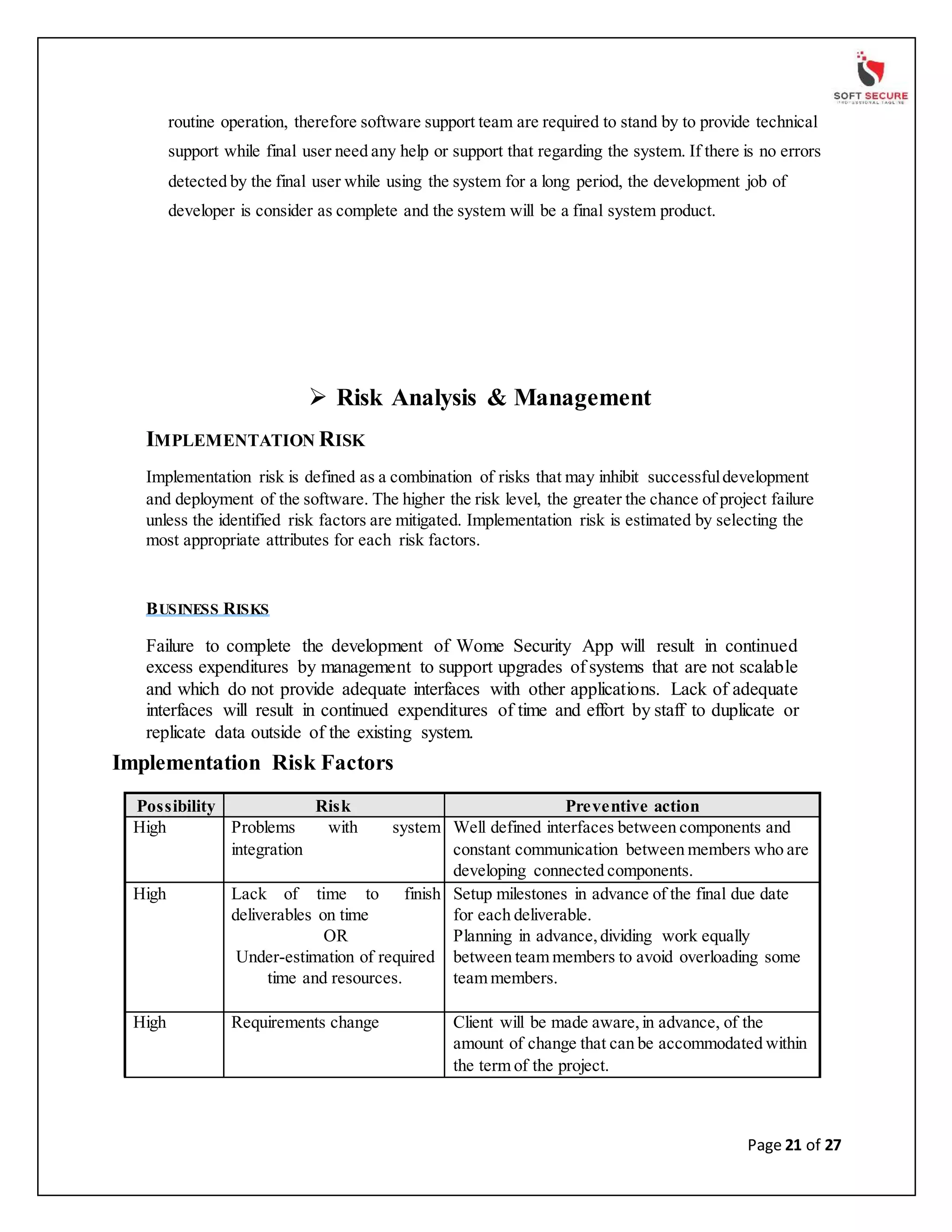

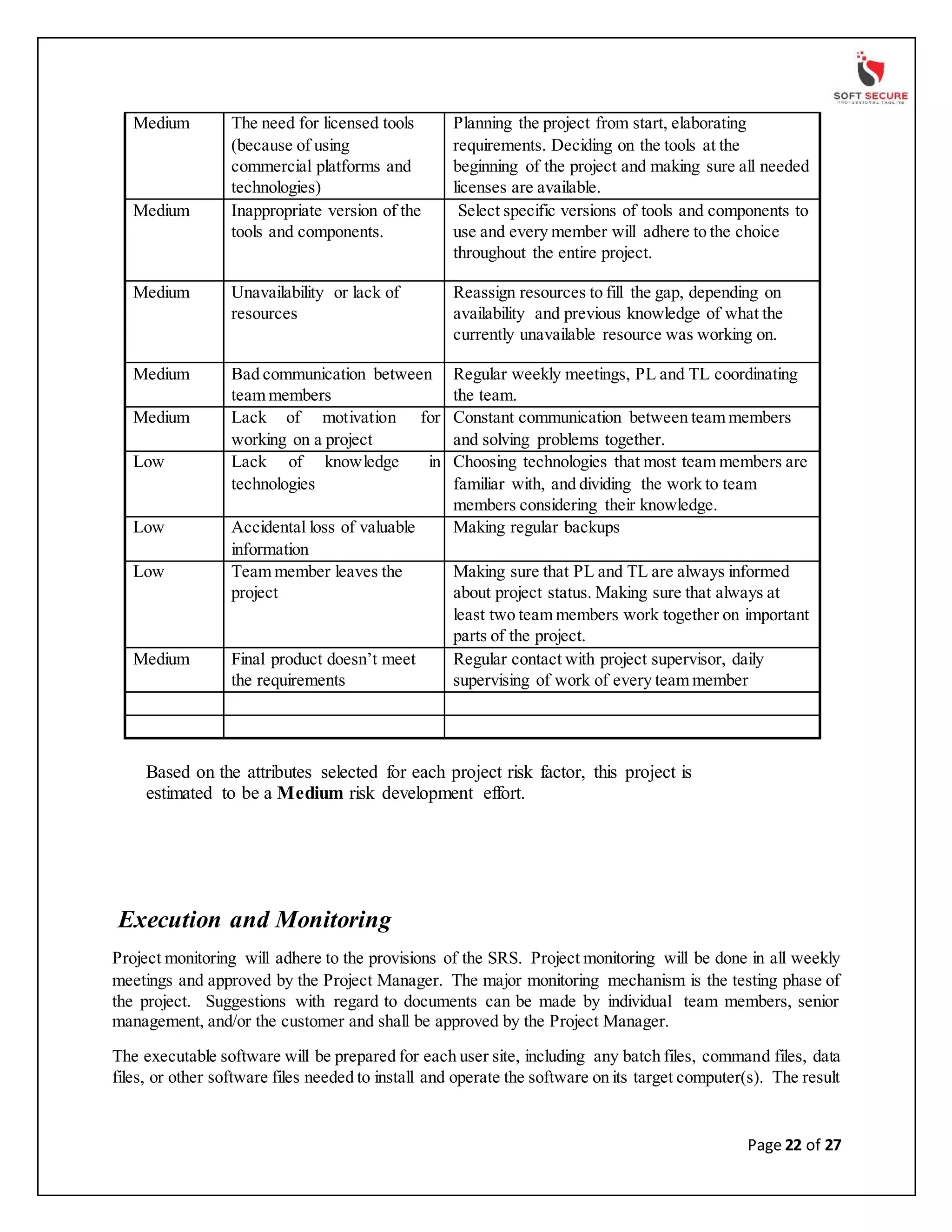

Discusses project scheduling and resource management plans to ensure timely delivery of the application.

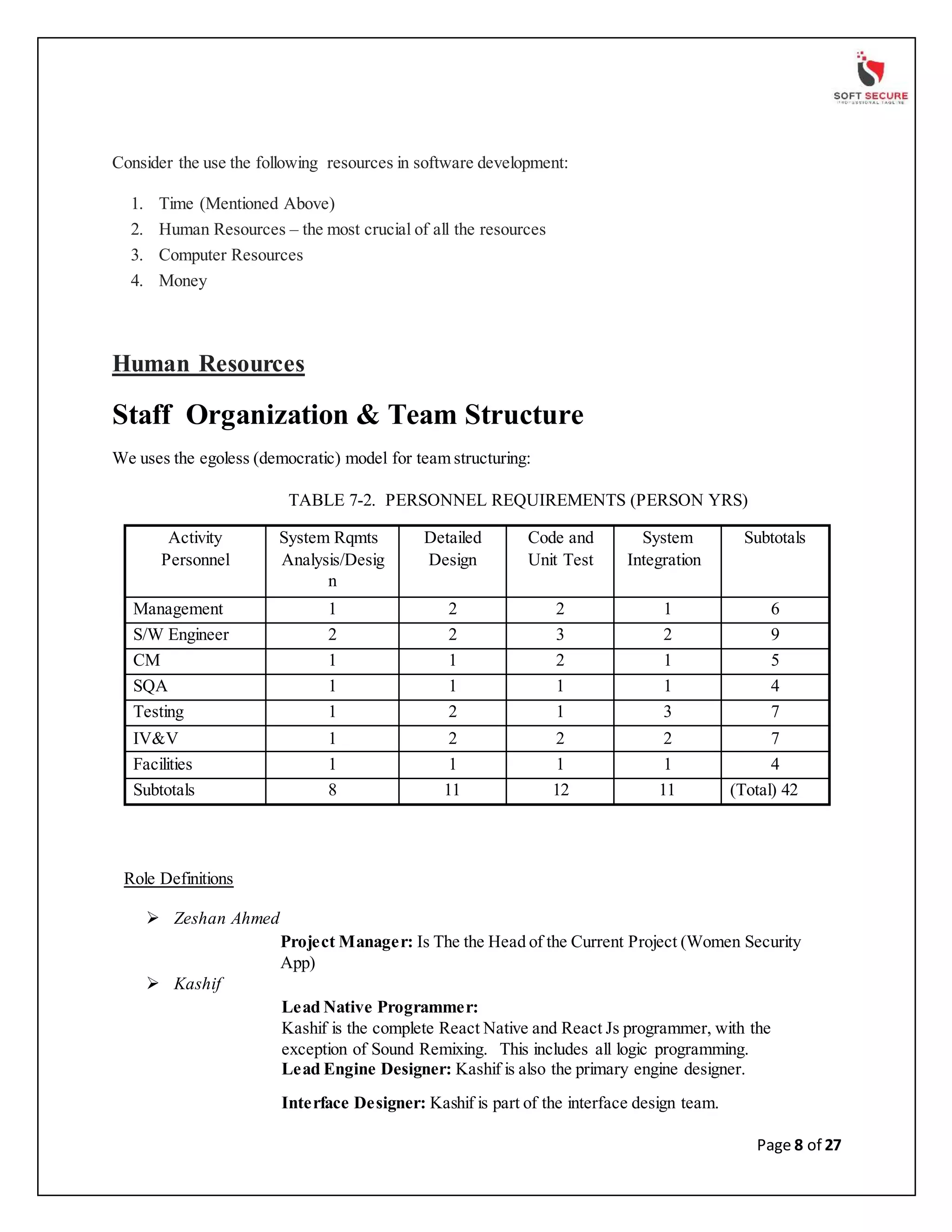

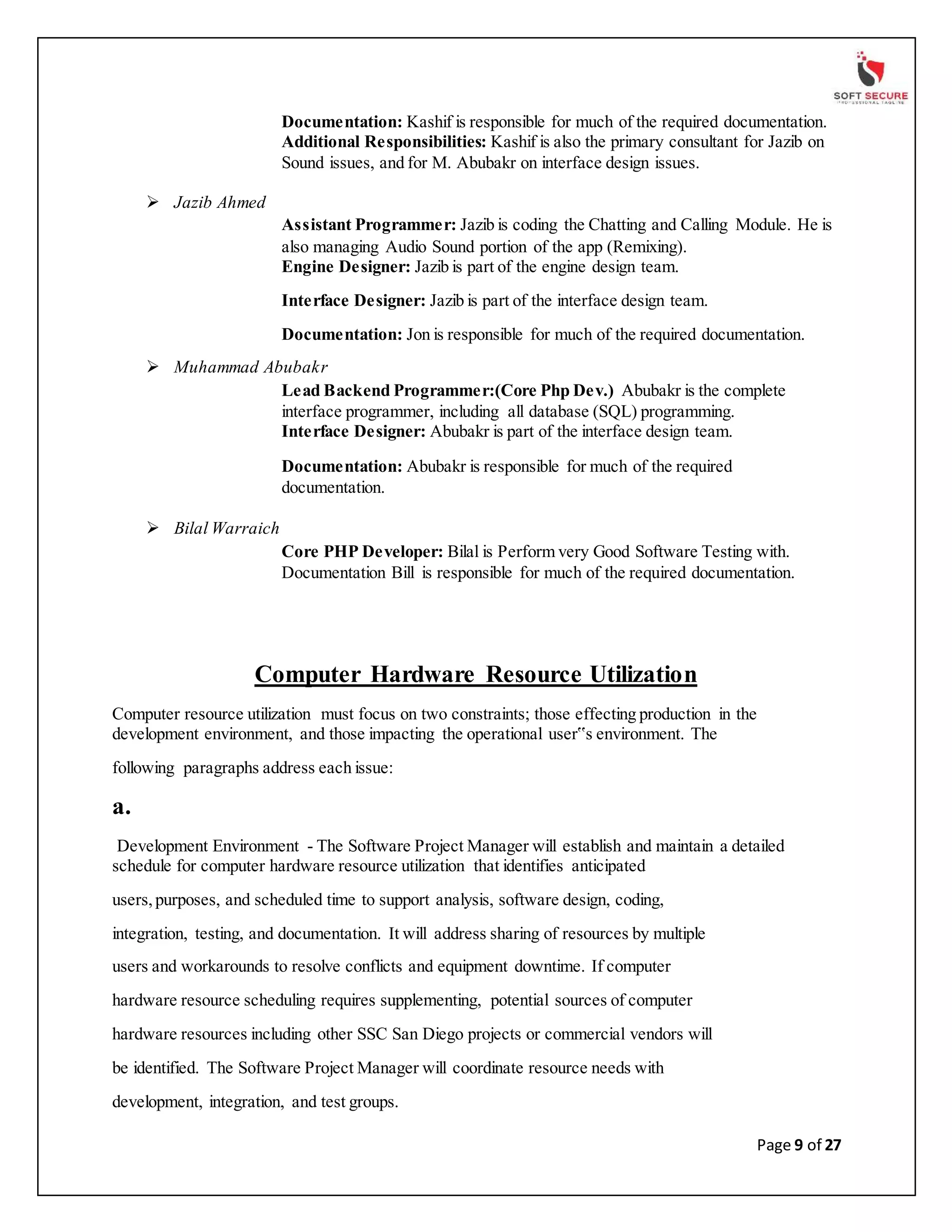

Describes team structure and roles of key personnel involved in the development of the Women Security Application.

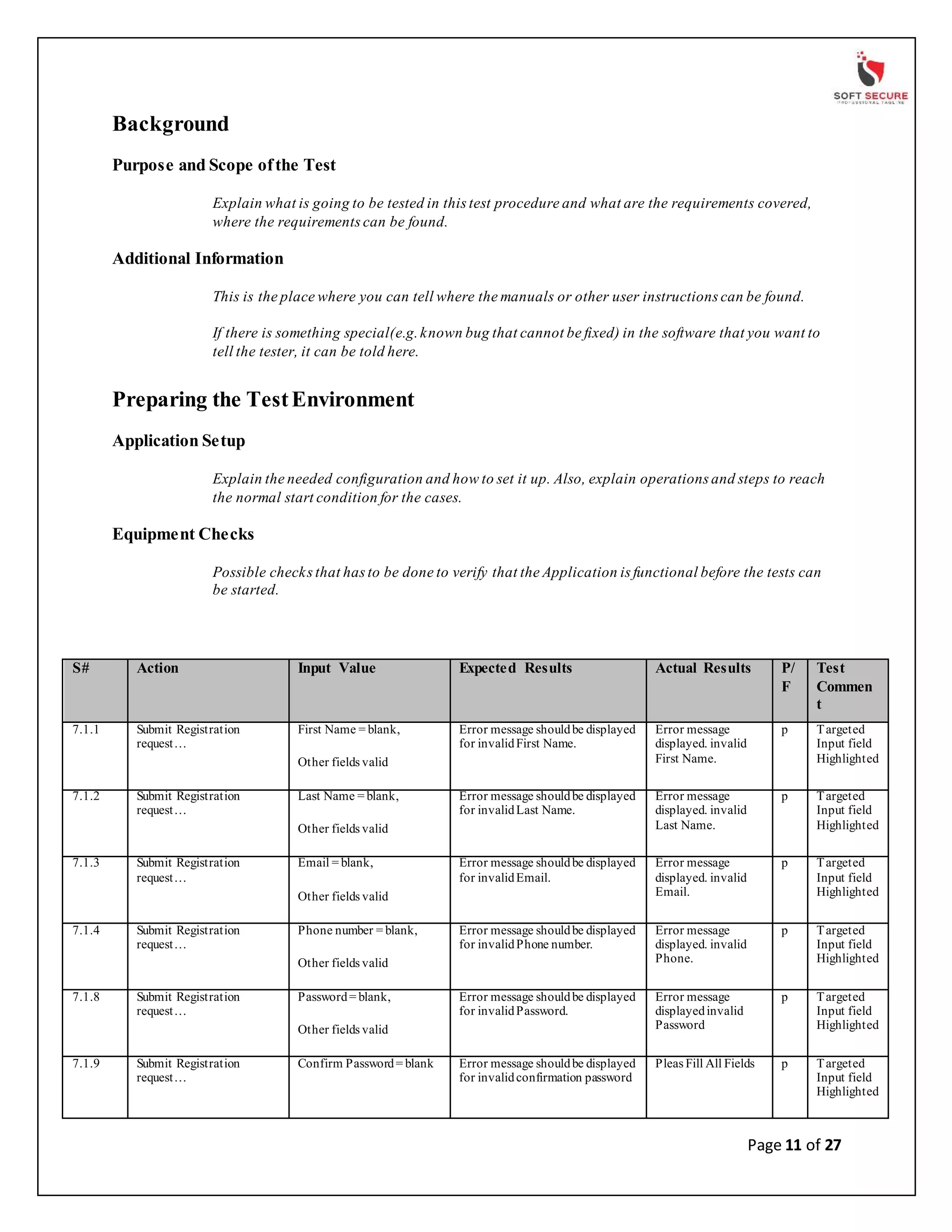

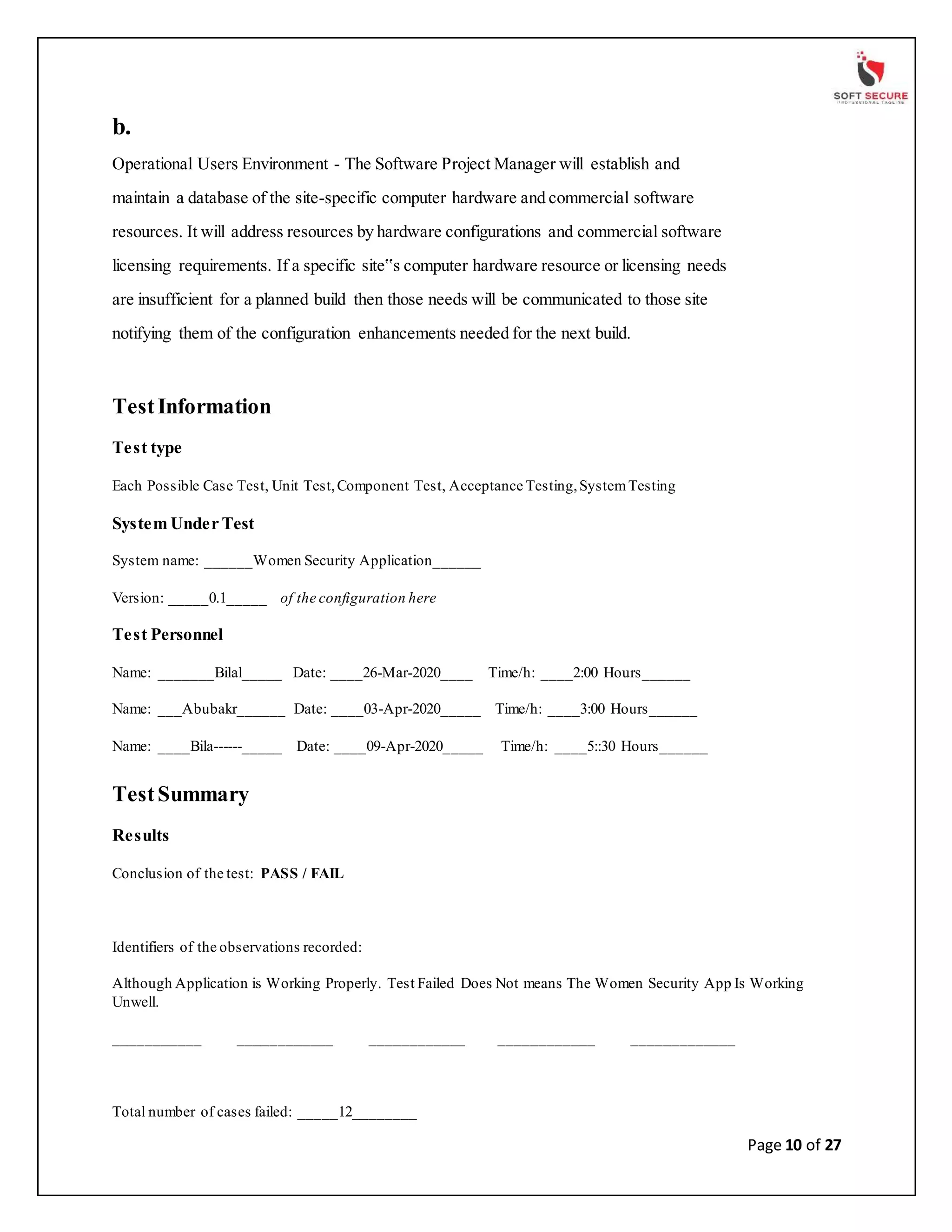

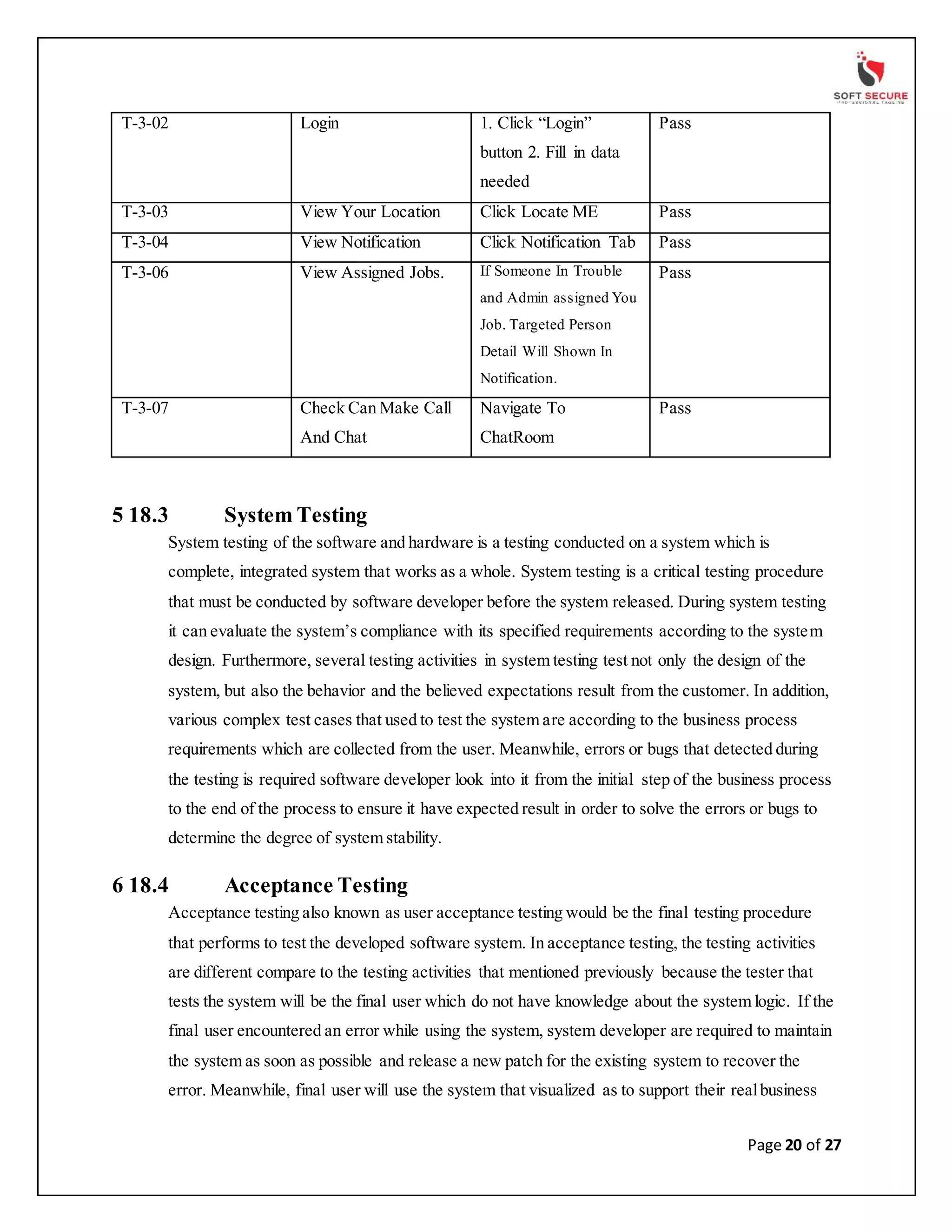

Details testing methodology, including the purpose and environment setup for validating the Women Security Application.

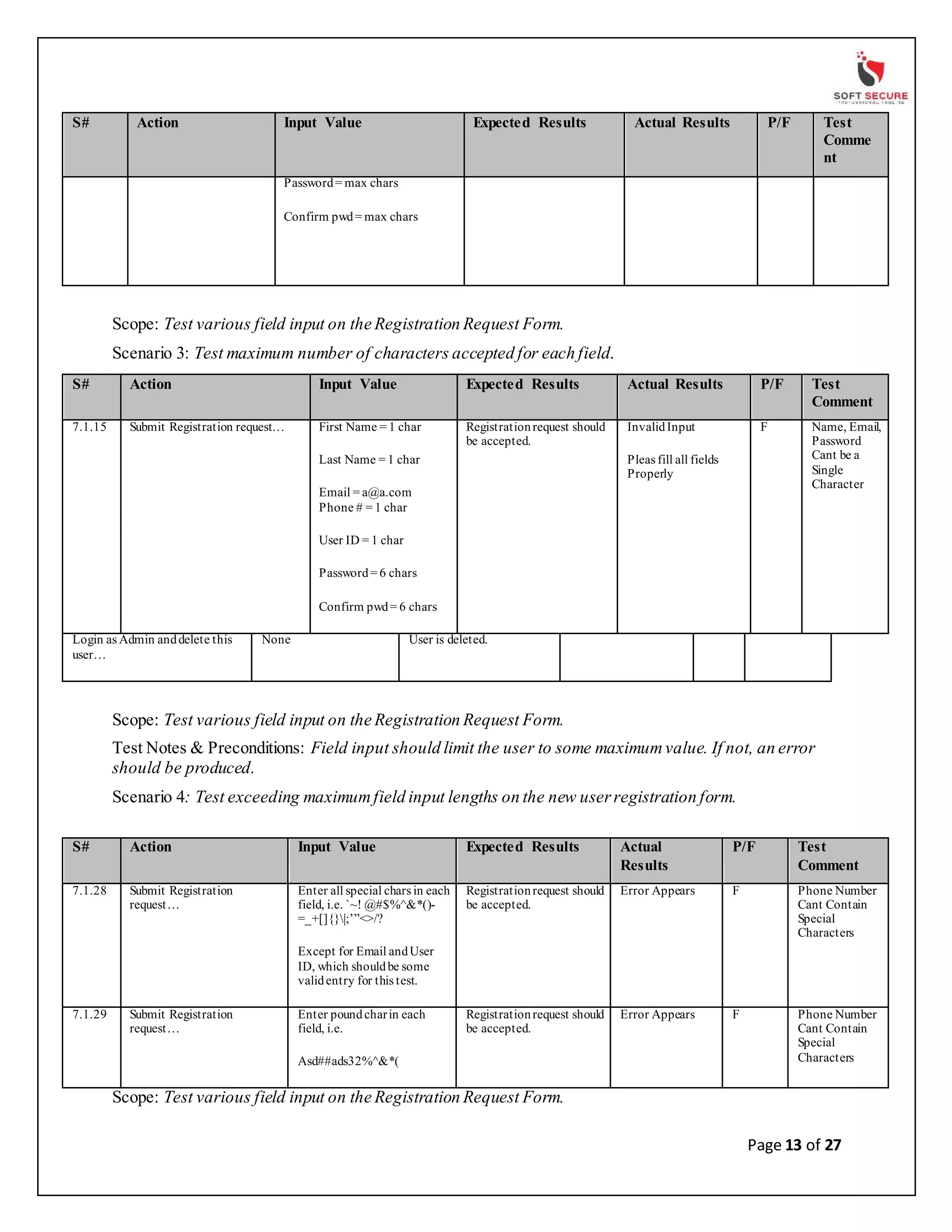

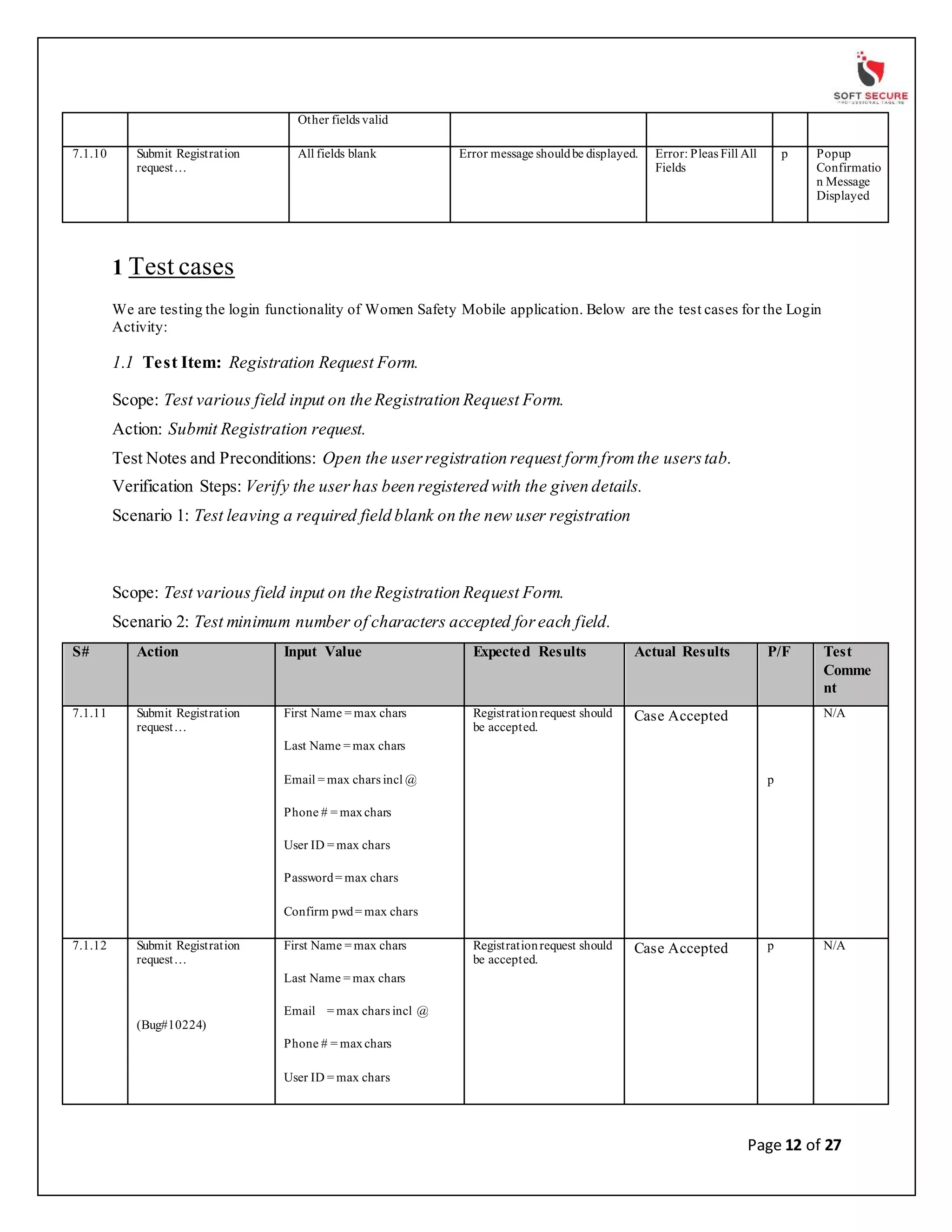

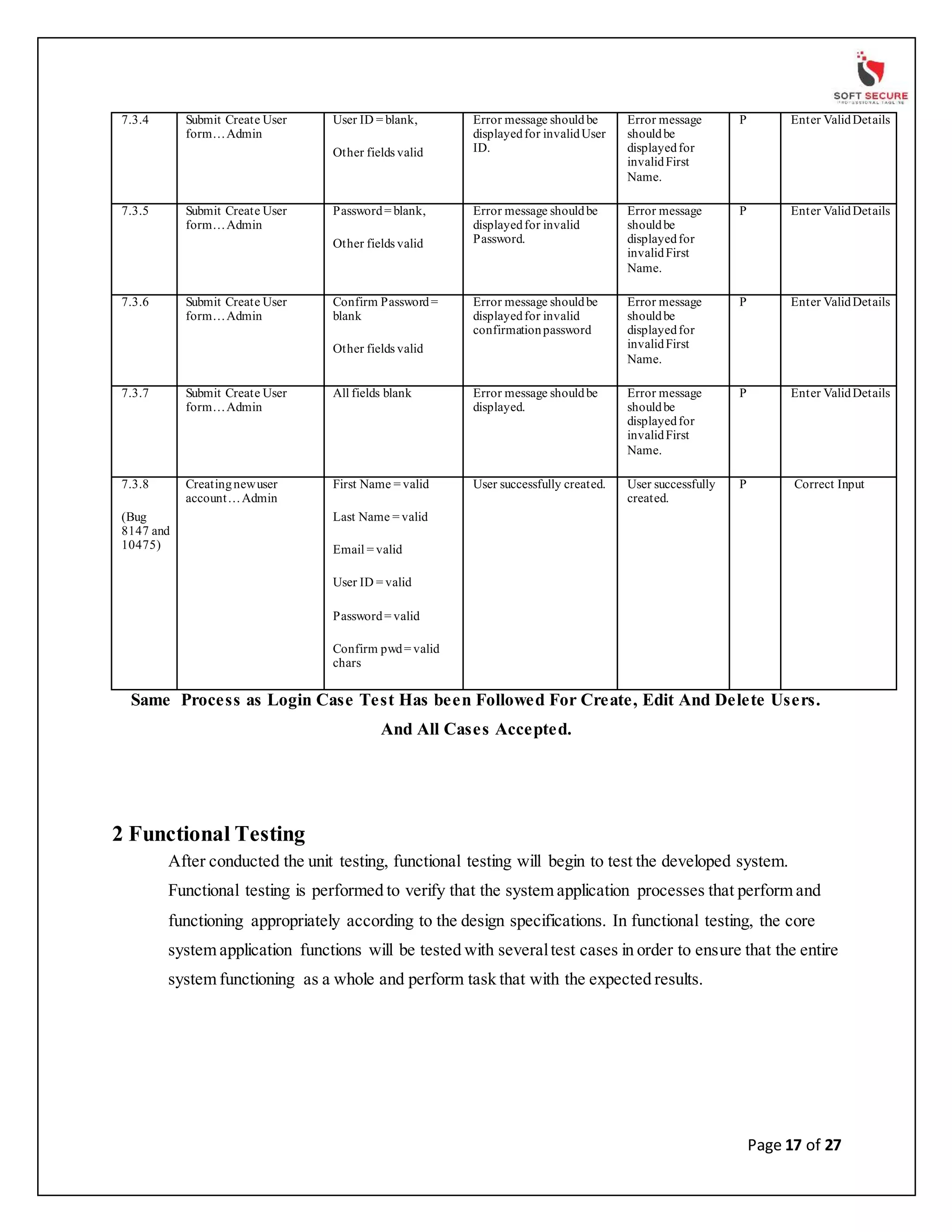

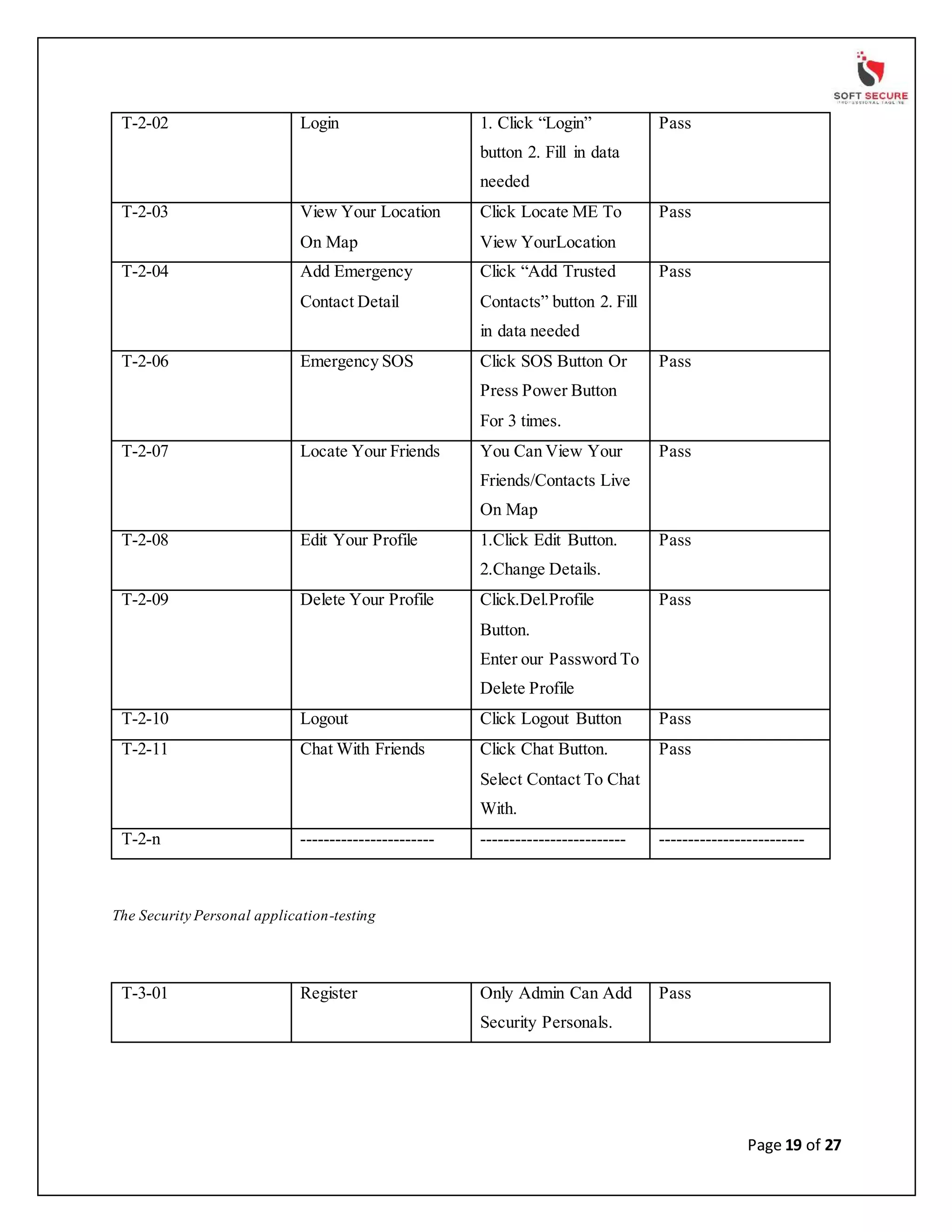

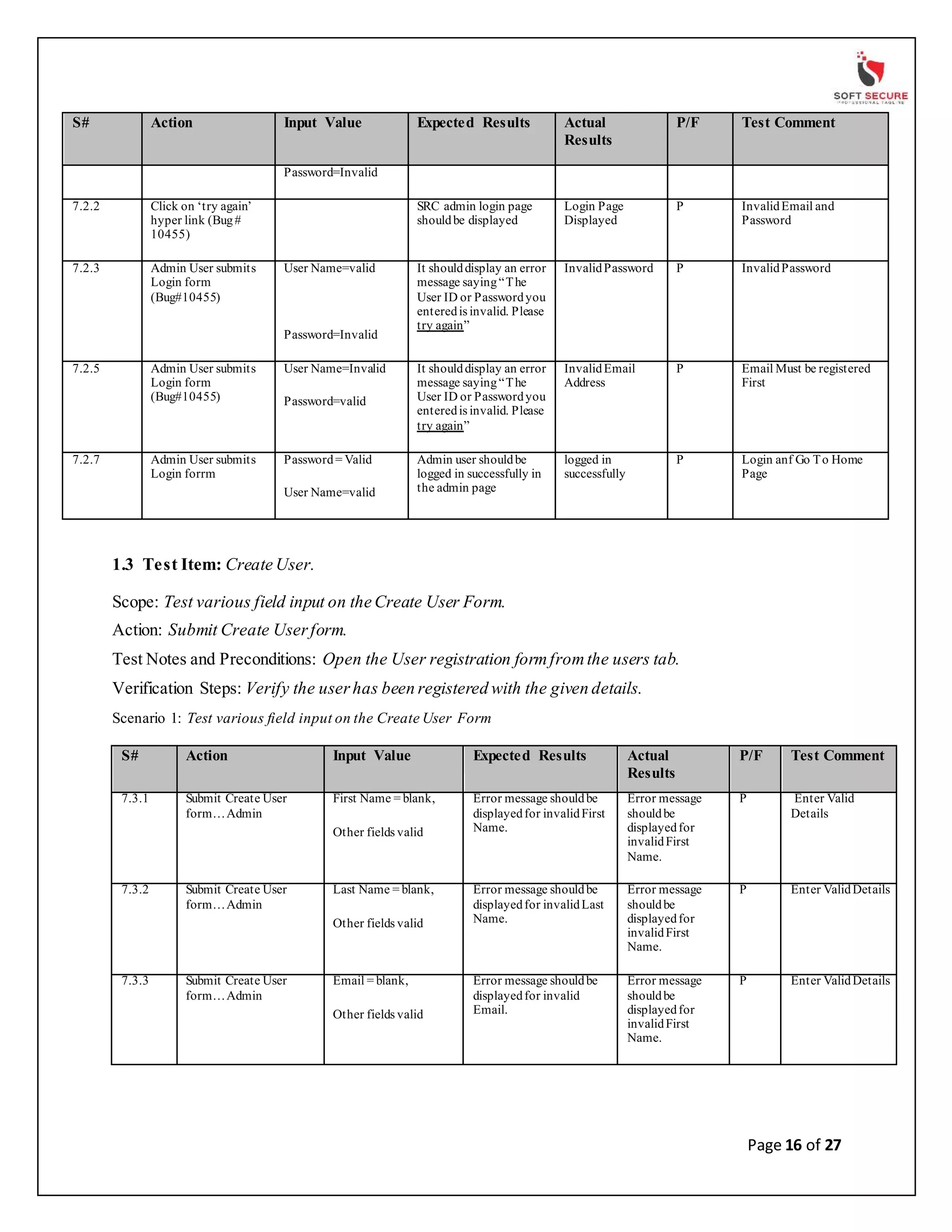

Outlines specific test cases for the user registration process, including handling empty and invalid field submissions.

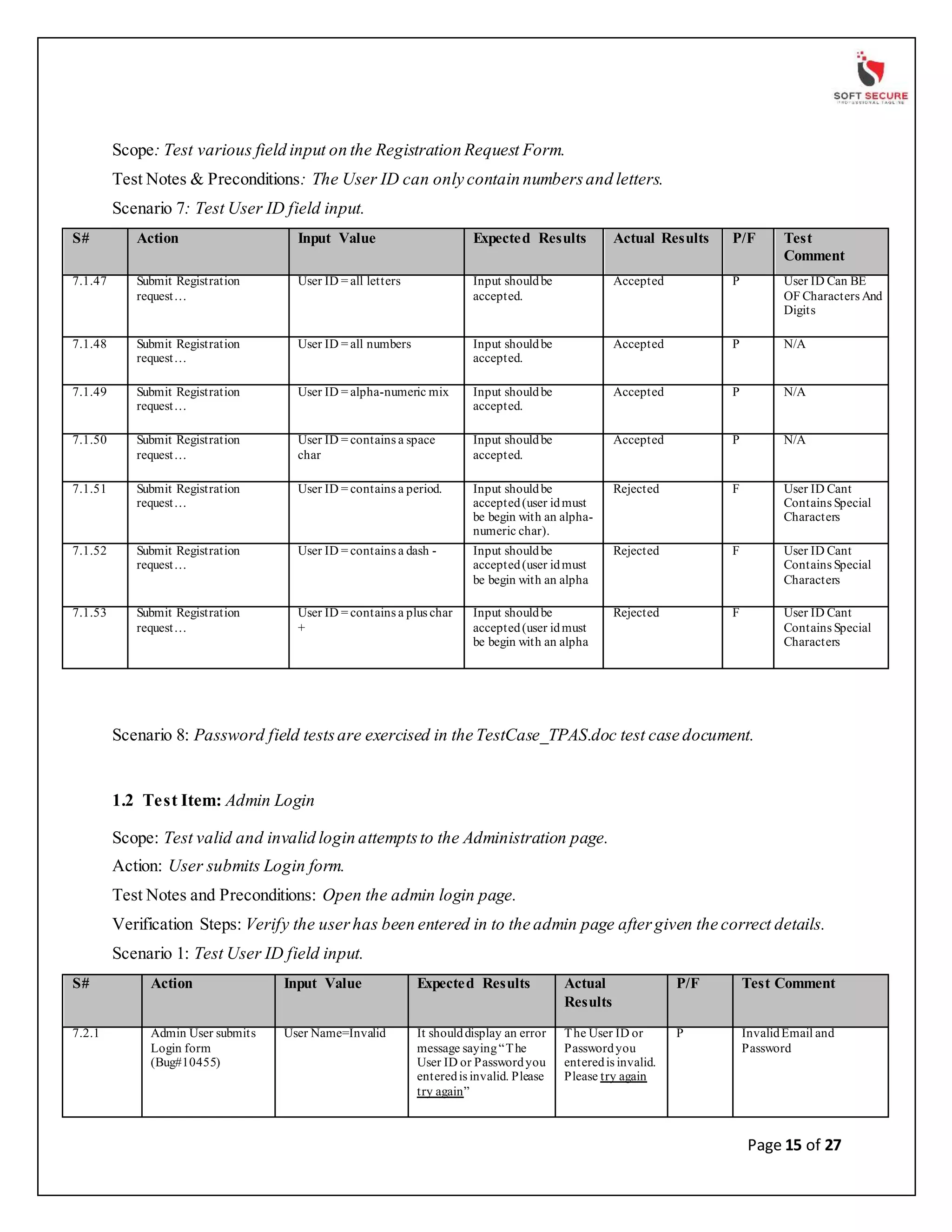

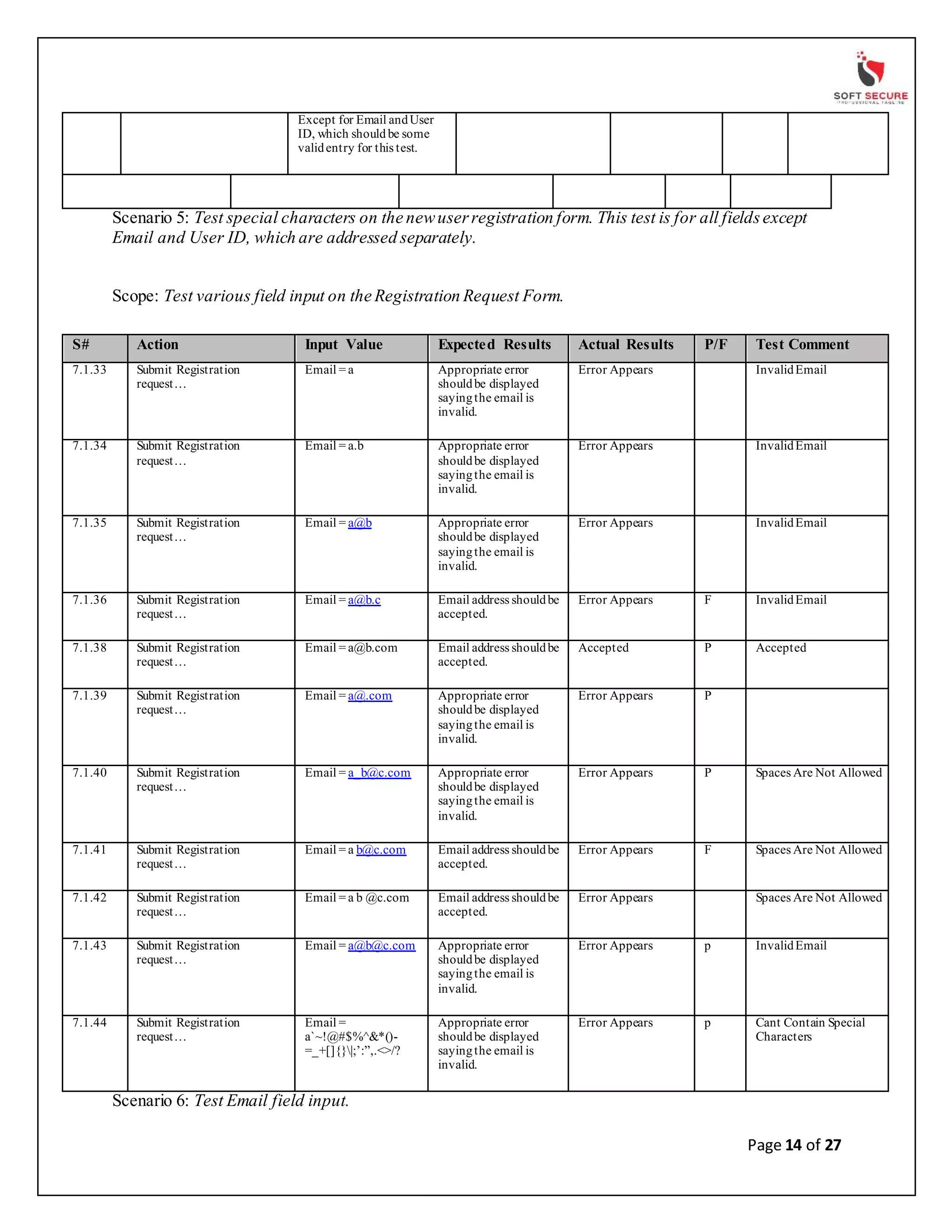

Expounds on scenarios testing password and user ID input fields during registration and their validation.
Describes the process of functional testing used to ensure the application meets its requirements after development.
Gives insights on acceptance testing, which is crucial for confirming that the final product meets user satisfaction.
Emphasizes the importance of communication in project management and details the communication approach taken.

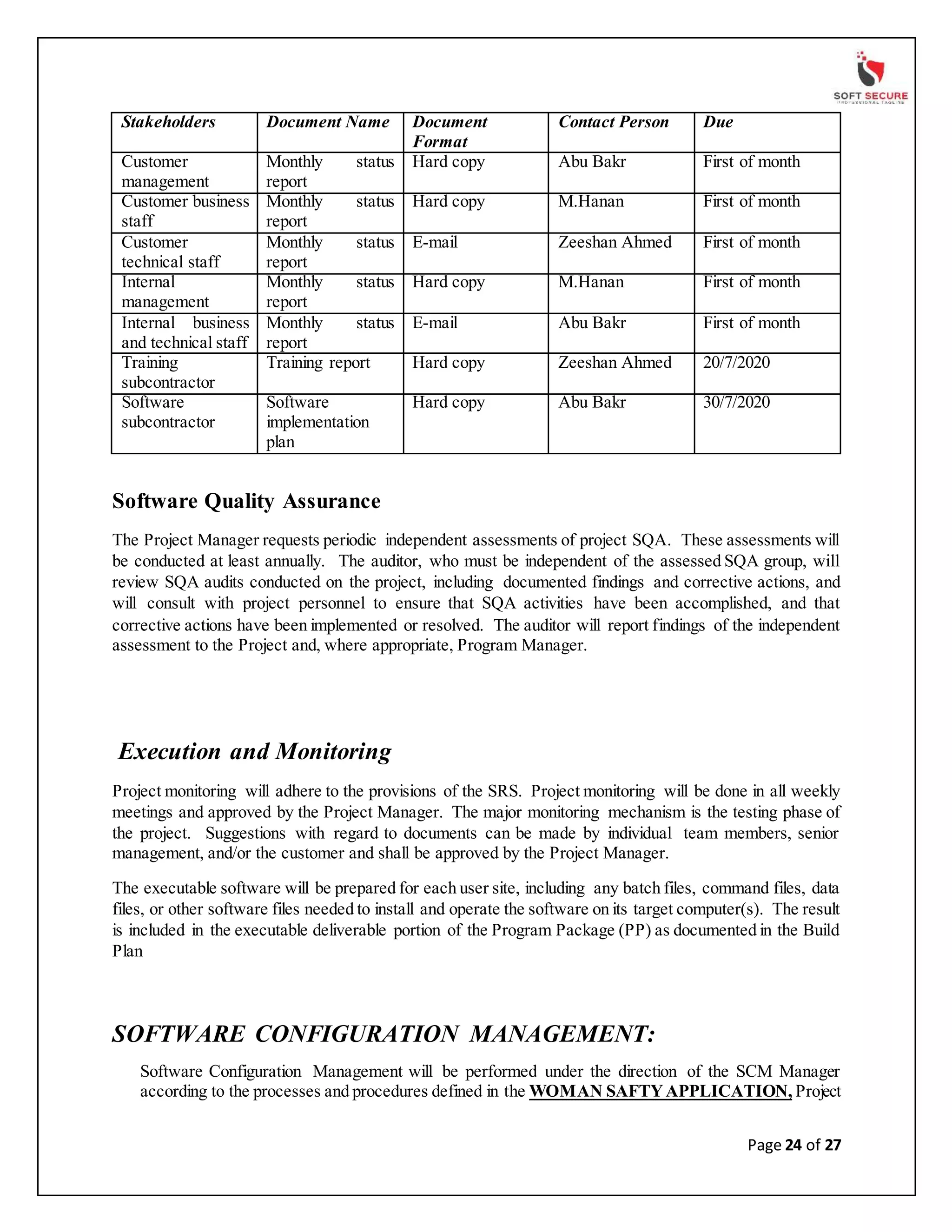

Lists key stakeholder roles and their responsibilities in receiving project status updates and documentation.

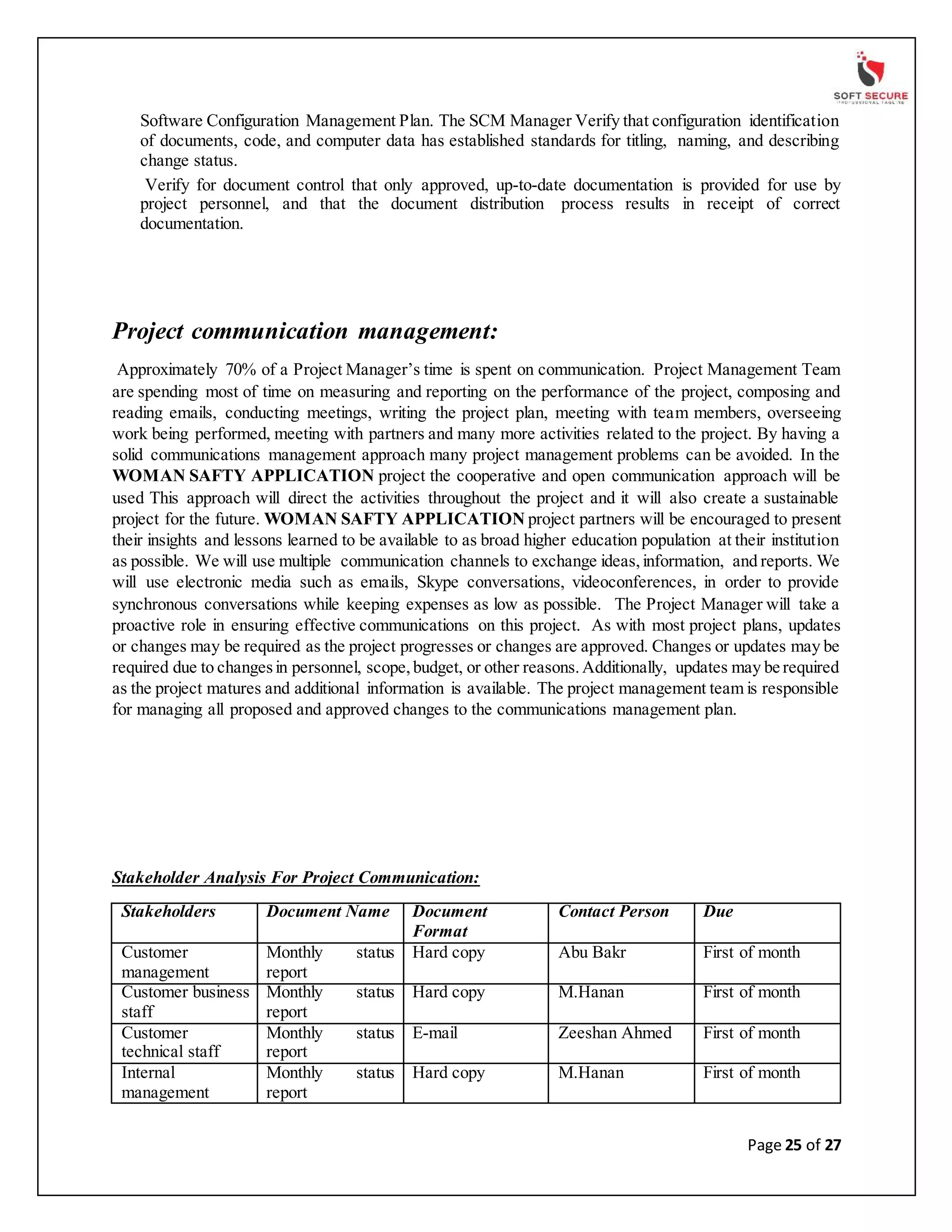

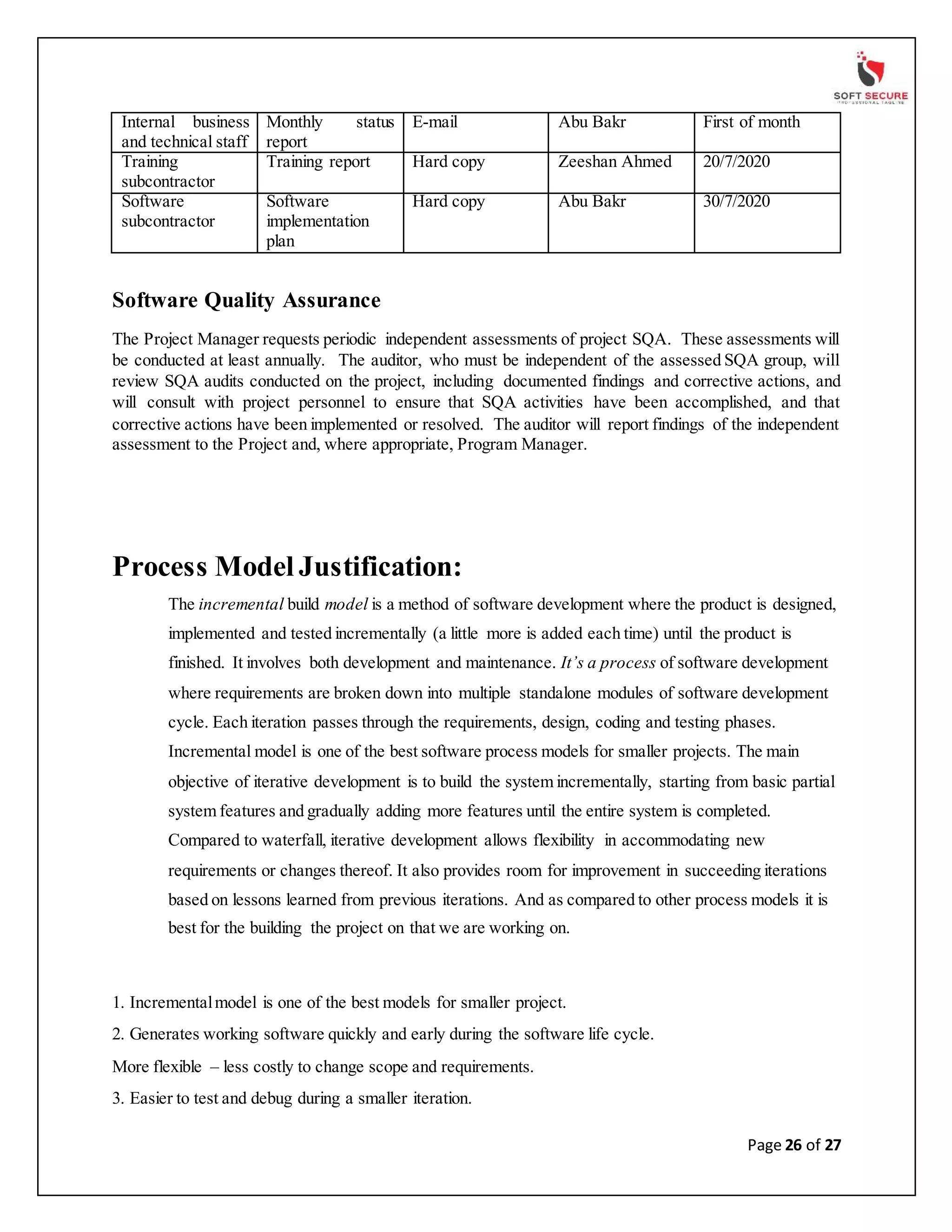

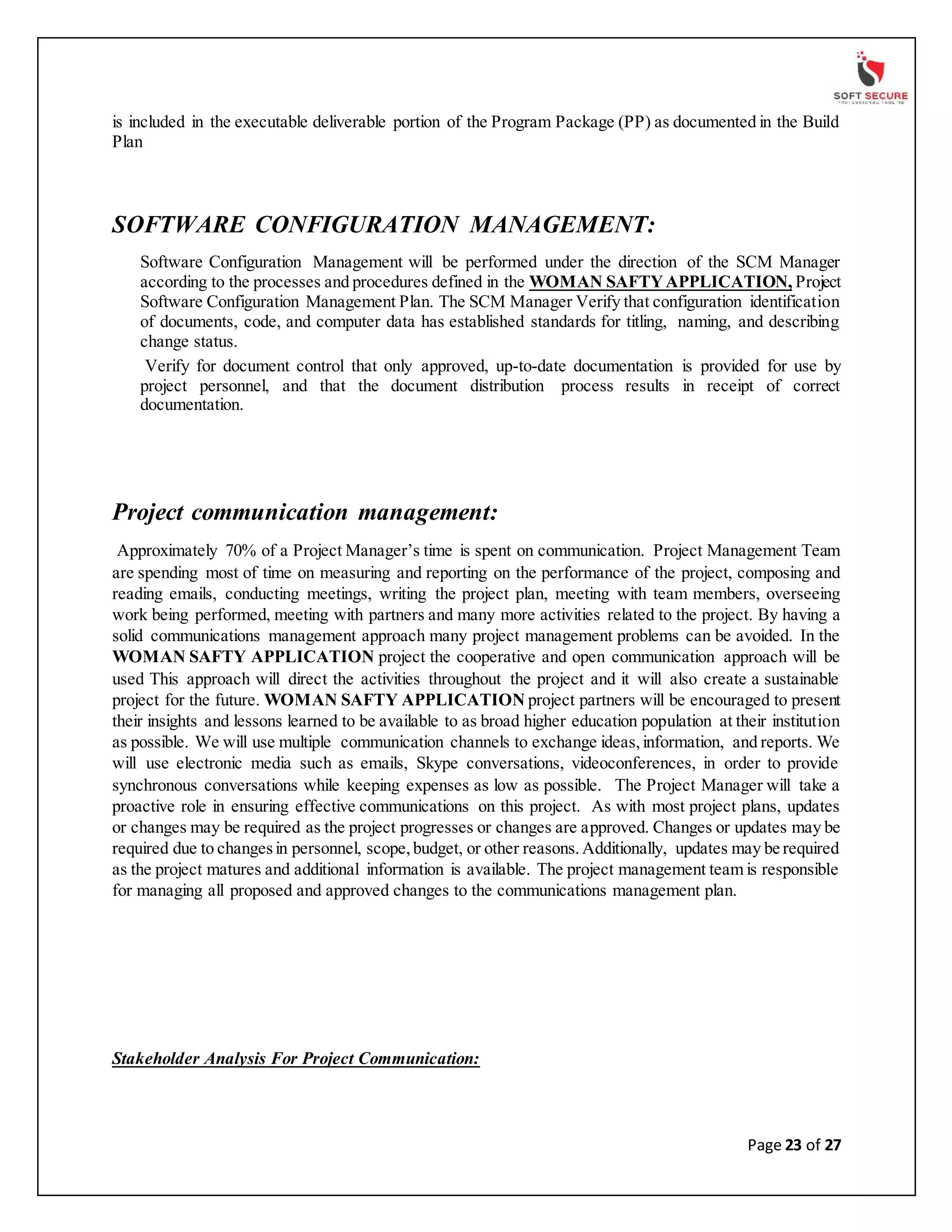

Discusses configuration management processes to ensure documentation and software version control throughout the project.

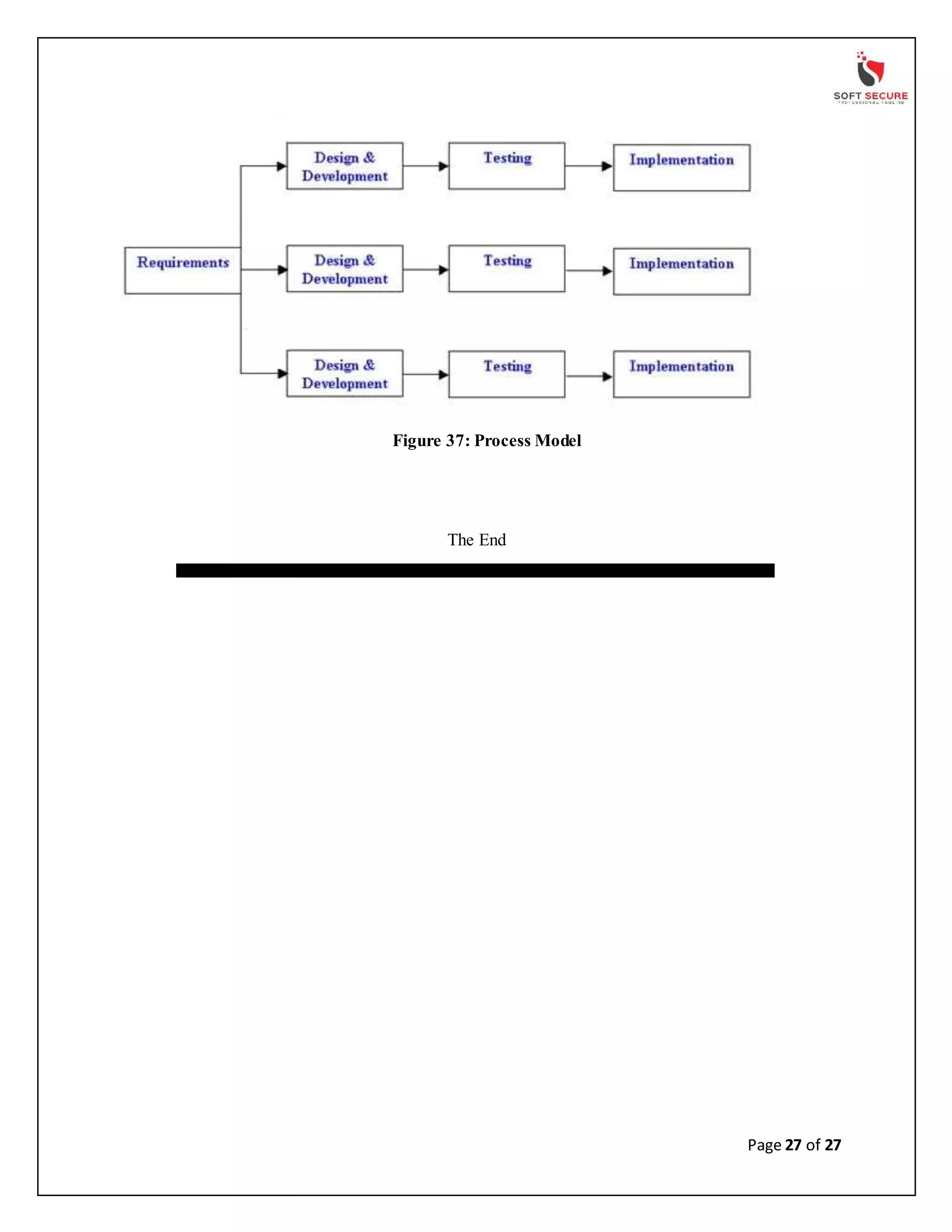

Explains the incremental build model chosen for development, emphasizing flexibility and iterative improvement.
Wraps up the presentation by summarizing the incremental development process and overall project goals.
