SAP FICO INTERVIEW QUESTIONS
             & ANSWERS

   How to Clear Each and Every Interview You
         Give- 100 % Success Assured.


      Published by a Team of SAP Consultants at
                     SAPTOPJOBS


           Visit us at www.sap-topjobs.com

                    Copyright 2005@SAPTOPJOBS



All rights reserved. No part of this publication may be reproduced, stored
in a retrieval system, or transmitted in any form, or by any means
electronic or mechanical including photocopying, recording or any
information storage and retrieval system without permission in writing
from SAPTOPJOBS.

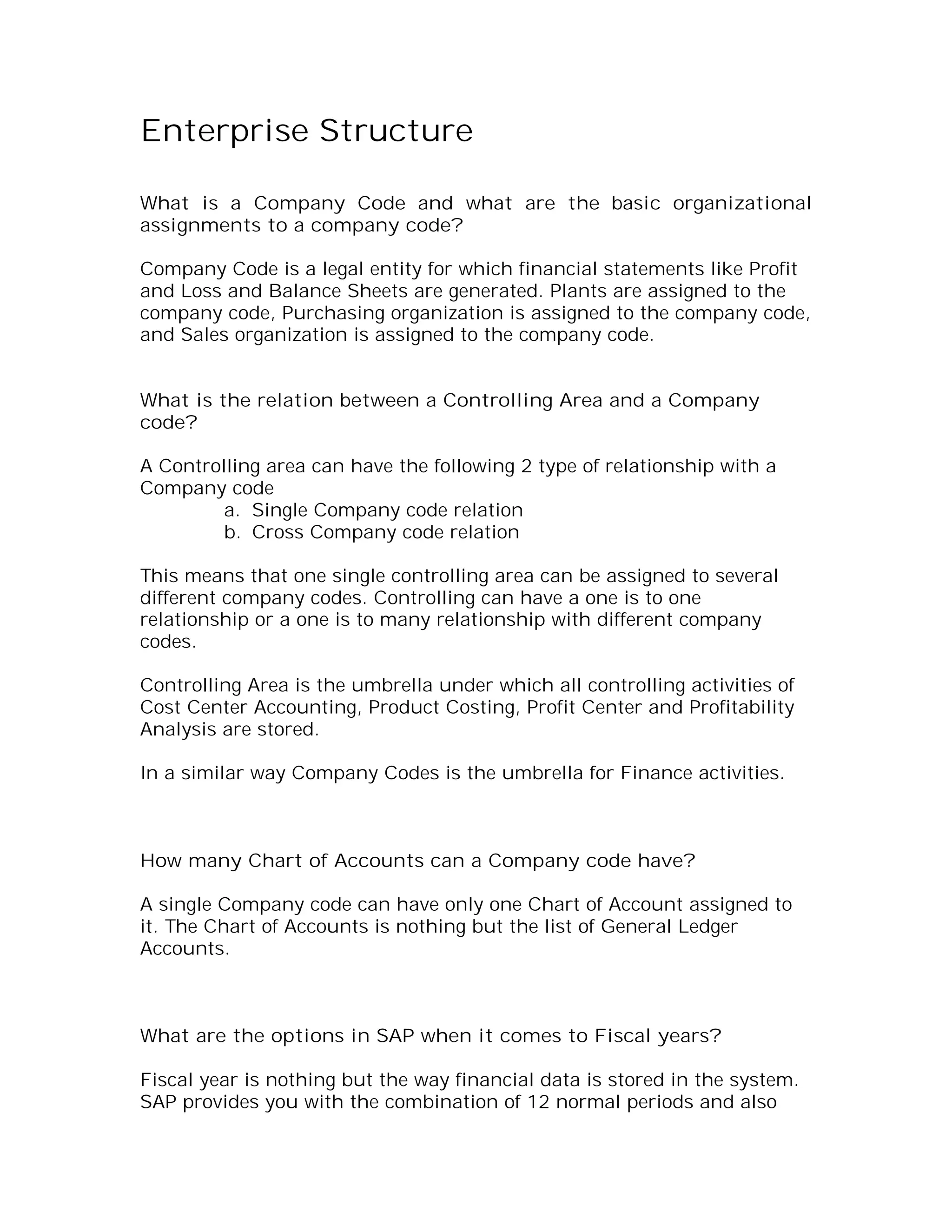

Enterprise Structure

What is a Company Code and what are the basic organizational
assignments to a company code?

Company Code is a legal entity for which financial statements like Profit
and Loss and Balance Sheets are generated. Plants are assigned to the
company code, Purchasing organization is assigned to the company code,
and Sales organization is assigned to the company code.


What is the relation between a Controlling Area and a Company
code?

A Controlling area can have the following 2 type of relationship with a
Company code
         a. Single Company code relation
         b. Cross Company code relation

This means that one single controlling area can be assigned to several
different company codes. Controlling can have a one is to one
relationship or a one is to many relationship with different company
codes.

Controlling Area is the umbrella under which all controlling activities of
Cost Center Accounting, Product Costing, Profit Center and Profitability
Analysis are stored.

In a similar way Company Codes is the umbrella for Finance activities.



How many Chart of Accounts can a Company code have?

A single Company code can have only one Chart of Account assigned to
it. The Chart of Accounts is nothing but the list of General Ledger
Accounts.



What are the options in SAP when it comes to Fiscal years?

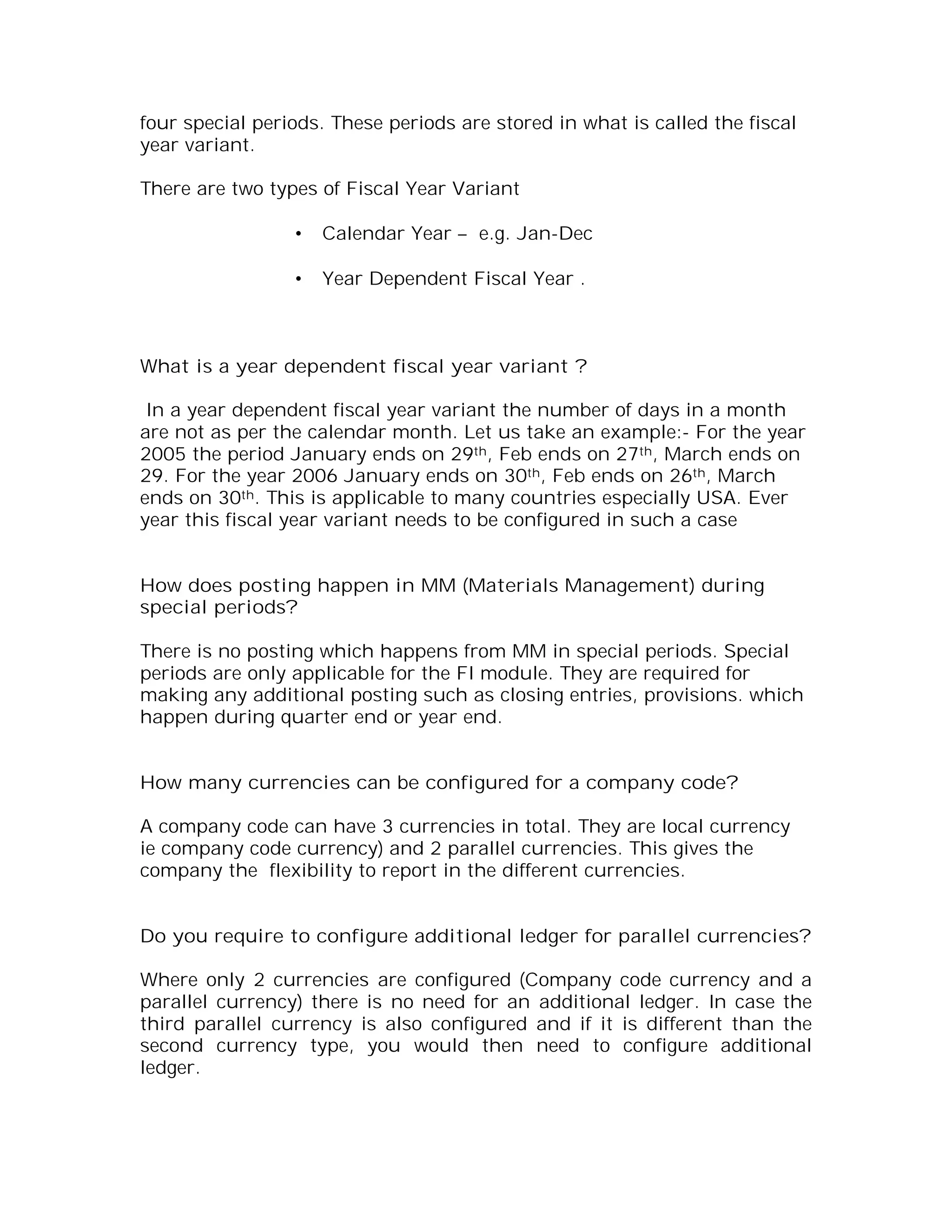

Fiscal year is nothing but the way financial data is stored in the system.
SAP provides you with the combination of 12 normal periods and also
four special periods. These periods are stored in what is called the fiscal
year variant.

There are two types of Fiscal Year Variant

                 •   Calendar Year – e.g. Jan-Dec

                 •   Year Dependent Fiscal Year .



What is a year dependent fiscal year variant ?

 In a year dependent fiscal year variant the number of days in a month
are not as per the calendar month. Let us take an example:- For the year
2005 the period January ends on 29th, Feb ends on 27th, March ends on
29. For the year 2006 January ends on 30th, Feb ends on 26th, March
ends on 30th. This is applicable to many countries especially USA. Ever
year this fiscal year variant needs to be configured in such a case


How does posting happen in MM (Materials Management) during
special periods?

There is no posting which happens from MM in special periods. Special
periods are only applicable for the FI module. They are required for
making any additional posting such as closing entries, provisions. which
happen during quarter end or year end.


How many currencies can be configured for a company code?

A company code can have 3 currencies in total. They are local currency
ie company code currency) and 2 parallel currencies. This gives the
company the flexibility to report in the different currencies.


Do you require to configure additional ledger for parallel currencies?

Where only 2 currencies are configured (Company code currency and a
parallel currency) there is no need for an additional ledger. In case the
third parallel currency is also configured and if it is different than the
second currency type, you would then need to configure additional
ledger.
If there are two company codes with different chart of accounts how
can you consolidate their activities?

In this case you either need to write an ABAP program or you need to
implement the Special Consolidation Module of SAP. If both the company
codes use the same chart of accounts then standard SAP reports give
you the consolidated figure.

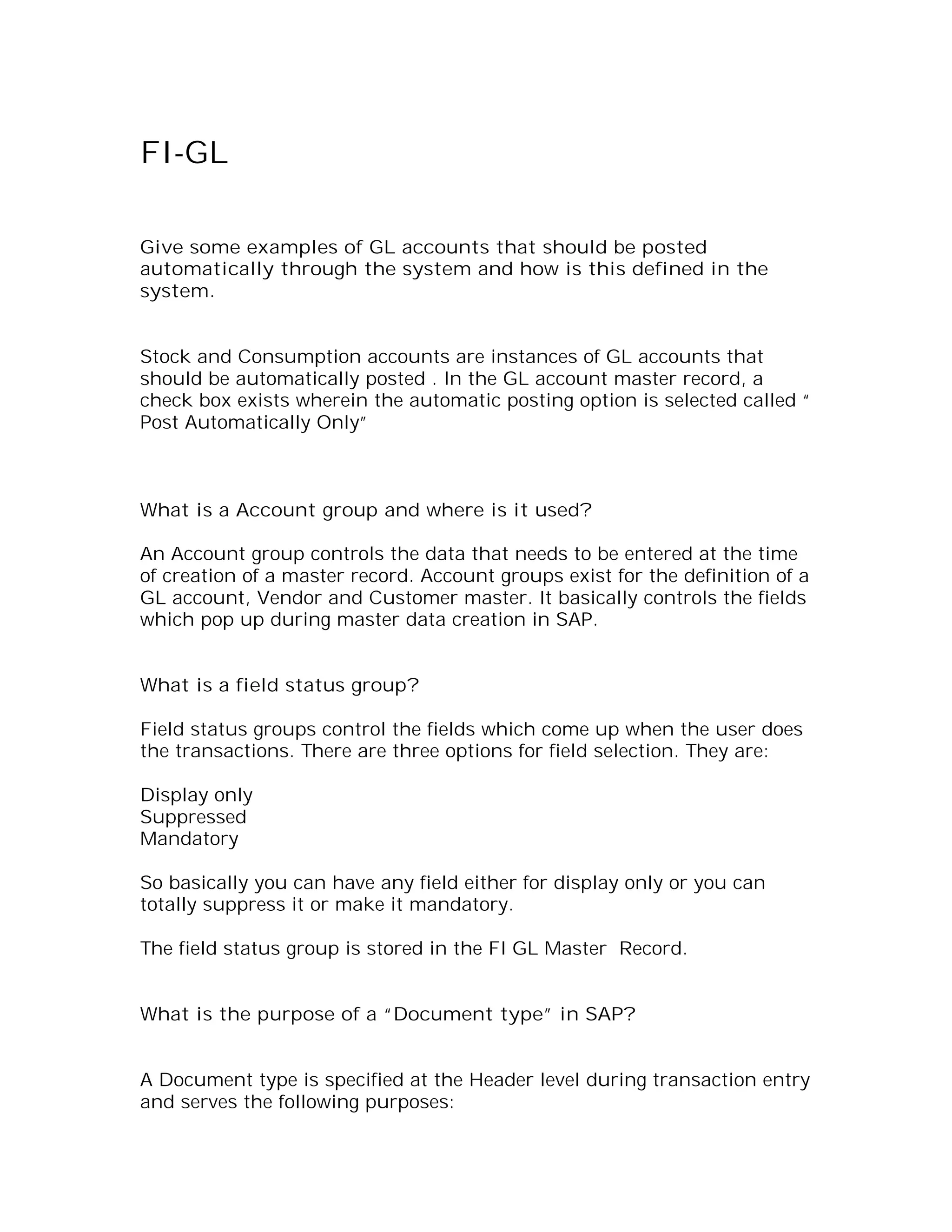

FI-GL

Give some examples of GL accounts that should be posted
automatically through the system and how is this defined in the
system.


Stock and Consumption accounts are instances of GL accounts that
should be automatically posted . In the GL account master record, a
check box exists wherein the automatic posting option is selected called “
Post Automatically Only”



What is a Account group and where is it used?

An Account group controls the data that needs to be entered at the time
of creation of a master record. Account groups exist for the definition of a
GL account, Vendor and Customer master. It basically controls the fields
which pop up during master data creation in SAP.


What is a field status group?

Field status groups control the fields which come up when the user does
the transactions. There are three options for field selection. They are:

Display only
Suppressed
Mandatory

So basically you can have any field either for display only or you can
totally suppress it or make it mandatory.

The field status group is stored in the FI GL Master Record.

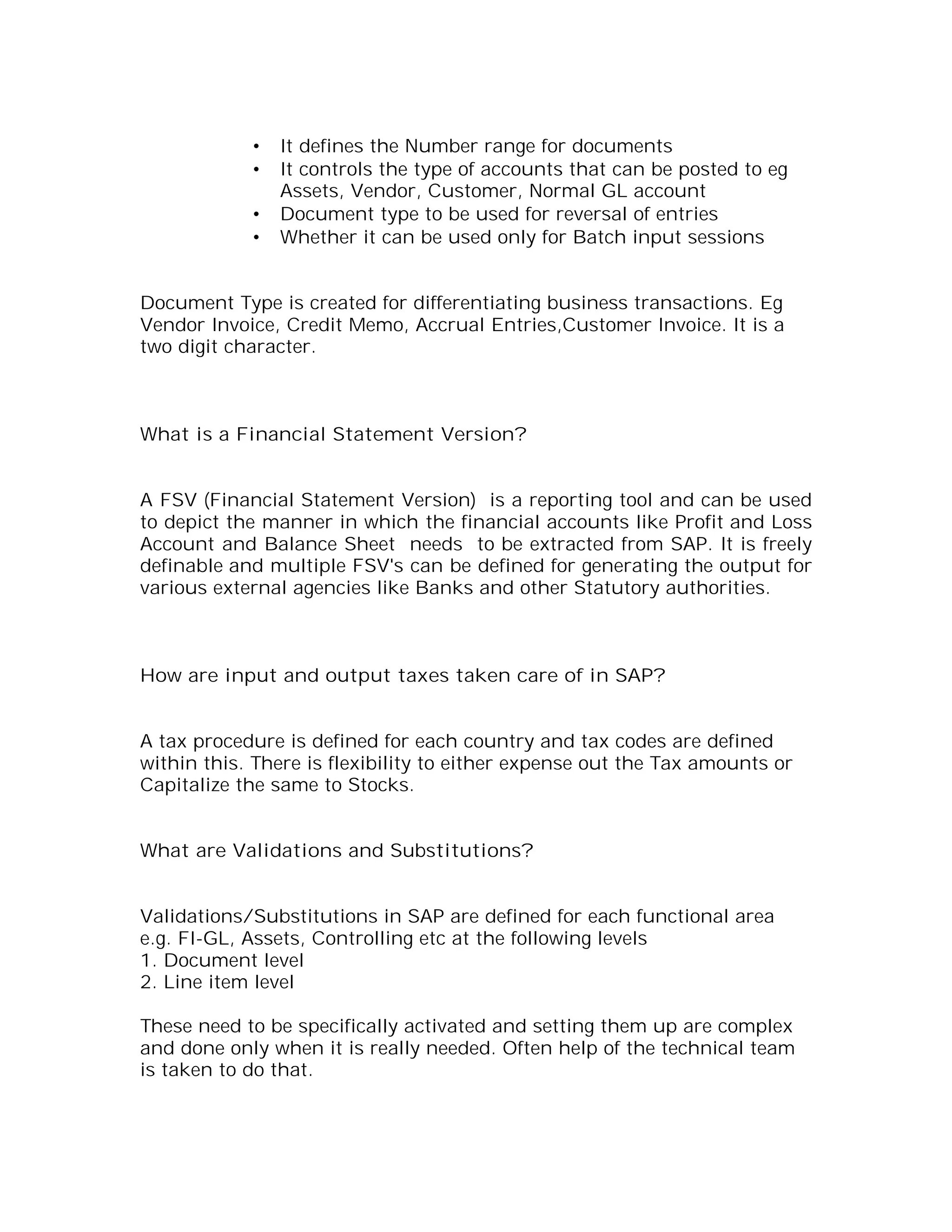

What is the purpose of a “Document type” in SAP?


A Document type is specified at the Header level during transaction entry
and serves the following purposes:
•   It defines the Number range for documents
            •   It controls the type of accounts that can be posted to eg
                Assets, Vendor, Customer, Normal GL account
            •   Document type to be used for reversal of entries
            •   Whether it can be used only for Batch input sessions


Document Type is created for differentiating business transactions. Eg
Vendor Invoice, Credit Memo, Accrual Entries,Customer Invoice. It is a
two digit character.



What is a Financial Statement Version?


A FSV (Financial Statement Version) is a reporting tool and can be used
to depict the manner in which the financial accounts like Profit and Loss
Account and Balance Sheet needs to be extracted from SAP. It is freely
definable and multiple FSV's can be defined for generating the output for
various external agencies like Banks and other Statutory authorities.



How are input and output taxes taken care of in SAP?


A tax procedure is defined for each country and tax codes are defined
within this. There is flexibility to either expense out the Tax amounts or
Capitalize the same to Stocks.


What are Validations and Substitutions?


Validations/Substitutions in SAP are defined for each functional area
e.g. FI-GL, Assets, Controlling etc at the following levels
1. Document level
2. Line item level

These need to be specifically activated and setting them up are complex
and done only when it is really needed. Often help of the technical team
is taken to do that.

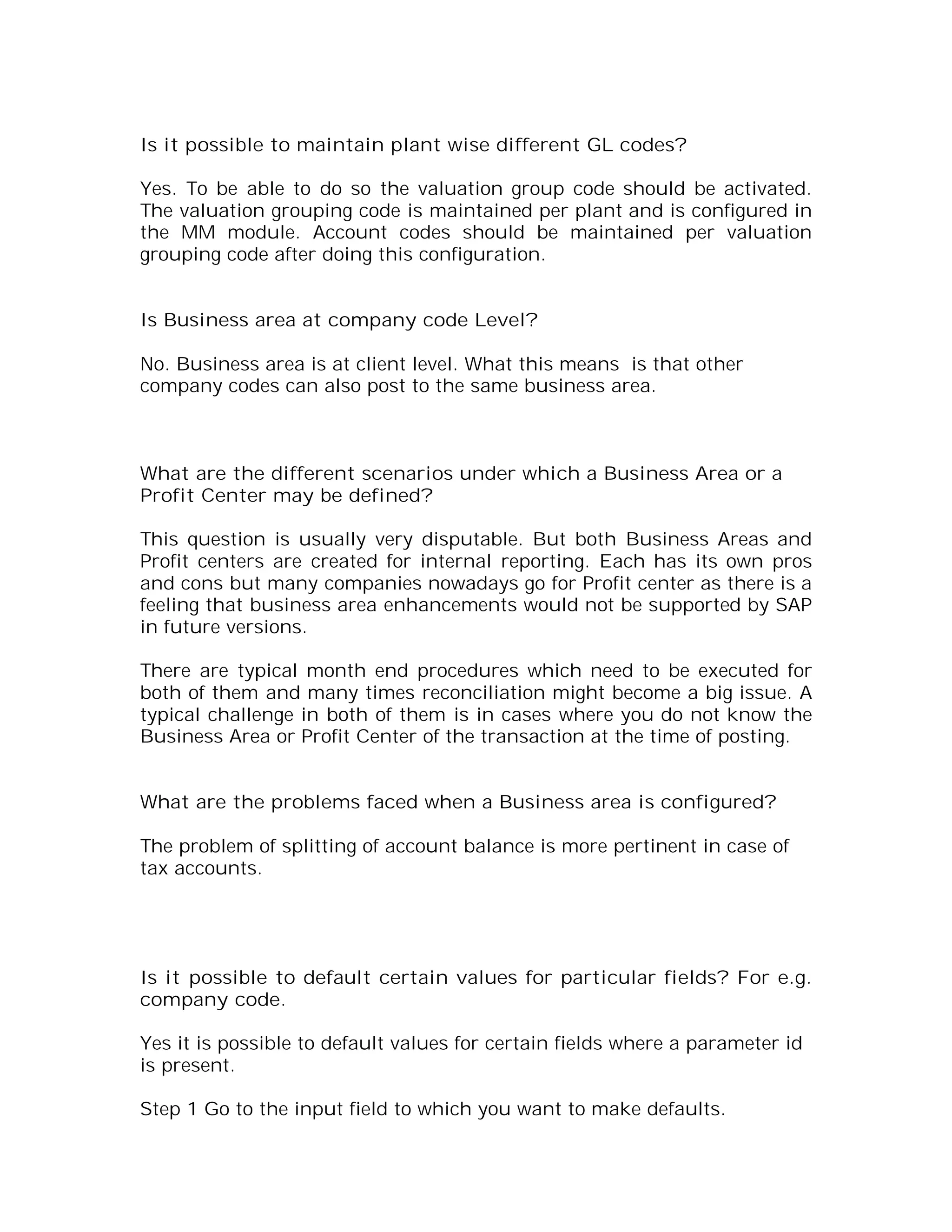

Is it possible to maintain plant wise different GL codes?

Yes. To be able to do so the valuation group code should be activated.
The valuation grouping code is maintained per plant and is configured in
the MM module. Account codes should be maintained per valuation
grouping code after doing this configuration.


Is Business area at company code Level?

No. Business area is at client level. What this means is that other
company codes can also post to the same business area.



What are the different scenarios under which a Business Area or a
Profit Center may be defined?

This question is usually very disputable. But both Business Areas and
Profit centers are created for internal reporting. Each has its own pros
and cons but many companies nowadays go for Profit center as there is a
feeling that business area enhancements would not be supported by SAP
in future versions.

There are typical month end procedures which need to be executed for
both of them and many times reconciliation might become a big issue. A
typical challenge in both of them is in cases where you do not know the
Business Area or Profit Center of the transaction at the time of posting.


What are the problems faced when a Business area is configured?

The problem of splitting of account balance is more pertinent in case of
tax accounts.




Is it possible to default certain values for particular fields? For e.g.
company code.

Yes it is possible to default values for certain fields where a parameter id
is present.

Step 1 Go to the input field to which you want to make defaults.

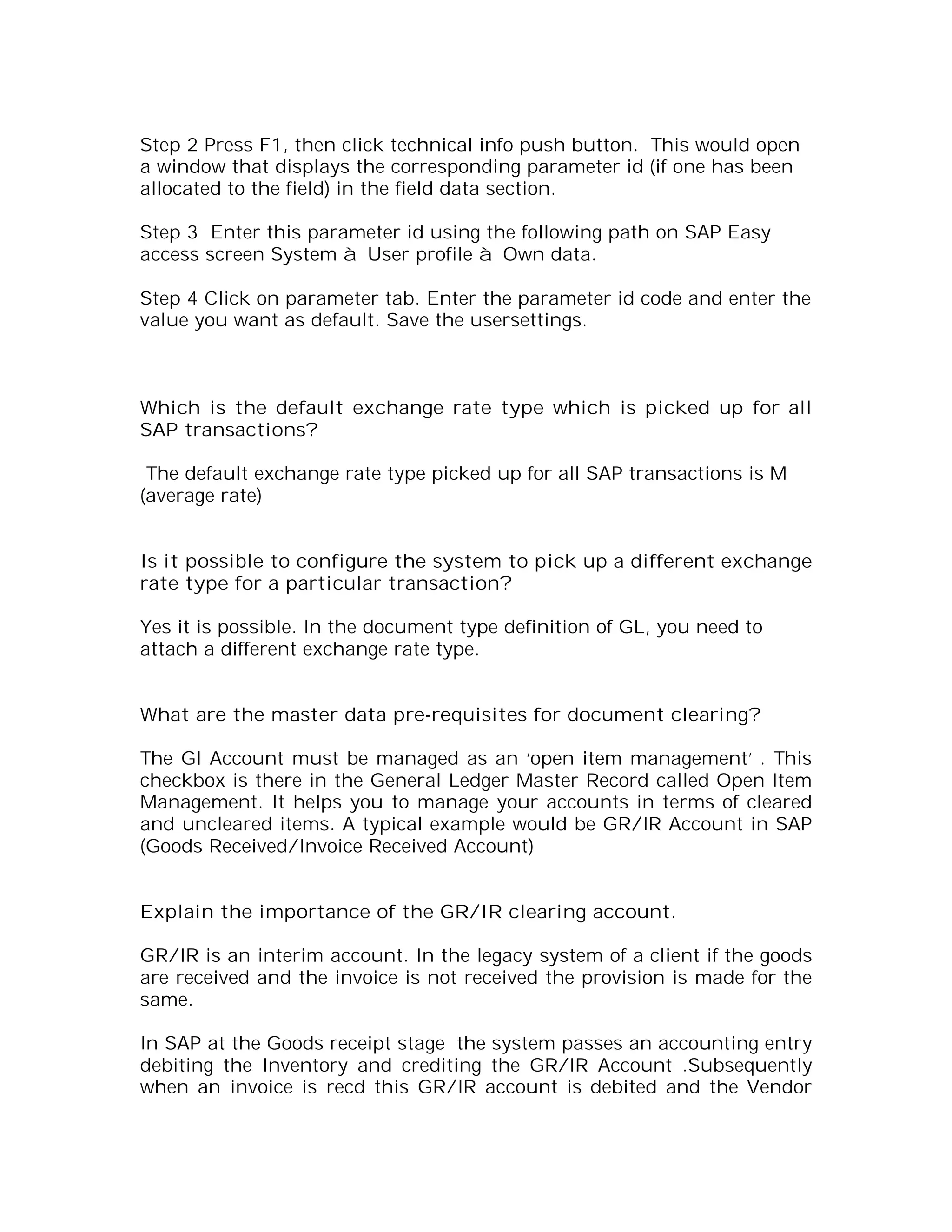

Step 2 Press F1, then click technical info push button. This would open
a window that displays the corresponding parameter id (if one has been
allocated to the field) in the field data section.

Step 3 Enter this parameter id using the following path on SAP Easy
access screen System à User profile à Own data.

Step 4 Click on parameter tab. Enter the parameter id code and enter the
value you want as default. Save the usersettings.



Which is the default exchange rate type which is picked up for all
SAP transactions?

 The default exchange rate type picked up for all SAP transactions is M
(average rate)


Is it possible to configure the system to pick up a different exchange
rate type for a particular transaction?

Yes it is possible. In the document type definition of GL, you need to
attach a different exchange rate type.


What are the master data pre-requisites for document clearing?

The Gl Account must be managed as an ‘open item management’ . This
checkbox is there in the General Ledger Master Record called Open Item
Management. It helps you to manage your accounts in terms of cleared
and uncleared items. A typical example would be GR/IR Account in SAP
(Goods Received/Invoice Received Account)


Explain the importance of the GR/IR clearing account.

GR/IR is an interim account. In the legacy system of a client if the goods
are received and the invoice is not received the provision is made for the
same.

In SAP at the Goods receipt stage the system passes an accounting entry

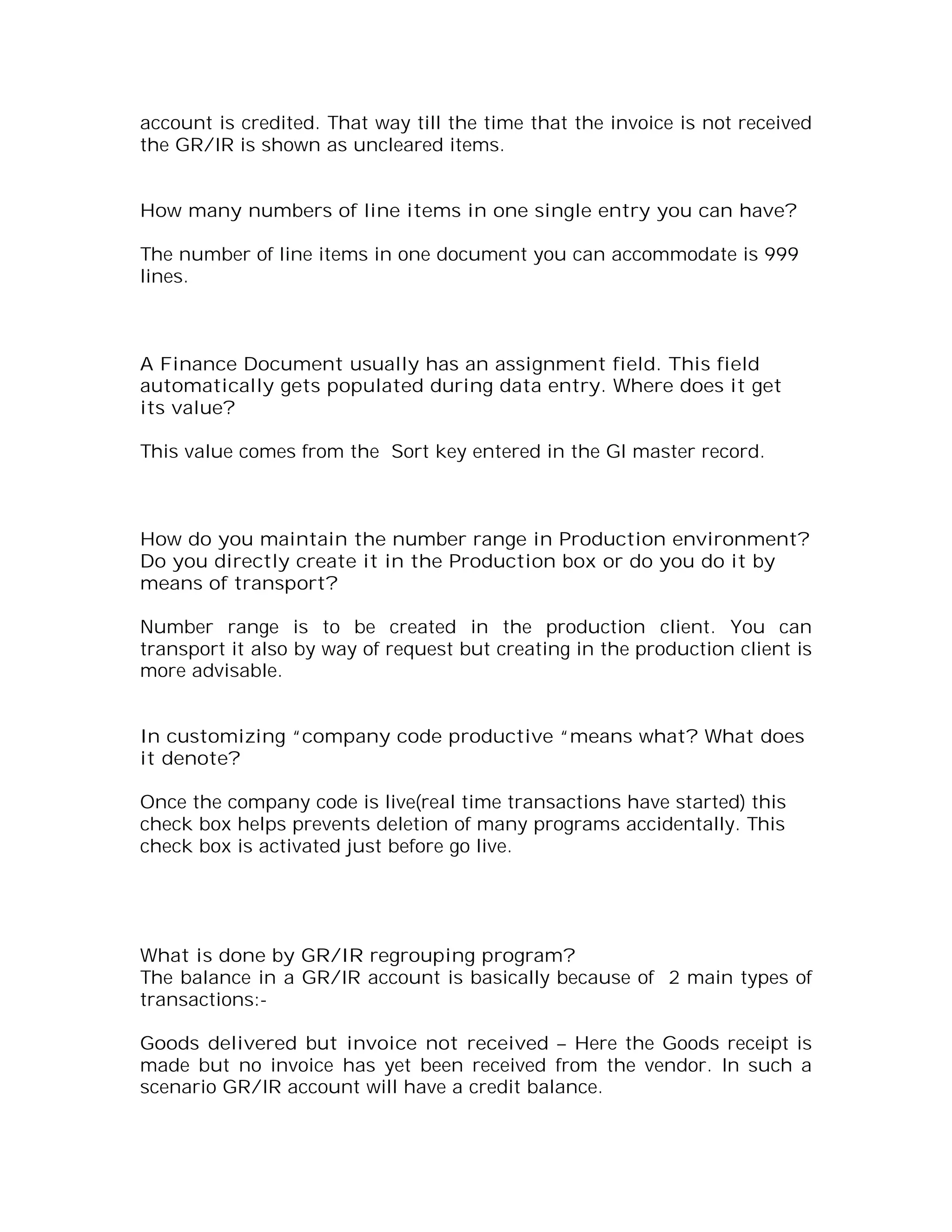

debiting the Inventory and crediting the GR/IR Account .Subsequently
when an invoice is recd this GR/IR account is debited and the Vendor
account is credited. That way till the time that the invoice is not received
the GR/IR is shown as uncleared items.


How many numbers of line items in one single entry you can have?

The number of line items in one document you can accommodate is 999
lines.



A Finance Document usually has an assignment field. This field
automatically gets populated during data entry. Where does it get
its value?

This value comes from the Sort key entered in the Gl master record.



How do you maintain the number range in Production environment?
Do you directly create it in the Production box or do you do it by
means of transport?

Number range is to be created in the production client. You can
transport it also by way of request but creating in the production client is
more advisable.


In customizing “company code productive “means what? What does
it denote?

Once the company code is live(real time transactions have started) this
check box helps prevents deletion of many programs accidentally. This
check box is activated just before go live.




What is done by GR/IR regrouping program?
The balance in a GR/IR account is basically because of 2 main types of
transactions:-

Goods delivered but invoice not received – Here the Goods receipt is
made but no invoice has yet been received from the vendor. In such a
scenario GR/IR account will have a credit balance.
Invoiced received but goods not delivered – Here the Invoice is
received from the vendor and accounted for, but goods have not been
received. In such a scenario GR/IR account will have a debit balance.

The GR/IR account would contain the net value of the above two types of
transactions.    The GR/IR regrouping program analyses the above
transactions and regroups them to the correct adjustment account. The
balance on account of first transactions will be regrouped to another
liability account and the balance on account of second transactions will
be regrouped to an asset account.


What are the functionalities available in the financial statement
version?

In the financial statement version the most important functionality
available is the debit credit shift. This is more important in case of
Bank overdraft accounts which can have a debit balance or a credit
balance. Thus in case of a debit balance you would require the overdraft
account to be shown on the Asset side. In case of credit balance you
would require the account to be shown on the Liability side.


Is it possible to print the financial statement version on a SAPscript
form?

Yes. It is possible to print the financial statement version on a SAPscript
form.


How do you configure the SAPscript form financial statement
version?

It is possible to generate a form from the financial statement version and
print the financial statements on a SAPscript form. In the customizing for
financial statement version select the FSV you created and choose Goto
à Generate form à One column or Two column form.

You can also copy form from the standard system.



Is it possible to generate a financial statement form automatically?

Yes. It is possible to generate a form automatically.
Is it possible to keep the FI posting period open only for certain GL
codes?

Yes. It is possible to keep open the FI posting period only for certain GL
codes.


How do you keep the FI posting period open only for certain GL
codes?

In transaction code OB52 click on new entries and maintain an interval
or a single GL code for the account type S with the posting period
variant. If the GL codes are not in sequence then you need to maintain
further entries for the posting period variant and account type S.


Can posting period variant be assigned to more than 1 company
code?

Yes. Posting period variant can be assigned to more than one company
code.
Accounts Receivable and Accounts
Payable

At what level are the customer and vendor codes stored in SAP?

The customer and vendor code are at the client level. That means any
company code can use the customer and vendor code by extending the
company code view.


How are Vendor Invoice payments made?

Vendor payments can be made in the following manner:

Manual payments without the use of any output medium like cheques
etc.

Automatic Payment program through cheques, Wire transfers, DME etc.


How do you configure the automatic payment program?


The following are the steps for configuring the automatic payment
program:-


Step 1 Set up the following:

      Co. code for Payment transaction
      Define sending and paying company code.
      Tolerance days for payable
      Minimum % for cash discount
      Maximum cash discount
      Special GL transactions to be paid

Step 2 Set up the following:

      Paying company code for payment transaction
      Minimum amount for outgoing payment
      No exchange rate diff
      Separate payment for each ref
      Bill/exch payment
Form for payment advice

Step 3 Set up the following:

      Payment method per country
      Whether Outgoing payment
      Check or bank transfer or B/E
      Whether allowed for personnel payment
      Required master data
      Doc types
      Payment medium programs
      Currencies allowed

Step 4 Set up the following:

      Payment method per company code for payment transactions
      Set up per payment method and co. code
      The minimum and maximum amount.
      Whether payment per due day
      Bank optimization by bank group or by postal code or no
      optimization
      Whether Foreign currency allowed
      Customer/Vendor bank abroad allowed
      Attach the payment form check
      Whether payment advice required

Step 5 Set up the following:

      Bank Determination for Payment Transactions
      Rank the house banks as per the following
      Payment method, currency and give them ranking nos
      Set up house bank sub account (GL code)
      Available amounts for each bank
      House bank, account id, currency, available amount
      Value date specification



Where do you attach the check payment form?

It is attached to the payment method per company code.




Where are Payment terms for customer master maintained?
Payment terms for customer master can be maintained at two places i.e.
in the accounting view and the sales view of the vendor master record.


Which is the payment term which actually gets defaulted when the
transaction is posted for the customer (accounting view or the sales
view)?

The payment term in the accounting view of the customer master comes
into picture if the transaction originates from the FI module. If an FI
invoice is posted (FB70) to the customer, then the payment terms is
defaulted from the accounting view of the customer master.

The payment term in the sales view of the customer master comes into
picture if the transaction originates from the SD module. A sales order is
created in the SD module. The payment terms are defaulted in the sales
order from the sales view of the customer master.




Where are Payment terms for vendor master maintained?

Payment terms for Vendor master can be maintained at two places i.e. in
the accounting view and the purchasing view.


 Which is the payment term which actually gets defaulted in
transaction (accounting view or purchasing view)?
The payment term in the accounting view of the vendor master comes
into picture if the transaction originates from the FI module. If an FI
invoice is posted (FB60) to the Vendor, then the payment terms is
defaulted from the accounting view of the vendor master.

The payment term in the purchasing view of the vendor master comes
into picture if the transaction originates from the MM module. A
purchase order is created in the MM module. The payment terms are
defaulted in the purchase order from the purchasing view of the vendor
master.


Explain the entire process of Invoice verification from GR to Invoice
verification in SAP with accounting entries?
These are the following steps:

A goods receipt in SAP for a purchased material is prepared referring a
purchase order.

When the goods receipt is posted in SAP the accounting entry passed is:-
Inventory account Debit
GR/IR account credit

A GR/IR (which is Goods receipt/Invoice receipt) is a provision account
which provides for the liability for the purchase. The rates for the
valuation of the material are picked up from the purchase order.

When the invoice is booked in the system through Logistics invoice
verification the entry passed is as follows:-

GR/IR account debit
Vendor credit


How are Tolerances for Invoice verification defined?


The following are instances of tolerances that can be defined for Logistic
Invoice Verification.
         c. Small Differences
         d. Moving Average Price variances
         e. Quantity variances
         f. Price variances

Based on the client requirement, the transaction can be “Blocked” or
Posted with a “Warning” in the event of the Tolerances being exceeded.

Tolerances are nothing but the differences between invoice amount and
payment amount or differences between goods receipt amount and
invoice amount which is acceptable to the client.


Can we change the reconciliation account in the vendor master?

Yes. Reconciliation account can be changed in the vendor master
provided that the authority to change has been configured. Normally we
should not change the reconciliation account.
What is the impact on the old balance when the reconciliation
account in the vendor master is changed?

Any change you make to the reconciliation account is prospective and
not retrospective. The old items and balances do not reflect the new
account only the new transactions reflect the account.


There is an advance given by the customer which lies in a special GL
account indicator A. Will this advance amount be considered for
credit check?

It depends on the configuration setting in the special GL indicator A. If
the “Relevant to credit limit” indicator is switched on in the Special GL
indicator A the advances will be relevant for credit check, otherwise it will
not be relevant.



In payment term configuration what are the options available for
setting a default baseline date?

There are 4 options available:-

   1)   No default
   2)   Posting date
   3)   Document date
   4)   Entry date


What is generally configured in the payment term as a default for
baseline date?

Generally document date is configured in the payment term as a default
for base line date.


How do you configure a special GL indicator for Customer?

You can use an existing special GL indicator ID or create a new one.
After creating a special GL indicator id, update the chart of accounts and
the Reconciliation account. Also as a last step you need to update the
special GL code.
The special GL code should also be marked as a Reconciliation account.
Switch on the relevant for credit limit and commitment warning
indicators in the master record.
Bank Accounting:

How is Bank Reconciliation handled in SAP?

The bank reco typically follows the below procedure:

First, the payment made to a Vendor is posted to an interim bank
clearing account. Subsequently, while performing reconciliation, an entry
is posted to the Main Bank account. You can do bank reconciliation
either manually or electronically.


How do you configure check deposit?


The following are the steps for configuring check deposit:-

Step1: Create account symbols for the main bank and incoming check
account.

Step2: Assign accounts to account symbols

Step3: Create keys for posting rules

Step4: Define posting rules

Step5: Create business transactions and assign posting rule

Step6: Define variant for check deposit


What is the clearing basis for check deposit?

In the variant for check deposit we need to set up the following

   a) fields document number ( which is the invoice number),
   b) amount
   c) Short description of the customer.

   The document number and the invoice amount acts as the clearing
   basis.


How do you configure manual bank statement?
The following are the steps for configuring manual bank statement:-

Step1: Create account symbols for the main bank and the sub accounts

Step2: Assign accounts to account symbols

Step3: Create keys for posting rules

Step4: Define posting rules

Step5: Create business transaction and assign posting rule

Step6: Define variant for Manual Bank statement




How do you configure Electronic bank statement?

The steps for Electronic Bank Statement are the same except for couple
of more additional steps which you will see down below

Step1:   Create account symbols for the main bank and the sub accounts
Step2:   Assign accounts to account symbols
Step3:   Create keys for posting rules
Step4:   Define posting rules
Step5:   Create transaction type
Step6:   Assign external transaction type to posting rules
Step7:   Assign Bank accounts to Transaction types
Fixed Assets

What are the organizational assignments in asset accounting?

Chart of depreciation is the highest node in Asset Accounting and this is
assigned to the company code.

Under the Chart of depreciation all the depreciation calculations are
stored.


How do you go about configuring Asset accounting?

The configuration steps in brief are as follows:-
a) Copy a reference chart of depreciation areas
b) Assign Input Tax indicator for non taxable acquisitions
c) Assign chart of depreciation area to company code
d) Specify account determination
e) Define number range interval
f) Define asset classes
g) Define depreciation areas posting to general ledger
h) Define depreciation key


Explain the importance of asset classes. Give examples?

The asset class is the main criterion for classifying assets. Every asset
must be assigned to only one asset class. Examples of asset class are
Plant& Machinery, Furniture & Fixtures, Computers etc. The asset class
also contains the Gl accounts which are debited when any asset is
procured. It also contains the gl accounts for depreciation calculation,
scrapping etc

Whenever you create an asset master you need to mention the asset
class for which you are creating the required asset. In this manner
whenever any asset transaction happens the gl accounts attached to the
asset class is automatically picked up and the entry passed.

You can also specify certain control parameters and default values for
depreciation calculation and other master data in each asset class.


How are depreciation keys defined?
The specifications and parameters that the system requires to calculate
depreciation amounts are entered in Calculation methods. Calculation
methods replace the internal calculation key of the depreciation key.
Depreciation keys are defaulted in Asset Master from the asset class.
Refer to the configuration for more details of how depreciation is
calculated.



A company has its books prepared based on Jan –Dec calendar year
for reporting to its parent company. It is also required to report
accounts to tax authorities based on April- March. Can assets be
managed in another depreciation area based on a different fiscal
year variant?

No. Assets accounting module cannot manage differing fiscal year variant
which has a different start date (January for book depreciation and April
for tax depreciation) and different end date (December for book
depreciation and March for tax depreciation). In this case you need to
implement the special purpose ledger.




What are the special steps and care to be taken in Fixed asset data
migration into SAP system especially when Profit center accounting
is                                                          active?

Data migration is slightly different from a normal transaction which
happens in Asset accounting module.

Normally, in asset accounting the day to day transactions is posted with
values through FI bookings and at the same time the asset reconciliation
is updated online realtime. Whereas In data Migration the asset master
is updated with values through a transaction code called as AS91. The
values updated on the master are Opening Gross value and the
accumulated depreciation. The reconciliation GL account is not
automatically updated at this point of time.

The reconciliation accounts (GL codes) are updated manually through
another transaction code called as OASV.

If profit center is active, then after uploading assets through AS91 you
should transfer the asset balances to profit center accounting through a
program.
Thereafter you remove the Asset GL code (reconciliation accounts) from
the 3KEH table for PCA and update the Asset reconciliation account (GL
code) through OASV.

After this step you again update the Asset reconciliation account in the
3KEH table.

The reason you remove the Asset reconciliation code from 3KEH table is
that double posting will happen to PCA when you update the Asset
reconciliation manually.


Is it possible to calculate multiple shift depreciation? Is any special
configuration required?

Yes it is possible to calculate multiple shift depreciation in SAP for all
types of depreciation except unit of production. No special configuration
is required.


How do you maintain multiple shift depreciation in asset master?

The following steps are needed to maintain multiple shift depreciation:

   1. The variable depreciation portion as a percentage rate is to be
      maintained in the detail screen of the depreciation area.
   2. The multiple shift factor is to be maintained in the time dependent
      data in the asset master record. This shift factor is multiplied by
      the variable portion of ordinary depreciation.

   Once you have done the above the SAP system calculates the total
   depreciation amount as follows:-

Depreciation amount = Fixed depreciation + (variable depreciation * shift
factor)


Let’s say you have changed the depreciation rates in one of the
depreciation keys due to changes in legal requirements. Does
system automatically calculate the planned depreciation as per the
new rate?

No. System does not automatically calculate the planned depreciation
after the change is made. You need to run a program for recalculation of
planned depreciation.
What are evaluation groups?

The evaluation groups are an option for classifying assets for reports or
user defined match code (search code). You can configure 5 different
evaluation groups. You can update these evaluation groups on to the
asset master record.


What are group assets?

The tax requirements in some countries require calculation of
depreciation at a higher group or level of assets. For this purpose you
can group assets together into so-called group assets.


What are the steps to be taken into account during a depreciation
run to ensure that the integration with the general ledger works
smoothly?

For each depreciation area and company code, specify the following:

  1 The frequency of posting depreciation(monthly,quarterly etc)
  2 CO account assignment (cost center)
  3 For each company code you must define a document type for
    automatic depreciation posting: This document type requires its
    own external number range.
  4 You also need to specify the accounts for posting. (Account
    determination)

   Finally to ensure consistency between Asset Accounting and Financial
  Accounting, you must process the batch input session created by the
  posting report. If you fail to process the batch input session, an error
  message will appear at the next posting run.

  The depreciation calculation is a month end process which is run in
  batches and then once the batch input is run the system posts the
  accounting entries into Finance.



How do you change fiscal year in Asset Accounting?

  n   Run The fiscal year change program which would open new annual
      value fields for each asset. i e next year
Ÿ The earliest you can start this program is in the last posting period of
    the current year.
  Ÿ You have to run the fiscal year change program for your whole
    company code.
  Ÿ You can only process a fiscal year change in a subsequent year if the
    previous year has already been closed for business.

Take care not to confuse the fiscal year change program with year-end
closing for accounting purposes. This fiscal year change is needed only in
Asset Accounting for various technical reasons.


Is it possible to have depreciation calculated to the day?

Yes it is possible. You need to switch on the indicator “Dep to the day” in
the depreciation key configuration.


Is it possible to ensure that no capitalization be posted in the
subsequent years?

Yes it is possible. You need to set it in the depreciation key
configuration.



How are Capital Work in Progress and Assets accounted for in SAP?

Capital WIP is referred to as Assets under Construction in SAP and are
represented by a specific Asset class. Usually depreciation is not charged
on Capital WIP.

All costs incurred on building a capital asset can be booked to an
Internal Order and through the settlement procedure can be posted onto
an Asset Under Construction. Subsequently on the actual readiness of
the asset for commercial production, the Asset Under Construction gets
capitalized to an actual asset.


The company has procured 10 cars. You want to create asset
masters for each of this car. How do you create 10 asset masters at
the same time?

While creating asset master there is a field on the initial create screen
called as number of similar assets. Update this field with 10. When you
finally save this asset master you will get a pop up asking whether you
want to maintain different texts for these assets. You can update
different details for all the 10 cars.
FI-MM-SD Integration

How do you go about setting the FI MM account determination ?

FI MM settings are maintained in transaction code OBYC. Within these
there are various transaction keys to be maintained like BSX, WRX,
GBB, PRD etc. In each of these transaction keys you specify the GL
accounts which gets automatically passed at the time of entry.

Few examples could be: BSX- Stands for Inventory Posting Debit
                       GBB-Standsfor Goods Issue/Scrapping/delivery
                       of goods etc
                       PRD- Stands for Price Differences.



At what level is the FI-MM, FI-SD account determination settings?

They are at the chart of accounts level.


What are the additional settings required while maintaining or
creating the GL codes for Inventory accounts?


In the Inventory GL accounts (Balance sheet) you should switch on the
‘Post automatically only’ tick. It is also advisable to maintain the
aforesaid setting for all FI-MM accounts and FI-SD accounts. This helps
in preserving the sanctity of those accounts and prevents from having
any difference between FI and MM, FI and SD.



What is Valuation and Account assignment in SAP?

This is actually the link between Materials Management and Finance.

The valuation in SAP can be at the plant level or the company code level.
If you define valuation at the plant level then you can have different
prices for the same material in the various plants. If you keep it at the
company code level you can have only price across all plants.
Valuation also involves the Price Control .Each material is assigned to a
material type in Materials Management and every material is valuated
either in Moving Average Price or Standard Price in SAP. These are the
two types of price control available.


What is Valuation Class?

The Valuation Class in the Accounting 1 View in Material Master is the
main link between Material Master and Finance. This Valuation Class
along with the combination of the transaction keys (BSX,WRX,GBB,PRD )
defined above determine the GL account during posting.

We can group together different materials with similar properties by
valuation class. Eg Raw material,Finsihed Goods, Semi Finished

We can define the following assignments in customizing :

All materials with same material type are assigned to just one valuation
class.

Different materials with the same material type can be assigned to
different valuation classes.

Materials with different material types are assigned to a single valuation
class.


Can we change the valuation class in the material master once it is
assigned?

Once a material is assigned to a valuation class in the material master
record, we can change it only if the stocks for that material are nil. If the
stock exists for that material, then we cannot change the valuation class.
In such a case, if the stock exists, we have to transfer the stocks or issue
the stocks and make the stock nil for the specific valuation class. Then
only we will be able to change the valuation class.


Does the moving average price change in the material master during
issue of the stock assuming that the price control for the material is
Moving Average?

The moving average price in the case of goods issue remains unchanged.
Goods issue are always valuated at the current moving average price. It
is only in goods receipt that the moving average price might change. A
goods issue only reduces the total quantity and the total value in relation
to the price and the moving price remains unchanged. Also read the
next question to learn more about this topic.


If the answer to the above question is ‘Yes’, then list the scenario in
which the moving average price of the material in the material
master changes when the goods are issued.

The moving average price in the material master changes in the scenario
of Split Valuation which is sometimes used by many organizations. If the
material is subject to split valuation, the material is managed as Several
partial stocks and each partial stock is valuated separately.

In split valuation, the material with valuation header record will have ‘v’
moving average price. This is where the individual stocks of a material
are managed cumulatively. Here two valuation types are created, one
valuation type can have ‘v’ (MAP) and the other valuation type can have
‘s’(standard price).

In this case, whenever the goods are issued from the respective valuation
types, always the MAP for the valuation header changes.



What is the accounting entry in the Financial books of accounts
when the goods are received in unrestricted use stock? Also
mention the settings to be done in the ‘Automatic postings’ in SAP
for the specific G/L accounts.

On receipt of the goods in unrestricted-use stock, the Inventory account
is debited and the GR/IR account gets credited. In customization, in the
automatic postings, the Inventory G/L account is assigned to the
Transaction event key BSX and the GR/IR account is assigned to the
Transaction event key WRX.



If a material has no material code in SAP, can you default the G/L
account in Purchase order or it has to be manually entered?.


If a material has no material code in SAP, we can still, default the G/L
account with the help of material groups. We can assign the valuation
class to a material group and then in FI-automatic posting, we can
assign the relevant G/L account in the Transaction event key. The
assignment of a valuation class to a material group enables the system to
determine different G/L accounts for the individual material groups.



What is the procedure in SAP for Initial stock uploading? Mention
the accounting entries also.


Initial stock uploading in SAP from the legacy system is done with
inventory movement type 561( a MM transaction which is performed).

Material valuated at standard price: For a material valuated at
standard price, the initial entry of inventory data is valuated on the basis
of standard price in the material master. If you enter an alternative value
at the time of the movement type 561, then the system posts the
difference to the price difference account.

Material valuated at moving average price: The initial entry of
inventory data is valuated as follows : If you enter a value when
uploading the initial data, the quantity entered is valuated at this price.
If you do not enter a value when entering initial data, then the quantity
entered is valuated at the MAP present in the material master.

The accounting entries are: Inventory account is debited and Inventory
Historical upload account is credited.



How do you configure FI-SD account determination?

The FI-SD account determination happens through an access sequence.
The system goes about finding accounts from more specific criteria to
less specific criteria.

This is the sequence it would follow:

   1) It will first access and look for the combination of Customer
      accounts assignment grp/ Material account assignment grp/
      Account key.
   2) If it does not find the accounts for the first combination it will look
      for Customer account assignment grp and account key
      combination.
   3) Furthermore, if it does not find accounts for the first 2 criteria’s
      then it will look for Material account assignment grp/Account key.
4) If it does not find accounts for the all earlier criteria’s then finally it
      will look for Account key and assign the GL code.

Thus posting of Sales Invoices into FI are effected on the basis of a
combination of Sales organization, Account type, or Customer and
Material Account assignment groups and following are the options
available.

a. Customer AAG/Material AAG/Account type
b. Material AAG/Account type
c. Customer AAG/Account type

For each of this option you can define a Gl account. Thus the system
uses this gl account to automatically pass the entries.
Logistics Invoice Verification

Can you assign multiple G/L accounts in the Purchase order for the
same line item?

Yes, we can assign multiple G/L accounts in the Purchase order for the
same line item. The costs can be allocated on a percentage or quantity
basis. If the partial goods receipt and partial invoice receipt has already
taken place, then the partial invoice amount can be distributed
proportionally, i.e. evenly among the account assigned items of a
Purchase order. Alternatively the partial invoice amount can be
distributed on a progressive fill-up basis, i.e. the invoiced amount is
allocated to the individual account assignment items one after the other.



What is Credit memo and subsequent debit in Logistics Invoice
verification?

The term credit memo refers to the credit memo from the vendor.
Therefore posting a credit memo always leads to a debit posting on the
vendor account. Credit memos are used if the quantity invoiced is higher
than the quantity received or if part of the quantity was returned.

Accounting entries are : Vendor account is debited and GR/IR account is
credited.

Subsequent debit : If a transaction has already been invoiced and
additional costs are invoiced later, then subsequent debit is necessary. In
this case you can debit the material with additional costs, i.e. GR/IR
account debit and Vendor account credit. When entering the Subsequent
debit, if there is no sufficient stock coverage, only the portion for the
available stock gets posted to the stock account and rest is posted to the
price difference account.




What do you mean by Invoice parking, Invoice saving and Invoice
confirmation?


Invoice parking : Invoice Parking is a functionality which allows you to
create incomplete documents and the system does not check whether the
entries are balanced or not. An accounting documents is also not created
when the invoice is in parked mode.

Thus you can create incomplete documents and then post it later to
accounting when you feel it is complete. You can even rectify the Parked
invoice. This feature is used by many companies as on many occasions
all data relating to the invoice might not be available.


Invoice saving : This is also called Invoice processing or Invoice posting.
The accounting document gets created when the invoice is posted in SAP.


Invoice confirmation : There is no terminology in SAP as Invoice
confirmation.



What are Planned delivery costs and Unplanned delivery costs?

Planned delivery costs: are entered at the time of Purchase order. At
goods receipt, a provision is posted to the freight or customs clearing
account.

e.g. FRE is the account key for freight condition, hence the system can
post the freight charges to the relevant freight revenue account and FR3
is the account key for Customs duty, hence the system can post the
customs duty to the relevant G/L account.

These account keys are assigned to the specific condition types in the
MM Pricing schema.

In terms of Invoice verification : If the freight vendor and the material
vendor is the same : then we can choose the option : Goods service items
+ Planned delivery costs.

If the freight vendor is different from the material vendor: then for
crediting only the delivery costs, we can choose the option: Planned
delivery costs.


Unplanned delivery costs: are the costs which are not specified in the
Purchase order and are only entered when you enter the invoice.
What is the basis on which the apportionment is done of unplanned
delivery costs?

Unplanned delivery costs are either uniformly distributed among the
items or posted to a separate G/L account.

For a material subjected to Moving average price, the unplanned delivery
costs are posted to the stock account, provided sufficient stock coverage
exists.

For a material subjected to Standard price, the unplanned delivery costs
are posted to the Price difference account.


There are cases where Invoice verification is done first before the
Goods receipt is made for the purchase order . In these cases with
what values would the Goods receipt be posted ?

Since the invoice verification has been done first the Goods Receipts will
be valued with the Invoice value.
FI Month End Closing Activities

What are the Month End Closing Activities in Finance?

  1. Recurring Documents.
        a) Create Recurring documents
        b) Create Batch Input for Posting Recurring Documents
        c) Run the Batch Input Session


  2. Posting Accruals or Provisions entries at month end

  3. Managing the GR/IR Account-Run the GR/Ir Automatic Clearing

  4. Foreign Currency Open Item Revaluation-Revalue Open Items in
     AR.AP

  5. Maintain Exchange Rates

  6. Run Balance Sheets –Run Financial Statement Version

  7. Reclassify Payables and Receivables if necessary

  8. Run the Depreciation Calculation

  9. Fiscal Year Change of Asset Accounting if it is year end

  10.      Run the Bank Reconciliation

  11.      Open Next Accounting Period
Controlling Module

Explain the organizational assignment in the controlling module?

Company codes are assigned to the controlling area. A controlling area
is assigned to the operating concern.

Controlling Area is the umbrella under which all controlling activities of
Cost Center Accounting, Product costing, Profitability Analysis and Profit
Center are stored.

Operating Concern is the highest node in Profitability Analysis


What is primary Cost element and secondary cost element?

Every Profit and Loss GL account that needs to be controlled has to be
defined as a cost element in SAP. Just as in FI General Ledger Accounts
exist, in Controlling we have Cost element.

Each FI General Ledger Account that is a Profit and Loss Account is also
created as a Cost element in SAP.

Primary Cost Elements are those which are created from FI general
Ledger Accounts and impact the financial accounts eg. Travelling
expenses, consumption account infact, any Profit and Loss GL account


Secondary Cost Elements are those which are created only in
controlling and does not affect the financials of the company. It is used
for internal reporting only. The postings to these accounts do not affect
the Profit or Loss of the company.

The following categories exist for secondary cost elements:

21 Internal Settlement:

Cost elements of this category is used to settle order costs to objects in
controlling such as cost centers, pa segments etc.

31 Order/Results Analysis:

Used to calculate WIP on the order/project

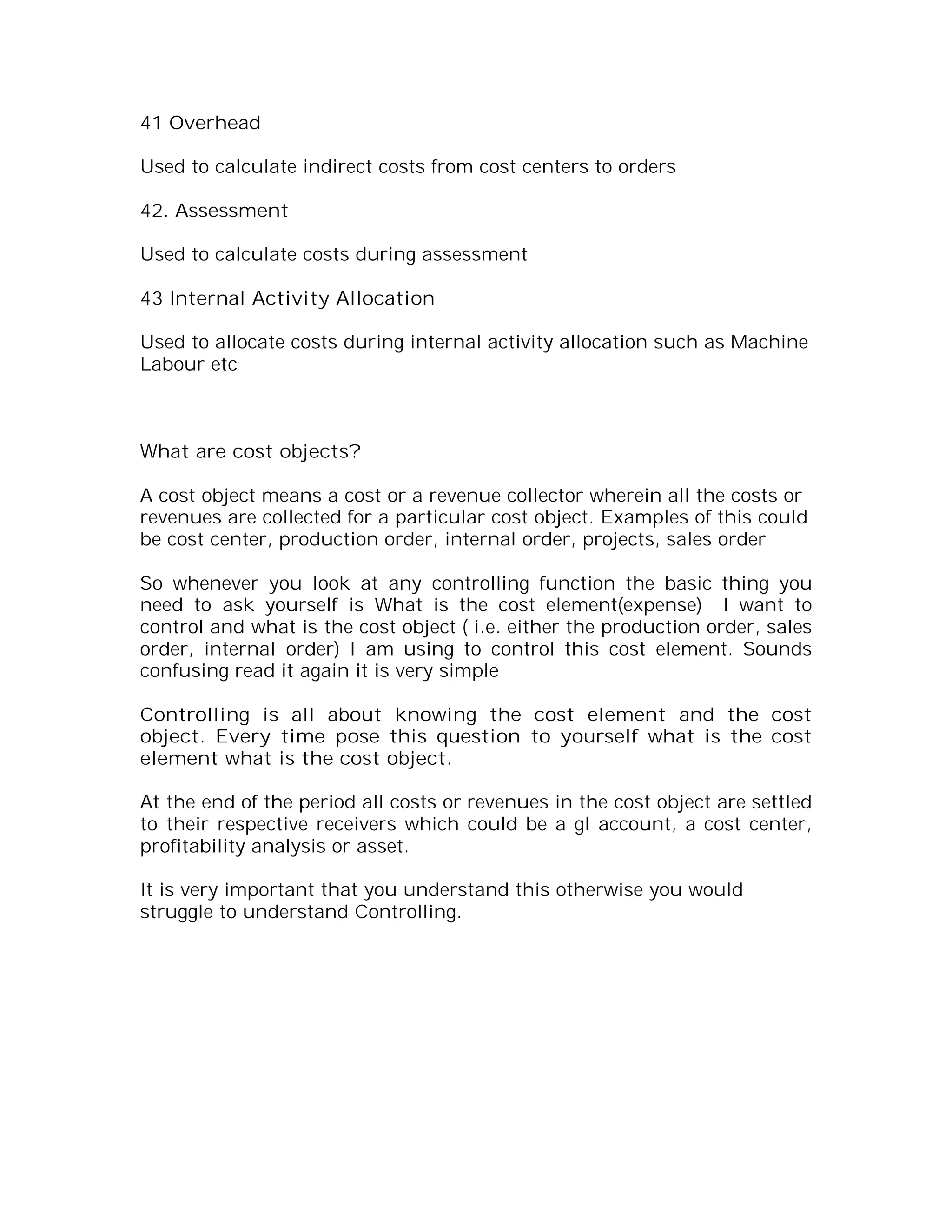

41 Overhead

Used to calculate indirect costs from cost centers to orders

42. Assessment

Used to calculate costs during assessment

43 Internal Activity Allocation

Used to allocate costs during internal activity allocation such as Machine
Labour etc



What are cost objects?

A cost object means a cost or a revenue collector wherein all the costs or
revenues are collected for a particular cost object. Examples of this could
be cost center, production order, internal order, projects, sales order

So whenever you look at any controlling function the basic thing you
need to ask yourself is What is the cost element(expense) I want to
control and what is the cost object ( i.e. either the production order, sales
order, internal order) I am using to control this cost element. Sounds
confusing read it again it is very simple

Controlling is all about knowing the cost element and the cost
object. Every time pose this question to yourself what is the cost
element what is the cost object.

At the end of the period all costs or revenues in the cost object are settled
to their respective receivers which could be a gl account, a cost center,
profitability analysis or asset.

It is very important that you understand this otherwise you would
struggle to understand Controlling.

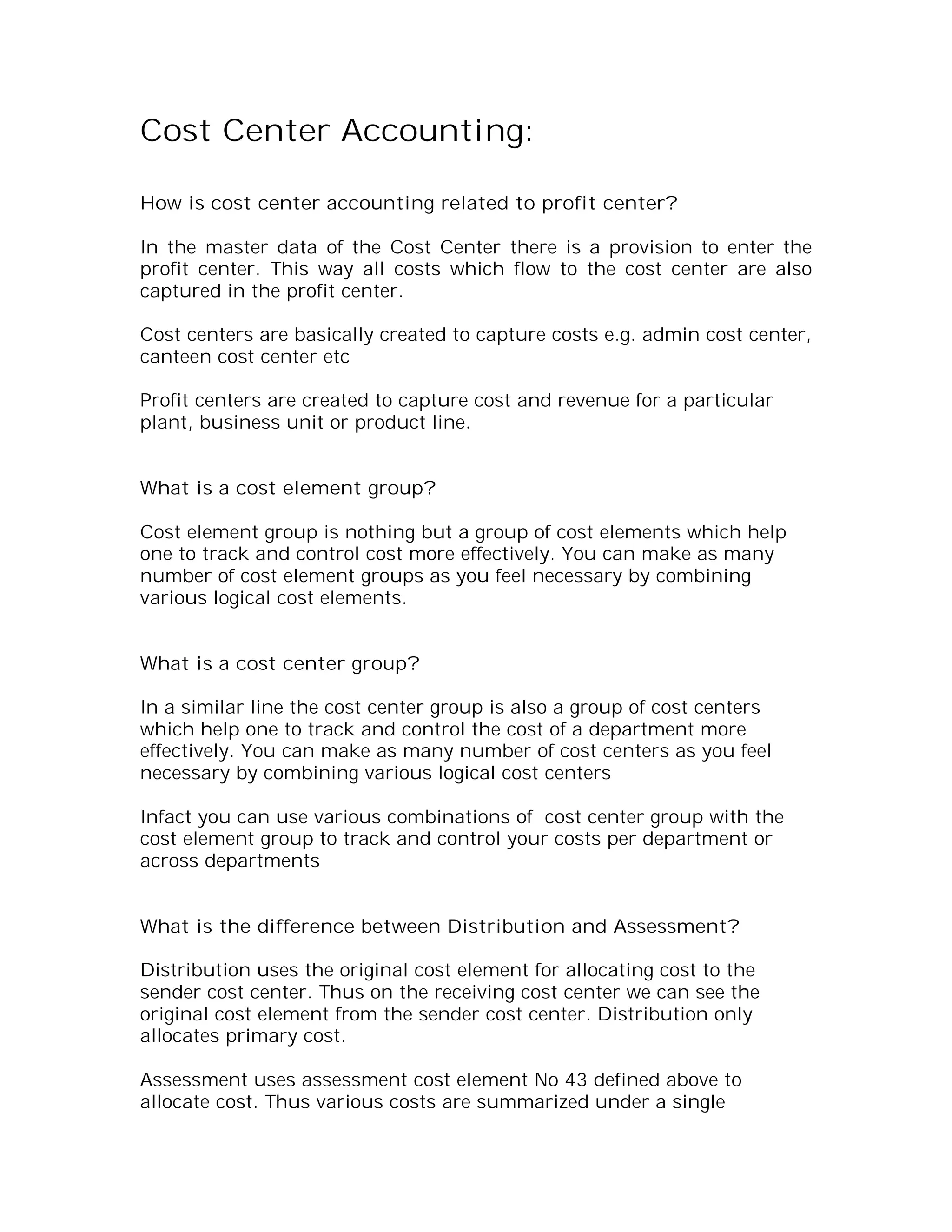

Cost Center Accounting:

How is cost center accounting related to profit center?

In the master data of the Cost Center there is a provision to enter the
profit center. This way all costs which flow to the cost center are also
captured in the profit center.

Cost centers are basically created to capture costs e.g. admin cost center,
canteen cost center etc

Profit centers are created to capture cost and revenue for a particular
plant, business unit or product line.


What is a cost element group?

Cost element group is nothing but a group of cost elements which help
one to track and control cost more effectively. You can make as many
number of cost element groups as you feel necessary by combining
various logical cost elements.


What is a cost center group?

In a similar line the cost center group is also a group of cost centers
which help one to track and control the cost of a department more
effectively. You can make as many number of cost centers as you feel
necessary by combining various logical cost centers

Infact you can use various combinations of cost center group with the
cost element group to track and control your costs per department or
across departments


What is the difference between Distribution and Assessment?

Distribution uses the original cost element for allocating cost to the
sender cost center. Thus on the receiving cost center we can see the
original cost element from the sender cost center. Distribution only
allocates primary cost.

Assessment uses assessment cost element No 43 defined above to
allocate cost. Thus various costs are summarized under a single
assessment cost element. In receiver cost center the original cost
breakup from sender is not available. Assessment allocates both primary
as well as secondary cost.




What are the other activities in Cost center?

If you have a manufacturing set up, entering of Activity prices per cost
center/activity type is an important exercise undertaken in Cost center
accounting.


What is an Activity Type?

Activity types classify the activities produced in the cost centers.
Examples of Activity Type could be Machine, Labour, Utilities



You want to calculate the activity price through system? What are
the requirements for that?

In the activity type master you need to select price indicator 1 – Plan
price, automatically based on activity.

When activity price is calculated through system whether activity
price is shown as fixed or variable?

Normally when activity price is calculated through system it is shown as
fixed activity price since primary cost are planned as activity independent
costs.


What is required to be done if activity price is to be shown both
fixed and variable?

In this case you need to plan both activity independent cost which are
shown as fixed costs and activity dependent costs which are shown as
variable costs.



Is it possible to calculate the planned activity output through
system?
Yes. It is possible to calculate the planned activity output through
system by using Long term Planning process in PP module.


Explain the process of calculating the planned activity output
through Long term planning?

In Long term planning process the planned production quantities are
entered for the planning year in a particular scenario. The Long term
planning is executed for the scenario. This generates the planned activity
requirements taking the activity quantities from the routing and
multiplying with the planned production.

The activity requirements are then transferred to the controlling module
as scheduled activity quantities. Thereafter you execute a plan activity
reconciliation which will reconcile the schedule activity and the activity
you have planned manually. The reconciliation program updates the
scheduled activity quantity as the planned activity in the controlling
module.



You want to revalue the production orders using actual activity
prices. Is there any configuration setting?

Yes. There is a configuration setting to be done.


Where is the configuration setting to be done for carrying out
revaluation of planned activity prices in various cost objects?

The configuration setting is to be done in the cost center accounting
version maintenance for fiscal year. This has to be maintained for version
0. You need to select revalue option either using own business
transaction or original business transaction.


At month end you calculate actual activity prices in the system.
You want to revalue the production orders with this actual activity
prices. What are the options available in the system for revaluation?

The options available are as follows:-

You can revalue the transactions using periodic price, average price or
cumulative price.
Further you can revalue the various cost objects as follows:-
Own business transaction – Differential entries are posted
Original business transaction – The original business transaction is
changed.
Internal orders

What is the purpose of defining Internal orders.?

An example would help us understand this much better.

Lets say in an organization there are various events such as trade fairs,
training seminars, which occur during the year. Now lets assume for a
second that these Trade fairs are organized by the Marketing cost center
of the organization. Therefore in this case marketing cost center is
responsible for all the trade fairs costs. All these trade fairs costs are
posted to the marketing cost centers. Now if the management wants an
analysis of the cost incurred for each of the trade fair organized by
the marketing cost center how would the marketing manager get
this piece of information across to them? The cost center report
would not give this piece of info

Now this is where Internal Order steps in .If you go through all cost
center reports this information is not readily available since all the costs
are posted to the cost center.

SAP, therefore provides the facility of using internal orders which comes
in real handy in such situations. In the above scenario the controlling
department would then need to create an internal order for each of the
trade fair organized. The cost incurred for each of the trade fair will be
posted to the internal orders during the month. At the month end, these
costs which are collected in the internal order will be settled from these
orders to the marketing cost center. Thus the controlling person is now
in a position to analyze the cost for each of the trade fair separately.

Thus internal order is used to monitor costs for short term events,
activities. It helps in providing more information than that is provided on
the cost centers. It can be widely used for various purposes .



How can you default certain items while creation of internal order
master data?

You can do so by creating a model order and then update the fields
which you want to default in this model order. Finally attach this model
order in the internal order type in the field reference order.
Once the above is done whenever you create an internal order for this
order type the field entries will get copied from the model order.


What is the configuration setting for the release of the internal
order immediately after creation?

You have to check the “release immediately” check box in the
internal order type.
Product Costing

What are the important Terminologies in Product Costing?:


Results Analysis Key – This key determines how the Work in Progress is
calculated

Cost Components         - The break up of the costs which get reflected in
the product costing eg. Material Cost, Labour Cost, Overhead etc

Costing Sheets         -   This is used to calculate the overhead in
Controlling

Costing Variant        - For All manufactured products the price control
recommended is Standard Price. To come up with this standard price for
the finished good material this material has to be costed. This is done
using Costing Variant. Further questions down below will explain this
concept better.



What are the configuration settings maintained in the costing
variant?


Costing variant forms the link between the application and Customizing,
since all cost estimates are carried out and saved with reference to a
costing variant. The costing variant contains all the control parameters
for costing.

The configuration parameters are maintained for costing type, valuation
variants, date control, and quantity structure control.

In costing type we specify which field in the material master should be
updated.

In valuation variant we specify the following
   a) the sequence or order the system should go about accessing
      prices for the material master (planned price, standard price,
      moving average price etc).
   b) It also contains which price should be considered for activity price
      calculation and .
   c) How the system should select BOM and routing.
How does SAP go about costing a Product having multiple Bill of
materials within it?

SAP first costs the lowest level product, arrives at the cost and then goes
and cost the next highest level and finally arrives at the cost of the final
product.


What does the concept of cost roll up mean in product costing
context?

The purpose of the cost roll up is to include the cost of goods
manufactured of all materials in a multilevel production structure at the
topmost level of the BOM(Bill of Material)

The costs are rolled up automatically using the costing levels.
   1) The system first calculates the costs for the materials with the
      lowest costing level and assigns them to cost components.

   2) The materials in the next highest costing level (such as semi-
      finished materials) are then costed. The costs for the materials
      costed first are rolled up and become part of the material costs of
      the next highest level.


What is a settlement profile and why is it needed?

All the costs or revenues which are collected in the Production order or
Sales order for example have to be settled to a receiver at the end of the
period. This receiver could be a Gl account, a cost center, profitability
analysis or asset. Also read the question “What is a cost object “ in the
section Controlling.

In order to settle the costs of the production order or sales order a
settlement profile is needed.

In a settlement profile you define a range of control parameters for
settlement. You must define the settlement profile before you can enter a
settlement rule for a sender.


The Settlement Profile is maintained in the Order Type and defaults
during creating of order.
.
Settlement profile includes:-


1) the retention period for the settlement documents.
2) Valid receivers GL account, cost center, order, WBS element, fixed
asset, material, profitability segment, sales order, cost objects, order
items, business process
3) Document type is also attached here
4) Allocation structure and PA transfer structure is also attached to the
settlement profile e.g. A1

The settlement profile created is then attached to the order type.



What is Transfer or Allocation structure?

The transfer structure is what helps in settling the cost from one cost
object to the receiver. It is maintained in the Settlement profile defined
above.

The Transfer structure has 2 parts:

    a) Source of cost elements you want to settle
    b) Target receiver whether it is a Profitability segment or fixed asset or
       cost center

So basically for settling the costs of a cost object you need
to define the Transfer structure where you mention what
are the costs you want to settle and the target receiver for
that.

This information you fit it in the settlement profile which
contains various other parameters and this settlement
profile is defaulted in the Order type. So every time a
order is executed the relevant settlement rule is stored
and at the month end by running the transaction of the
settlement of orders all the cost is passed on to the
receiver

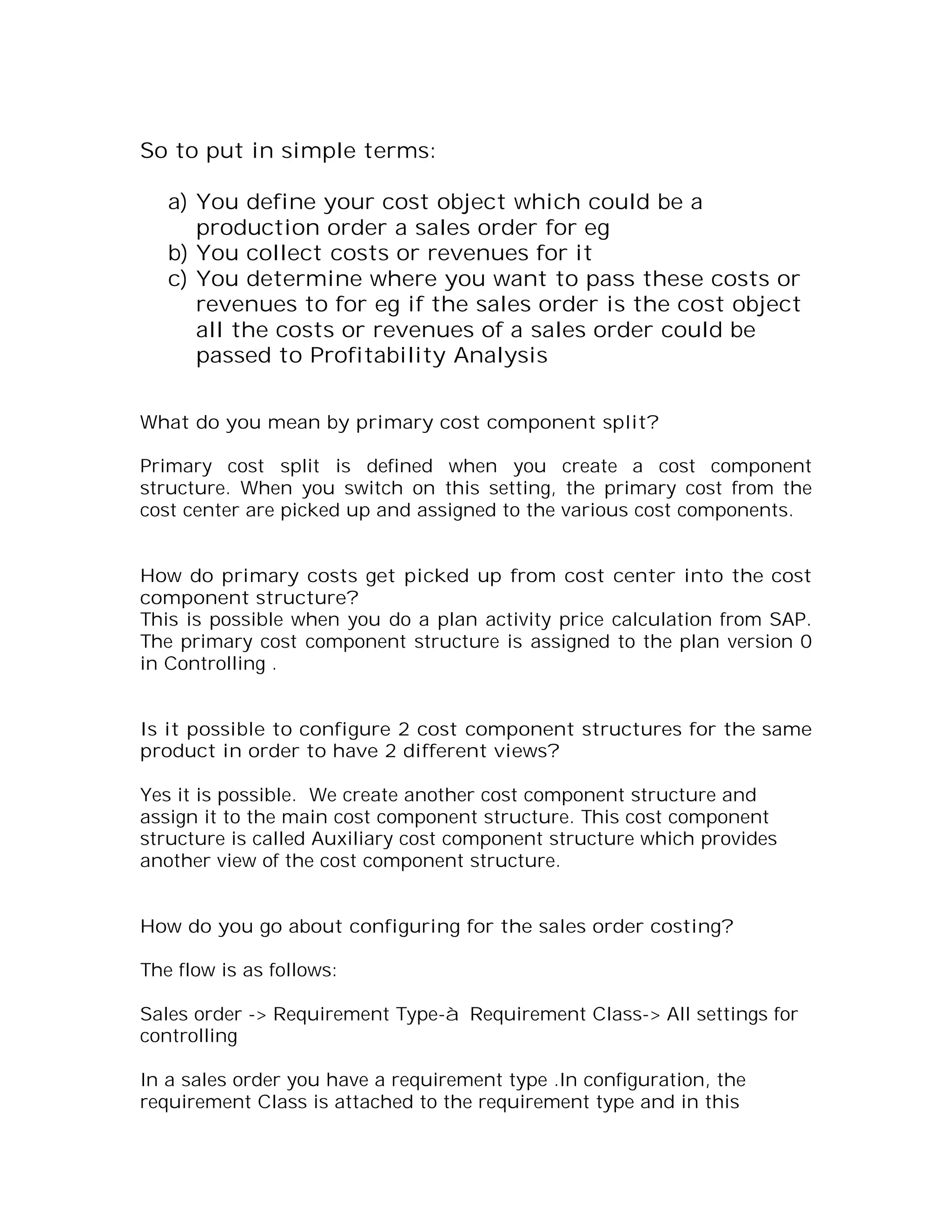

So to put in simple terms:

   a) You define your cost object which could be a
      production order a sales order for eg
   b) You collect costs or revenues for it
   c) You determine where you want to pass these costs or
      revenues to for eg if the sales order is the cost object
      all the costs or revenues of a sales order could be
      passed to Profitability Analysis


What do you mean by primary cost component split?

Primary cost split is defined when you create a cost component
structure. When you switch on this setting, the primary cost from the
cost center are picked up and assigned to the various cost components.


How do primary costs get picked up from cost center into the cost
component structure?
This is possible when you do a plan activity price calculation from SAP.
The primary cost component structure is assigned to the plan version 0
in Controlling .


Is it possible to configure 2 cost component structures for the same
product in order to have 2 different views?

Yes it is possible. We create another cost component structure and
assign it to the main cost component structure. This cost component
structure is called Auxiliary cost component structure which provides
another view of the cost component structure.


How do you go about configuring for the sales order costing?

The flow is as follows:

Sales order -> Requirement Type-à Requirement Class-> All settings for
controlling

In a sales order you have a requirement type .In configuration, the
requirement Class is attached to the requirement type and in this
requirement class all configuration settings are maintained for
controlling.

In the requirement class we attach the costing variant, we attach the
condition type EK02 where we want the sales order cost to be updated,
and the account assignment category. In the account assignment
category we define whether the sales order will carry cost or not. In case
if we do not want to carry cost on the sales order we keep the
consumption posting field blank.

We also define here the Results Analysis version which helps to calculate
the Results Analysis for the Sales order if required.


There are 2 plants in a company code. First plant is the
manufacturing plant and another plant is the selling plant. Finished
goods are manufactured at the manufacturing plant and transferred
to the selling plant. How is standard cost estimate calculated at the
selling plant given the fact that the cost at both the plant should be
the same?

The special procurement type needs to be configured which specifies in
which plant the system is to look up for cost. Here a special procurement
key specifying plant 1 (manufacturing plant) should be configured.

This special procurement type must be entered in the costing view or the
MRP view of the Finished good material master record in plant 2.

When you cost the finished good at plant 2, the system will transfer the
standard cost estimate from plant 1 to plant 2


What is mixed costing in SAP? Give an example to explain.

Mixed costing is required when different processes are used to
manufacture the same material. Mixed costing is required when you have
different sources of supply for purchasing the material.

Let us take an example:-

There is a finished good Xylene which can be manufactured by 3
different processes.

The first process uses an old machine and labour. The processing time is
9 hrs to manufacture.
The second process uses a semi-automatic machine and labour. The
processing time is 7 hrs to manufacture.

The third process uses a fully automatic machine and the processing
time is 5 hrs.

Thus cost of manufacture for the 3 processes is different. By using Mixed
costing you can create a mixed price for the valuation of this finished
good.


What configuration needs to done for using Mixed costing?

Quantity Structure type for mixed costing must be configured. Here we
specify the time dependency of the structure type . The following options
exist
   a) You have no time dependency.
   b) It is based on fiscal year
   c) It is based on period

This quantity structure type is then assigned to the costing version.


Lets say for a product there exists three production versions.
Explain the process how you would go about creating a mixed cost
estimate?

The process of creating a Mixed cost estimate would be as follows:-
   1) Create procurement alternatives for each of the production version.
   2) Define Mixing ratios for the procurement alternatives
   3) Select the configured quantity structure type and execute a
      material cost estimate based on the costing version.


What is Mixing ratios and why are they required to be maintained
before creation of cost estimate?

Mixing ratios are weighting factors assigned to the procurement
alternatives. This weighting factor is obtained from the planning
department based on the usage of the procurement alternatives during
the planning year.

For e.g.
Procurement alternative 1 (production version 1) 40% will be
manufactured

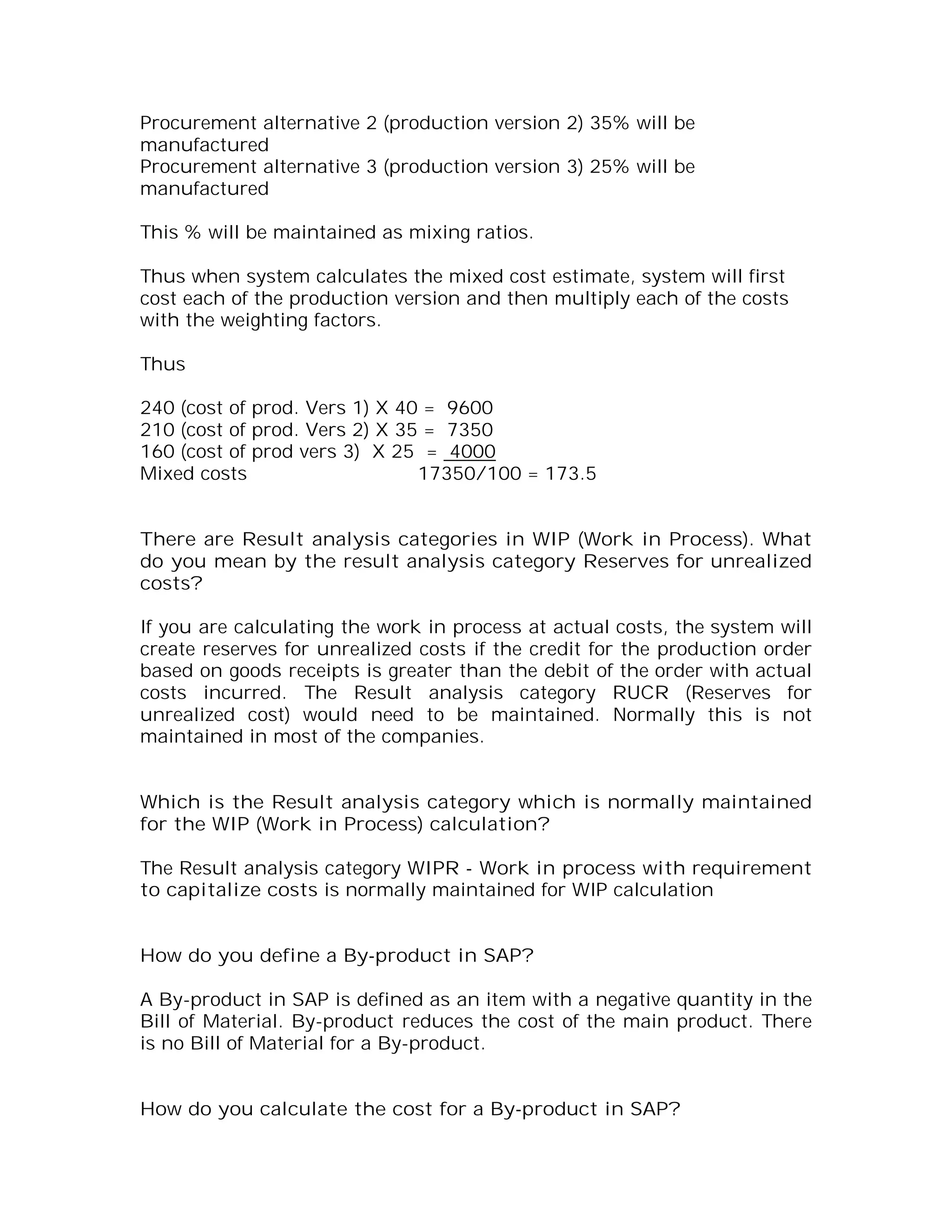

Procurement alternative 2 (production version 2) 35% will be
manufactured
Procurement alternative 3 (production version 3) 25% will be
manufactured

This % will be maintained as mixing ratios.

Thus when system calculates the mixed cost estimate, system will first
cost each of the production version and then multiply each of the costs
with the weighting factors.

Thus

240 (cost of prod. Vers 1) X 40 = 9600
210 (cost of prod. Vers 2) X 35 = 7350
160 (cost of prod vers 3) X 25 = 4000
Mixed costs                    17350/100 = 173.5


There are Result analysis categories in WIP (Work in Process). What
do you mean by the result analysis category Reserves for unrealized
costs?

If you are calculating the work in process at actual costs, the system will
create reserves for unrealized costs if the credit for the production order
based on goods receipts is greater than the debit of the order with actual
costs incurred. The Result analysis category RUCR (Reserves for
unrealized cost) would need to be maintained. Normally this is not
maintained in most of the companies.


Which is the Result analysis category which is normally maintained
for the WIP (Work in Process) calculation?

The Result analysis category WIPR - Work in process with requirement
to capitalize costs is normally maintained for WIP calculation


How do you define a By-product in SAP?

A By-product in SAP is defined as an item with a negative quantity in the
Bill of Material. By-product reduces the cost of the main product. There
is no Bill of Material for a By-product.


How do you calculate the cost for a By-product in SAP?
The cost for the By-product is the net realizable value. This is manually
maintained in the system for the by-product through transaction code
MR21 Price change.


How do you define a Co-Product in SAP?

A Co-product (primary product or by-product) is indicated by a tick in
the costing view of the material master. In the BOM all the primary
products are represented as an item with negative quantity. A primary
product is also indicated as a co-product in the BOM of the leading co-
product. For primary products the costs are calculated using the
apportionment method, while for by-products the net realizable value
method applies.



Is it possible to use Standard SAP Co-product functionality in
Repetitive manufacturing?

No. It is not possible to use the Standard Co-product functionality in
repetitive manufacturing


How do you got about defining CO-Product functionality in
Repetitive manufacturing?

In the Repetitive manufacturing you need to use the Costing BOM for the
other co-product. Through arithmetical calculation you need to maintain
the quantities in the costing BOM. This co-product will be shown as a
negative item in the leading co-product.



You get an error while executing a cost estimate which says” Item
no 1 (which is a raw material) is not assigned to the cost component
structure?
What could be the possible cause of error in this scenario?

The consumption GL code for the material master is not assigned to the
cost component structure. To find out how you can know which GL code
to assign read the next question.
In the above scenario how do you know which cost element is being
called for?

In this case you need to the use simulation mode OMWB in MM and
enter the material code plant and the movement type 261 (issue against
production order). You will see the account modifier VBR and against
which the GL code is available.



You get an error while executing a cost estimate, which says” Item
no. 1 (which is a raw material) is not assigned to the cost
component structure?
In this case everything is perfectly configured, what could be the
possible error in this scenario?

In the material master of the raw material the valuation class updated in
the accounting view will be incorrect.


Is it possible to calculate standard cost estimate for a past date?

No. It is not possible to calculate standard cost estimate for a past date.


What is the difference between a product cost collector and
production order?

Both of these are cost objects which collect production costs for
manufactured product. Product cost collector is a single order created for
a material. All the costs during the month for that material is debited to
single product cost collector. No costing by lot size is required in case of
product cost collector.

The latter is where there are many production orders for a single material
during the month. Costs are collected on each of this production order.
Costing by lot size is the main requirement in case of production orders.


What is the meaning of     preliminary cost estimate for product cost
collector?

Preliminary costing in the product cost by period component calculates
the costs for the product cost collector. In repetitive manufacturing you
can create cost estimate for specific production version.
Why is preliminary cost estimate required?

The preliminary cost estimate is required for the following:-

Confirm the actual activity quantities.
Valuate work in process
Calculate production variances in variance calculation
Valuate the unplanned scrap in variance calculation




Is it possible to update the results of the standard cost estimate to
other fields such as commercial price, tax price fields in the
accounting view?

Yes. It is possible to update the standard cost estimate to other fields
such as commercial price etc. in accounting view.



How do you configure that the results of the standard cost estimate
are updated in other fields other than the standard price?

The price update in the material master is defined in Costing type. This
costing type is attached to the costing variant.


What do you mean by Assembly scrap and how is it maintained in
SAP?

Assembly scrap is scrap that is expected to occur during the production
of a material which is used as an assembly.

If a certain amount of scrap always occurs during the production of an
assembly, the quantities and activities used must be increased by the
system so that the required lot size can be produced.

To increase the lot size of an assembly you can enter a percentage, flat-
rate assembly scrap in the MRP 1 view of the material master record.
This assembly scrap is reflected in all the subordinate components. The
system increases the quantity to be produced by the calculated scrap
quantity. This increases both the materials consumed and the activities
consumed and consequently the cost.
How are scrap costs shows in the standard cost estimate?

Scrap costs are assigned to the relevant cost component and can be
shown separately for a material in the costed multilevel BOM.


How are scrap variances calculated?

Scrap variance are calculated by valuating the scrap quantities with the
amount of the actual costs less the planned scrap costs.




What do you mean by Component scrap and how is it maintained in
SAP?

Component scrap is the scrap of a material that is expected to occur
during production. When an assembly is produced with this component,
the system has to increase the component quantity to enable to reach
the required lot size. The component scrap can be entered in the BOM
item or in the MRP 4 view of the material master


What do you mean by Operation scrap and how is it maintained in
SAP?

Operation scrap is a scrap that is expected to occur during production.
Operation scrap is used to reduce the planned input quantities in follow
up operations and to calculate the precise amount of assembly scrap.
Operation scrap can be maintained in % in the routing and in the BOM.


What are the implications if the operation scrap is maintained in
the routing and if it maintained in the BOM?

If the operation scrap is maintained only in the routing, the costing lot
size is reduced by this percentage.

If the operation scrap is maintained in the BOM, the planned input (not
the output quantity) is increased and any assembly scrap is reduced.
What is the meaning of additive costs in SAP and why is it required?

Additive costs are used to add costs manually to a material cost estimate
when it cannot be calculated by the system. Examples of such costs are
freight charges, insurance costs and stock transfer costs.


What is the configuration required for additive costs?

To include additive costs in the material cost estimate you need to set the
indicator “Incl. additive costs” for each valuation strategy in the valuation
variant.
Further you also need to set in the costing variant to include additive
costs.



How do you configure split valuation?

The configuration steps involved in split valuation:-
   1) Activate split valuation – Configure whether split valuation is
      allowed for the company code.
   2) Determine the valuation categories and valuation types that are
      allowed for all valuation areas.
   3) Allocate the valuation types to the valuation categories
   4) Determine the local valuation categories for each valuation area
      and activate the categories to be used in your valuation area.


What is valuation category and valuation type in split valuation?

In split valuation the material stock is divided according to valuation
category and valuation type.

Valuation category determines how the partial stocks are divided
according to which criteria. The following valuation categories are preset
in the standard SAP R/3 system –

B - Procurement type
H – Origin type
X – Automatic batch valuation

Valuation type describes the characteristic of individual stock.
e.g. EIGEN Inhouse production (SAP standard)
     FREMD External procurement (SAP standard)
Valuation types are assigned to valuation categories.


What are the steps involved before you run a cost estimate for a
split valuated material?

The following are the steps:-
   1) Create procurement alternatives based on the valuation types for
      the material.
   2) Maintain Mixing ratios for the procurement alternatives



How do you create a material master with split valuation?

To create a split valuated material master proceed as follows:-

   1. First create a valuation header record for the material. Update the
      Valuation category field on the accounting screen; leave the
      Valuation type field blank. In the Price control field, enter V
      (moving average price). When you save, the system creates the
      valuation header record.



   2. Then create the material for a valuation type.

      Call up the same material in creation mode again. Due to the fact
      that a valuation header record exists, the system requires you to
      enter a valuation type for the valuation category.

    3. Repeat Step two for every valuation type planned.



When a standard cost estimate is run for a finished good does SAP
calculate cost estimate for its components such as raw and packing
material?

Yes. SAP calculates the cost estimate even for raw and packing material
and stores it in the standard price field for information purposes
How do you prevent the system from calculating the cost estimate
for raw and packing material when you run a standard cost estimate
for the finished goods?

To prevent the system from calculating cost estimates for raw and
packing material, you need to select the “No costing” checkbox in the
costing view of the material master.


How is it possible to apply 2 different overhead rates for 2 different
finished goods?

It is possible through overhead groups. You configure 2 overhead keys.
Define rates for each of this overhead key. These two overhead keys is
then assigned to the two overhead groups. These overhead groups are
attached in the costing view of the finished goods material master.
Work in Progress

In period 1 there is a WIP posted of 22000 USD in period 2 some
further goods issue are done to the extent of 15000 USD . How will
system calculate WIP for period 2?

System will post a delta WIP of 15000 USD in period 2.


What is the basic difference in WIP calculation in product cost by
order and product cost by period (repetitive manufacturing)?

Generally in product cost by order, WIP is calculated at actual costs and
in product cost by period WIP is calculated at target costs


What are the configuration settings for calculating WIP in SAP?

You define secondary cost elements of type 31 first.

You then need to define the Results Analysis version

This results analysis contains line ids which are basically nothing but
break up of costs

Next you define assignments-> here you assign source cost elements to
the line ids defined above

You also define the secondary cost elements which are assigned to the
line ids.

In the end you define the Finance GL accounts which are debited and
credited when a Work in Progress is calculated.

Please refer to the configuration document for more detailed information


How does SAP calculate Work in Process (WIP) in product cost by
order?

The system first runs through all the production order for the month and
checks for the status of each production order. If the status of the
production order is REL (Released) or PREL (Partially released) and if
costs are incurred for that order system calculates WIP for the
production order.
The system cancels the WIP for the production order when the status of
the order becomes DLV (delivered) or TECO (Technically complete).


There is a production order with order quantity 1000 kgs. During
the month 500 kgs of goods were produced. What will be the system
treatment at the month end?

The system will first check the status of the production order. Since the
status of the order is not DLV (Delivered) it will calculate a WIP for the
production                                                          order.



Why does the system not calculate variance for the 500 kgs which
has been delivered?

In the product cost by order component the system does not calculate a
variance for partially delivered stock on the production order. Whatever
is the balance on the production order is considered as WIP. In the
product cost by period component, system will calculate WIP as well as
variance provided


Is the WIP calculated in the product cost by order component at
actual costs or standard costs?

In the product cost by order component the WIP is calculated at actual
costs.



Is the WIP calculated in the product cost by period component at
actual costs or target costs?

In the product cost by period component the WIP is calculated at target
costs.
Material Ledger

What precautions have to be taken while switching on the material
ledger for a plant?

A material ledger once activated for a plant cannot be switched off.
Therefore it is important that the material ledger be activated carefully
for a plant.


How do you go about configuring material ledger?


The following are the steps:-

   1) Activate Valuation Areas for Material Ledger

   2) Assign Currency Types to Material Ledger Type

   3) Assign Material Ledger Types to Valuation Area

   4) Maintain Number Ranges for Material Ledger Documents

   5) Activate Actual costing (whether activity update relevant for price
      determination)

   6) Activate Actual cost component split

   7) Customizing settings in OBYC



What are the problems faced when a material ledger is activated?


When a material ledger is activated it is imperative that actual costing
run has to be done every month. Actual costing run needs to be done
immediately after the new month roll over. After the actual costing run
you cannot post any MM(Materials Management) entry to the previous
period.
What are the options available while performing revaluation in an
actual costing run?

There are 2 options available:-

Revaluation – You can revalue the finished goods stock
Accrual – You can accrue the revaluation gain or loss without actually
changing the price in the material master.



What is the configuration setting to be done for posting the accrual
in the actual costing run?

In transaction code OBYC select transaction key LKW and maintain the
balance sheet account for accrual.



What are the steps to be taken before you execute an actual costing
run?

The following are the steps to be taken:

         1.) Execute all the allocation cycles in the cost center
             accounting module.
         2.) Execute actual activity price calculation.
         3.) Revalue all the production orders with the actual activity
             prices. The under or over absorbed cost on cost centers are
             passed on to the production order through this step of
             revaluation of production orders.
         4.) Calculate overheads, do a variance calculation and finally
             settle the production order.
         5.) Finally execute the actual costing run.




What happens in an actual costing run?

In actual costing run there is a process of single level price determination
and multi level price determination. The production price difference
variances are collected on the material ledger for each of the finished
goods and semi finished goods.
During single level price determination the price difference collected on a
single finished product is allocated to consumption. This allocation to the
consumption is not individually allocated to the good issues.

In multi level price determination the price difference is allocated to
individual goods issue. The price differences are passed on to the next
level of consumption.

The system calculates a weighted average price for the finished goods
and semi finished goods. This weighted average price is called as the
periodic unit price


What happens when the revaluation is done in actual costing run for
the previous period?

When revaluation is performed in actual costing for the previous period
the price control in the material master is changed from S to V and the
periodic price is updated as the valuation price for the previous period.


What is the importance of the price determination indicator in the
material master for the purpose of actual costing run?

There are 2 price determination indicators in the material master when
material ledger is activated.

They are as follows:-
2 – transaction based
3 – Single level / multi level

In case of material masters having price determination indicator 2 no
actual costing will take place. In case of material masters having price
determination indicator 3 actual costing will take place.


What should be the price control for a material master which has a
price determination indicator 3 where material ledger is activated?

In such a case only price control S is possible where the price
determination 3 is activated in material master.
Profitability Analysis

Explain the organizational assignment in the PA module?

The operating Concern is the highest node in Profitability Analysis.

The operating concern is assigned to the Controlling Area.

Within the operating concern all the transactions of Profitability Analysis
are stored.

The operating concern is nothing but a nomenclature for defining the
highest node in PA.


What is the functionality of the PA module?

PA module is the most important module when it comes to analyzing the
results of the organization.

In this module you basically collect the revenues from the sale order , the
costs from the production order, cost center or internal order and
analyze their results.

The interesting part about this module is that when it collects the costs
and revenues it also collects the characteristics associated with the costs
and revenues and this is what makes it stand out

So for e.g. using PA module you can find out the following:

Profit of a certain product
Profit of a certain product in a certain region
Profit of a certain product in a certain region by a certain customer
Profit of a certain product in a certain region by a certain sales person
And the list can go on in depth

It is one of the most wonderful modules in the SAP



How do you get all those characteristics defined above and how do
you analyze them?
To do so while defining Operating concern one has to define
Characteristics and Value fields.


What are characteristics and Value Fields?

In the operating concern two things are basically defined

   a) Characteristics
   b) Value Fields

Characteristics are nothing but those aspects on which we want to break
down the profit logically such as customer, region product, product
hierarchy, sales person etc

Value Fields are nothing but the values associated with these
characteristics
Eg Sales, Raw Material Cost, Labour Cost, Overheads etc

Once you define the characteristics and value fields these values are
updated in the table.


From where does the characteristics come from?

The characteristics which are defined above basically comes from either
the Customer Master or the Material Master.




How does various values( revenues and costs) flow into PA?

The Sales Revenue comes from the Condition Type in SD.

We need to map the Condition Type in SD to the respective value fields in
customizing to have the revenue flow into PA.

The Cost comes from Cost estimates which are transferred using the PA
transfer structure which we have covered in the Product costing section.

The various cost components of the cost component structure is assigned
to the value field of PA module and this is how the costs come into PA.

Once the actual revenue and the std cost defined above are captured in
PA the variances are also transferred into PA.
This way the std cost variances equal the actual cost.

So actual revenue- actual cost helps us determine the profit.



How do you configure the assignment of variances from product
costing to COPA module?

The variance categories from product costing along with cost element is
to be assigned to the value fields in COPA


Once you have captured all the costs and revenues how do you
analyze them?

The costs and revenues which we have captured in the above manner are
then analysed by writing reports using the Report Painter Functionality
in SAP.



What is characteristic Derivation in Profitability Analysis Module?

Characteristic Derivation is usually used when you want to derive the
characteristics . An example of this could be say you want to derive the
first two characteristics of product hierarchy.

In such cases you define characteristic derivation where you maintain
the rules, which contain the table names of the product hierarchy fields
and the number of characters to be extracted, and it also specifies the
target characteristic field in PA.



What is the basic difference in customizing in Profitability analysis
as compared to other modules?

In PA when we configure the system i.e. creating operating concern,
maintain structures no customizing request is generated. The
configuration needs to be transported through a different transaction
called as KE3I.
What is the difference between Account based Profitability Analysis
and Costing based Profitability Analysis?

Account based Profitability analysis is a form of Profitability analysis (PA)
that uses accounts as its base and has an account based approach. It
uses costs and revenue elements.

Costing based Profitability Analysis is a form of profitability analysis that
groups costs and revenues according to value fields and costing based
valuation approaches. The cost and revenues are shown in value fields.


What are the advantages and disadvantages of Account based
profitability analysis vis-à-vis costing based profitability analysis?

The advantage of Account based PA is that it is permanently reconciled
with Financial accounting.

The disadvantages are that it is not powerful as the costing based PA,
since it uses accounts to get values. No Contribution margin planning
can be done since it cannot access the standard cost estimate. Further
no variance analysis is readily available.


The advantages of the Costing based PA are manifold. They are as
follows: -
    • Greater Reporting capabilities since lot of characteristics are
      available for analysis.
    • This form of PA accesses the Standard cost estimate of the
      manufactured product and gives a split according to the cost
      component split (from the product costing module) when the bills
      are posted.
    • Contribution margin can be planned in this module since the
      system automatically accesses the standard cost estimate of the
      product based on the valuation approaches.
    • Variance analysis is ready available here since the variance
      categories can be individually mapped to the value fields.

Disadvantages:-
Since it uses a costing based approach, it does not sometime reconcile
with financial accounting.
Can both Account based and Costing based Profitability analysis be
configured at the same time?

Yes. It is possible to configure both types of costing based profitability
analysis at the same time.


What is the advantage of configuring both the type of Profitability
analysis together?

The advantage of activating account based profitability analysis along
with costing based PA is that you can easily reconcile costing based
profitability analysis to account based profitability analysis, which means
indirectly reconciling with Financial accounting.


Is there any additional configuration required for Account based
profitability analysis as compared to costing based profitability
analysis?

No. There are no special configurations required except for activating the
account based profitability analysis while maintaining the operating
concern.


What is the difference between Profitability analysis and Profit
center accounting?

Profitability analysis lets you analyze the profitability of segments of your
market according to products, customers, regions, division. It provides
your sales, marketing, planning and management organizations with
decision support from a market oriented view point.

Profit center accounting lets you analyze profit and loss for profit centers.
It makes it possible to evaluate different areas or units within your
company. Profit center can be structured according to region, plants,
functions or products (product ranges).


What configuration settings are available to set up valuation using
material cost estimate in costing based profitability analysis?

In Costing based Profitability analysis you define costing keys. A costing
key is a set of access parameters which are used in valuation to
determine which data in Product cost planning should be read. In the
costing key you attach the costing variant.
In the costing key you specify whether the system should read the
current standard cost estimate, the previous standard cost estimate or
the future standard cost estimate or a saved cost estimate.
The configuration settings to determine this costing key is as follows:-
   1) Assign costing keys to the products – Three costing keys can be
      attached to a single product for a specific point of valuation, record
      type, plan version.
   2) Assign costing keys to Material types
   3) Assign costing keys to any characteristics – You can use your own
      strategy to determine the costing keys. This is through user
      defined assignment tables.
Profit Center

What is the basic purpose of creating a Profit Center?

The basic purpose of creating a Profit Center is to analyse the revenues
and costs for a particular product line, or a plant or a business unit.
Though you can generate balance sheets and profit and loss accounts
per Profit Center still a profit center should basically be used as a tool
only for internal reporting purposes.

If legally one has to produce the Balance sheets and Profit and Loss
Accounts for a profit center then it is advisable to create it as a company
code instead of a profit center



How does the cost and revenue flow to the Profit Center?

The profit center is stored in the cost center this way the costs flow to the
profit center.

The profit center is also stored in material master. This way all sales
orders created for the finished product automatically picks up the profit
center from the material master and all the revenues and costs coming
from this sales order for that finished product is passed on to this profit
center.

A profit center document is created in addition to the Finance document
whenever revenue or consumption takes place. This document contains
the details of the profit center.

Once both the costs and revenues flow to the profit center you can write
reports using the Report Painter to get intelligent analysis. You can also
use SAP standard reports

Statistical key figures are created in the cost center accounting
module. Now the same statistical key figures are required in the
profit center accounting module. Is it required to maintain the
statistical key figure in PCA module?

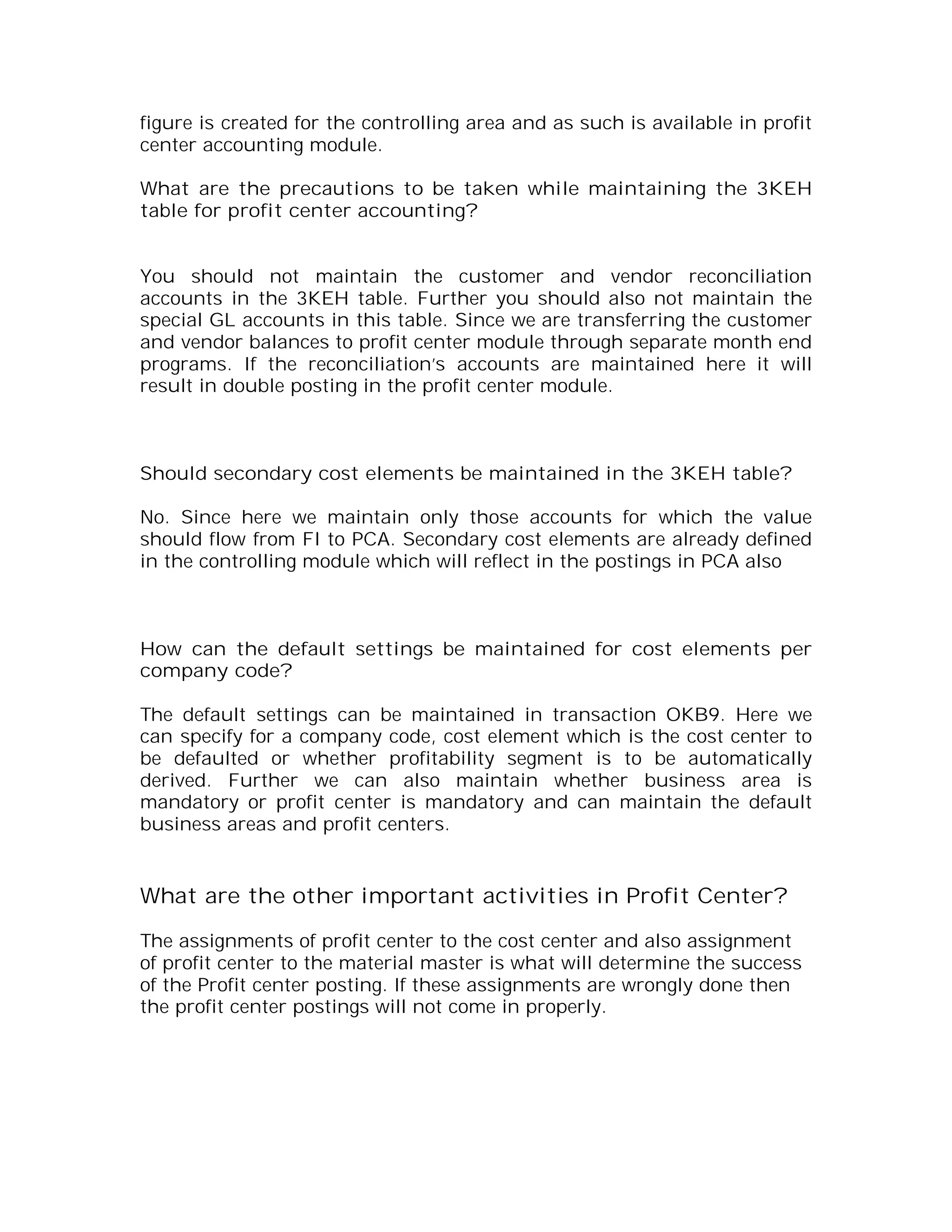

No. Since the statistical key figures are created in a controlling area.
Profit center is a sub module within controlling area. The statistical key
figure is created for the controlling area and as such is available in profit
center accounting module.

What are the precautions to be taken while maintaining the 3KEH
table for profit center accounting?


You should not maintain the customer and vendor reconciliation
accounts in the 3KEH table. Further you should also not maintain the
special GL accounts in this table. Since we are transferring the customer
and vendor balances to profit center module through separate month end
programs. If the reconciliation’s accounts are maintained here it will
result in double posting in the profit center module.



Should secondary cost elements be maintained in the 3KEH table?

No. Since here we maintain only those accounts for which the value
should flow from FI to PCA. Secondary cost elements are already defined
in the controlling module which will reflect in the postings in PCA also



How can the default settings be maintained for cost elements per
company code?

The default settings can be maintained in transaction OKB9. Here we
can specify for a company code, cost element which is the cost center to
be defaulted or whether profitability segment is to be automatically
derived. Further we can also maintain whether business area is
mandatory or profit center is mandatory and can maintain the default
business areas and profit centers.


What are the other important activities in Profit Center?

The assignments of profit center to the cost center and also assignment
of profit center to the material master is what will determine the success
of the Profit center posting. If these assignments are wrongly done then
the profit center postings will not come in properly.
Period End Closing Activities in
Controlling:

What are the period end closing activities in controlling ?

The following are the period end closing activities in Controlling:

Repost CO Documents that was incorrectly posted

Run Distribution or Assessment Cycles

Run the Overhead Calculation in Product Costing

Run the WIP Calculation in Product Costing

Run the Variance Calculation in Product Costing

Run the Settlement Calculation in Product Costing which will post all the
WIP and variance to Finance and PA.

Calculate FI Data for Transfer to Profit Center

Transfer Balance Sheet Items like Recievables, Payables, Assets and
Stock

Run Results Analysis for Sales Order if applicable

Run Settlement of Sales Orders to PA.
Fico interview questions and answers

Fico interview questions and answers

  • 1.
    SAP FICO INTERVIEWQUESTIONS & ANSWERS How to Clear Each and Every Interview You Give- 100 % Success Assured. Published by a Team of SAP Consultants at SAPTOPJOBS Visit us at www.sap-topjobs.com Copyright 2005@SAPTOPJOBS All rights reserved. No part of this publication may be reproduced, stored in a retrieval system, or transmitted in any form, or by any means electronic or mechanical including photocopying, recording or any information storage and retrieval system without permission in writing from SAPTOPJOBS.
  • 3.
    Enterprise Structure What isa Company Code and what are the basic organizational assignments to a company code? Company Code is a legal entity for which financial statements like Profit and Loss and Balance Sheets are generated. Plants are assigned to the company code, Purchasing organization is assigned to the company code, and Sales organization is assigned to the company code. What is the relation between a Controlling Area and a Company code? A Controlling area can have the following 2 type of relationship with a Company code a. Single Company code relation b. Cross Company code relation This means that one single controlling area can be assigned to several different company codes. Controlling can have a one is to one relationship or a one is to many relationship with different company codes. Controlling Area is the umbrella under which all controlling activities of Cost Center Accounting, Product Costing, Profit Center and Profitability Analysis are stored. In a similar way Company Codes is the umbrella for Finance activities. How many Chart of Accounts can a Company code have? A single Company code can have only one Chart of Account assigned to it. The Chart of Accounts is nothing but the list of General Ledger Accounts. What are the options in SAP when it comes to Fiscal years? Fiscal year is nothing but the way financial data is stored in the system. SAP provides you with the combination of 12 normal periods and also
  • 4.
    four special periods.These periods are stored in what is called the fiscal year variant. There are two types of Fiscal Year Variant • Calendar Year – e.g. Jan-Dec • Year Dependent Fiscal Year . What is a year dependent fiscal year variant ? In a year dependent fiscal year variant the number of days in a month are not as per the calendar month. Let us take an example:- For the year 2005 the period January ends on 29th, Feb ends on 27th, March ends on 29. For the year 2006 January ends on 30th, Feb ends on 26th, March ends on 30th. This is applicable to many countries especially USA. Ever year this fiscal year variant needs to be configured in such a case How does posting happen in MM (Materials Management) during special periods? There is no posting which happens from MM in special periods. Special periods are only applicable for the FI module. They are required for making any additional posting such as closing entries, provisions. which happen during quarter end or year end. How many currencies can be configured for a company code? A company code can have 3 currencies in total. They are local currency ie company code currency) and 2 parallel currencies. This gives the company the flexibility to report in the different currencies. Do you require to configure additional ledger for parallel currencies? Where only 2 currencies are configured (Company code currency and a parallel currency) there is no need for an additional ledger. In case the third parallel currency is also configured and if it is different than the second currency type, you would then need to configure additional ledger.
  • 5.
    If there aretwo company codes with different chart of accounts how can you consolidate their activities? In this case you either need to write an ABAP program or you need to implement the Special Consolidation Module of SAP. If both the company codes use the same chart of accounts then standard SAP reports give you the consolidated figure.
  • 6.
    FI-GL Give some examplesof GL accounts that should be posted automatically through the system and how is this defined in the system. Stock and Consumption accounts are instances of GL accounts that should be automatically posted . In the GL account master record, a check box exists wherein the automatic posting option is selected called “ Post Automatically Only” What is a Account group and where is it used? An Account group controls the data that needs to be entered at the time of creation of a master record. Account groups exist for the definition of a GL account, Vendor and Customer master. It basically controls the fields which pop up during master data creation in SAP. What is a field status group? Field status groups control the fields which come up when the user does the transactions. There are three options for field selection. They are: Display only Suppressed Mandatory So basically you can have any field either for display only or you can totally suppress it or make it mandatory. The field status group is stored in the FI GL Master Record. What is the purpose of a “Document type” in SAP? A Document type is specified at the Header level during transaction entry and serves the following purposes:
  • 7.
    It defines the Number range for documents • It controls the type of accounts that can be posted to eg Assets, Vendor, Customer, Normal GL account • Document type to be used for reversal of entries • Whether it can be used only for Batch input sessions Document Type is created for differentiating business transactions. Eg Vendor Invoice, Credit Memo, Accrual Entries,Customer Invoice. It is a two digit character. What is a Financial Statement Version? A FSV (Financial Statement Version) is a reporting tool and can be used to depict the manner in which the financial accounts like Profit and Loss Account and Balance Sheet needs to be extracted from SAP. It is freely definable and multiple FSV's can be defined for generating the output for various external agencies like Banks and other Statutory authorities. How are input and output taxes taken care of in SAP? A tax procedure is defined for each country and tax codes are defined within this. There is flexibility to either expense out the Tax amounts or Capitalize the same to Stocks. What are Validations and Substitutions? Validations/Substitutions in SAP are defined for each functional area e.g. FI-GL, Assets, Controlling etc at the following levels 1. Document level 2. Line item level These need to be specifically activated and setting them up are complex and done only when it is really needed. Often help of the technical team is taken to do that.
  • 8.
    Is it possibleto maintain plant wise different GL codes? Yes. To be able to do so the valuation group code should be activated. The valuation grouping code is maintained per plant and is configured in the MM module. Account codes should be maintained per valuation grouping code after doing this configuration. Is Business area at company code Level? No. Business area is at client level. What this means is that other company codes can also post to the same business area. What are the different scenarios under which a Business Area or a Profit Center may be defined? This question is usually very disputable. But both Business Areas and Profit centers are created for internal reporting. Each has its own pros and cons but many companies nowadays go for Profit center as there is a feeling that business area enhancements would not be supported by SAP in future versions. There are typical month end procedures which need to be executed for both of them and many times reconciliation might become a big issue. A typical challenge in both of them is in cases where you do not know the Business Area or Profit Center of the transaction at the time of posting. What are the problems faced when a Business area is configured? The problem of splitting of account balance is more pertinent in case of tax accounts. Is it possible to default certain values for particular fields? For e.g. company code. Yes it is possible to default values for certain fields where a parameter id is present. Step 1 Go to the input field to which you want to make defaults.
  • 9.
    Step 2 PressF1, then click technical info push button. This would open a window that displays the corresponding parameter id (if one has been allocated to the field) in the field data section. Step 3 Enter this parameter id using the following path on SAP Easy access screen System à User profile à Own data. Step 4 Click on parameter tab. Enter the parameter id code and enter the value you want as default. Save the usersettings. Which is the default exchange rate type which is picked up for all SAP transactions? The default exchange rate type picked up for all SAP transactions is M (average rate) Is it possible to configure the system to pick up a different exchange rate type for a particular transaction? Yes it is possible. In the document type definition of GL, you need to attach a different exchange rate type. What are the master data pre-requisites for document clearing? The Gl Account must be managed as an ‘open item management’ . This checkbox is there in the General Ledger Master Record called Open Item Management. It helps you to manage your accounts in terms of cleared and uncleared items. A typical example would be GR/IR Account in SAP (Goods Received/Invoice Received Account) Explain the importance of the GR/IR clearing account. GR/IR is an interim account. In the legacy system of a client if the goods are received and the invoice is not received the provision is made for the same. In SAP at the Goods receipt stage the system passes an accounting entry debiting the Inventory and crediting the GR/IR Account .Subsequently when an invoice is recd this GR/IR account is debited and the Vendor
  • 10.
    account is credited.That way till the time that the invoice is not received the GR/IR is shown as uncleared items. How many numbers of line items in one single entry you can have? The number of line items in one document you can accommodate is 999 lines. A Finance Document usually has an assignment field. This field automatically gets populated during data entry. Where does it get its value? This value comes from the Sort key entered in the Gl master record. How do you maintain the number range in Production environment? Do you directly create it in the Production box or do you do it by means of transport? Number range is to be created in the production client. You can transport it also by way of request but creating in the production client is more advisable. In customizing “company code productive “means what? What does it denote? Once the company code is live(real time transactions have started) this check box helps prevents deletion of many programs accidentally. This check box is activated just before go live. What is done by GR/IR regrouping program? The balance in a GR/IR account is basically because of 2 main types of transactions:- Goods delivered but invoice not received – Here the Goods receipt is made but no invoice has yet been received from the vendor. In such a scenario GR/IR account will have a credit balance.
  • 11.
    Invoiced received butgoods not delivered – Here the Invoice is received from the vendor and accounted for, but goods have not been received. In such a scenario GR/IR account will have a debit balance. The GR/IR account would contain the net value of the above two types of transactions. The GR/IR regrouping program analyses the above transactions and regroups them to the correct adjustment account. The balance on account of first transactions will be regrouped to another liability account and the balance on account of second transactions will be regrouped to an asset account. What are the functionalities available in the financial statement version? In the financial statement version the most important functionality available is the debit credit shift. This is more important in case of Bank overdraft accounts which can have a debit balance or a credit balance. Thus in case of a debit balance you would require the overdraft account to be shown on the Asset side. In case of credit balance you would require the account to be shown on the Liability side. Is it possible to print the financial statement version on a SAPscript form? Yes. It is possible to print the financial statement version on a SAPscript form. How do you configure the SAPscript form financial statement version? It is possible to generate a form from the financial statement version and print the financial statements on a SAPscript form. In the customizing for financial statement version select the FSV you created and choose Goto à Generate form à One column or Two column form. You can also copy form from the standard system. Is it possible to generate a financial statement form automatically? Yes. It is possible to generate a form automatically.
  • 12.
    Is it possibleto keep the FI posting period open only for certain GL codes? Yes. It is possible to keep open the FI posting period only for certain GL codes. How do you keep the FI posting period open only for certain GL codes? In transaction code OB52 click on new entries and maintain an interval or a single GL code for the account type S with the posting period variant. If the GL codes are not in sequence then you need to maintain further entries for the posting period variant and account type S. Can posting period variant be assigned to more than 1 company code? Yes. Posting period variant can be assigned to more than one company code.
  • 13.
    Accounts Receivable andAccounts Payable At what level are the customer and vendor codes stored in SAP? The customer and vendor code are at the client level. That means any company code can use the customer and vendor code by extending the company code view. How are Vendor Invoice payments made? Vendor payments can be made in the following manner: Manual payments without the use of any output medium like cheques etc. Automatic Payment program through cheques, Wire transfers, DME etc. How do you configure the automatic payment program? The following are the steps for configuring the automatic payment program:- Step 1 Set up the following: Co. code for Payment transaction Define sending and paying company code. Tolerance days for payable Minimum % for cash discount Maximum cash discount Special GL transactions to be paid Step 2 Set up the following: Paying company code for payment transaction Minimum amount for outgoing payment No exchange rate diff Separate payment for each ref Bill/exch payment
  • 14.
    Form for paymentadvice Step 3 Set up the following: Payment method per country Whether Outgoing payment Check or bank transfer or B/E Whether allowed for personnel payment Required master data Doc types Payment medium programs Currencies allowed Step 4 Set up the following: Payment method per company code for payment transactions Set up per payment method and co. code The minimum and maximum amount. Whether payment per due day Bank optimization by bank group or by postal code or no optimization Whether Foreign currency allowed Customer/Vendor bank abroad allowed Attach the payment form check Whether payment advice required Step 5 Set up the following: Bank Determination for Payment Transactions Rank the house banks as per the following Payment method, currency and give them ranking nos Set up house bank sub account (GL code) Available amounts for each bank House bank, account id, currency, available amount Value date specification Where do you attach the check payment form? It is attached to the payment method per company code. Where are Payment terms for customer master maintained?
  • 15.
    Payment terms forcustomer master can be maintained at two places i.e. in the accounting view and the sales view of the vendor master record. Which is the payment term which actually gets defaulted when the transaction is posted for the customer (accounting view or the sales view)? The payment term in the accounting view of the customer master comes into picture if the transaction originates from the FI module. If an FI invoice is posted (FB70) to the customer, then the payment terms is defaulted from the accounting view of the customer master. The payment term in the sales view of the customer master comes into picture if the transaction originates from the SD module. A sales order is created in the SD module. The payment terms are defaulted in the sales order from the sales view of the customer master. Where are Payment terms for vendor master maintained? Payment terms for Vendor master can be maintained at two places i.e. in the accounting view and the purchasing view. Which is the payment term which actually gets defaulted in transaction (accounting view or purchasing view)? The payment term in the accounting view of the vendor master comes into picture if the transaction originates from the FI module. If an FI invoice is posted (FB60) to the Vendor, then the payment terms is defaulted from the accounting view of the vendor master. The payment term in the purchasing view of the vendor master comes into picture if the transaction originates from the MM module. A purchase order is created in the MM module. The payment terms are defaulted in the purchase order from the purchasing view of the vendor master. Explain the entire process of Invoice verification from GR to Invoice verification in SAP with accounting entries?
  • 16.
    These are thefollowing steps: A goods receipt in SAP for a purchased material is prepared referring a purchase order. When the goods receipt is posted in SAP the accounting entry passed is:- Inventory account Debit GR/IR account credit A GR/IR (which is Goods receipt/Invoice receipt) is a provision account which provides for the liability for the purchase. The rates for the valuation of the material are picked up from the purchase order. When the invoice is booked in the system through Logistics invoice verification the entry passed is as follows:- GR/IR account debit Vendor credit How are Tolerances for Invoice verification defined? The following are instances of tolerances that can be defined for Logistic Invoice Verification. c. Small Differences d. Moving Average Price variances e. Quantity variances f. Price variances Based on the client requirement, the transaction can be “Blocked” or Posted with a “Warning” in the event of the Tolerances being exceeded. Tolerances are nothing but the differences between invoice amount and payment amount or differences between goods receipt amount and invoice amount which is acceptable to the client. Can we change the reconciliation account in the vendor master? Yes. Reconciliation account can be changed in the vendor master provided that the authority to change has been configured. Normally we should not change the reconciliation account.
  • 17.
    What is theimpact on the old balance when the reconciliation account in the vendor master is changed? Any change you make to the reconciliation account is prospective and not retrospective. The old items and balances do not reflect the new account only the new transactions reflect the account. There is an advance given by the customer which lies in a special GL account indicator A. Will this advance amount be considered for credit check? It depends on the configuration setting in the special GL indicator A. If the “Relevant to credit limit” indicator is switched on in the Special GL indicator A the advances will be relevant for credit check, otherwise it will not be relevant. In payment term configuration what are the options available for setting a default baseline date? There are 4 options available:- 1) No default 2) Posting date 3) Document date 4) Entry date What is generally configured in the payment term as a default for baseline date? Generally document date is configured in the payment term as a default for base line date. How do you configure a special GL indicator for Customer? You can use an existing special GL indicator ID or create a new one. After creating a special GL indicator id, update the chart of accounts and the Reconciliation account. Also as a last step you need to update the special GL code.
  • 18.
    The special GLcode should also be marked as a Reconciliation account. Switch on the relevant for credit limit and commitment warning indicators in the master record.
  • 19.
    Bank Accounting: How isBank Reconciliation handled in SAP? The bank reco typically follows the below procedure: First, the payment made to a Vendor is posted to an interim bank clearing account. Subsequently, while performing reconciliation, an entry is posted to the Main Bank account. You can do bank reconciliation either manually or electronically. How do you configure check deposit? The following are the steps for configuring check deposit:- Step1: Create account symbols for the main bank and incoming check account. Step2: Assign accounts to account symbols Step3: Create keys for posting rules Step4: Define posting rules Step5: Create business transactions and assign posting rule Step6: Define variant for check deposit What is the clearing basis for check deposit? In the variant for check deposit we need to set up the following a) fields document number ( which is the invoice number), b) amount c) Short description of the customer. The document number and the invoice amount acts as the clearing basis. How do you configure manual bank statement?
  • 20.
    The following arethe steps for configuring manual bank statement:- Step1: Create account symbols for the main bank and the sub accounts Step2: Assign accounts to account symbols Step3: Create keys for posting rules Step4: Define posting rules Step5: Create business transaction and assign posting rule Step6: Define variant for Manual Bank statement How do you configure Electronic bank statement? The steps for Electronic Bank Statement are the same except for couple of more additional steps which you will see down below Step1: Create account symbols for the main bank and the sub accounts Step2: Assign accounts to account symbols Step3: Create keys for posting rules Step4: Define posting rules Step5: Create transaction type Step6: Assign external transaction type to posting rules Step7: Assign Bank accounts to Transaction types
  • 21.
    Fixed Assets What arethe organizational assignments in asset accounting? Chart of depreciation is the highest node in Asset Accounting and this is assigned to the company code. Under the Chart of depreciation all the depreciation calculations are stored. How do you go about configuring Asset accounting? The configuration steps in brief are as follows:- a) Copy a reference chart of depreciation areas b) Assign Input Tax indicator for non taxable acquisitions c) Assign chart of depreciation area to company code d) Specify account determination e) Define number range interval f) Define asset classes g) Define depreciation areas posting to general ledger h) Define depreciation key Explain the importance of asset classes. Give examples? The asset class is the main criterion for classifying assets. Every asset must be assigned to only one asset class. Examples of asset class are Plant& Machinery, Furniture & Fixtures, Computers etc. The asset class also contains the Gl accounts which are debited when any asset is procured. It also contains the gl accounts for depreciation calculation, scrapping etc Whenever you create an asset master you need to mention the asset class for which you are creating the required asset. In this manner whenever any asset transaction happens the gl accounts attached to the asset class is automatically picked up and the entry passed. You can also specify certain control parameters and default values for depreciation calculation and other master data in each asset class. How are depreciation keys defined?
  • 22.
    The specifications andparameters that the system requires to calculate depreciation amounts are entered in Calculation methods. Calculation methods replace the internal calculation key of the depreciation key. Depreciation keys are defaulted in Asset Master from the asset class. Refer to the configuration for more details of how depreciation is calculated. A company has its books prepared based on Jan –Dec calendar year for reporting to its parent company. It is also required to report accounts to tax authorities based on April- March. Can assets be managed in another depreciation area based on a different fiscal year variant? No. Assets accounting module cannot manage differing fiscal year variant which has a different start date (January for book depreciation and April for tax depreciation) and different end date (December for book depreciation and March for tax depreciation). In this case you need to implement the special purpose ledger. What are the special steps and care to be taken in Fixed asset data migration into SAP system especially when Profit center accounting is active? Data migration is slightly different from a normal transaction which happens in Asset accounting module. Normally, in asset accounting the day to day transactions is posted with values through FI bookings and at the same time the asset reconciliation is updated online realtime. Whereas In data Migration the asset master is updated with values through a transaction code called as AS91. The values updated on the master are Opening Gross value and the accumulated depreciation. The reconciliation GL account is not automatically updated at this point of time. The reconciliation accounts (GL codes) are updated manually through another transaction code called as OASV. If profit center is active, then after uploading assets through AS91 you should transfer the asset balances to profit center accounting through a program.
  • 23.
    Thereafter you removethe Asset GL code (reconciliation accounts) from the 3KEH table for PCA and update the Asset reconciliation account (GL code) through OASV. After this step you again update the Asset reconciliation account in the 3KEH table. The reason you remove the Asset reconciliation code from 3KEH table is that double posting will happen to PCA when you update the Asset reconciliation manually. Is it possible to calculate multiple shift depreciation? Is any special configuration required? Yes it is possible to calculate multiple shift depreciation in SAP for all types of depreciation except unit of production. No special configuration is required. How do you maintain multiple shift depreciation in asset master? The following steps are needed to maintain multiple shift depreciation: 1. The variable depreciation portion as a percentage rate is to be maintained in the detail screen of the depreciation area. 2. The multiple shift factor is to be maintained in the time dependent data in the asset master record. This shift factor is multiplied by the variable portion of ordinary depreciation. Once you have done the above the SAP system calculates the total depreciation amount as follows:- Depreciation amount = Fixed depreciation + (variable depreciation * shift factor) Let’s say you have changed the depreciation rates in one of the depreciation keys due to changes in legal requirements. Does system automatically calculate the planned depreciation as per the new rate? No. System does not automatically calculate the planned depreciation after the change is made. You need to run a program for recalculation of planned depreciation.
  • 24.
    What are evaluationgroups? The evaluation groups are an option for classifying assets for reports or user defined match code (search code). You can configure 5 different evaluation groups. You can update these evaluation groups on to the asset master record. What are group assets? The tax requirements in some countries require calculation of depreciation at a higher group or level of assets. For this purpose you can group assets together into so-called group assets. What are the steps to be taken into account during a depreciation run to ensure that the integration with the general ledger works smoothly? For each depreciation area and company code, specify the following: 1 The frequency of posting depreciation(monthly,quarterly etc) 2 CO account assignment (cost center) 3 For each company code you must define a document type for automatic depreciation posting: This document type requires its own external number range. 4 You also need to specify the accounts for posting. (Account determination) Finally to ensure consistency between Asset Accounting and Financial Accounting, you must process the batch input session created by the posting report. If you fail to process the batch input session, an error message will appear at the next posting run. The depreciation calculation is a month end process which is run in batches and then once the batch input is run the system posts the accounting entries into Finance. How do you change fiscal year in Asset Accounting? n Run The fiscal year change program which would open new annual value fields for each asset. i e next year
  • 25.
    Ÿ The earliestyou can start this program is in the last posting period of the current year. Ÿ You have to run the fiscal year change program for your whole company code. Ÿ You can only process a fiscal year change in a subsequent year if the previous year has already been closed for business. Take care not to confuse the fiscal year change program with year-end closing for accounting purposes. This fiscal year change is needed only in Asset Accounting for various technical reasons. Is it possible to have depreciation calculated to the day? Yes it is possible. You need to switch on the indicator “Dep to the day” in the depreciation key configuration. Is it possible to ensure that no capitalization be posted in the subsequent years? Yes it is possible. You need to set it in the depreciation key configuration. How are Capital Work in Progress and Assets accounted for in SAP? Capital WIP is referred to as Assets under Construction in SAP and are represented by a specific Asset class. Usually depreciation is not charged on Capital WIP. All costs incurred on building a capital asset can be booked to an Internal Order and through the settlement procedure can be posted onto an Asset Under Construction. Subsequently on the actual readiness of the asset for commercial production, the Asset Under Construction gets capitalized to an actual asset. The company has procured 10 cars. You want to create asset masters for each of this car. How do you create 10 asset masters at the same time? While creating asset master there is a field on the initial create screen called as number of similar assets. Update this field with 10. When you finally save this asset master you will get a pop up asking whether you
  • 26.
    want to maintaindifferent texts for these assets. You can update different details for all the 10 cars.
  • 27.
    FI-MM-SD Integration How doyou go about setting the FI MM account determination ? FI MM settings are maintained in transaction code OBYC. Within these there are various transaction keys to be maintained like BSX, WRX, GBB, PRD etc. In each of these transaction keys you specify the GL accounts which gets automatically passed at the time of entry. Few examples could be: BSX- Stands for Inventory Posting Debit GBB-Standsfor Goods Issue/Scrapping/delivery of goods etc PRD- Stands for Price Differences. At what level is the FI-MM, FI-SD account determination settings? They are at the chart of accounts level. What are the additional settings required while maintaining or creating the GL codes for Inventory accounts? In the Inventory GL accounts (Balance sheet) you should switch on the ‘Post automatically only’ tick. It is also advisable to maintain the aforesaid setting for all FI-MM accounts and FI-SD accounts. This helps in preserving the sanctity of those accounts and prevents from having any difference between FI and MM, FI and SD. What is Valuation and Account assignment in SAP? This is actually the link between Materials Management and Finance. The valuation in SAP can be at the plant level or the company code level. If you define valuation at the plant level then you can have different prices for the same material in the various plants. If you keep it at the company code level you can have only price across all plants.
  • 28.
    Valuation also involvesthe Price Control .Each material is assigned to a material type in Materials Management and every material is valuated either in Moving Average Price or Standard Price in SAP. These are the two types of price control available. What is Valuation Class? The Valuation Class in the Accounting 1 View in Material Master is the main link between Material Master and Finance. This Valuation Class along with the combination of the transaction keys (BSX,WRX,GBB,PRD ) defined above determine the GL account during posting. We can group together different materials with similar properties by valuation class. Eg Raw material,Finsihed Goods, Semi Finished We can define the following assignments in customizing : All materials with same material type are assigned to just one valuation class. Different materials with the same material type can be assigned to different valuation classes. Materials with different material types are assigned to a single valuation class. Can we change the valuation class in the material master once it is assigned? Once a material is assigned to a valuation class in the material master record, we can change it only if the stocks for that material are nil. If the stock exists for that material, then we cannot change the valuation class. In such a case, if the stock exists, we have to transfer the stocks or issue the stocks and make the stock nil for the specific valuation class. Then only we will be able to change the valuation class. Does the moving average price change in the material master during issue of the stock assuming that the price control for the material is Moving Average? The moving average price in the case of goods issue remains unchanged. Goods issue are always valuated at the current moving average price. It is only in goods receipt that the moving average price might change. A
  • 29.
    goods issue onlyreduces the total quantity and the total value in relation to the price and the moving price remains unchanged. Also read the next question to learn more about this topic. If the answer to the above question is ‘Yes’, then list the scenario in which the moving average price of the material in the material master changes when the goods are issued. The moving average price in the material master changes in the scenario of Split Valuation which is sometimes used by many organizations. If the material is subject to split valuation, the material is managed as Several partial stocks and each partial stock is valuated separately. In split valuation, the material with valuation header record will have ‘v’ moving average price. This is where the individual stocks of a material are managed cumulatively. Here two valuation types are created, one valuation type can have ‘v’ (MAP) and the other valuation type can have ‘s’(standard price). In this case, whenever the goods are issued from the respective valuation types, always the MAP for the valuation header changes. What is the accounting entry in the Financial books of accounts when the goods are received in unrestricted use stock? Also mention the settings to be done in the ‘Automatic postings’ in SAP for the specific G/L accounts. On receipt of the goods in unrestricted-use stock, the Inventory account is debited and the GR/IR account gets credited. In customization, in the automatic postings, the Inventory G/L account is assigned to the Transaction event key BSX and the GR/IR account is assigned to the Transaction event key WRX. If a material has no material code in SAP, can you default the G/L account in Purchase order or it has to be manually entered?. If a material has no material code in SAP, we can still, default the G/L account with the help of material groups. We can assign the valuation class to a material group and then in FI-automatic posting, we can assign the relevant G/L account in the Transaction event key. The
  • 30.
    assignment of avaluation class to a material group enables the system to determine different G/L accounts for the individual material groups. What is the procedure in SAP for Initial stock uploading? Mention the accounting entries also. Initial stock uploading in SAP from the legacy system is done with inventory movement type 561( a MM transaction which is performed). Material valuated at standard price: For a material valuated at standard price, the initial entry of inventory data is valuated on the basis of standard price in the material master. If you enter an alternative value at the time of the movement type 561, then the system posts the difference to the price difference account. Material valuated at moving average price: The initial entry of inventory data is valuated as follows : If you enter a value when uploading the initial data, the quantity entered is valuated at this price. If you do not enter a value when entering initial data, then the quantity entered is valuated at the MAP present in the material master. The accounting entries are: Inventory account is debited and Inventory Historical upload account is credited. How do you configure FI-SD account determination? The FI-SD account determination happens through an access sequence. The system goes about finding accounts from more specific criteria to less specific criteria. This is the sequence it would follow: 1) It will first access and look for the combination of Customer accounts assignment grp/ Material account assignment grp/ Account key. 2) If it does not find the accounts for the first combination it will look for Customer account assignment grp and account key combination. 3) Furthermore, if it does not find accounts for the first 2 criteria’s then it will look for Material account assignment grp/Account key.
  • 31.
    4) If itdoes not find accounts for the all earlier criteria’s then finally it will look for Account key and assign the GL code. Thus posting of Sales Invoices into FI are effected on the basis of a combination of Sales organization, Account type, or Customer and Material Account assignment groups and following are the options available. a. Customer AAG/Material AAG/Account type b. Material AAG/Account type c. Customer AAG/Account type For each of this option you can define a Gl account. Thus the system uses this gl account to automatically pass the entries.
  • 32.
    Logistics Invoice Verification Canyou assign multiple G/L accounts in the Purchase order for the same line item? Yes, we can assign multiple G/L accounts in the Purchase order for the same line item. The costs can be allocated on a percentage or quantity basis. If the partial goods receipt and partial invoice receipt has already taken place, then the partial invoice amount can be distributed proportionally, i.e. evenly among the account assigned items of a Purchase order. Alternatively the partial invoice amount can be distributed on a progressive fill-up basis, i.e. the invoiced amount is allocated to the individual account assignment items one after the other. What is Credit memo and subsequent debit in Logistics Invoice verification? The term credit memo refers to the credit memo from the vendor. Therefore posting a credit memo always leads to a debit posting on the vendor account. Credit memos are used if the quantity invoiced is higher than the quantity received or if part of the quantity was returned. Accounting entries are : Vendor account is debited and GR/IR account is credited. Subsequent debit : If a transaction has already been invoiced and additional costs are invoiced later, then subsequent debit is necessary. In this case you can debit the material with additional costs, i.e. GR/IR account debit and Vendor account credit. When entering the Subsequent debit, if there is no sufficient stock coverage, only the portion for the available stock gets posted to the stock account and rest is posted to the price difference account. What do you mean by Invoice parking, Invoice saving and Invoice confirmation? Invoice parking : Invoice Parking is a functionality which allows you to create incomplete documents and the system does not check whether the
  • 33.
    entries are balancedor not. An accounting documents is also not created when the invoice is in parked mode. Thus you can create incomplete documents and then post it later to accounting when you feel it is complete. You can even rectify the Parked invoice. This feature is used by many companies as on many occasions all data relating to the invoice might not be available. Invoice saving : This is also called Invoice processing or Invoice posting. The accounting document gets created when the invoice is posted in SAP. Invoice confirmation : There is no terminology in SAP as Invoice confirmation. What are Planned delivery costs and Unplanned delivery costs? Planned delivery costs: are entered at the time of Purchase order. At goods receipt, a provision is posted to the freight or customs clearing account. e.g. FRE is the account key for freight condition, hence the system can post the freight charges to the relevant freight revenue account and FR3 is the account key for Customs duty, hence the system can post the customs duty to the relevant G/L account. These account keys are assigned to the specific condition types in the MM Pricing schema. In terms of Invoice verification : If the freight vendor and the material vendor is the same : then we can choose the option : Goods service items + Planned delivery costs. If the freight vendor is different from the material vendor: then for crediting only the delivery costs, we can choose the option: Planned delivery costs. Unplanned delivery costs: are the costs which are not specified in the Purchase order and are only entered when you enter the invoice.
  • 34.
    What is thebasis on which the apportionment is done of unplanned delivery costs? Unplanned delivery costs are either uniformly distributed among the items or posted to a separate G/L account. For a material subjected to Moving average price, the unplanned delivery costs are posted to the stock account, provided sufficient stock coverage exists. For a material subjected to Standard price, the unplanned delivery costs are posted to the Price difference account. There are cases where Invoice verification is done first before the Goods receipt is made for the purchase order . In these cases with what values would the Goods receipt be posted ? Since the invoice verification has been done first the Goods Receipts will be valued with the Invoice value.
  • 35.
    FI Month EndClosing Activities What are the Month End Closing Activities in Finance? 1. Recurring Documents. a) Create Recurring documents b) Create Batch Input for Posting Recurring Documents c) Run the Batch Input Session 2. Posting Accruals or Provisions entries at month end 3. Managing the GR/IR Account-Run the GR/Ir Automatic Clearing 4. Foreign Currency Open Item Revaluation-Revalue Open Items in AR.AP 5. Maintain Exchange Rates 6. Run Balance Sheets –Run Financial Statement Version 7. Reclassify Payables and Receivables if necessary 8. Run the Depreciation Calculation 9. Fiscal Year Change of Asset Accounting if it is year end 10. Run the Bank Reconciliation 11. Open Next Accounting Period
  • 36.
    Controlling Module Explain theorganizational assignment in the controlling module? Company codes are assigned to the controlling area. A controlling area is assigned to the operating concern. Controlling Area is the umbrella under which all controlling activities of Cost Center Accounting, Product costing, Profitability Analysis and Profit Center are stored. Operating Concern is the highest node in Profitability Analysis What is primary Cost element and secondary cost element? Every Profit and Loss GL account that needs to be controlled has to be defined as a cost element in SAP. Just as in FI General Ledger Accounts exist, in Controlling we have Cost element. Each FI General Ledger Account that is a Profit and Loss Account is also created as a Cost element in SAP. Primary Cost Elements are those which are created from FI general Ledger Accounts and impact the financial accounts eg. Travelling expenses, consumption account infact, any Profit and Loss GL account Secondary Cost Elements are those which are created only in controlling and does not affect the financials of the company. It is used for internal reporting only. The postings to these accounts do not affect the Profit or Loss of the company. The following categories exist for secondary cost elements: 21 Internal Settlement: Cost elements of this category is used to settle order costs to objects in controlling such as cost centers, pa segments etc. 31 Order/Results Analysis: Used to calculate WIP on the order/project
  • 37.
    41 Overhead Used tocalculate indirect costs from cost centers to orders 42. Assessment Used to calculate costs during assessment 43 Internal Activity Allocation Used to allocate costs during internal activity allocation such as Machine Labour etc What are cost objects? A cost object means a cost or a revenue collector wherein all the costs or revenues are collected for a particular cost object. Examples of this could be cost center, production order, internal order, projects, sales order So whenever you look at any controlling function the basic thing you need to ask yourself is What is the cost element(expense) I want to control and what is the cost object ( i.e. either the production order, sales order, internal order) I am using to control this cost element. Sounds confusing read it again it is very simple Controlling is all about knowing the cost element and the cost object. Every time pose this question to yourself what is the cost element what is the cost object. At the end of the period all costs or revenues in the cost object are settled to their respective receivers which could be a gl account, a cost center, profitability analysis or asset. It is very important that you understand this otherwise you would struggle to understand Controlling.
  • 38.
    Cost Center Accounting: Howis cost center accounting related to profit center? In the master data of the Cost Center there is a provision to enter the profit center. This way all costs which flow to the cost center are also captured in the profit center. Cost centers are basically created to capture costs e.g. admin cost center, canteen cost center etc Profit centers are created to capture cost and revenue for a particular plant, business unit or product line. What is a cost element group? Cost element group is nothing but a group of cost elements which help one to track and control cost more effectively. You can make as many number of cost element groups as you feel necessary by combining various logical cost elements. What is a cost center group? In a similar line the cost center group is also a group of cost centers which help one to track and control the cost of a department more effectively. You can make as many number of cost centers as you feel necessary by combining various logical cost centers Infact you can use various combinations of cost center group with the cost element group to track and control your costs per department or across departments What is the difference between Distribution and Assessment? Distribution uses the original cost element for allocating cost to the sender cost center. Thus on the receiving cost center we can see the original cost element from the sender cost center. Distribution only allocates primary cost. Assessment uses assessment cost element No 43 defined above to allocate cost. Thus various costs are summarized under a single
  • 39.
    assessment cost element.In receiver cost center the original cost breakup from sender is not available. Assessment allocates both primary as well as secondary cost. What are the other activities in Cost center? If you have a manufacturing set up, entering of Activity prices per cost center/activity type is an important exercise undertaken in Cost center accounting. What is an Activity Type? Activity types classify the activities produced in the cost centers. Examples of Activity Type could be Machine, Labour, Utilities You want to calculate the activity price through system? What are the requirements for that? In the activity type master you need to select price indicator 1 – Plan price, automatically based on activity. When activity price is calculated through system whether activity price is shown as fixed or variable? Normally when activity price is calculated through system it is shown as fixed activity price since primary cost are planned as activity independent costs. What is required to be done if activity price is to be shown both fixed and variable? In this case you need to plan both activity independent cost which are shown as fixed costs and activity dependent costs which are shown as variable costs. Is it possible to calculate the planned activity output through system?
  • 40.
    Yes. It ispossible to calculate the planned activity output through system by using Long term Planning process in PP module. Explain the process of calculating the planned activity output through Long term planning? In Long term planning process the planned production quantities are entered for the planning year in a particular scenario. The Long term planning is executed for the scenario. This generates the planned activity requirements taking the activity quantities from the routing and multiplying with the planned production. The activity requirements are then transferred to the controlling module as scheduled activity quantities. Thereafter you execute a plan activity reconciliation which will reconcile the schedule activity and the activity you have planned manually. The reconciliation program updates the scheduled activity quantity as the planned activity in the controlling module. You want to revalue the production orders using actual activity prices. Is there any configuration setting? Yes. There is a configuration setting to be done. Where is the configuration setting to be done for carrying out revaluation of planned activity prices in various cost objects? The configuration setting is to be done in the cost center accounting version maintenance for fiscal year. This has to be maintained for version 0. You need to select revalue option either using own business transaction or original business transaction. At month end you calculate actual activity prices in the system. You want to revalue the production orders with this actual activity prices. What are the options available in the system for revaluation? The options available are as follows:- You can revalue the transactions using periodic price, average price or cumulative price.
  • 41.
    Further you canrevalue the various cost objects as follows:- Own business transaction – Differential entries are posted Original business transaction – The original business transaction is changed.
  • 42.
    Internal orders What isthe purpose of defining Internal orders.? An example would help us understand this much better. Lets say in an organization there are various events such as trade fairs, training seminars, which occur during the year. Now lets assume for a second that these Trade fairs are organized by the Marketing cost center of the organization. Therefore in this case marketing cost center is responsible for all the trade fairs costs. All these trade fairs costs are posted to the marketing cost centers. Now if the management wants an analysis of the cost incurred for each of the trade fair organized by the marketing cost center how would the marketing manager get this piece of information across to them? The cost center report would not give this piece of info Now this is where Internal Order steps in .If you go through all cost center reports this information is not readily available since all the costs are posted to the cost center. SAP, therefore provides the facility of using internal orders which comes in real handy in such situations. In the above scenario the controlling department would then need to create an internal order for each of the trade fair organized. The cost incurred for each of the trade fair will be posted to the internal orders during the month. At the month end, these costs which are collected in the internal order will be settled from these orders to the marketing cost center. Thus the controlling person is now in a position to analyze the cost for each of the trade fair separately. Thus internal order is used to monitor costs for short term events, activities. It helps in providing more information than that is provided on the cost centers. It can be widely used for various purposes . How can you default certain items while creation of internal order master data? You can do so by creating a model order and then update the fields which you want to default in this model order. Finally attach this model order in the internal order type in the field reference order.
  • 43.
    Once the aboveis done whenever you create an internal order for this order type the field entries will get copied from the model order. What is the configuration setting for the release of the internal order immediately after creation? You have to check the “release immediately” check box in the internal order type.
  • 44.
    Product Costing What arethe important Terminologies in Product Costing?: Results Analysis Key – This key determines how the Work in Progress is calculated Cost Components - The break up of the costs which get reflected in the product costing eg. Material Cost, Labour Cost, Overhead etc Costing Sheets - This is used to calculate the overhead in Controlling Costing Variant - For All manufactured products the price control recommended is Standard Price. To come up with this standard price for the finished good material this material has to be costed. This is done using Costing Variant. Further questions down below will explain this concept better. What are the configuration settings maintained in the costing variant? Costing variant forms the link between the application and Customizing, since all cost estimates are carried out and saved with reference to a costing variant. The costing variant contains all the control parameters for costing. The configuration parameters are maintained for costing type, valuation variants, date control, and quantity structure control. In costing type we specify which field in the material master should be updated. In valuation variant we specify the following a) the sequence or order the system should go about accessing prices for the material master (planned price, standard price, moving average price etc). b) It also contains which price should be considered for activity price calculation and . c) How the system should select BOM and routing.
  • 45.
    How does SAPgo about costing a Product having multiple Bill of materials within it? SAP first costs the lowest level product, arrives at the cost and then goes and cost the next highest level and finally arrives at the cost of the final product. What does the concept of cost roll up mean in product costing context? The purpose of the cost roll up is to include the cost of goods manufactured of all materials in a multilevel production structure at the topmost level of the BOM(Bill of Material) The costs are rolled up automatically using the costing levels. 1) The system first calculates the costs for the materials with the lowest costing level and assigns them to cost components. 2) The materials in the next highest costing level (such as semi- finished materials) are then costed. The costs for the materials costed first are rolled up and become part of the material costs of the next highest level. What is a settlement profile and why is it needed? All the costs or revenues which are collected in the Production order or Sales order for example have to be settled to a receiver at the end of the period. This receiver could be a Gl account, a cost center, profitability analysis or asset. Also read the question “What is a cost object “ in the section Controlling. In order to settle the costs of the production order or sales order a settlement profile is needed. In a settlement profile you define a range of control parameters for settlement. You must define the settlement profile before you can enter a settlement rule for a sender. The Settlement Profile is maintained in the Order Type and defaults
  • 46.
    during creating oforder. . Settlement profile includes:- 1) the retention period for the settlement documents. 2) Valid receivers GL account, cost center, order, WBS element, fixed asset, material, profitability segment, sales order, cost objects, order items, business process 3) Document type is also attached here 4) Allocation structure and PA transfer structure is also attached to the settlement profile e.g. A1 The settlement profile created is then attached to the order type. What is Transfer or Allocation structure? The transfer structure is what helps in settling the cost from one cost object to the receiver. It is maintained in the Settlement profile defined above. The Transfer structure has 2 parts: a) Source of cost elements you want to settle b) Target receiver whether it is a Profitability segment or fixed asset or cost center So basically for settling the costs of a cost object you need to define the Transfer structure where you mention what are the costs you want to settle and the target receiver for that. This information you fit it in the settlement profile which contains various other parameters and this settlement profile is defaulted in the Order type. So every time a order is executed the relevant settlement rule is stored and at the month end by running the transaction of the settlement of orders all the cost is passed on to the receiver
  • 47.
    So to putin simple terms: a) You define your cost object which could be a production order a sales order for eg b) You collect costs or revenues for it c) You determine where you want to pass these costs or revenues to for eg if the sales order is the cost object all the costs or revenues of a sales order could be passed to Profitability Analysis What do you mean by primary cost component split? Primary cost split is defined when you create a cost component structure. When you switch on this setting, the primary cost from the cost center are picked up and assigned to the various cost components. How do primary costs get picked up from cost center into the cost component structure? This is possible when you do a plan activity price calculation from SAP. The primary cost component structure is assigned to the plan version 0 in Controlling . Is it possible to configure 2 cost component structures for the same product in order to have 2 different views? Yes it is possible. We create another cost component structure and assign it to the main cost component structure. This cost component structure is called Auxiliary cost component structure which provides another view of the cost component structure. How do you go about configuring for the sales order costing? The flow is as follows: Sales order -> Requirement Type-à Requirement Class-> All settings for controlling In a sales order you have a requirement type .In configuration, the requirement Class is attached to the requirement type and in this
  • 48.
    requirement class allconfiguration settings are maintained for controlling. In the requirement class we attach the costing variant, we attach the condition type EK02 where we want the sales order cost to be updated, and the account assignment category. In the account assignment category we define whether the sales order will carry cost or not. In case if we do not want to carry cost on the sales order we keep the consumption posting field blank. We also define here the Results Analysis version which helps to calculate the Results Analysis for the Sales order if required. There are 2 plants in a company code. First plant is the manufacturing plant and another plant is the selling plant. Finished goods are manufactured at the manufacturing plant and transferred to the selling plant. How is standard cost estimate calculated at the selling plant given the fact that the cost at both the plant should be the same? The special procurement type needs to be configured which specifies in which plant the system is to look up for cost. Here a special procurement key specifying plant 1 (manufacturing plant) should be configured. This special procurement type must be entered in the costing view or the MRP view of the Finished good material master record in plant 2. When you cost the finished good at plant 2, the system will transfer the standard cost estimate from plant 1 to plant 2 What is mixed costing in SAP? Give an example to explain. Mixed costing is required when different processes are used to manufacture the same material. Mixed costing is required when you have different sources of supply for purchasing the material. Let us take an example:- There is a finished good Xylene which can be manufactured by 3 different processes. The first process uses an old machine and labour. The processing time is 9 hrs to manufacture.
  • 49.
    The second processuses a semi-automatic machine and labour. The processing time is 7 hrs to manufacture. The third process uses a fully automatic machine and the processing time is 5 hrs. Thus cost of manufacture for the 3 processes is different. By using Mixed costing you can create a mixed price for the valuation of this finished good. What configuration needs to done for using Mixed costing? Quantity Structure type for mixed costing must be configured. Here we specify the time dependency of the structure type . The following options exist a) You have no time dependency. b) It is based on fiscal year c) It is based on period This quantity structure type is then assigned to the costing version. Lets say for a product there exists three production versions. Explain the process how you would go about creating a mixed cost estimate? The process of creating a Mixed cost estimate would be as follows:- 1) Create procurement alternatives for each of the production version. 2) Define Mixing ratios for the procurement alternatives 3) Select the configured quantity structure type and execute a material cost estimate based on the costing version. What is Mixing ratios and why are they required to be maintained before creation of cost estimate? Mixing ratios are weighting factors assigned to the procurement alternatives. This weighting factor is obtained from the planning department based on the usage of the procurement alternatives during the planning year. For e.g. Procurement alternative 1 (production version 1) 40% will be manufactured
  • 50.
    Procurement alternative 2(production version 2) 35% will be manufactured Procurement alternative 3 (production version 3) 25% will be manufactured This % will be maintained as mixing ratios. Thus when system calculates the mixed cost estimate, system will first cost each of the production version and then multiply each of the costs with the weighting factors. Thus 240 (cost of prod. Vers 1) X 40 = 9600 210 (cost of prod. Vers 2) X 35 = 7350 160 (cost of prod vers 3) X 25 = 4000 Mixed costs 17350/100 = 173.5 There are Result analysis categories in WIP (Work in Process). What do you mean by the result analysis category Reserves for unrealized costs? If you are calculating the work in process at actual costs, the system will create reserves for unrealized costs if the credit for the production order based on goods receipts is greater than the debit of the order with actual costs incurred. The Result analysis category RUCR (Reserves for unrealized cost) would need to be maintained. Normally this is not maintained in most of the companies. Which is the Result analysis category which is normally maintained for the WIP (Work in Process) calculation? The Result analysis category WIPR - Work in process with requirement to capitalize costs is normally maintained for WIP calculation How do you define a By-product in SAP? A By-product in SAP is defined as an item with a negative quantity in the Bill of Material. By-product reduces the cost of the main product. There is no Bill of Material for a By-product. How do you calculate the cost for a By-product in SAP?
  • 51.
    The cost forthe By-product is the net realizable value. This is manually maintained in the system for the by-product through transaction code MR21 Price change. How do you define a Co-Product in SAP? A Co-product (primary product or by-product) is indicated by a tick in the costing view of the material master. In the BOM all the primary products are represented as an item with negative quantity. A primary product is also indicated as a co-product in the BOM of the leading co- product. For primary products the costs are calculated using the apportionment method, while for by-products the net realizable value method applies. Is it possible to use Standard SAP Co-product functionality in Repetitive manufacturing? No. It is not possible to use the Standard Co-product functionality in repetitive manufacturing How do you got about defining CO-Product functionality in Repetitive manufacturing? In the Repetitive manufacturing you need to use the Costing BOM for the other co-product. Through arithmetical calculation you need to maintain the quantities in the costing BOM. This co-product will be shown as a negative item in the leading co-product. You get an error while executing a cost estimate which says” Item no 1 (which is a raw material) is not assigned to the cost component structure? What could be the possible cause of error in this scenario? The consumption GL code for the material master is not assigned to the cost component structure. To find out how you can know which GL code to assign read the next question.
  • 52.
    In the abovescenario how do you know which cost element is being called for? In this case you need to the use simulation mode OMWB in MM and enter the material code plant and the movement type 261 (issue against production order). You will see the account modifier VBR and against which the GL code is available. You get an error while executing a cost estimate, which says” Item no. 1 (which is a raw material) is not assigned to the cost component structure? In this case everything is perfectly configured, what could be the possible error in this scenario? In the material master of the raw material the valuation class updated in the accounting view will be incorrect. Is it possible to calculate standard cost estimate for a past date? No. It is not possible to calculate standard cost estimate for a past date. What is the difference between a product cost collector and production order? Both of these are cost objects which collect production costs for manufactured product. Product cost collector is a single order created for a material. All the costs during the month for that material is debited to single product cost collector. No costing by lot size is required in case of product cost collector. The latter is where there are many production orders for a single material during the month. Costs are collected on each of this production order. Costing by lot size is the main requirement in case of production orders. What is the meaning of preliminary cost estimate for product cost collector? Preliminary costing in the product cost by period component calculates the costs for the product cost collector. In repetitive manufacturing you can create cost estimate for specific production version.
  • 53.
    Why is preliminarycost estimate required? The preliminary cost estimate is required for the following:- Confirm the actual activity quantities. Valuate work in process Calculate production variances in variance calculation Valuate the unplanned scrap in variance calculation Is it possible to update the results of the standard cost estimate to other fields such as commercial price, tax price fields in the accounting view? Yes. It is possible to update the standard cost estimate to other fields such as commercial price etc. in accounting view. How do you configure that the results of the standard cost estimate are updated in other fields other than the standard price? The price update in the material master is defined in Costing type. This costing type is attached to the costing variant. What do you mean by Assembly scrap and how is it maintained in SAP? Assembly scrap is scrap that is expected to occur during the production of a material which is used as an assembly. If a certain amount of scrap always occurs during the production of an assembly, the quantities and activities used must be increased by the system so that the required lot size can be produced. To increase the lot size of an assembly you can enter a percentage, flat- rate assembly scrap in the MRP 1 view of the material master record. This assembly scrap is reflected in all the subordinate components. The system increases the quantity to be produced by the calculated scrap quantity. This increases both the materials consumed and the activities consumed and consequently the cost.
  • 54.
    How are scrapcosts shows in the standard cost estimate? Scrap costs are assigned to the relevant cost component and can be shown separately for a material in the costed multilevel BOM. How are scrap variances calculated? Scrap variance are calculated by valuating the scrap quantities with the amount of the actual costs less the planned scrap costs. What do you mean by Component scrap and how is it maintained in SAP? Component scrap is the scrap of a material that is expected to occur during production. When an assembly is produced with this component, the system has to increase the component quantity to enable to reach the required lot size. The component scrap can be entered in the BOM item or in the MRP 4 view of the material master What do you mean by Operation scrap and how is it maintained in SAP? Operation scrap is a scrap that is expected to occur during production. Operation scrap is used to reduce the planned input quantities in follow up operations and to calculate the precise amount of assembly scrap. Operation scrap can be maintained in % in the routing and in the BOM. What are the implications if the operation scrap is maintained in the routing and if it maintained in the BOM? If the operation scrap is maintained only in the routing, the costing lot size is reduced by this percentage. If the operation scrap is maintained in the BOM, the planned input (not the output quantity) is increased and any assembly scrap is reduced.
  • 55.
    What is themeaning of additive costs in SAP and why is it required? Additive costs are used to add costs manually to a material cost estimate when it cannot be calculated by the system. Examples of such costs are freight charges, insurance costs and stock transfer costs. What is the configuration required for additive costs? To include additive costs in the material cost estimate you need to set the indicator “Incl. additive costs” for each valuation strategy in the valuation variant. Further you also need to set in the costing variant to include additive costs. How do you configure split valuation? The configuration steps involved in split valuation:- 1) Activate split valuation – Configure whether split valuation is allowed for the company code. 2) Determine the valuation categories and valuation types that are allowed for all valuation areas. 3) Allocate the valuation types to the valuation categories 4) Determine the local valuation categories for each valuation area and activate the categories to be used in your valuation area. What is valuation category and valuation type in split valuation? In split valuation the material stock is divided according to valuation category and valuation type. Valuation category determines how the partial stocks are divided according to which criteria. The following valuation categories are preset in the standard SAP R/3 system – B - Procurement type H – Origin type X – Automatic batch valuation Valuation type describes the characteristic of individual stock. e.g. EIGEN Inhouse production (SAP standard) FREMD External procurement (SAP standard)
  • 56.
    Valuation types areassigned to valuation categories. What are the steps involved before you run a cost estimate for a split valuated material? The following are the steps:- 1) Create procurement alternatives based on the valuation types for the material. 2) Maintain Mixing ratios for the procurement alternatives How do you create a material master with split valuation? To create a split valuated material master proceed as follows:- 1. First create a valuation header record for the material. Update the Valuation category field on the accounting screen; leave the Valuation type field blank. In the Price control field, enter V (moving average price). When you save, the system creates the valuation header record. 2. Then create the material for a valuation type. Call up the same material in creation mode again. Due to the fact that a valuation header record exists, the system requires you to enter a valuation type for the valuation category. 3. Repeat Step two for every valuation type planned. When a standard cost estimate is run for a finished good does SAP calculate cost estimate for its components such as raw and packing material? Yes. SAP calculates the cost estimate even for raw and packing material and stores it in the standard price field for information purposes
  • 57.
    How do youprevent the system from calculating the cost estimate for raw and packing material when you run a standard cost estimate for the finished goods? To prevent the system from calculating cost estimates for raw and packing material, you need to select the “No costing” checkbox in the costing view of the material master. How is it possible to apply 2 different overhead rates for 2 different finished goods? It is possible through overhead groups. You configure 2 overhead keys. Define rates for each of this overhead key. These two overhead keys is then assigned to the two overhead groups. These overhead groups are attached in the costing view of the finished goods material master.
  • 58.
    Work in Progress Inperiod 1 there is a WIP posted of 22000 USD in period 2 some further goods issue are done to the extent of 15000 USD . How will system calculate WIP for period 2? System will post a delta WIP of 15000 USD in period 2. What is the basic difference in WIP calculation in product cost by order and product cost by period (repetitive manufacturing)? Generally in product cost by order, WIP is calculated at actual costs and in product cost by period WIP is calculated at target costs What are the configuration settings for calculating WIP in SAP? You define secondary cost elements of type 31 first. You then need to define the Results Analysis version This results analysis contains line ids which are basically nothing but break up of costs Next you define assignments-> here you assign source cost elements to the line ids defined above You also define the secondary cost elements which are assigned to the line ids. In the end you define the Finance GL accounts which are debited and credited when a Work in Progress is calculated. Please refer to the configuration document for more detailed information How does SAP calculate Work in Process (WIP) in product cost by order? The system first runs through all the production order for the month and checks for the status of each production order. If the status of the production order is REL (Released) or PREL (Partially released) and if
  • 59.
    costs are incurredfor that order system calculates WIP for the production order. The system cancels the WIP for the production order when the status of the order becomes DLV (delivered) or TECO (Technically complete). There is a production order with order quantity 1000 kgs. During the month 500 kgs of goods were produced. What will be the system treatment at the month end? The system will first check the status of the production order. Since the status of the order is not DLV (Delivered) it will calculate a WIP for the production order. Why does the system not calculate variance for the 500 kgs which has been delivered? In the product cost by order component the system does not calculate a variance for partially delivered stock on the production order. Whatever is the balance on the production order is considered as WIP. In the product cost by period component, system will calculate WIP as well as variance provided Is the WIP calculated in the product cost by order component at actual costs or standard costs? In the product cost by order component the WIP is calculated at actual costs. Is the WIP calculated in the product cost by period component at actual costs or target costs? In the product cost by period component the WIP is calculated at target costs.
  • 60.
    Material Ledger What precautionshave to be taken while switching on the material ledger for a plant? A material ledger once activated for a plant cannot be switched off. Therefore it is important that the material ledger be activated carefully for a plant. How do you go about configuring material ledger? The following are the steps:- 1) Activate Valuation Areas for Material Ledger 2) Assign Currency Types to Material Ledger Type 3) Assign Material Ledger Types to Valuation Area 4) Maintain Number Ranges for Material Ledger Documents 5) Activate Actual costing (whether activity update relevant for price determination) 6) Activate Actual cost component split 7) Customizing settings in OBYC What are the problems faced when a material ledger is activated? When a material ledger is activated it is imperative that actual costing run has to be done every month. Actual costing run needs to be done immediately after the new month roll over. After the actual costing run you cannot post any MM(Materials Management) entry to the previous period.
  • 61.
    What are theoptions available while performing revaluation in an actual costing run? There are 2 options available:- Revaluation – You can revalue the finished goods stock Accrual – You can accrue the revaluation gain or loss without actually changing the price in the material master. What is the configuration setting to be done for posting the accrual in the actual costing run? In transaction code OBYC select transaction key LKW and maintain the balance sheet account for accrual. What are the steps to be taken before you execute an actual costing run? The following are the steps to be taken: 1.) Execute all the allocation cycles in the cost center accounting module. 2.) Execute actual activity price calculation. 3.) Revalue all the production orders with the actual activity prices. The under or over absorbed cost on cost centers are passed on to the production order through this step of revaluation of production orders. 4.) Calculate overheads, do a variance calculation and finally settle the production order. 5.) Finally execute the actual costing run. What happens in an actual costing run? In actual costing run there is a process of single level price determination and multi level price determination. The production price difference variances are collected on the material ledger for each of the finished goods and semi finished goods.
  • 62.
    During single levelprice determination the price difference collected on a single finished product is allocated to consumption. This allocation to the consumption is not individually allocated to the good issues. In multi level price determination the price difference is allocated to individual goods issue. The price differences are passed on to the next level of consumption. The system calculates a weighted average price for the finished goods and semi finished goods. This weighted average price is called as the periodic unit price What happens when the revaluation is done in actual costing run for the previous period? When revaluation is performed in actual costing for the previous period the price control in the material master is changed from S to V and the periodic price is updated as the valuation price for the previous period. What is the importance of the price determination indicator in the material master for the purpose of actual costing run? There are 2 price determination indicators in the material master when material ledger is activated. They are as follows:- 2 – transaction based 3 – Single level / multi level In case of material masters having price determination indicator 2 no actual costing will take place. In case of material masters having price determination indicator 3 actual costing will take place. What should be the price control for a material master which has a price determination indicator 3 where material ledger is activated? In such a case only price control S is possible where the price determination 3 is activated in material master.
  • 63.
    Profitability Analysis Explain theorganizational assignment in the PA module? The operating Concern is the highest node in Profitability Analysis. The operating concern is assigned to the Controlling Area. Within the operating concern all the transactions of Profitability Analysis are stored. The operating concern is nothing but a nomenclature for defining the highest node in PA. What is the functionality of the PA module? PA module is the most important module when it comes to analyzing the results of the organization. In this module you basically collect the revenues from the sale order , the costs from the production order, cost center or internal order and analyze their results. The interesting part about this module is that when it collects the costs and revenues it also collects the characteristics associated with the costs and revenues and this is what makes it stand out So for e.g. using PA module you can find out the following: Profit of a certain product Profit of a certain product in a certain region Profit of a certain product in a certain region by a certain customer Profit of a certain product in a certain region by a certain sales person And the list can go on in depth It is one of the most wonderful modules in the SAP How do you get all those characteristics defined above and how do you analyze them?
  • 64.
    To do sowhile defining Operating concern one has to define Characteristics and Value fields. What are characteristics and Value Fields? In the operating concern two things are basically defined a) Characteristics b) Value Fields Characteristics are nothing but those aspects on which we want to break down the profit logically such as customer, region product, product hierarchy, sales person etc Value Fields are nothing but the values associated with these characteristics Eg Sales, Raw Material Cost, Labour Cost, Overheads etc Once you define the characteristics and value fields these values are updated in the table. From where does the characteristics come from? The characteristics which are defined above basically comes from either the Customer Master or the Material Master. How does various values( revenues and costs) flow into PA? The Sales Revenue comes from the Condition Type in SD. We need to map the Condition Type in SD to the respective value fields in customizing to have the revenue flow into PA. The Cost comes from Cost estimates which are transferred using the PA transfer structure which we have covered in the Product costing section. The various cost components of the cost component structure is assigned to the value field of PA module and this is how the costs come into PA. Once the actual revenue and the std cost defined above are captured in PA the variances are also transferred into PA.
  • 65.
    This way thestd cost variances equal the actual cost. So actual revenue- actual cost helps us determine the profit. How do you configure the assignment of variances from product costing to COPA module? The variance categories from product costing along with cost element is to be assigned to the value fields in COPA Once you have captured all the costs and revenues how do you analyze them? The costs and revenues which we have captured in the above manner are then analysed by writing reports using the Report Painter Functionality in SAP. What is characteristic Derivation in Profitability Analysis Module? Characteristic Derivation is usually used when you want to derive the characteristics . An example of this could be say you want to derive the first two characteristics of product hierarchy. In such cases you define characteristic derivation where you maintain the rules, which contain the table names of the product hierarchy fields and the number of characters to be extracted, and it also specifies the target characteristic field in PA. What is the basic difference in customizing in Profitability analysis as compared to other modules? In PA when we configure the system i.e. creating operating concern, maintain structures no customizing request is generated. The configuration needs to be transported through a different transaction called as KE3I.
  • 66.
    What is thedifference between Account based Profitability Analysis and Costing based Profitability Analysis? Account based Profitability analysis is a form of Profitability analysis (PA) that uses accounts as its base and has an account based approach. It uses costs and revenue elements. Costing based Profitability Analysis is a form of profitability analysis that groups costs and revenues according to value fields and costing based valuation approaches. The cost and revenues are shown in value fields. What are the advantages and disadvantages of Account based profitability analysis vis-à-vis costing based profitability analysis? The advantage of Account based PA is that it is permanently reconciled with Financial accounting. The disadvantages are that it is not powerful as the costing based PA, since it uses accounts to get values. No Contribution margin planning can be done since it cannot access the standard cost estimate. Further no variance analysis is readily available. The advantages of the Costing based PA are manifold. They are as follows: - • Greater Reporting capabilities since lot of characteristics are available for analysis. • This form of PA accesses the Standard cost estimate of the manufactured product and gives a split according to the cost component split (from the product costing module) when the bills are posted. • Contribution margin can be planned in this module since the system automatically accesses the standard cost estimate of the product based on the valuation approaches. • Variance analysis is ready available here since the variance categories can be individually mapped to the value fields. Disadvantages:- Since it uses a costing based approach, it does not sometime reconcile with financial accounting.
  • 67.
    Can both Accountbased and Costing based Profitability analysis be configured at the same time? Yes. It is possible to configure both types of costing based profitability analysis at the same time. What is the advantage of configuring both the type of Profitability analysis together? The advantage of activating account based profitability analysis along with costing based PA is that you can easily reconcile costing based profitability analysis to account based profitability analysis, which means indirectly reconciling with Financial accounting. Is there any additional configuration required for Account based profitability analysis as compared to costing based profitability analysis? No. There are no special configurations required except for activating the account based profitability analysis while maintaining the operating concern. What is the difference between Profitability analysis and Profit center accounting? Profitability analysis lets you analyze the profitability of segments of your market according to products, customers, regions, division. It provides your sales, marketing, planning and management organizations with decision support from a market oriented view point. Profit center accounting lets you analyze profit and loss for profit centers. It makes it possible to evaluate different areas or units within your company. Profit center can be structured according to region, plants, functions or products (product ranges). What configuration settings are available to set up valuation using material cost estimate in costing based profitability analysis? In Costing based Profitability analysis you define costing keys. A costing key is a set of access parameters which are used in valuation to determine which data in Product cost planning should be read. In the costing key you attach the costing variant.
  • 68.
    In the costingkey you specify whether the system should read the current standard cost estimate, the previous standard cost estimate or the future standard cost estimate or a saved cost estimate. The configuration settings to determine this costing key is as follows:- 1) Assign costing keys to the products – Three costing keys can be attached to a single product for a specific point of valuation, record type, plan version. 2) Assign costing keys to Material types 3) Assign costing keys to any characteristics – You can use your own strategy to determine the costing keys. This is through user defined assignment tables.
  • 69.
    Profit Center What isthe basic purpose of creating a Profit Center? The basic purpose of creating a Profit Center is to analyse the revenues and costs for a particular product line, or a plant or a business unit. Though you can generate balance sheets and profit and loss accounts per Profit Center still a profit center should basically be used as a tool only for internal reporting purposes. If legally one has to produce the Balance sheets and Profit and Loss Accounts for a profit center then it is advisable to create it as a company code instead of a profit center How does the cost and revenue flow to the Profit Center? The profit center is stored in the cost center this way the costs flow to the profit center. The profit center is also stored in material master. This way all sales orders created for the finished product automatically picks up the profit center from the material master and all the revenues and costs coming from this sales order for that finished product is passed on to this profit center. A profit center document is created in addition to the Finance document whenever revenue or consumption takes place. This document contains the details of the profit center. Once both the costs and revenues flow to the profit center you can write reports using the Report Painter to get intelligent analysis. You can also use SAP standard reports Statistical key figures are created in the cost center accounting module. Now the same statistical key figures are required in the profit center accounting module. Is it required to maintain the statistical key figure in PCA module? No. Since the statistical key figures are created in a controlling area. Profit center is a sub module within controlling area. The statistical key
  • 70.
    figure is createdfor the controlling area and as such is available in profit center accounting module. What are the precautions to be taken while maintaining the 3KEH table for profit center accounting? You should not maintain the customer and vendor reconciliation accounts in the 3KEH table. Further you should also not maintain the special GL accounts in this table. Since we are transferring the customer and vendor balances to profit center module through separate month end programs. If the reconciliation’s accounts are maintained here it will result in double posting in the profit center module. Should secondary cost elements be maintained in the 3KEH table? No. Since here we maintain only those accounts for which the value should flow from FI to PCA. Secondary cost elements are already defined in the controlling module which will reflect in the postings in PCA also How can the default settings be maintained for cost elements per company code? The default settings can be maintained in transaction OKB9. Here we can specify for a company code, cost element which is the cost center to be defaulted or whether profitability segment is to be automatically derived. Further we can also maintain whether business area is mandatory or profit center is mandatory and can maintain the default business areas and profit centers. What are the other important activities in Profit Center? The assignments of profit center to the cost center and also assignment of profit center to the material master is what will determine the success of the Profit center posting. If these assignments are wrongly done then the profit center postings will not come in properly.
  • 71.
    Period End ClosingActivities in Controlling: What are the period end closing activities in controlling ? The following are the period end closing activities in Controlling: Repost CO Documents that was incorrectly posted Run Distribution or Assessment Cycles Run the Overhead Calculation in Product Costing Run the WIP Calculation in Product Costing Run the Variance Calculation in Product Costing Run the Settlement Calculation in Product Costing which will post all the WIP and variance to Finance and PA. Calculate FI Data for Transfer to Profit Center Transfer Balance Sheet Items like Recievables, Payables, Assets and Stock Run Results Analysis for Sales Order if applicable Run Settlement of Sales Orders to PA.
