Jan.06.2004 Monthly Business Review Contents 1. Key Initiatives 2. Issues Appendix :  December, 2003 President Customer Director Prepared by A.Arenas

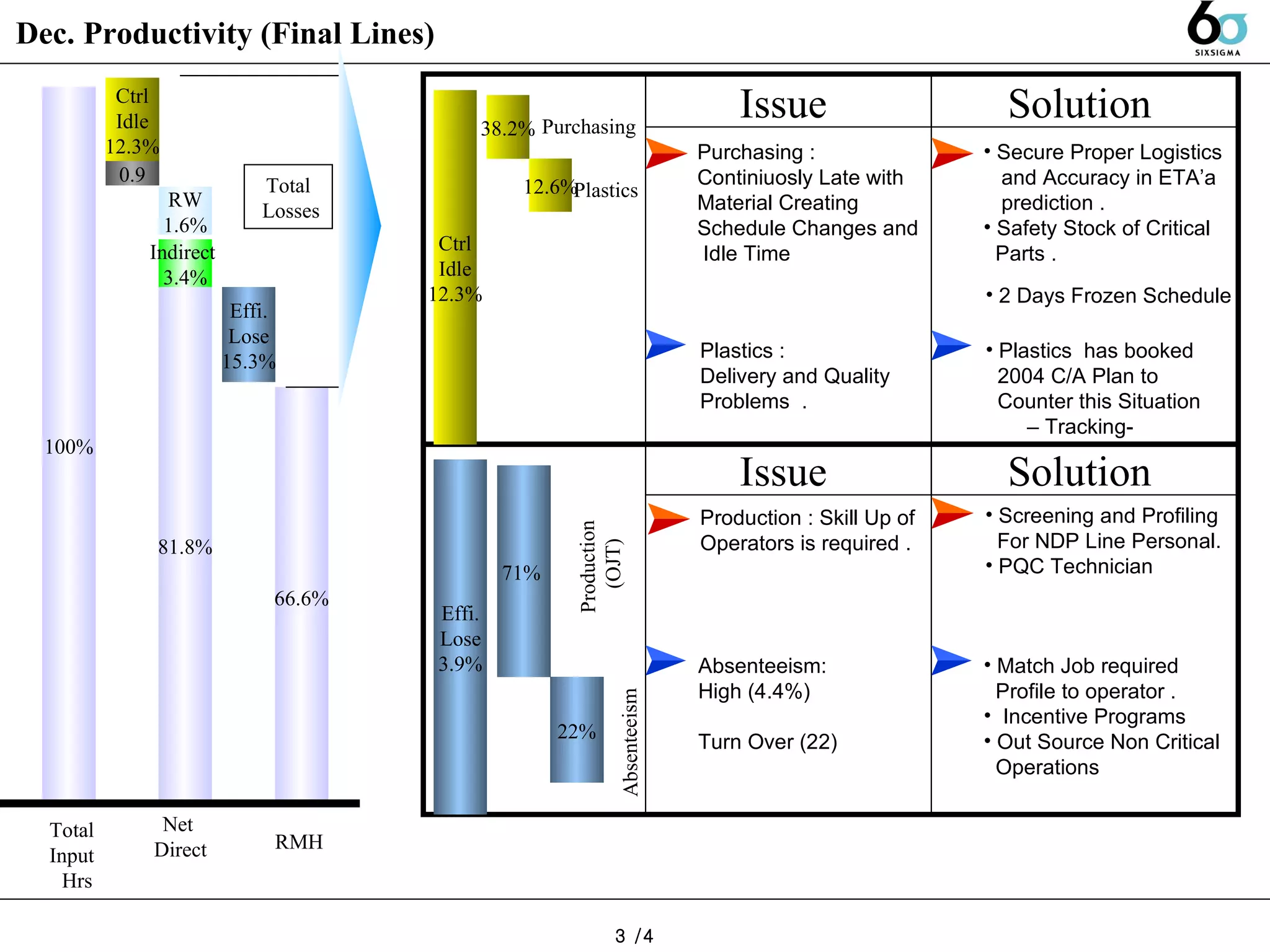

Dec. Productivity (Final Lines)  Match Job required  Profile to operator .  Incentive Programs  Out Source Non Critical Operations Ctrl Idle 12.3% 38.2% Purchasing  Effi. Lose 3.9% 12.6% Plastics Issue  Solution  Purchasing : Continiuosly Late with  Material Creating  Schedule Changes and Idle Time Plastics : Delivery and Quality  Problems  .  Secure Proper Logistics and Accuracy in ETA’a  prediction .  Safety Stock of Critical  Parts .  Plastics  has booked  2004 C/A Plan to  Counter this Situation  –  Tracking- 71%  Issue  Solution  Absenteeism: High (4.4%) Turn Over (22) 22% Production  (OJT) Absenteeism   3 /4 Production : Skill Up of Operators is required .  Screening and Profiling For NDP Line Personal.  PQC Technician  2 Days Frozen Schedule 100% Ctrl Idle 12.3% 0.9 RW 1.6% Indirect  3.4% 81.8% Total  Input  Hrs Net  Direct Effi. Lose 15.3% 66.6% RMH Total Losses

3. Issues Risk & Opportunity Major Activities Productivity Improvement (TE Capability to Detect more defects ) . Re-arrange Operators /supervisor to Improve  productivity TDR Team working to Improve NDP Line Productivity  by 233%  Low Productivity in Line 6 due to  design changes (ECO’s) , Frequent  Model Changes , Material Quality ,  Material Shortages , and Operators  Absenteeism and Skills .  Any Rework required to be done before  Delivering to Final Line  Material Delivery Tight to meet Schedule NDP Line Packing Area Problems  NDP Line Conveyor Logic Errors  Activities Good & Bad Task Team  (TDR) to address Process opportunities .  Training for Cross Functional Operators  and stronger Relief operators .  Develop Product Experts for NDP Line Action Plan Issues Solutions Allocation of a group to address Rework  caused by incoming material .  TPSG to Provide On The Job Training to  new Operators .  Material Expeditor  Line Fallout (Skills, Criteria , Equip. Turn Over  Clean Room (To Prevent Contamination) Automatic Hi-Pot Verification  Use Chassis after Functional test only Define CTQ’s and CTP’s  Establish disciplinary Guide Lines  4 / 4
MBR Review  Contents  KPI  Top 3 Contributors for RMH / Quality / PSA  Attachments  1 of 15 President Customer Director Prepared by A.Arenas

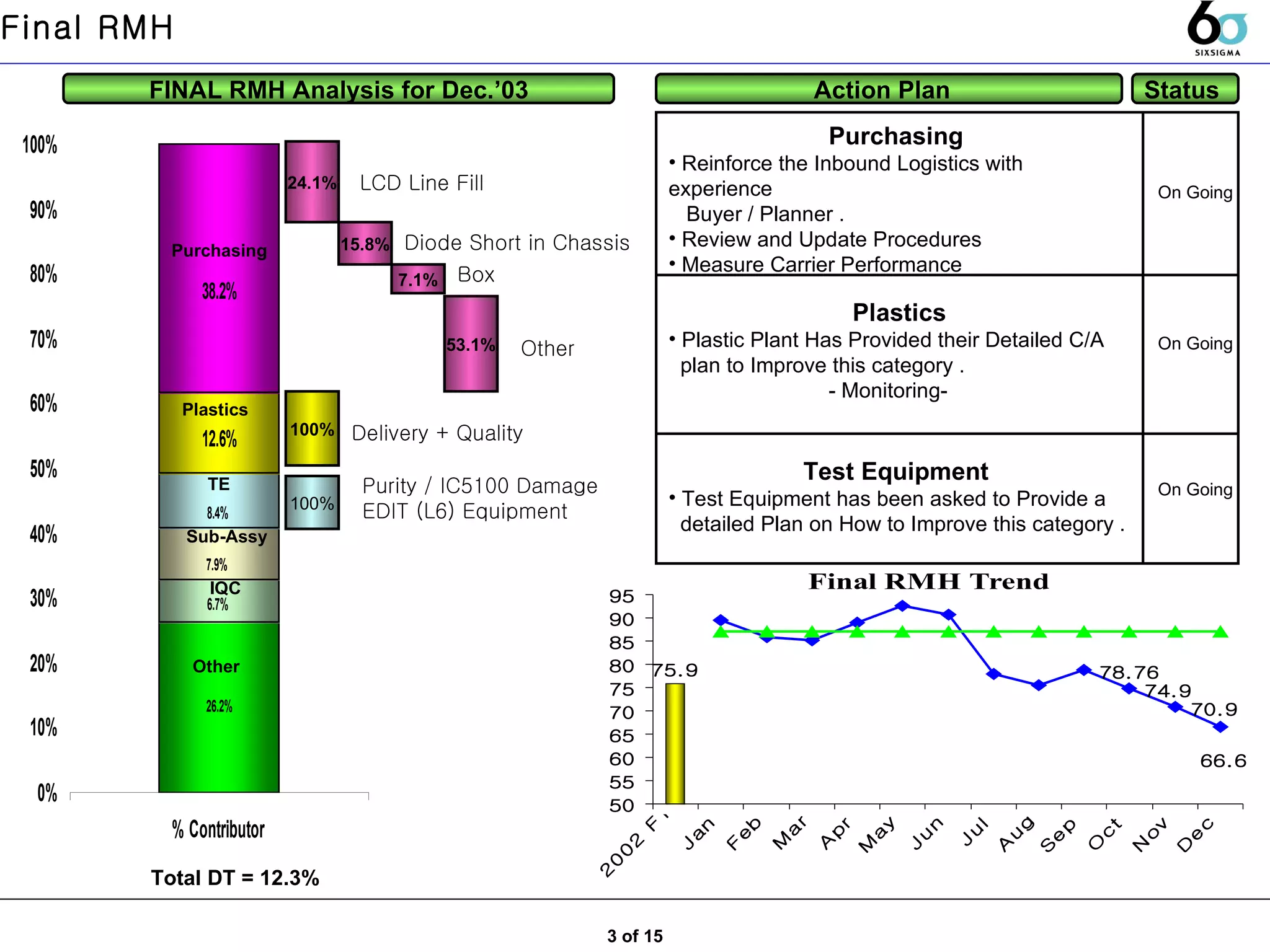

24.1% 15.8% 100% FINAL RMH Analysis for Dec.’03 Action Plan  Status  Total DT = 12.3%  7.1% Purchasing  Reinforce the Inbound Logistics with experience  Buyer / Planner . Review and Update Procedures  Measure Carrier Performance  On Going 53.1% TE Purchasing Plastics Other  100% Sub-Assy Final RMH 3 of 15 IQC LCD Line Fill  Diode Short in Chassis Box  Other  Delivery + Quality Purity / IC5100 Damage  EDIT (L6) Equipment  Plastics Plastic Plant Has Provided their Detailed C/A  plan to Improve this category .  - Monitoring-  On Going Test Equipment  Test Equipment has been asked to Provide a  detailed Plan on How to Improve this category .  On Going

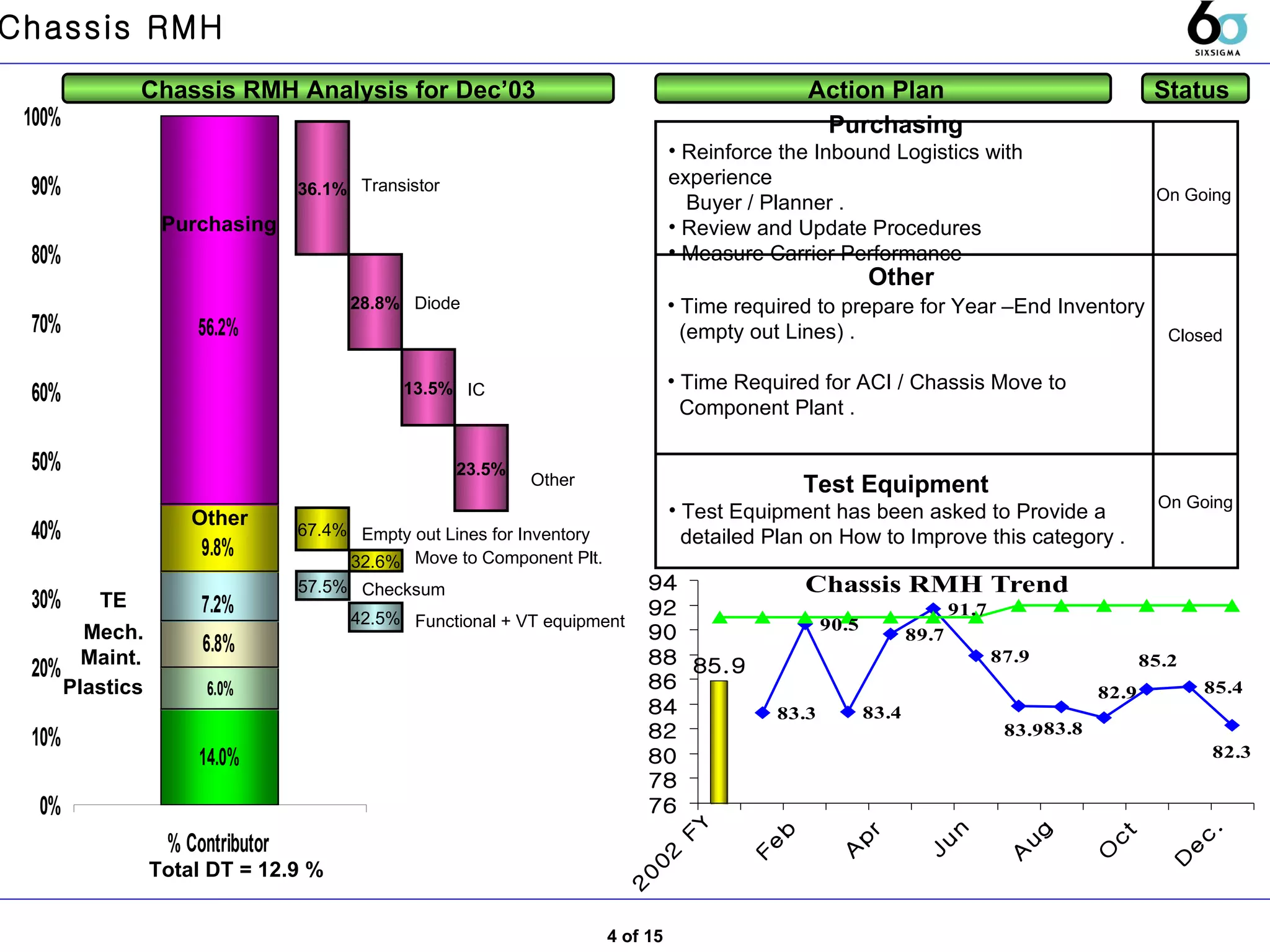

36.1% 28.8% 57.5% 67.4% Chassis RMH Analysis for Dec’03 Action Plan  Status  Total DT = 12.9 % 23.5% On Going Purchasing  Reinforce the Inbound Logistics with experience  Buyer / Planner . Review and Update Procedures  Measure Carrier Performance  Transistor  Purchasing IC Diode 13.5% Other  TE Empty out Lines for Inventory Checksum  Chassis RMH 4 of 15 Other  Mech. Maint. Plastics 32.6% Move to Component Plt. 42.5% Functional + VT equipment Test Equipment  Test Equipment has been asked to Provide a  detailed Plan on How to Improve this category .  On Going Other  Time required to prepare for Year –End Inventory (empty out Lines) .  Time Required for ACI / Chassis Move to  Component Plant .  Closed

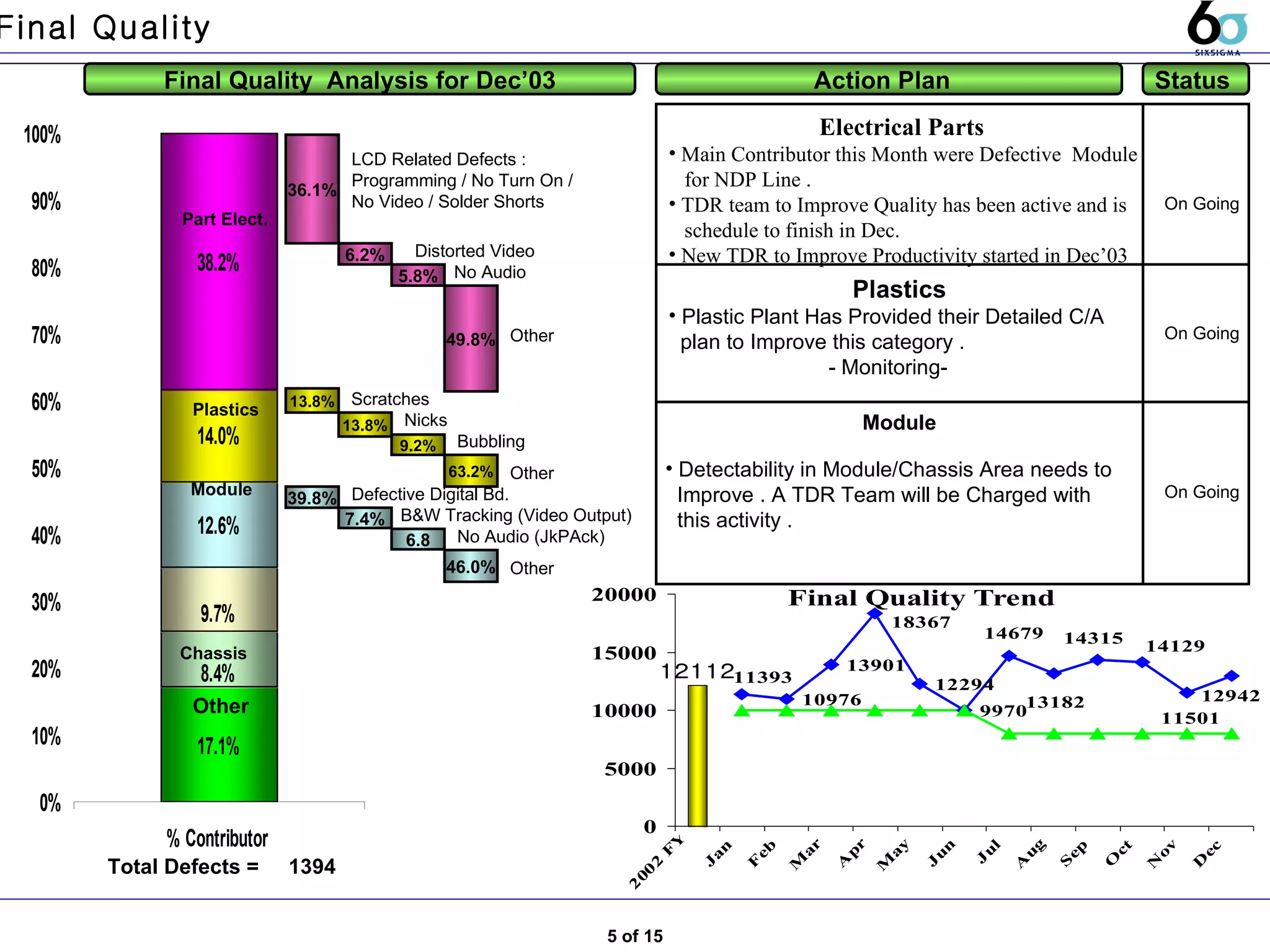

36.1% 13.8% 39.8% Final Quality  Analysis for Dec’03 Action Plan  Status  Total Defects =  1394 Other  Electrical Parts   Main Contributor this Month were Defective  Module for NDP Line .  TDR team to Improve Quality has been active and is  schedule to finish in Dec.  New TDR to Improve Productivity started in Dec’03 7.4% 6.8 Plastics Chassis Part Elect. Module  9.2% 63.2% Distorted Video Defective Digital Bd. On Going Final Quality 5 of 15 LCD Related Defects : Programming / No Turn On / No Video / Solder Shorts  6.2% 5.8% No Audio 49.8% Other Scratches 13.8% Nicks Bubbling Other B&W Tracking (Video Output) No Audio (JkPAck) 46.0% Other Module Plastics Plastic Plant Has Provided their Detailed C/A  plan to Improve this category .  - Monitoring-  On Going Detectability in Module/Chassis Area needs to  Improve . A TDR Team will be Charged with  this activity .  On Going

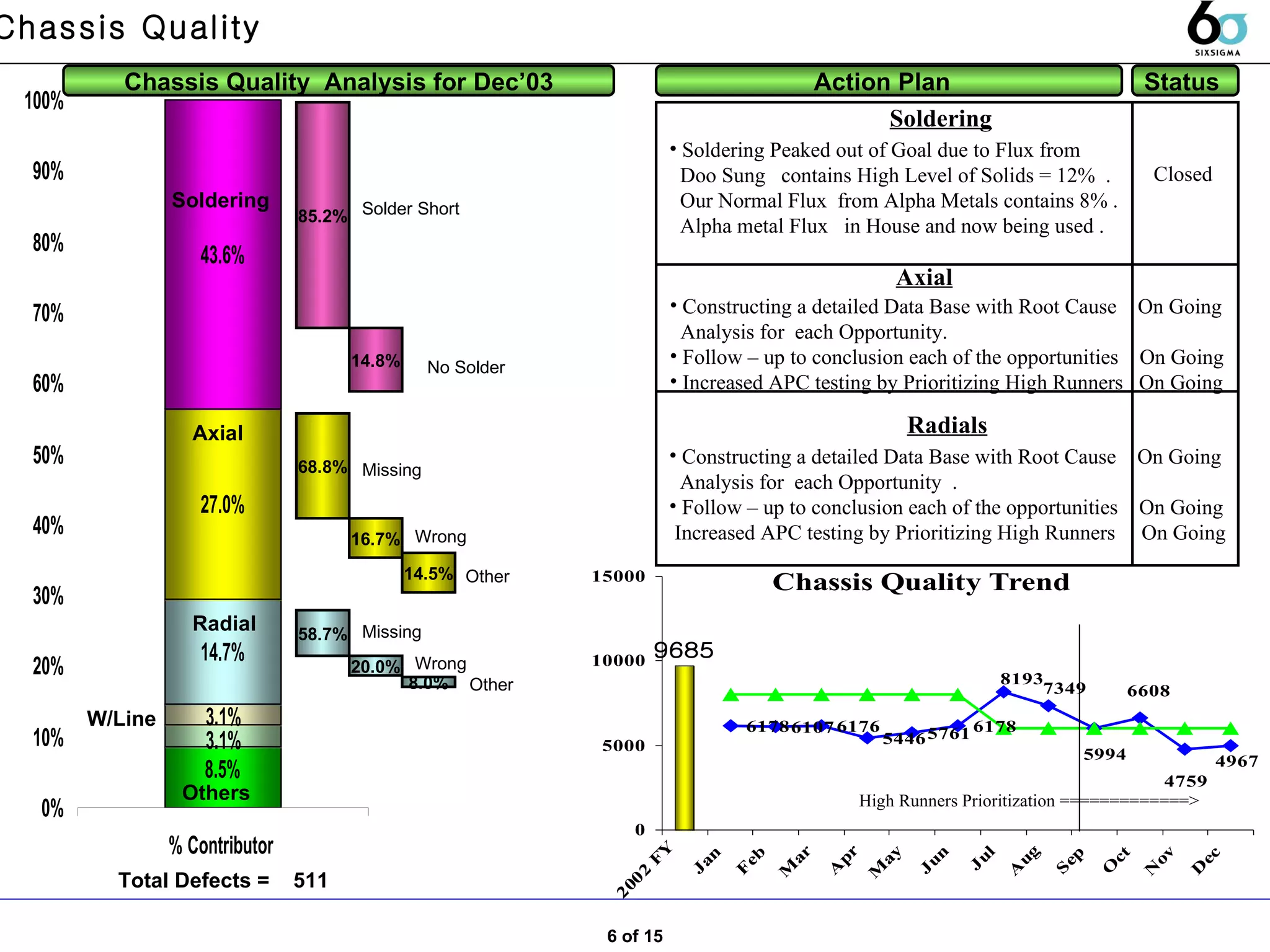

85.2% 14.8% 68.8% 16.7% 58.7% Chassis Quality  Analysis for Dec’03 Action Plan  Axial   Status  Total Defects =  511 Soldering Radials 20.0% Others  Constructing a detailed Data Base with Root Cause  On Going  Analysis for  each Opportunity.  Follow – up to conclusion each of the opportunities  On Going Increased APC testing by Prioritizing High Runners  On Going Constructing a detailed Data Base with Root Cause  On Going  Analysis for  each Opportunity  .  Follow – up to conclusion each of the opportunities  On Going Increased APC testing by Prioritizing High Runners  On Going  8.0% Axial  Soldering  Radial  W/Line Solder Short  Missing Wrong Missing  Wrong High Runners Prioritization =============> Chassis Quality 6 of 15 No Solder 14.5% Other  Other  Soldering Peaked out of Goal due to Flux from  Doo Sung  contains High Level of Solids = 12%  .  Our Normal Flux  from Alpha Metals contains 8% .  Alpha metal Flux  in House and now being used .  Closed

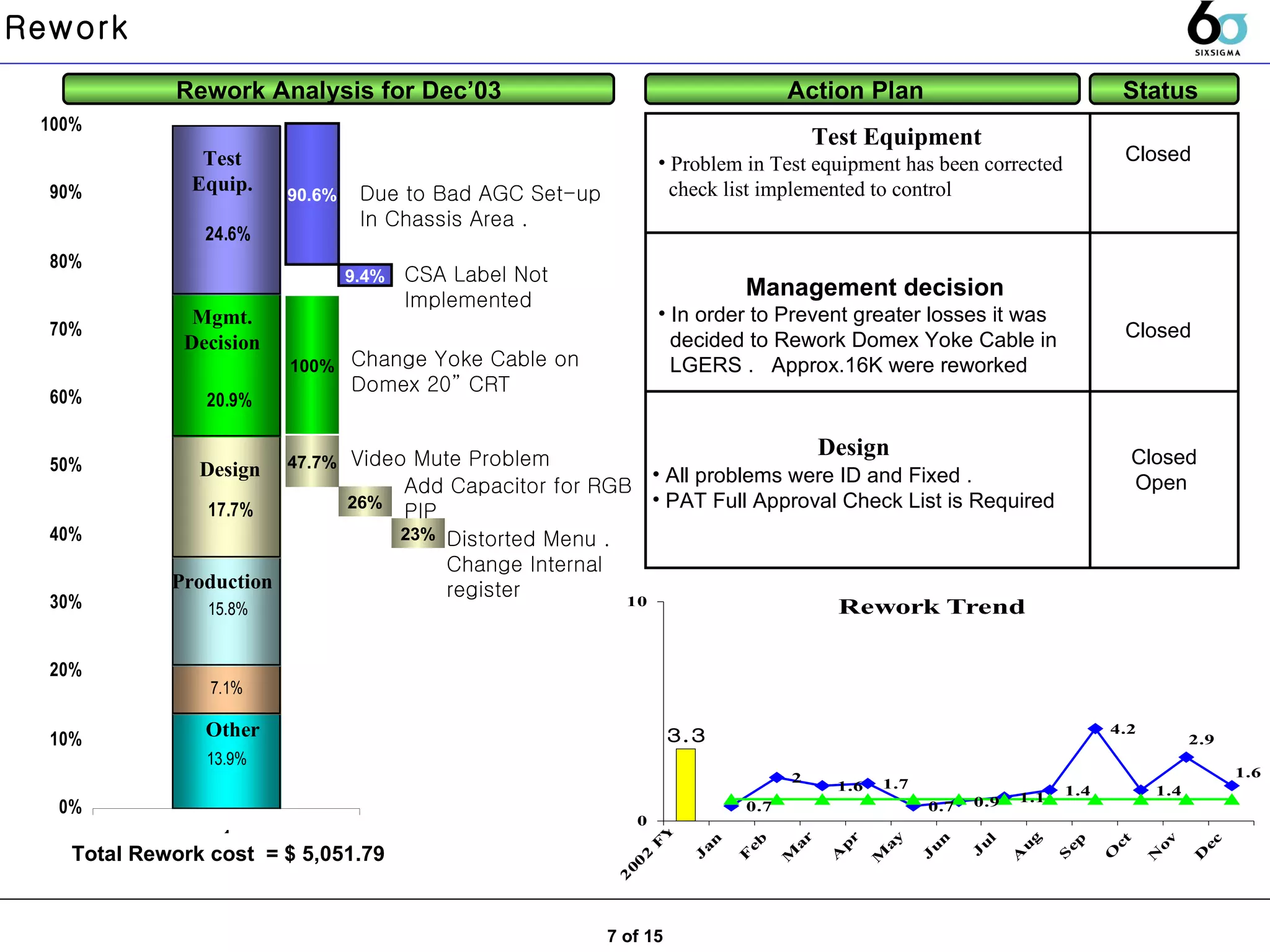

90.6% Rework Analysis for Dec’03 Action Plan  Test Equipment Problem in Test equipment has been corrected  check list implemented to control  Status  Total Rework cost  = $ 5,051.79 100% Design  Test Equip. 47.7% Closed  All problems were ID and Fixed .  PAT Full Approval Check List is Required Closed Open  Mgmt. Decision  26% Management decision  In order to Prevent greater losses it was decided to Rework Domex Yoke Cable in  LGERS .  Approx.16K were reworked  Closed  Rework 7 of 15 Due to Bad AGC Set-up  In Chassis Area .  9.4% CSA Label Not  Implemented Design  Change Yoke Cable on  Domex 20” CRT Video Mute Problem  Add Capacitor for RGB PIP 23% Distorted Menu .  Change Internal  register Production Other

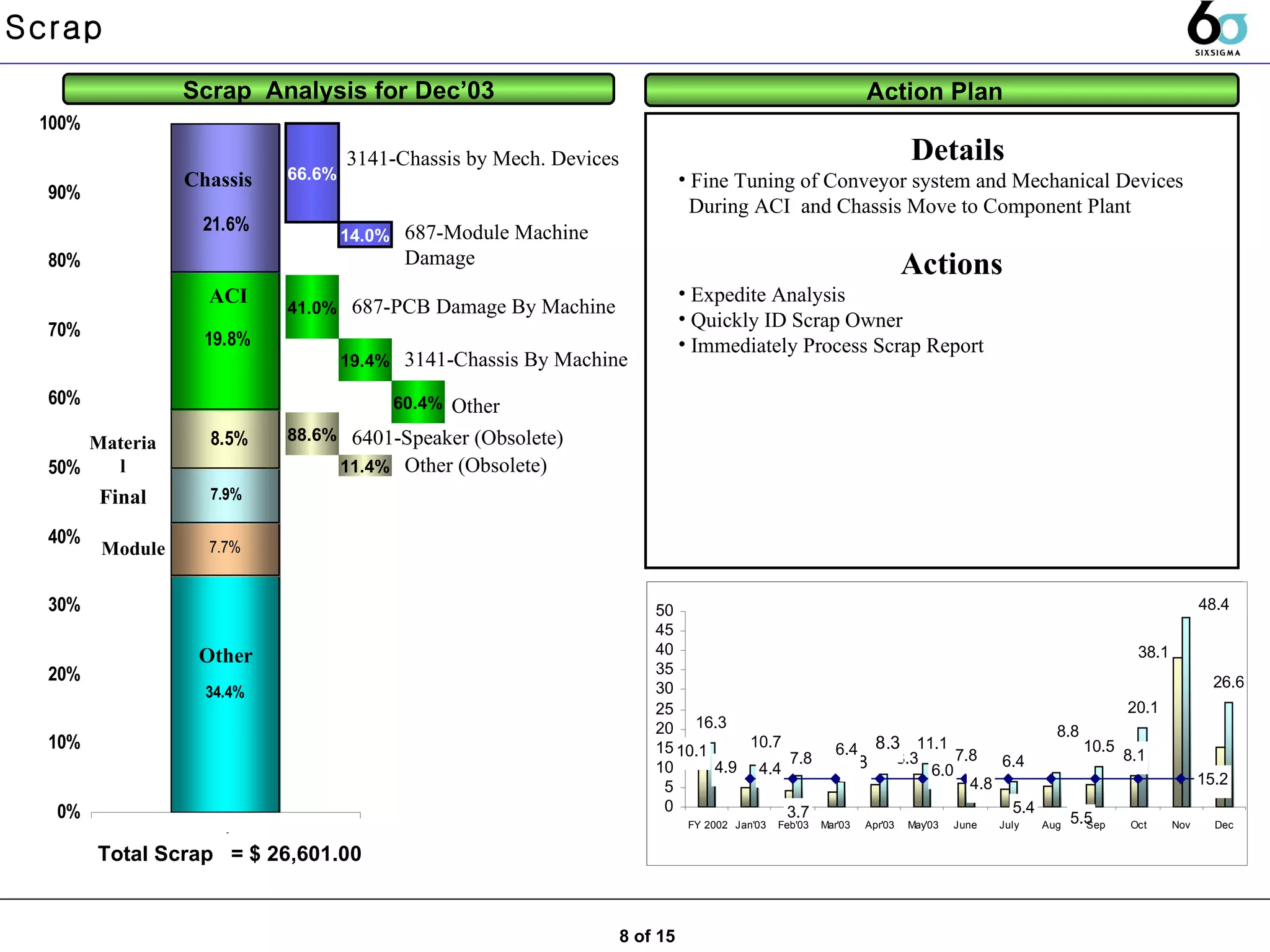

66.6% Scrap  Analysis for Dec’03 Action Plan  Total Scrap  = $ 26,601.00 41.0% 88.6% Scrap  3141-Chassis by Mech. Devices  687-PCB Damage By Machine  Details  Fine Tuning of Conveyor system and Mechanical Devices During ACI  and Chassis Move to Component Plant  Actions  Expedite Analysis  Quickly ID Scrap Owner  Immediately Process Scrap Report  Chassis Final ACI Other  Material 8 of 15 Module 14.0% 19.4% 3141-Chassis By Machine 60.4% Other  6401-Speaker (Obsolete) 11.4% Other (Obsolete) 687-Module Machine  Damage

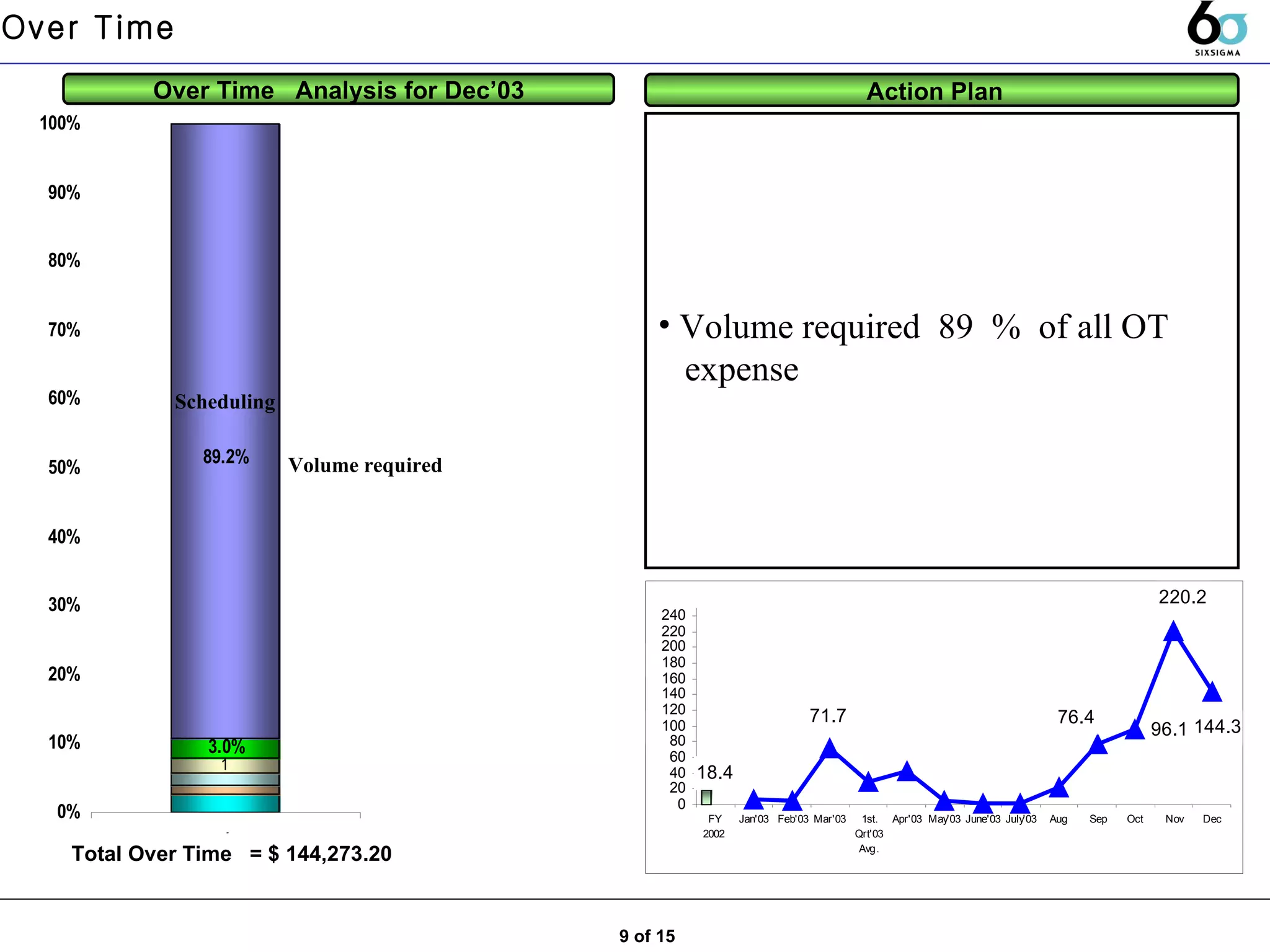

Over Time  Analysis for Dec’03 Action Plan  Total Over Time  = $ 144,273.20 Over Time  Scheduling  Volume required  Volume required  89  %  of all OT expense  9 of 15

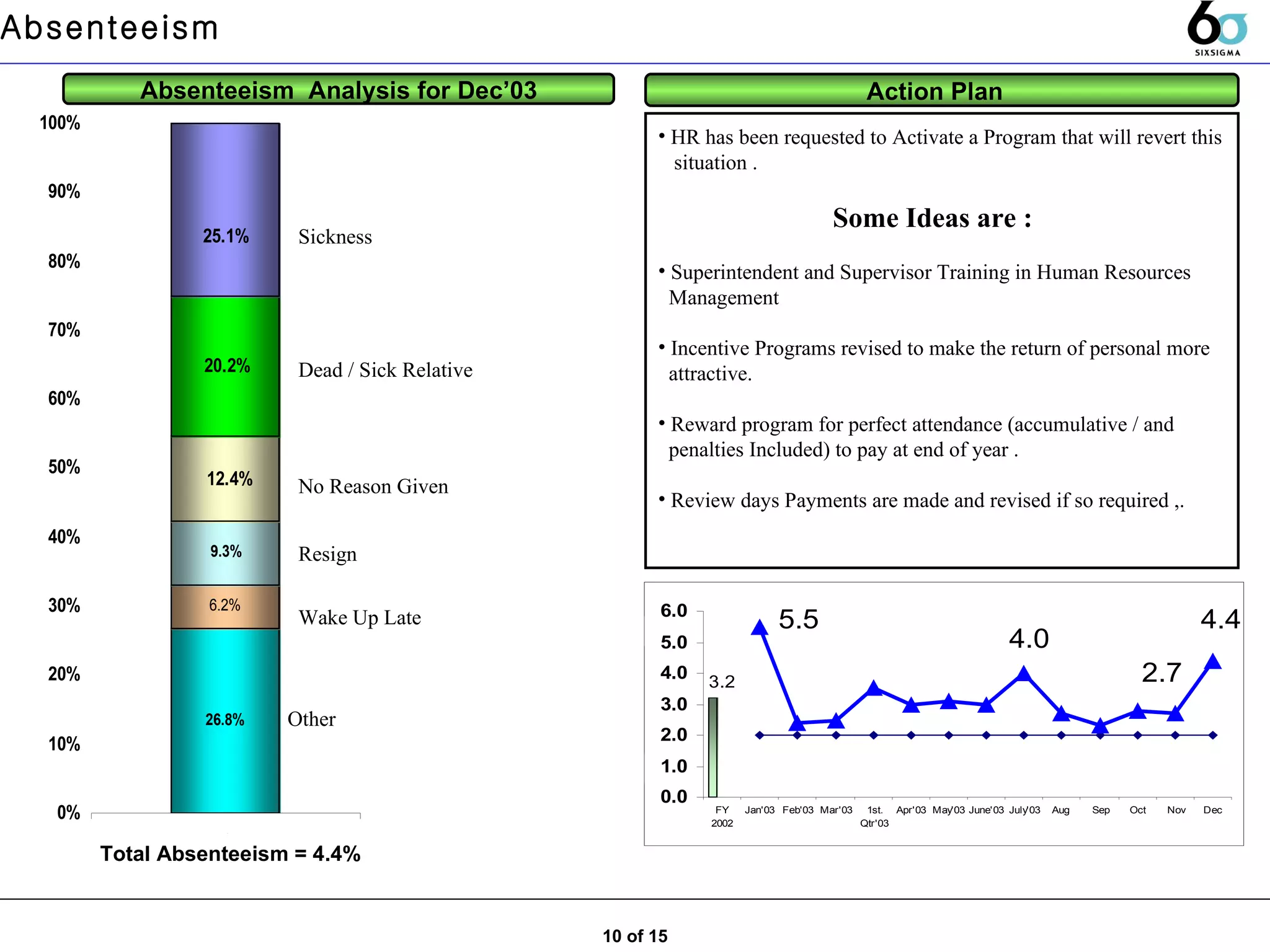

Absenteeism  Analysis for Dec’03 Action Plan  Total Absenteeism = 4.4% Absenteeism  Other  Sickness Dead / Sick Relative  No Reason Given Resign Wake Up Late  HR has been requested to Activate a Program that will revert this situation .  Some Ideas are :  Superintendent and Supervisor Training in Human Resources Management Incentive Programs revised to make the return of personal more attractive. Reward program for perfect attendance (accumulative / and  penalties Included) to pay at end of year .  Review days Payments are made and revised if so required ,.  10 of 15

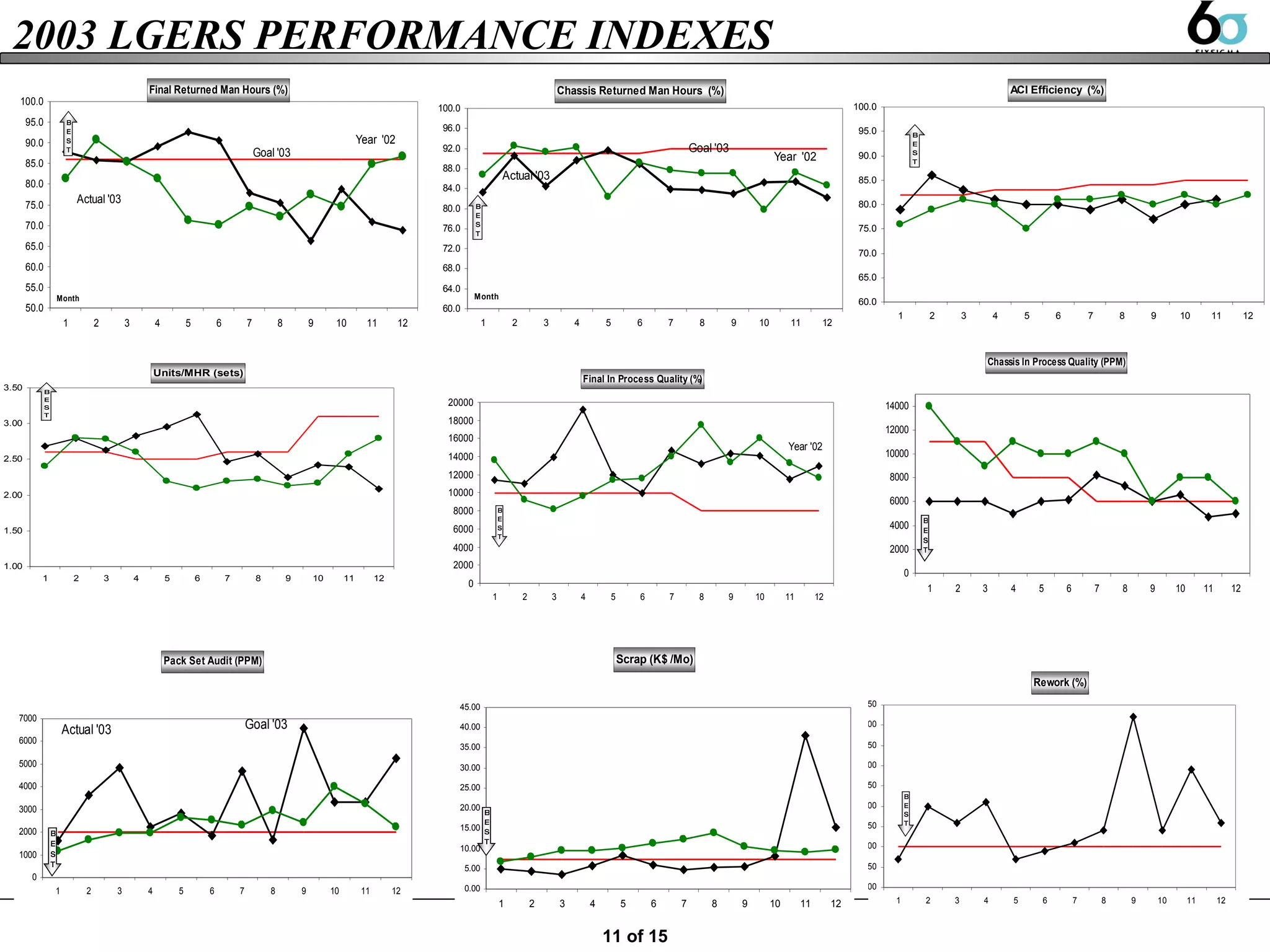

2003 LGERS PERFORMANCE INDEXES 11 of 15

2003 LGERS PERFORMANCE INDEXES  cont... 12 of 15

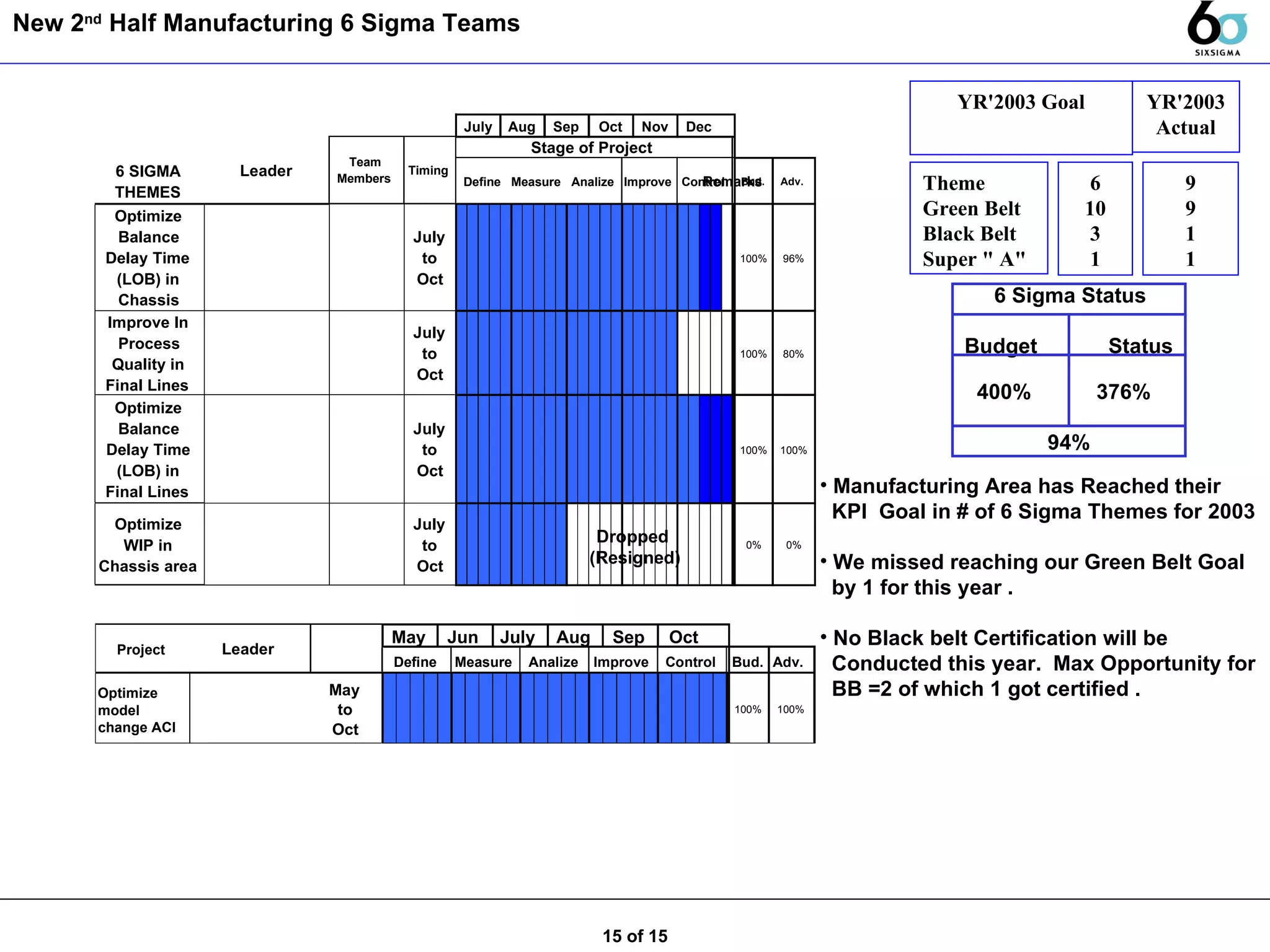

New 2 nd  Half Manufacturing 6 Sigma Teams  94% Manufacturing Area has Reached their  KPI  Goal in # of 6 Sigma Themes for 2003 We missed reaching our Green Belt Goal by 1 for this year .  No Black belt Certification will be Conducted this year.  Max Opportunity for BB =2 of which 1 got certified .  Dropped  (Resigned) 15 of 15 Budget  Status 6 SIGMA  THEMES Define Measure Analize Improve Control Bud. Adv.  Optimize  Balance  Delay Time  (LOB) in  Chassis July  to  Oct 100% 96% Improve In  Process  Quality in  Final Lines  July  to  Oct 100% 80% Optimize  Balance  Delay Time  (LOB) in  Final Lines  July  to  Oct 100% 100% Optimize  WIP in  Chassis area  July  to  Oct 0% 0% Nov Dec July Aug Sep Oct Leader  Stage of Project Team  Members Timing Remarks Define Measure Analize Improve Control Bud. Adv.  Optimize  model  change ACI May  to  Oct 100% 100% May Jun July Aug Project Leader  Sep Oct Theme Green Belt Black Belt Super " A" YR'2003 Actual YR'2003 Goal 6 10 3 1 9 9 1 1 6 Sigma Status  Budget  Status 400%  376%

Production Performance Results Internet Sample
