PMI-ACP Domain 1
Agile Principles
and Mindset

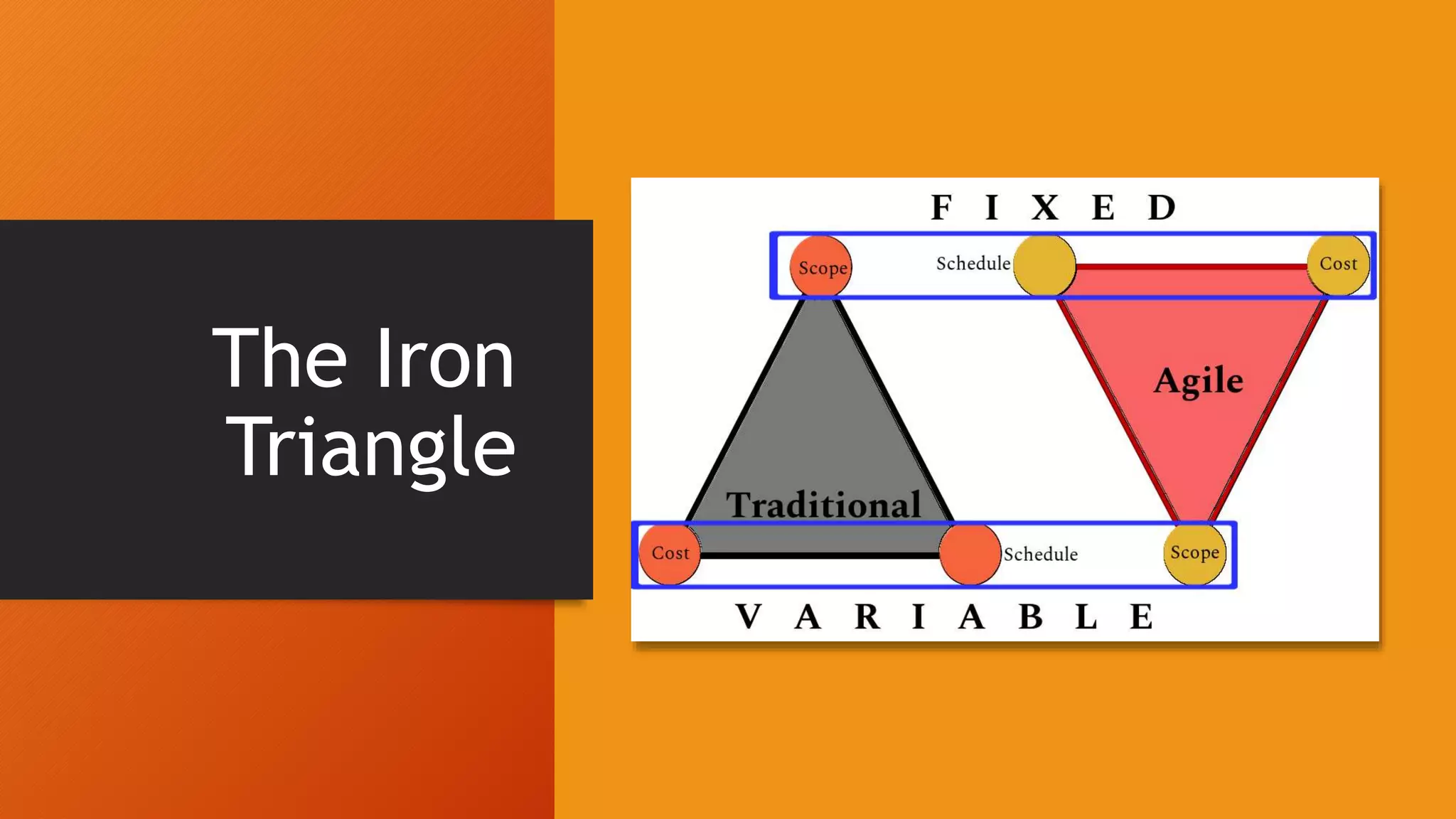

The Iron
Triangle
Traditional
Scope is fixed
Cost and schedule
are usually
variable
Agile
Cost and schedule
become fixed
The scope
becomes variable
Project

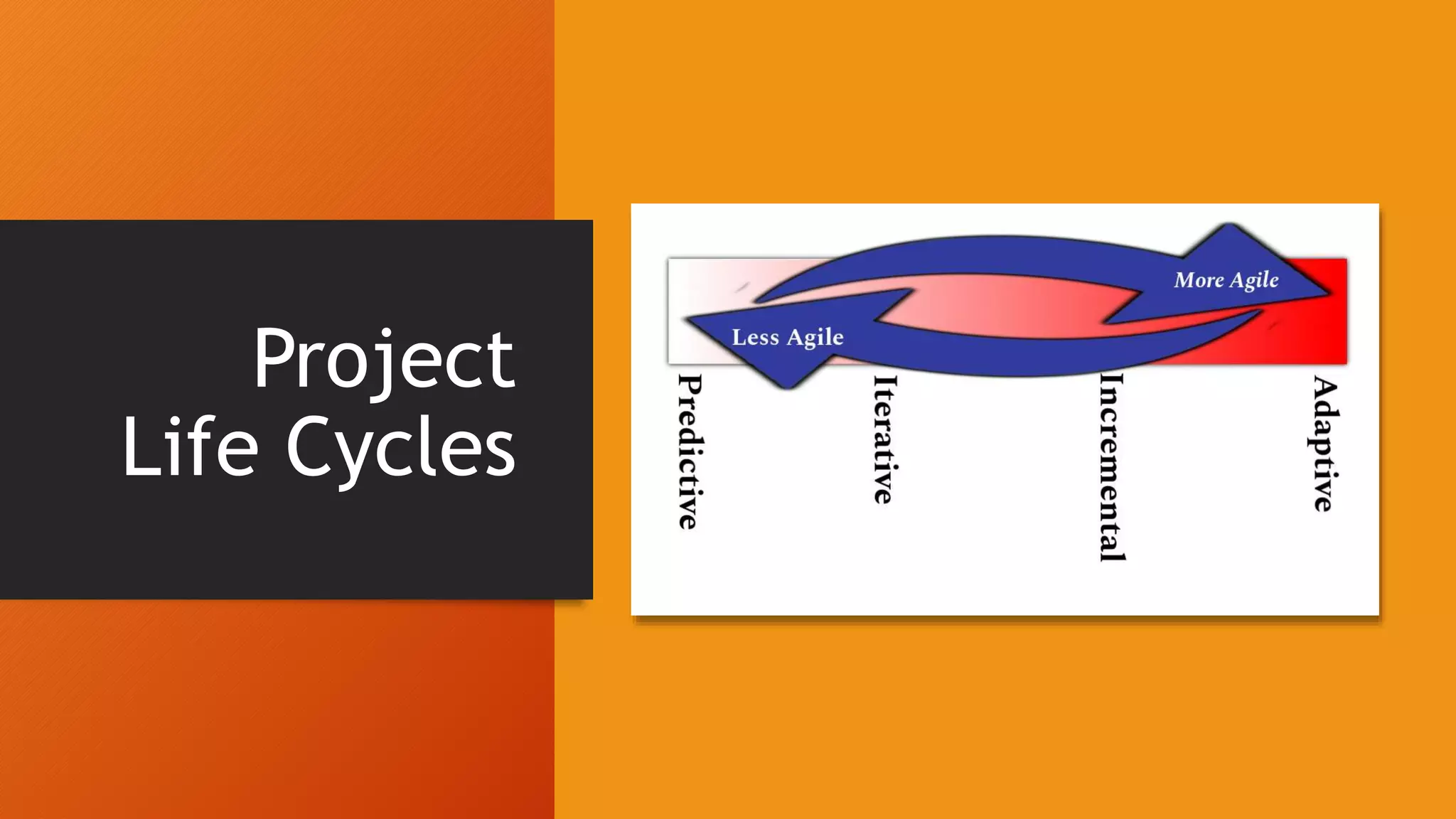

Life Cycles

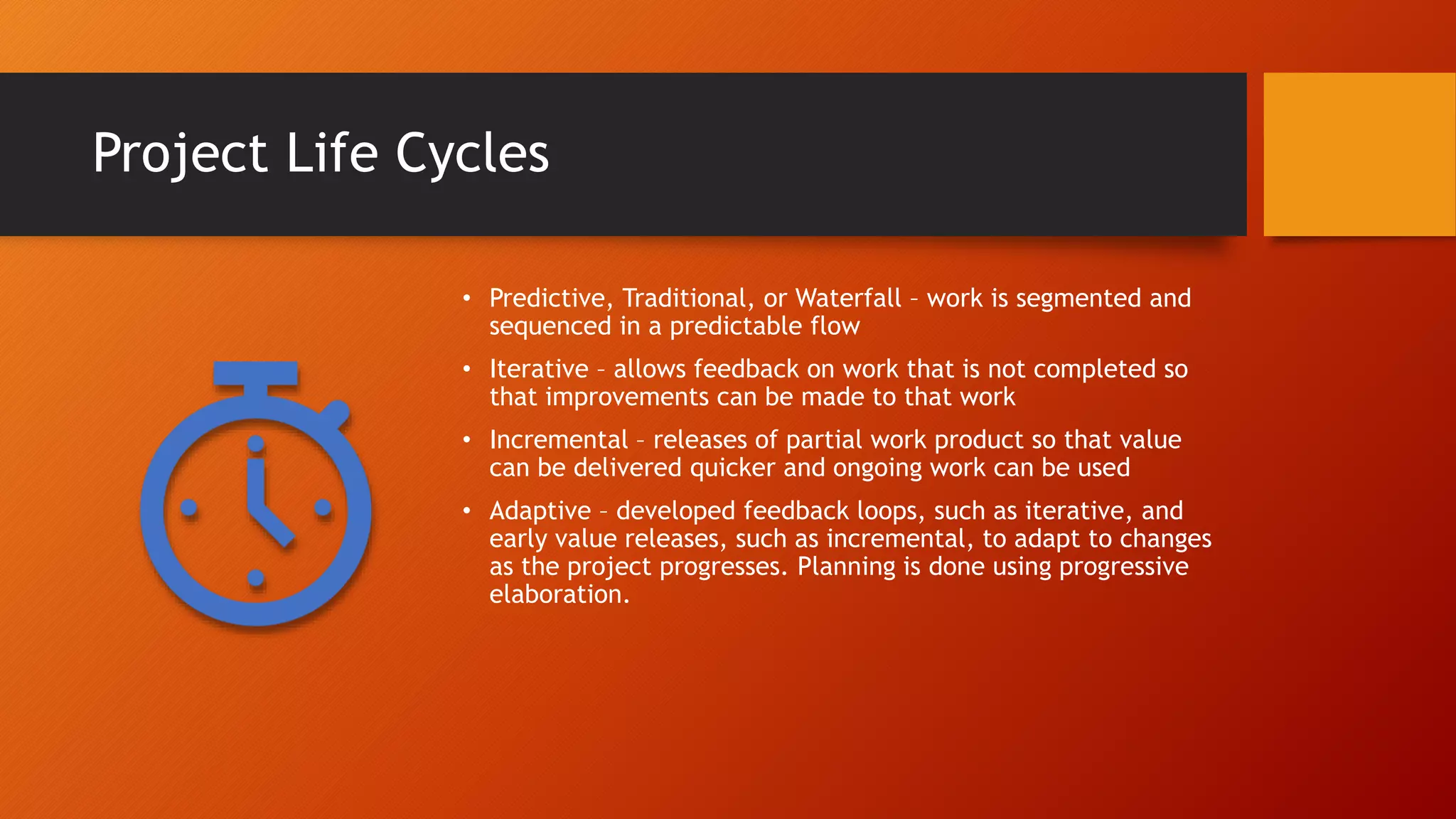

Project Life Cycles
• Predictive, Traditional, or Waterfall – work is segmented and
sequenced in a predictable flow
• Iterative – allows feedback on work that is not completed so
that improvements can be made to that work
• Incremental – releases of partial work product so that value
can be delivered quicker and ongoing work can be used
• Adaptive – developed feedback loops, such as iterative, and
early value releases, such as incremental, to adapt to changes
as the project progresses. Planning is done using progressive
elaboration.
Lean

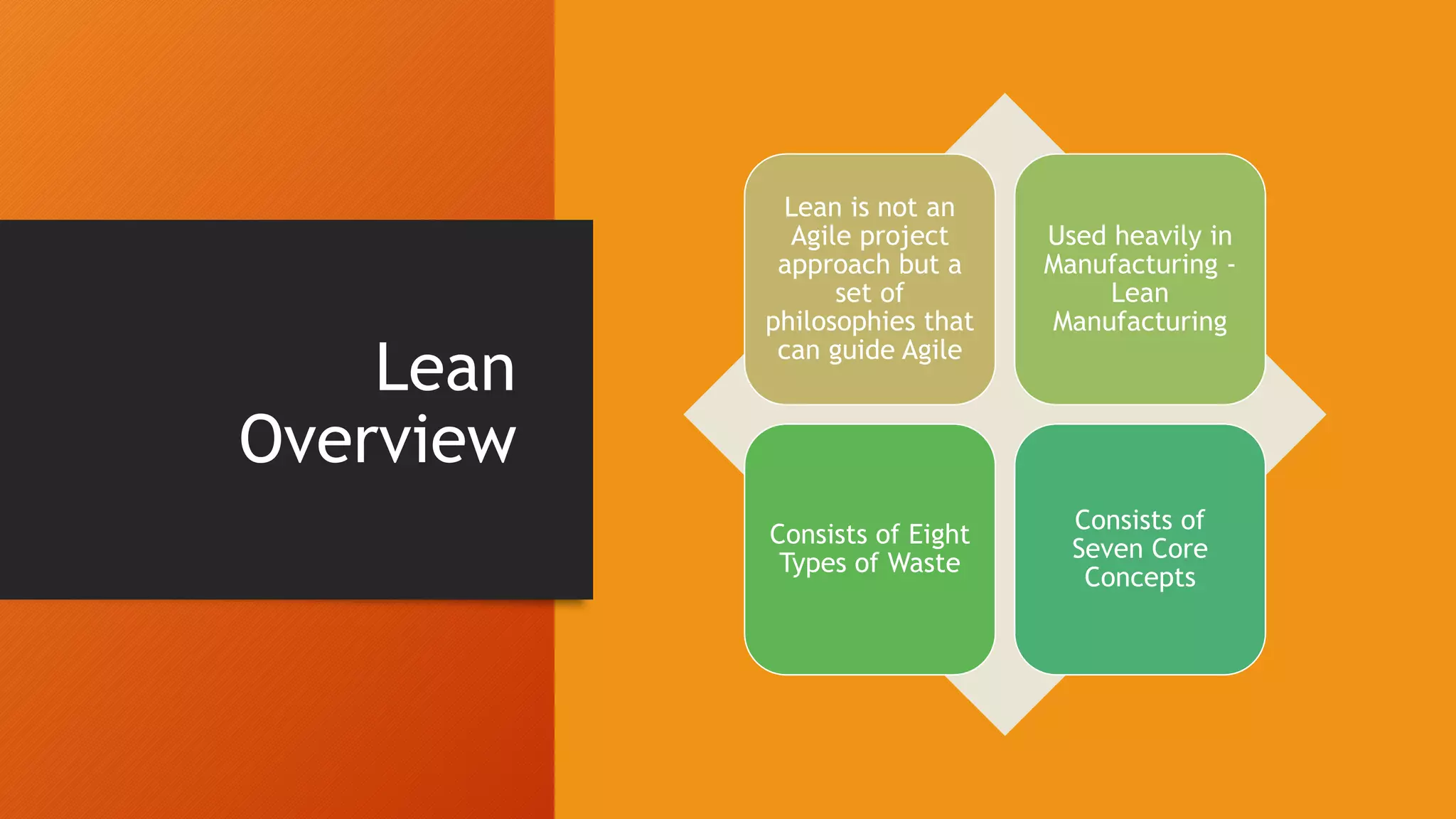

Lean
Overview
Lean is not an
Agile project
approach but a
set of
philosophies that
can guide Agile
Used heavily in
Manufacturing -
Lean
Manufacturing
Consists of Eight
Types of Waste
Consists of
Seven Core
Concepts

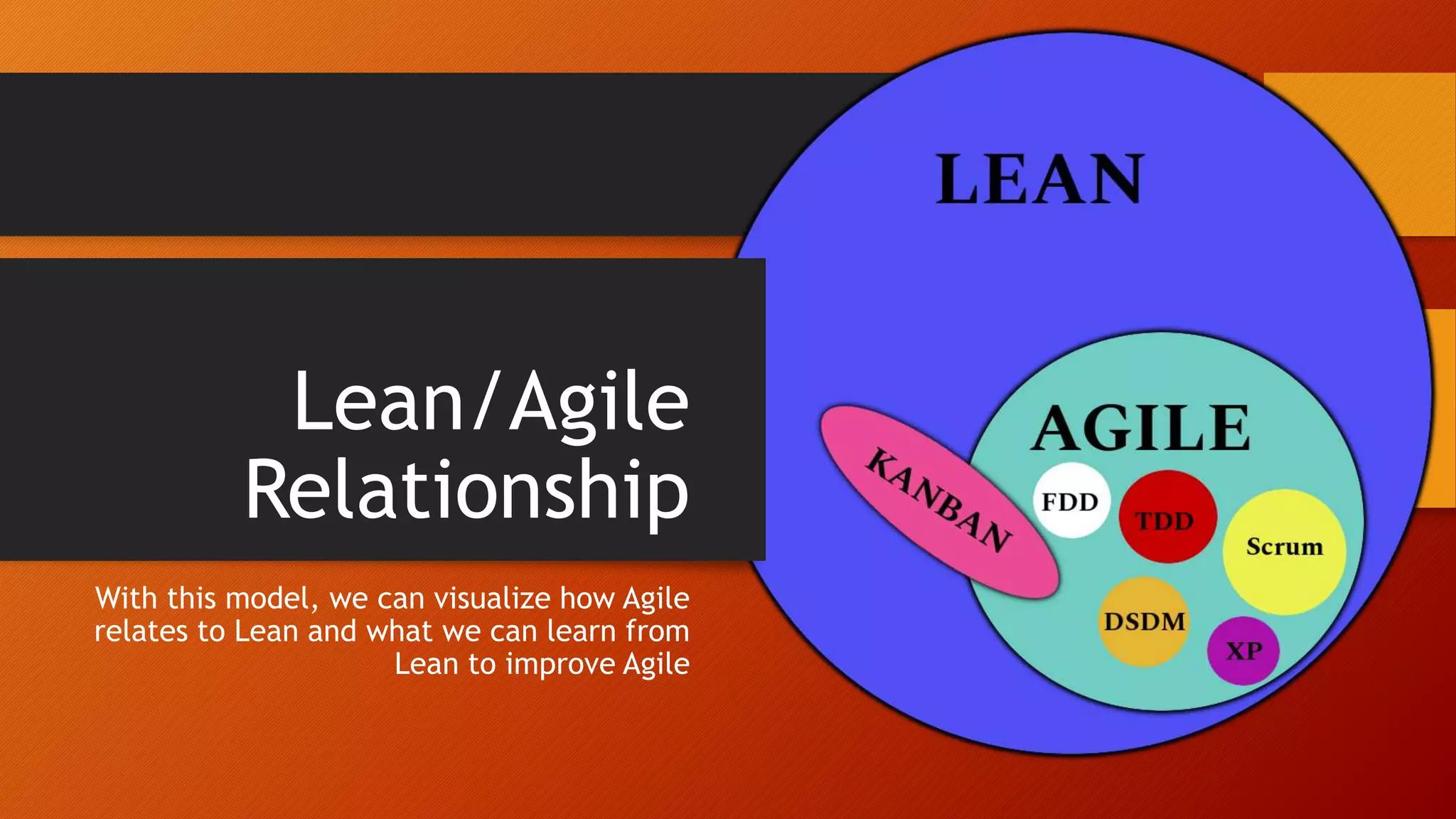

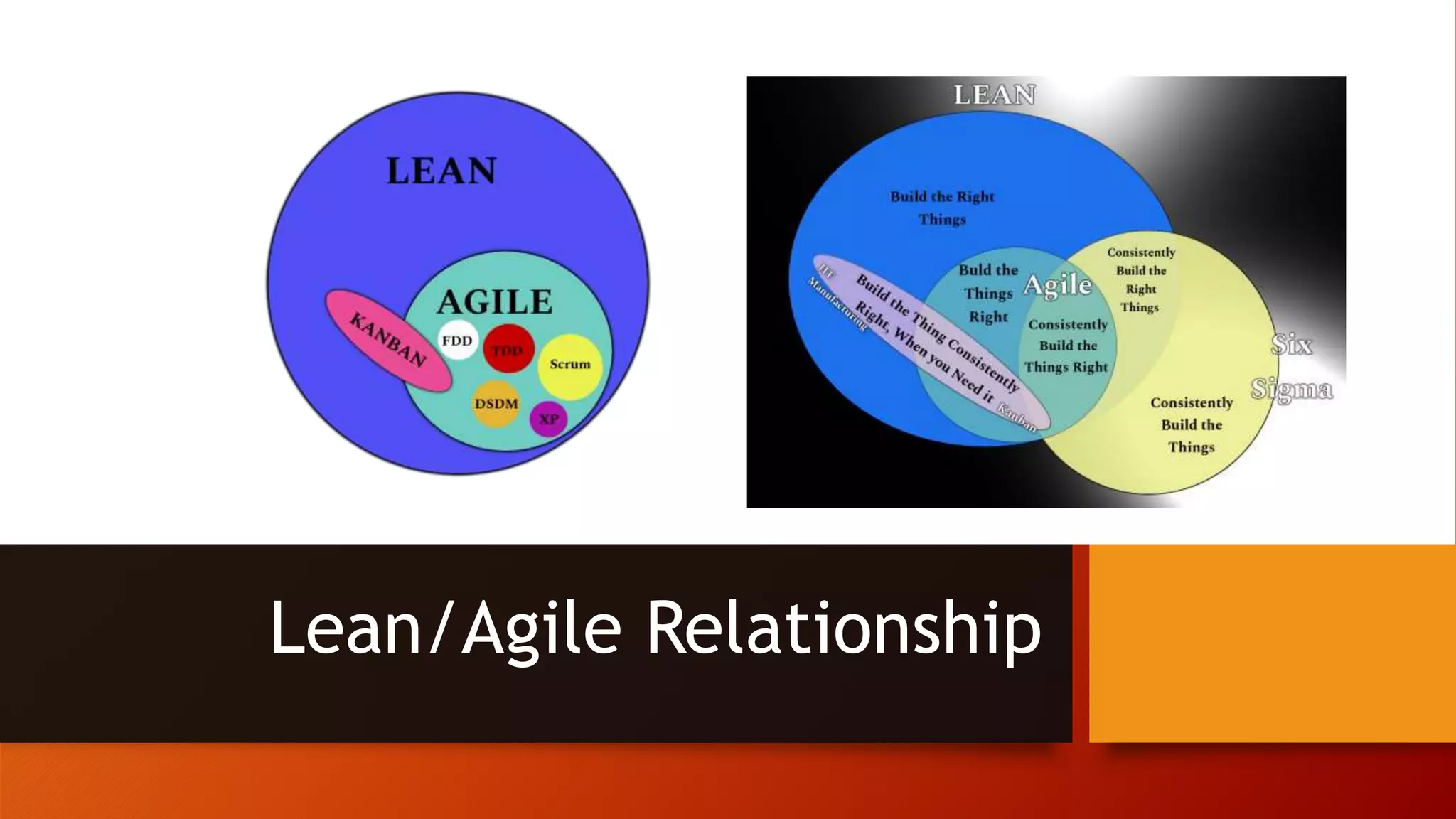

Lean/Agile Relationship
Lean/Agile
Relationship
With this model, we can visualize how Agile
relates to Lean and what we can learn from
Lean to improve Agile

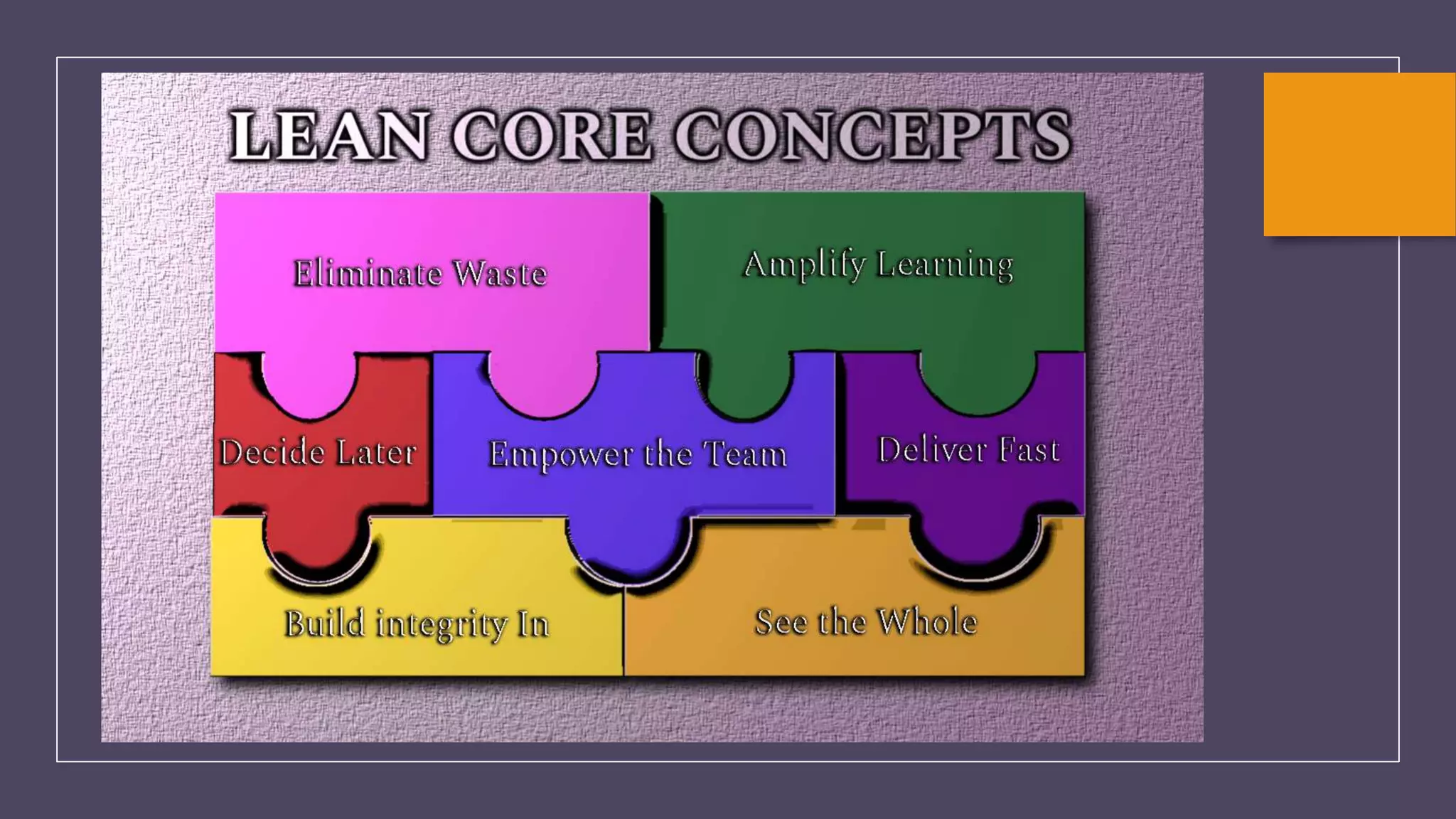

Lean Seven Core Concepts
Eliminate Waste
•Maximize value by
minimizing waste
Amplify Learning
•Facilitate
Communication and
elicit feedback
Decide Later
•Defer Decisions as long
as Responsibly Possible
Deliver Fast
•Maximize Return by
gaining value quicker
Empower the Team
•Give them the
knowledge, tools, and
environment to do their
work
Build Integrity In
•Test throughout the
process
See The Whole
•Be Aware of the entire
system, not just the
individual parts

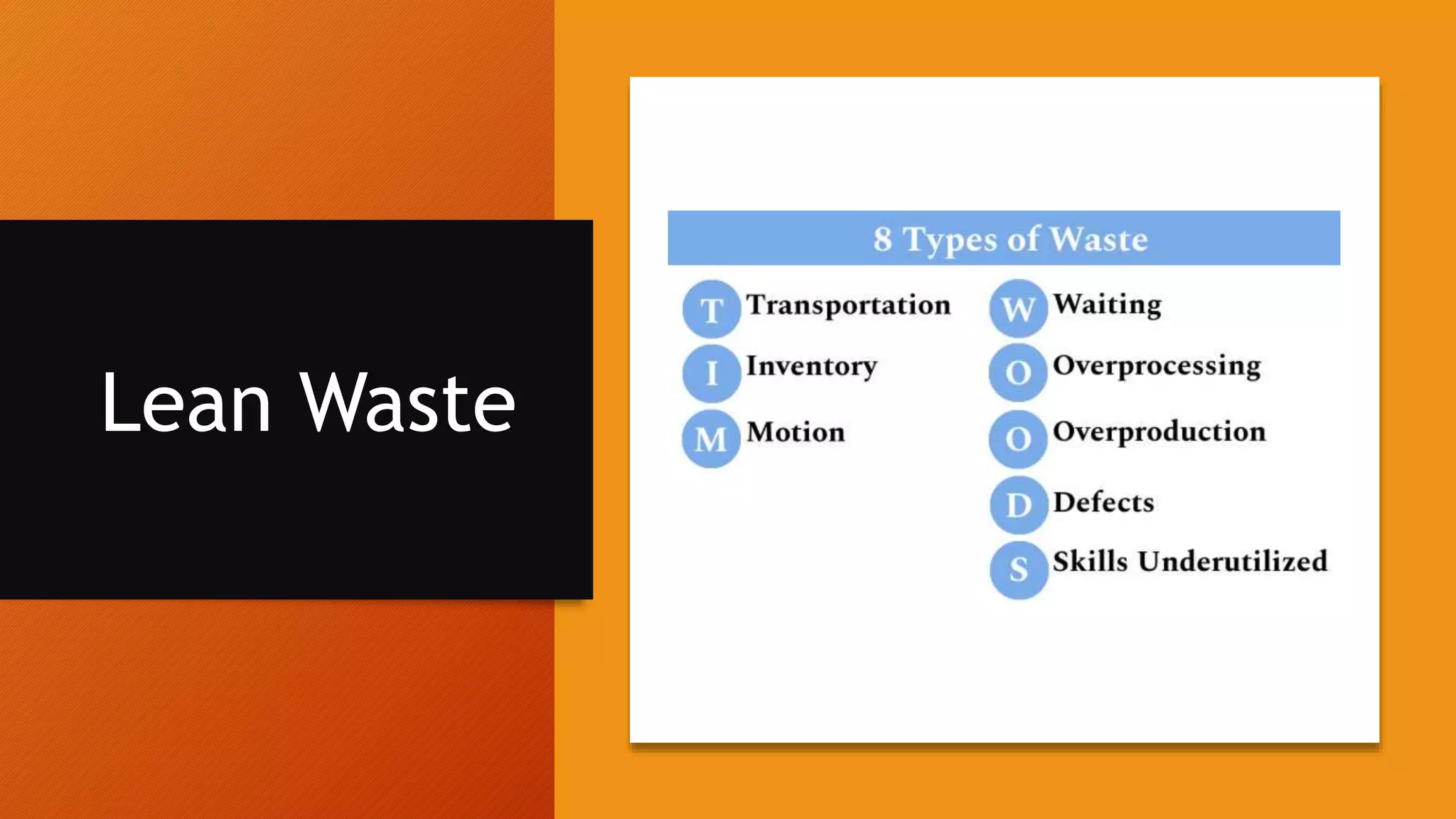

Lean Waste

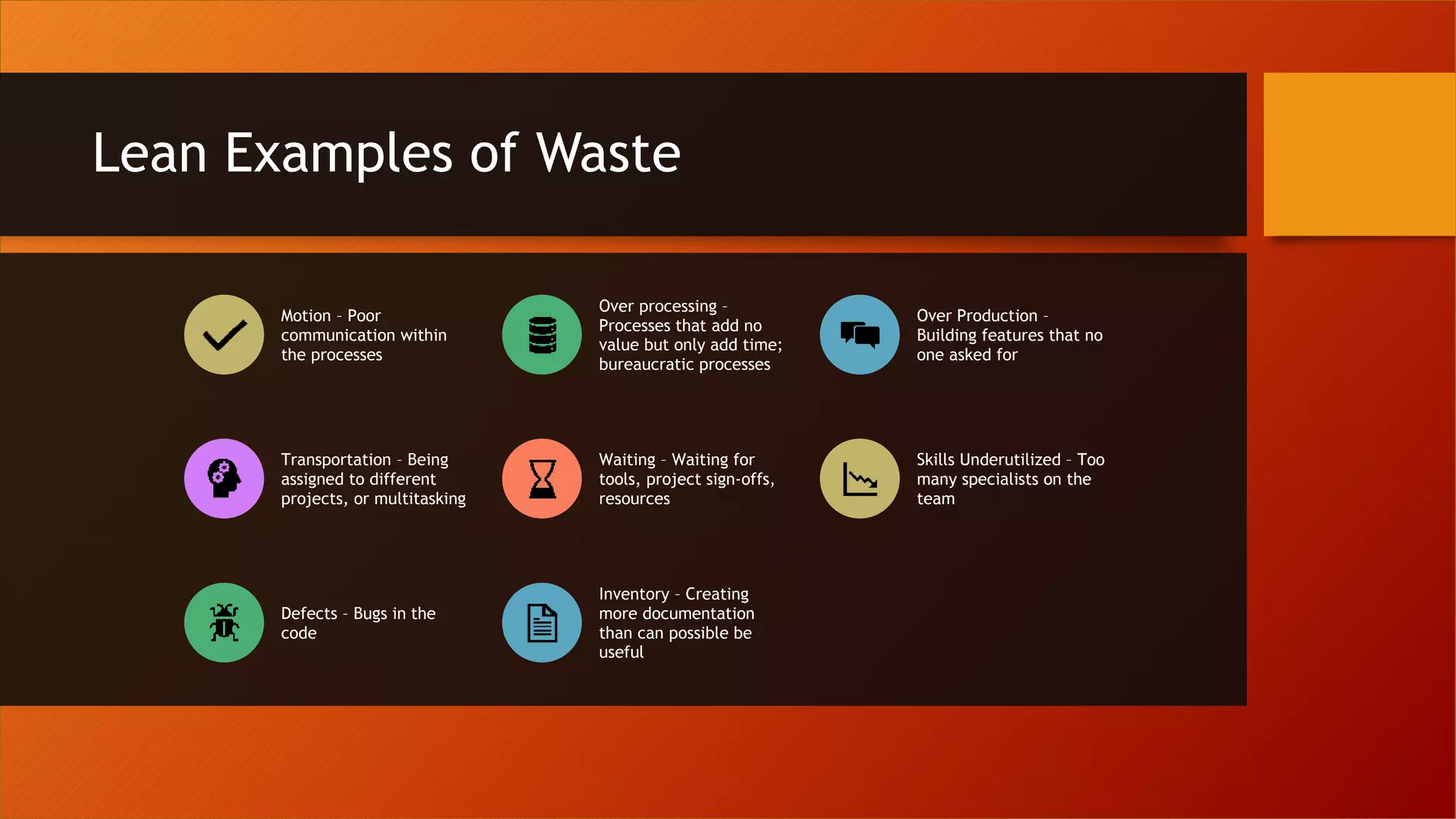

Lean Examples of Waste
Motion – Poor
communication within
the processes
Over processing –
Processes that add no
value but only add time;
bureaucratic processes
Over Production –
Building features that no
one asked for
Transportation – Being
assigned to different
projects, or multitasking
Waiting – Waiting for
tools, project sign-offs,
resources
Skills Underutilized – Too
many specialists on the
team
Defects – Bugs in the
code
Inventory – Creating
more documentation
than can possible be
useful
Scrum
Scrum
Overview
Lightweight Framework for developing and
sustaining complex products
Lightweight; Simple to understand; difficult
to master
Three Pillars to Scrum Philosophy
Five Values
Three roles on the Scrum team

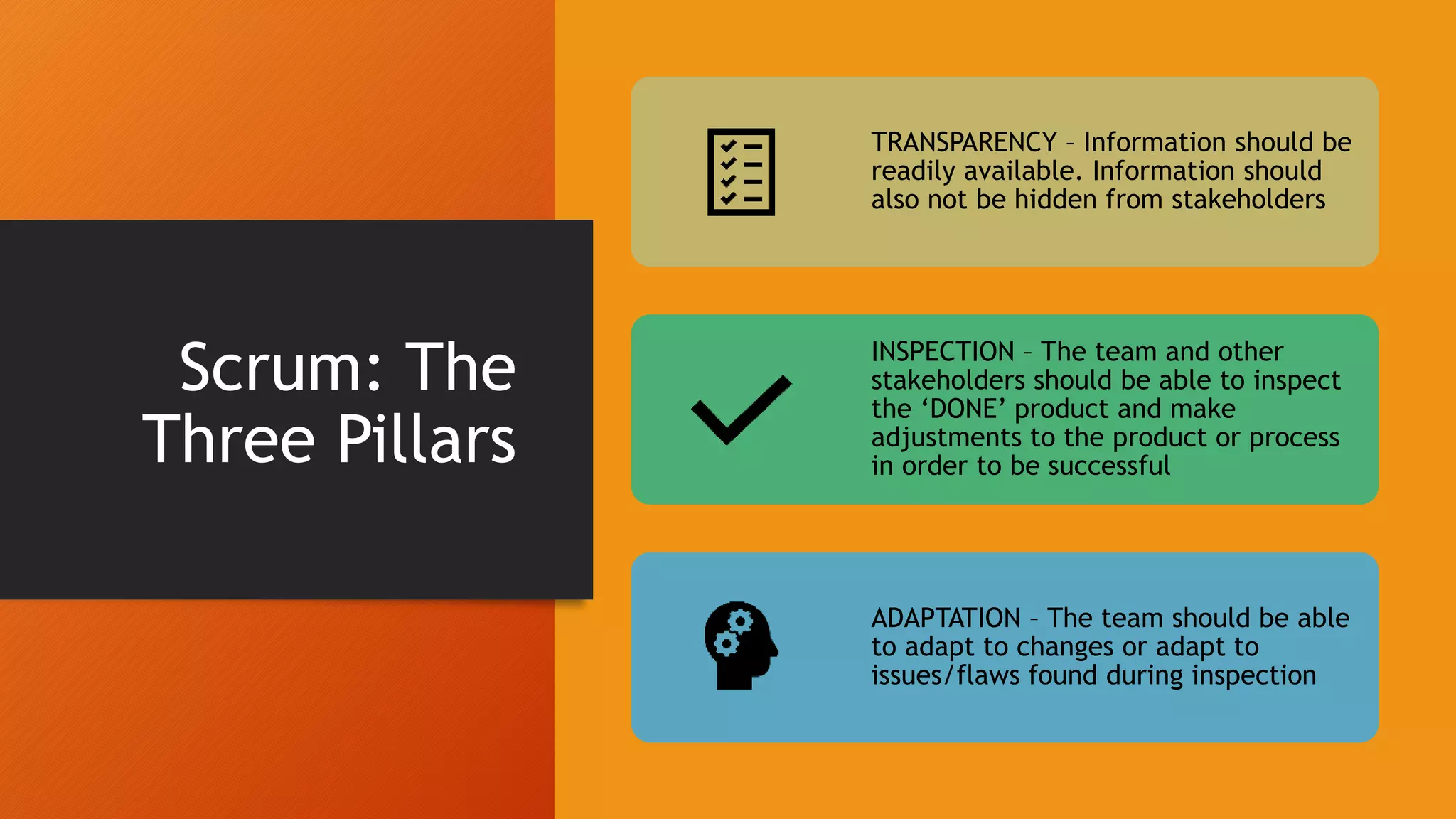

Scrum: The
Three Pillars
TRANSPARENCY – Information should be
readily available. Information should
also not be hidden from stakeholders
INSPECTION – The team and other
stakeholders should be able to inspect
the ‘DONE’ product and make
adjustments to the product or process
in order to be successful
ADAPTATION – The team should be able
to adapt to changes or adapt to
issues/flaws found during inspection

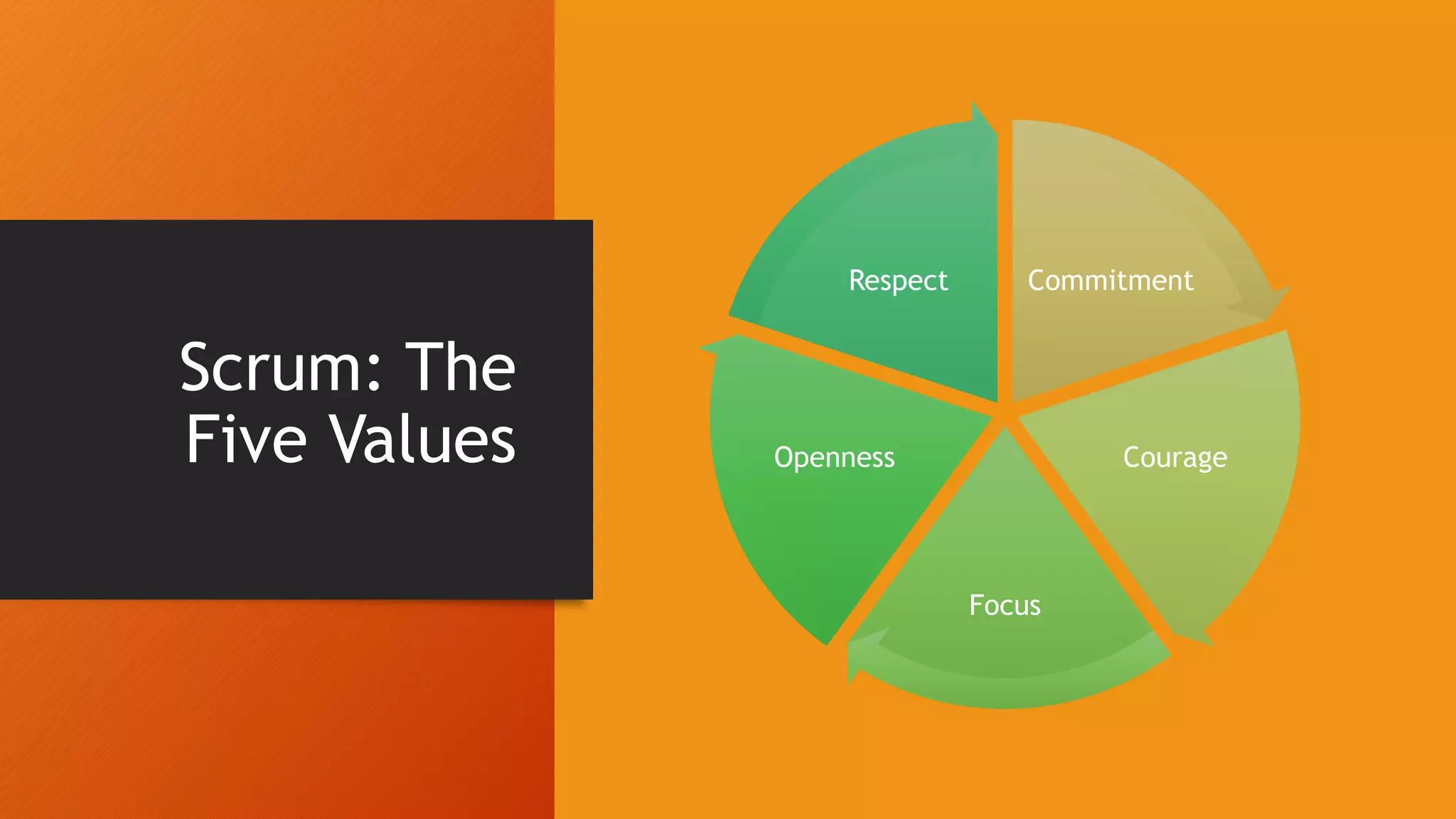

Scrum: The
Five Values
Commitment
Courage
Focus
Openness
Respect

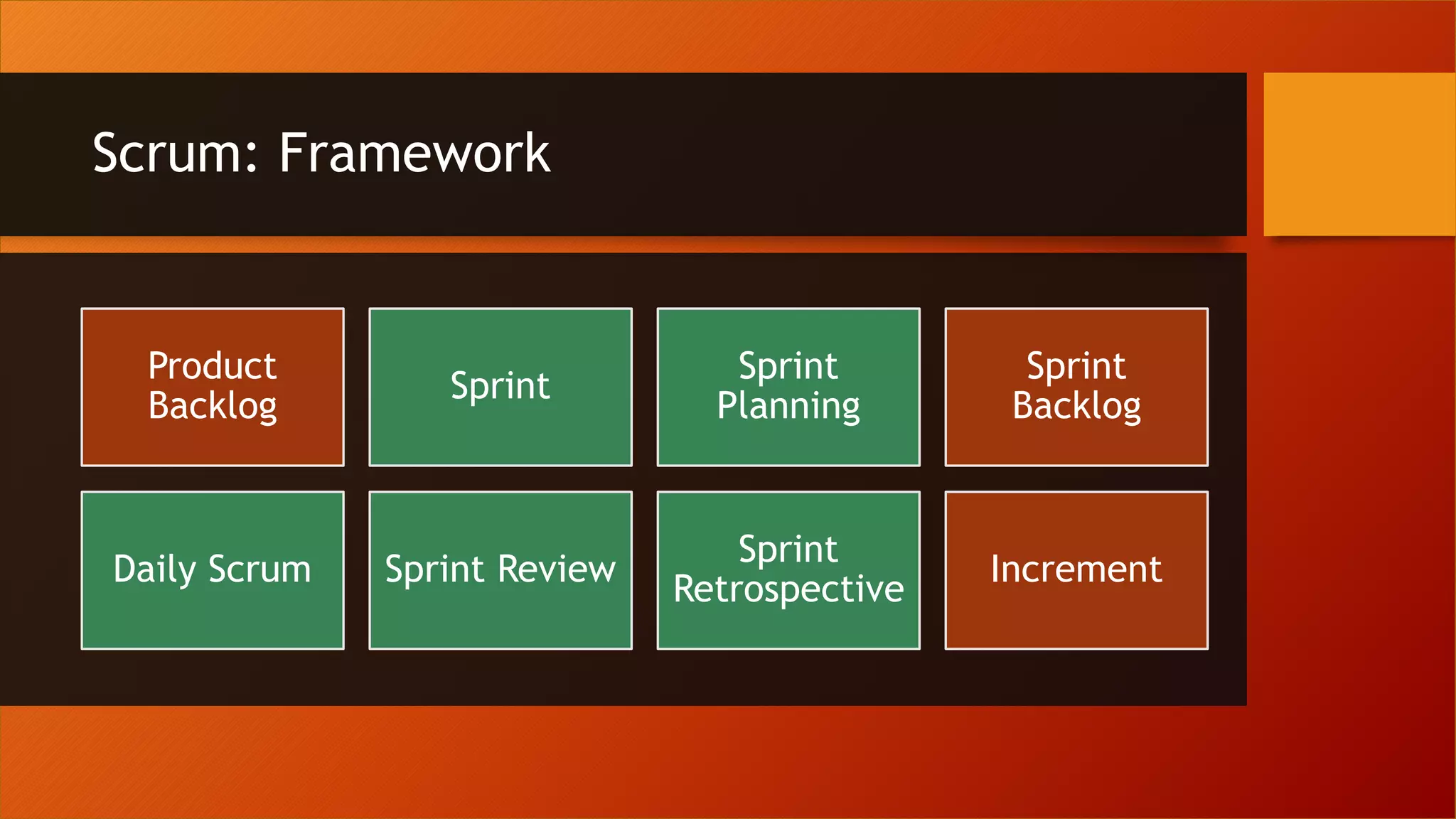

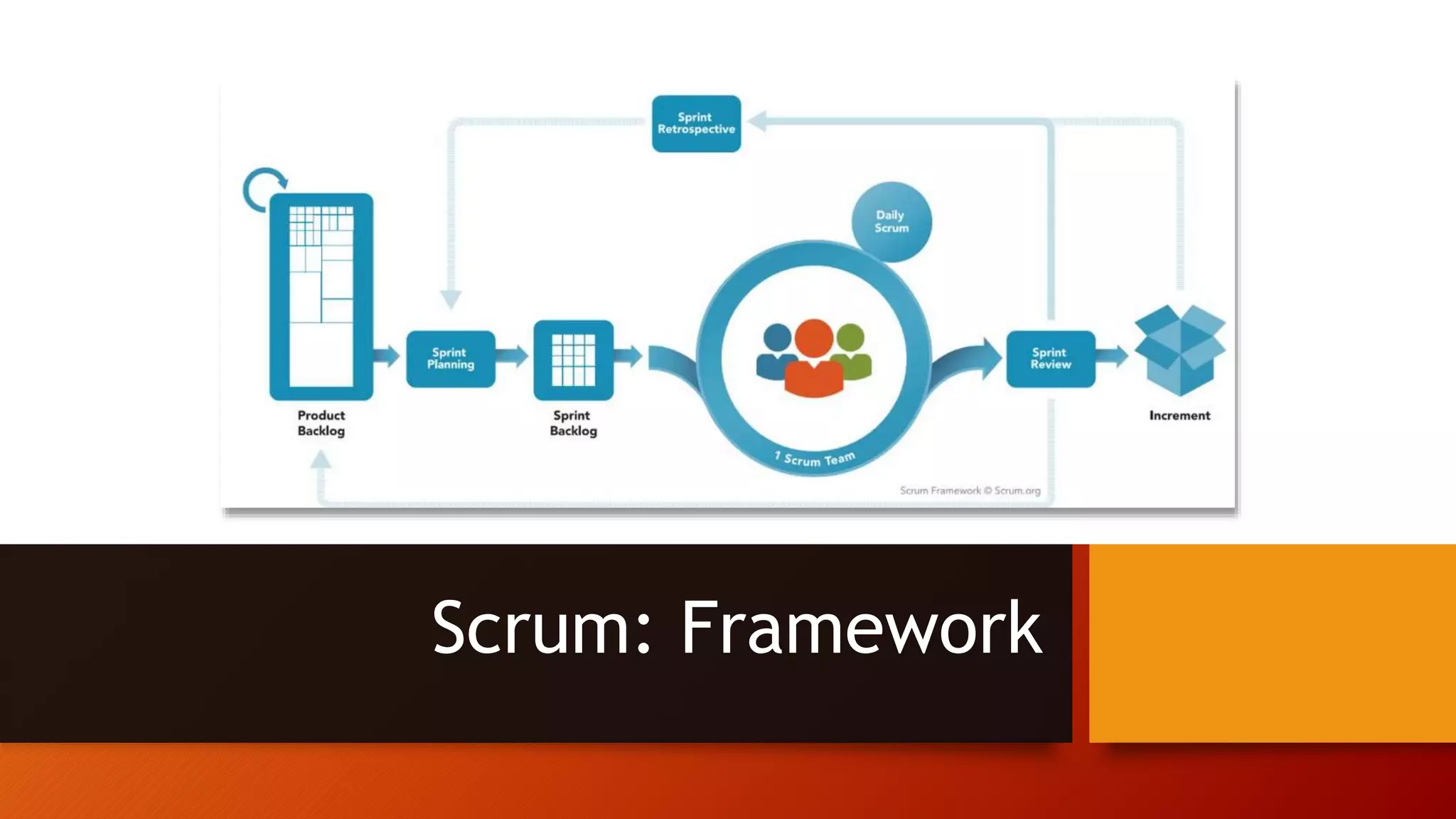

Scrum: Framework
Product
Backlog
Sprint
Sprint
Planning
Sprint
Backlog
Daily Scrum Sprint Review
Sprint
Retrospective
Increment
Scrum: Framework

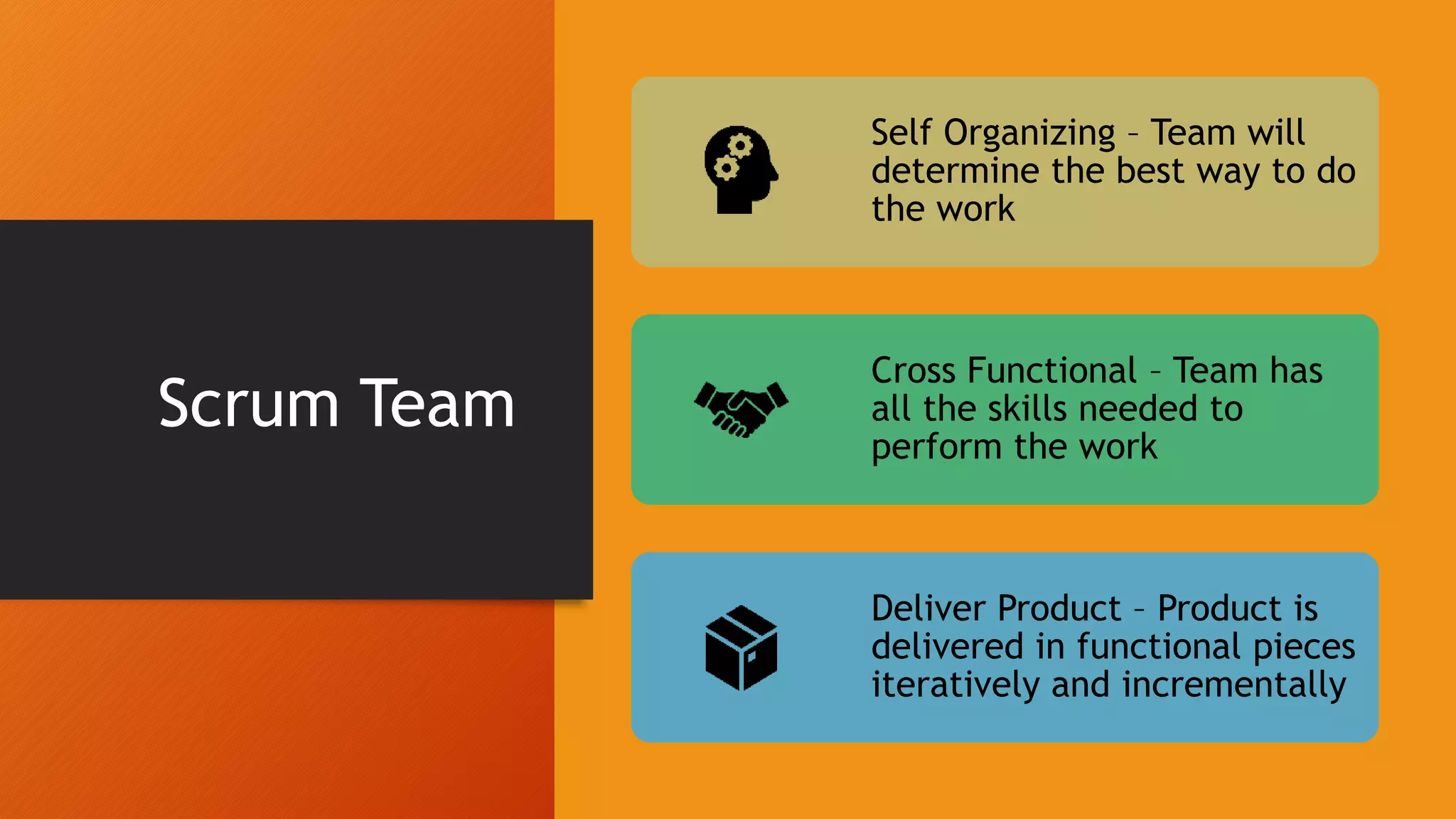

Scrum Team
Self Organizing – Team will
determine the best way to do
the work
Cross Functional – Team has
all the skills needed to
perform the work
Deliver Product – Product is
delivered in functional pieces
iteratively and incrementally

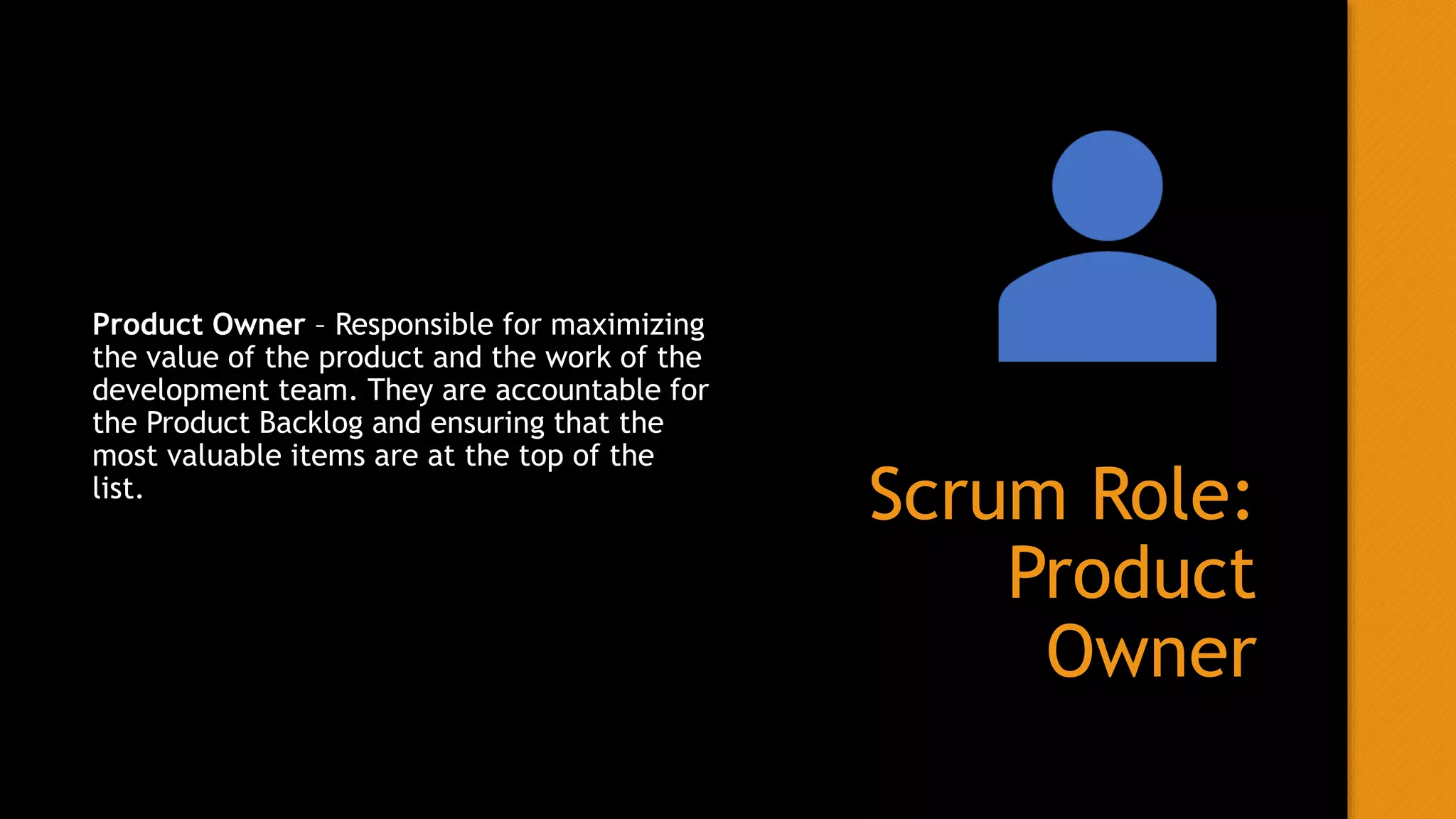

Scrum Role:
Product
Owner
Product Owner – Responsible for maximizing
the value of the product and the work of the
development team. They are accountable for
the Product Backlog and ensuring that the
most valuable items are at the top of the
list.
Scrum Role:
Development
Team
Development Team – The people who do the
actual work of creating and delivering a
potentially releasable increment of a DONE
product. They have no titles other than
“Development Team” and the accountability
of creating a DONE increment belongs to the
team. There are 3-9 people on a Scrum
Development Team.

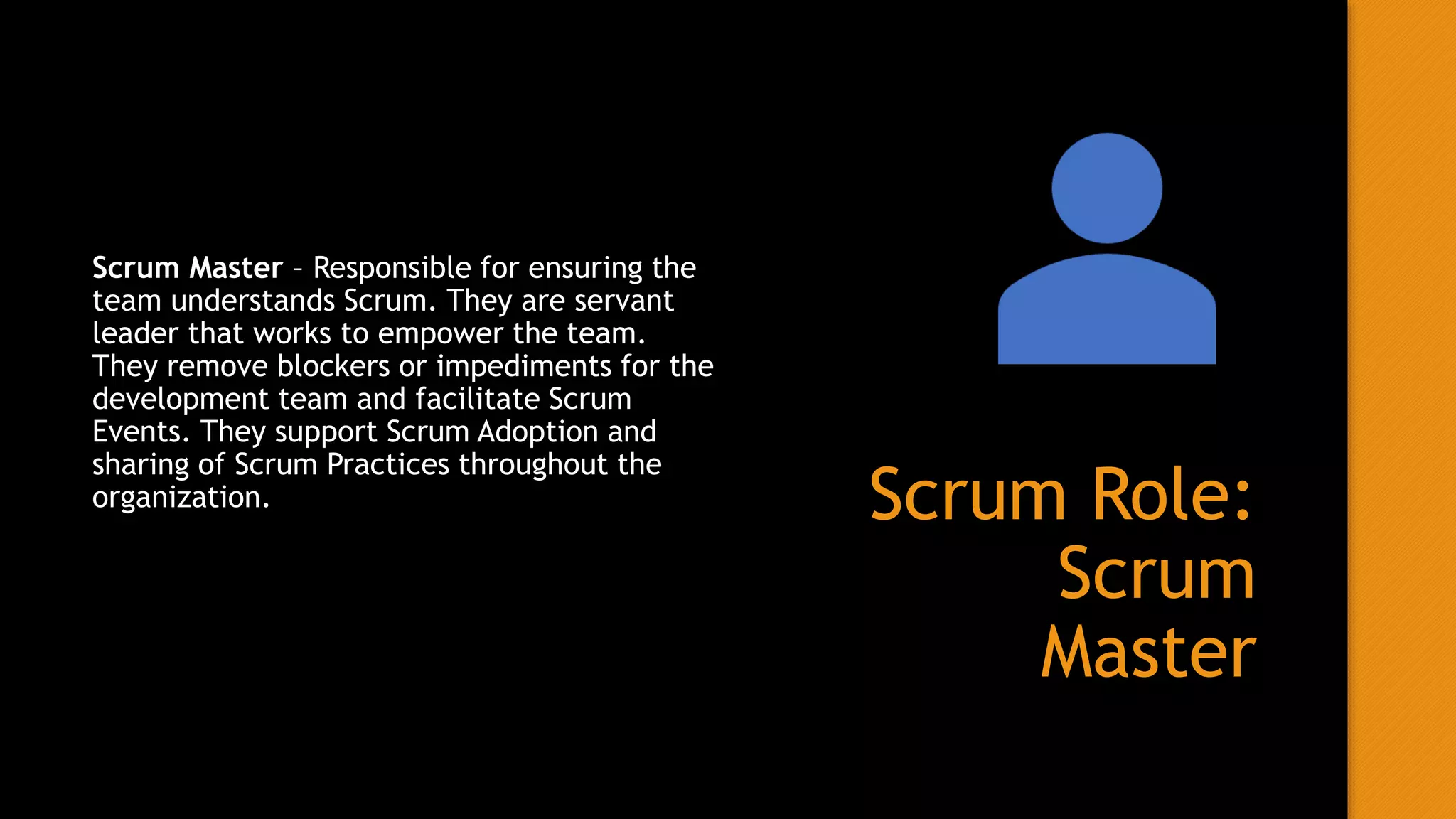

Scrum Role:
Scrum
Master
Scrum Master – Responsible for ensuring the
team understands Scrum. They are servant
leader that works to empower the team.
They remove blockers or impediments for the
development team and facilitate Scrum
Events. They support Scrum Adoption and
sharing of Scrum Practices throughout the
organization.

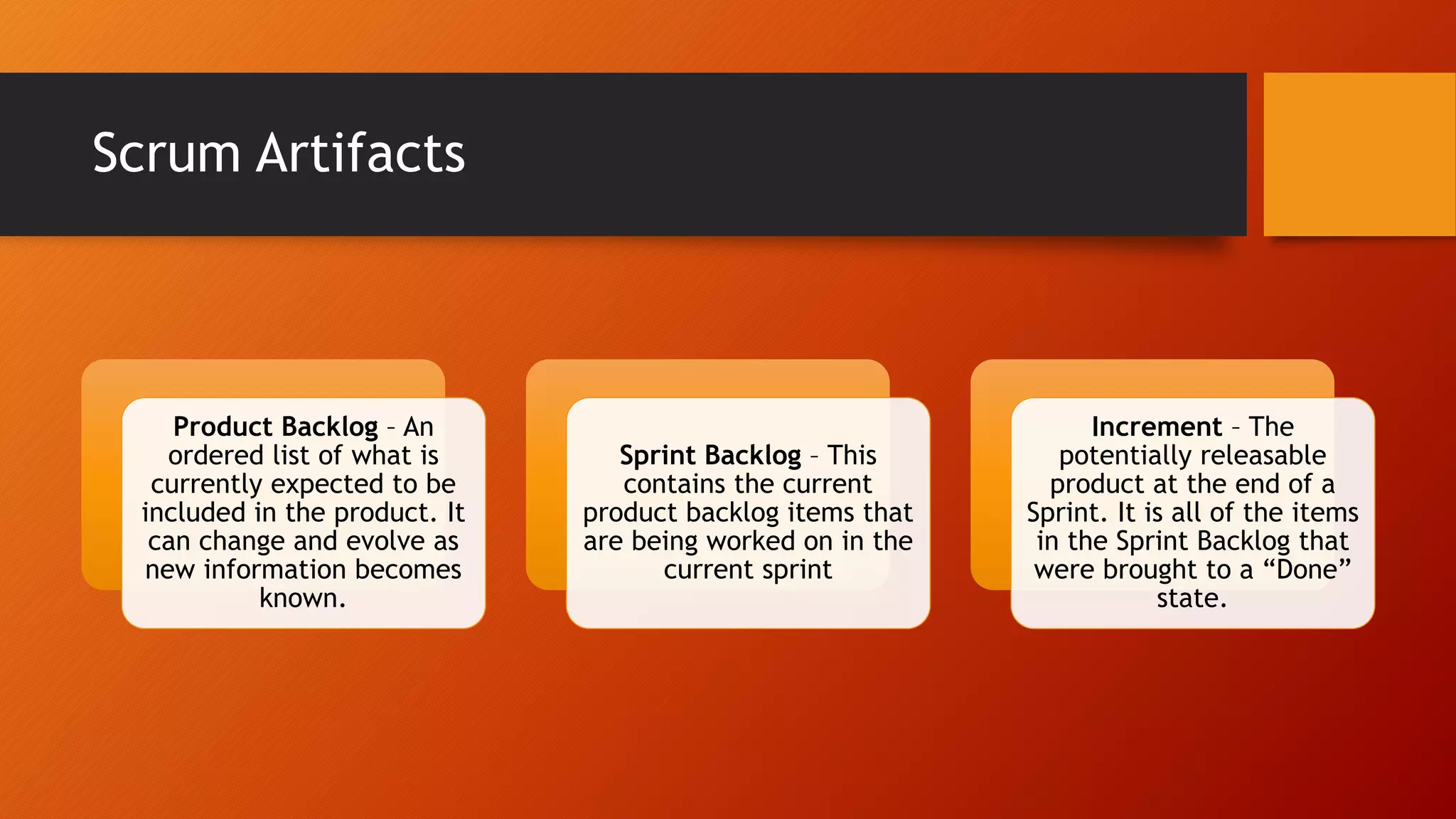

Scrum Artifacts
Product Backlog – An
ordered list of what is
currently expected to be
included in the product. It
can change and evolve as
new information becomes
known.
Sprint Backlog – This
contains the current
product backlog items that
are being worked on in the
current sprint
Increment – The
potentially releasable
product at the end of a
Sprint. It is all of the items
in the Sprint Backlog that
were brought to a “Done”
state.

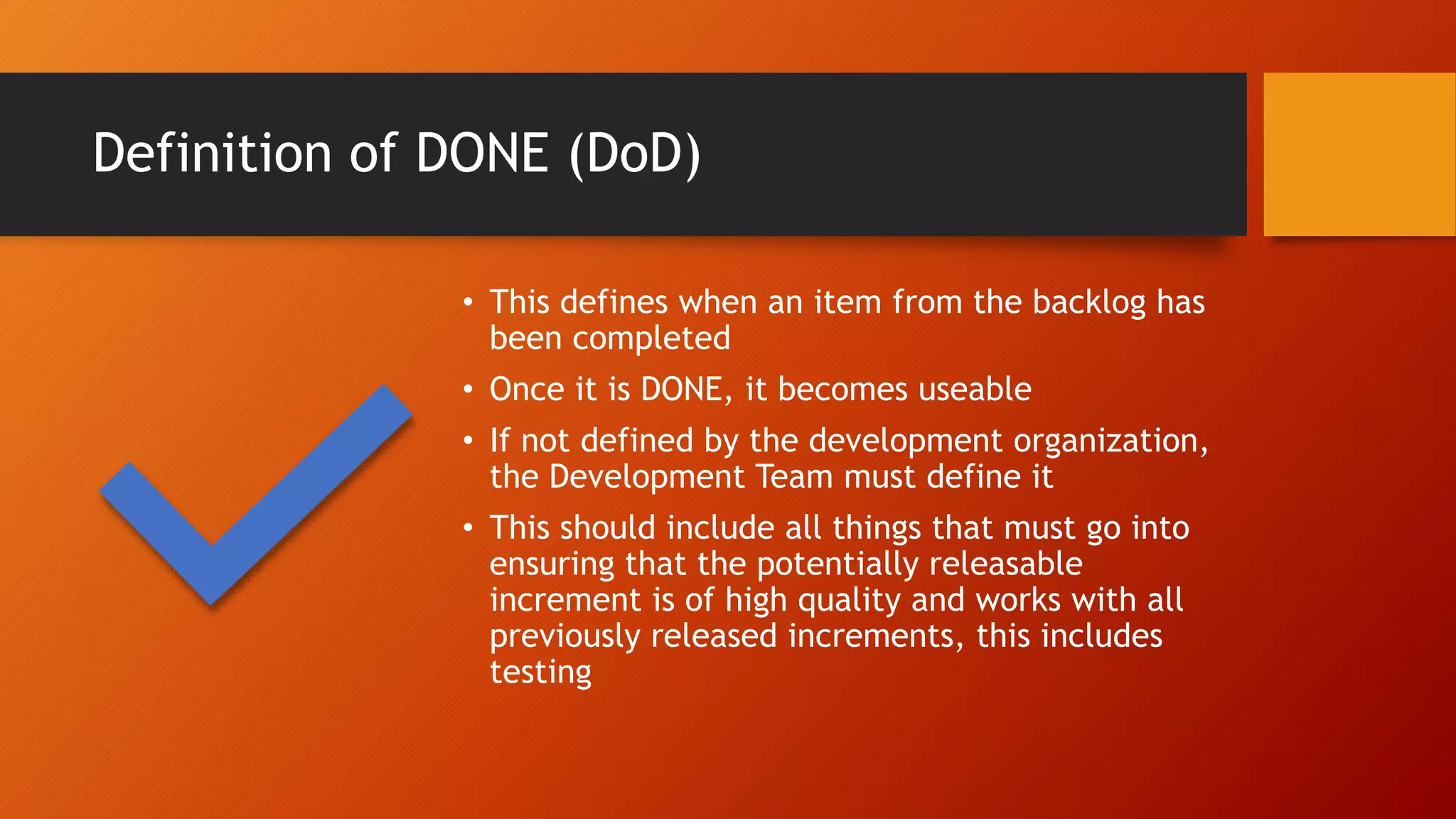

Definition of DONE (DoD)
• This defines when an item from the backlog has
been completed
• Once it is DONE, it becomes useable
• If not defined by the development organization,
the Development Team must define it
• This should include all things that must go into
ensuring that the potentially releasable
increment is of high quality and works with all
previously released increments, this includes
testing

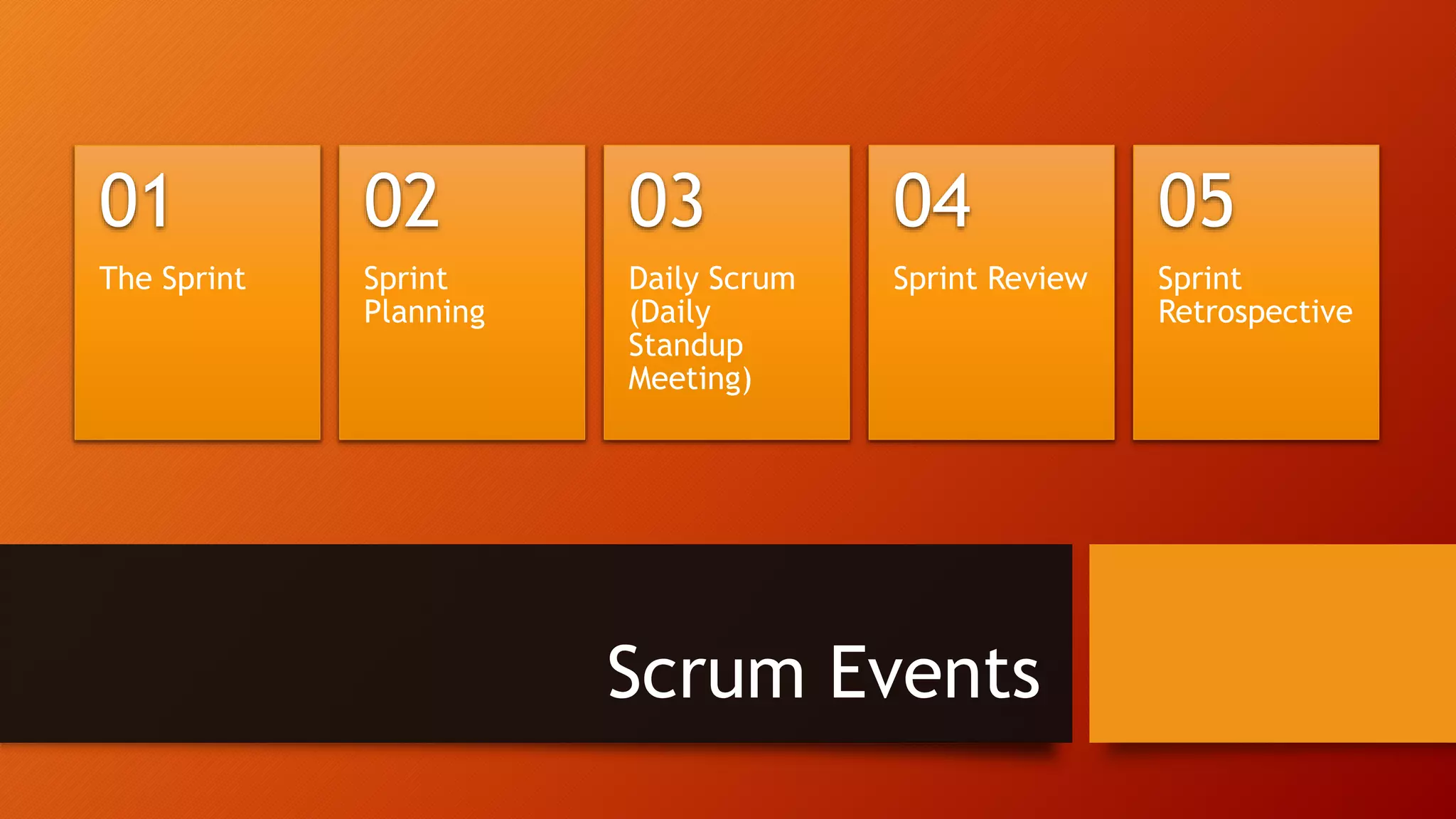

Scrum Events
The Sprint
01
Sprint
Planning
02
Daily Scrum
(Daily
Standup
Meeting)
03
Sprint Review
04
Sprint
Retrospective

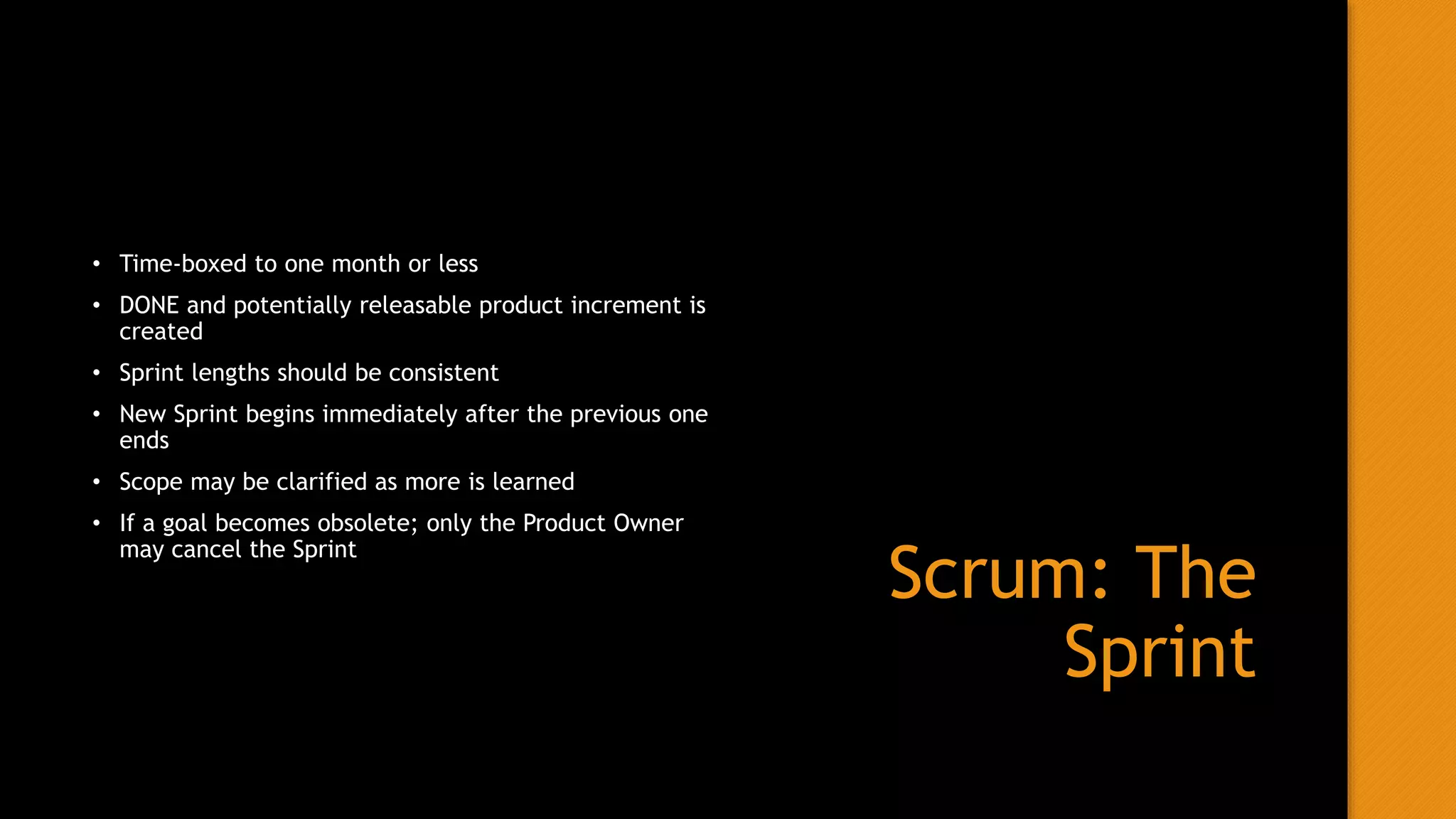

05
Scrum: The
Sprint
• Time-boxed to one month or less
• DONE and potentially releasable product increment is
created
• Sprint lengths should be consistent
• New Sprint begins immediately after the previous one
ends
• Scope may be clarified as more is learned
• If a goal becomes obsolete; only the Product Owner
may cancel the Sprint
Scrum:
Sprint
Planning
• A ceremony to plan the work to be completed within
the Sprint
• Time-Boxed to a maximum of 8 hours for a 1 month
Sprint, this can be less time for shorter sprints
• THE WHAT – What will be worked on?
• The Product Owner will discuss what they would like to
achieve as the Sprint Goal, but only the Development
Team decides on what can be accomplished.
• This will form the Sprint Goal
• THE HOW – How will this be accomplished?
• The team will discuss how they plan to achieve the
Sprint Goal

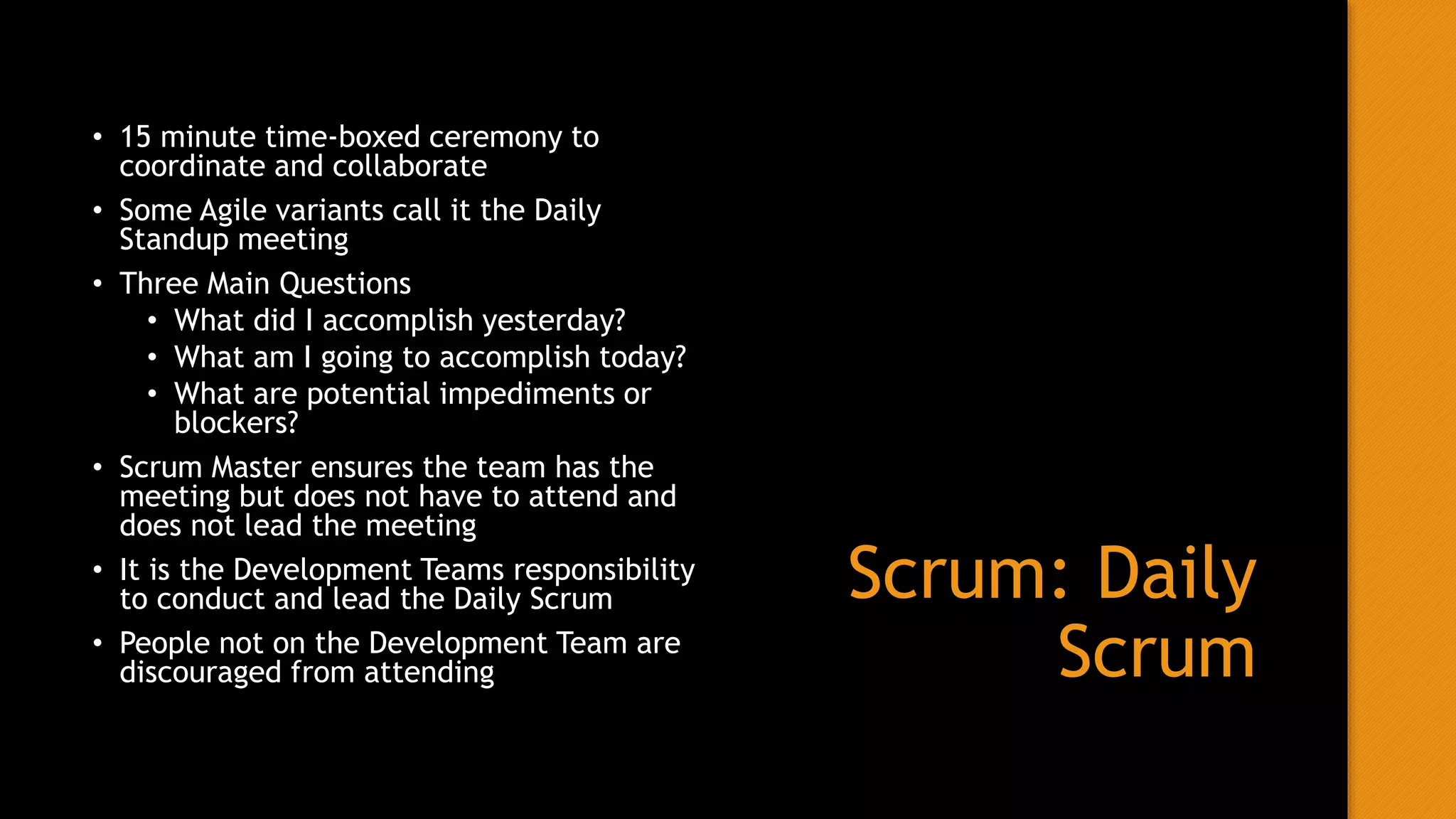

Scrum: Daily
Scrum
• 15 minute time-boxed ceremony to
coordinate and collaborate
• Some Agile variants call it the Daily
Standup meeting
• Three Main Questions
• What did I accomplish yesterday?
• What am I going to accomplish today?
• What are potential impediments or
blockers?
• Scrum Master ensures the team has the
meeting but does not have to attend and
does not lead the meeting
• It is the Development Teams responsibility
to conduct and lead the Daily Scrum
• People not on the Development Team are
discouraged from attending

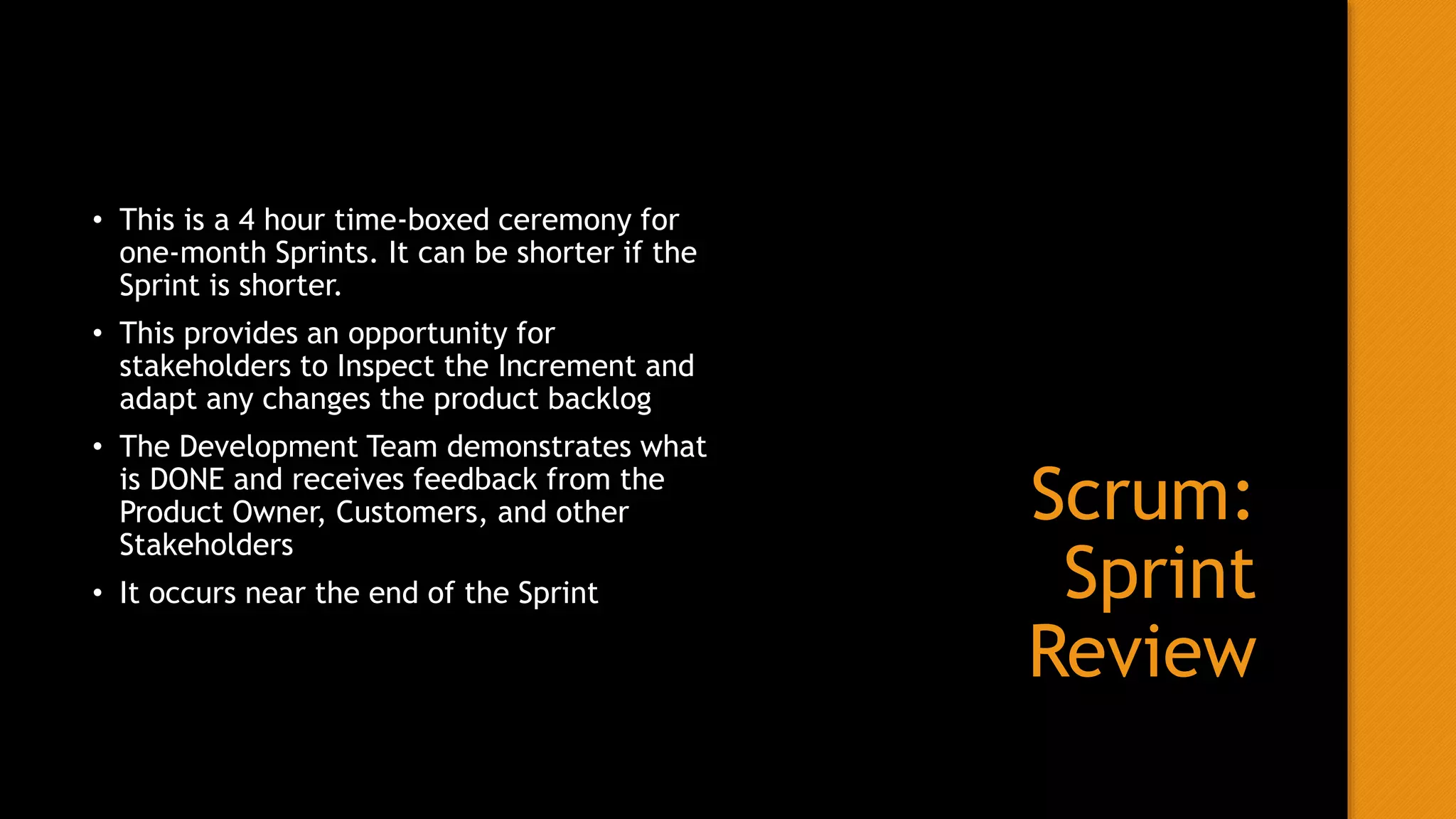

Scrum:
Sprint
Review
• This is a 4 hour time-boxed ceremony for
one-month Sprints. It can be shorter if the
Sprint is shorter.
• This provides an opportunity for
stakeholders to Inspect the Increment and
adapt any changes the product backlog
• The Development Team demonstrates what
is DONE and receives feedback from the
Product Owner, Customers, and other
Stakeholders
• It occurs near the end of the Sprint

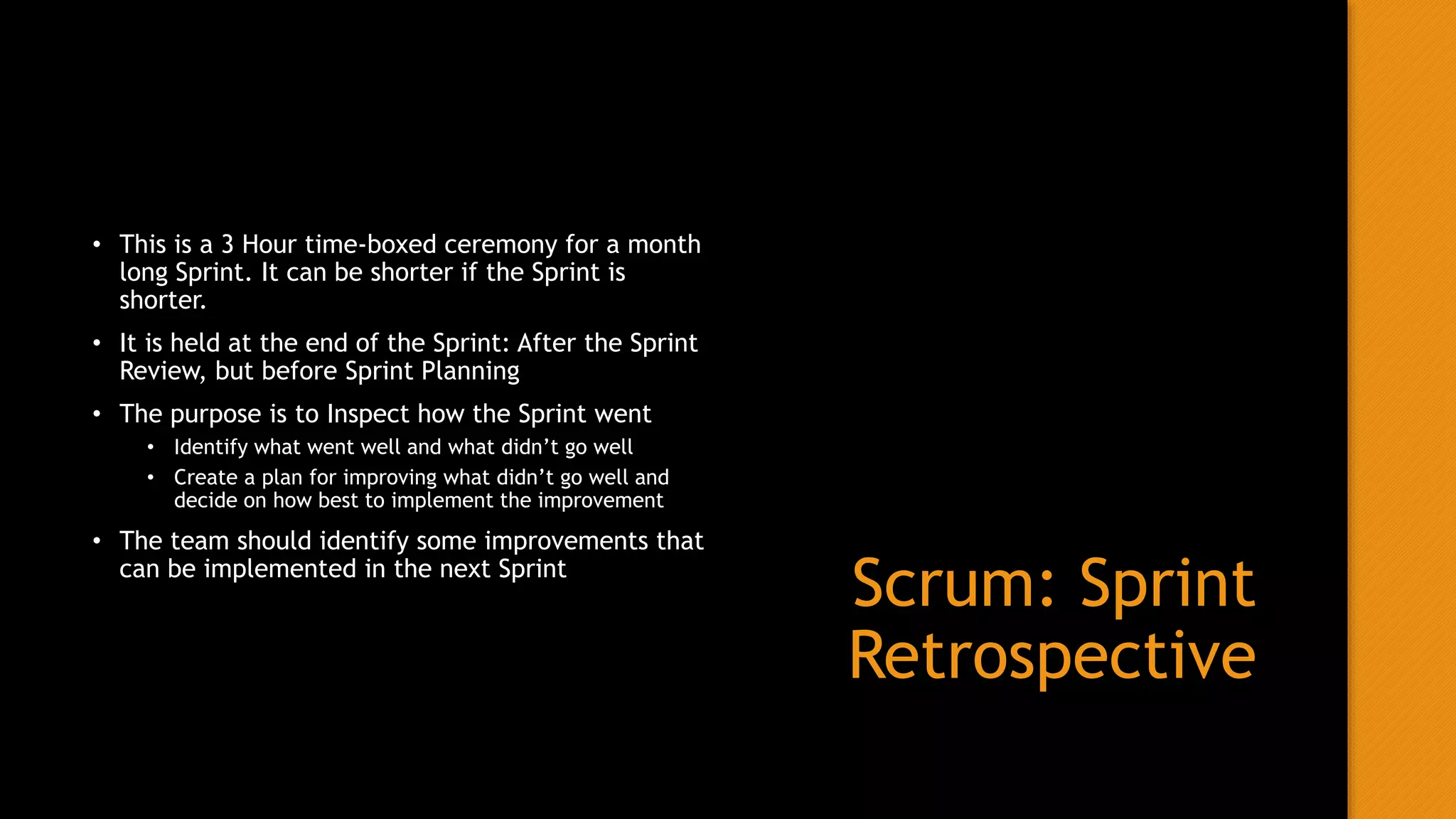

Scrum: Sprint
Retrospective
• This is a 3 Hour time-boxed ceremony for a month
long Sprint. It can be shorter if the Sprint is
shorter.
• It is held at the end of the Sprint: After the Sprint
Review, but before Sprint Planning
• The purpose is to Inspect how the Sprint went
• Identify what went well and what didn’t go well
• Create a plan for improving what didn’t go well and
decide on how best to implement the improvement
• The team should identify some improvements that
can be implemented in the next Sprint
Kanban

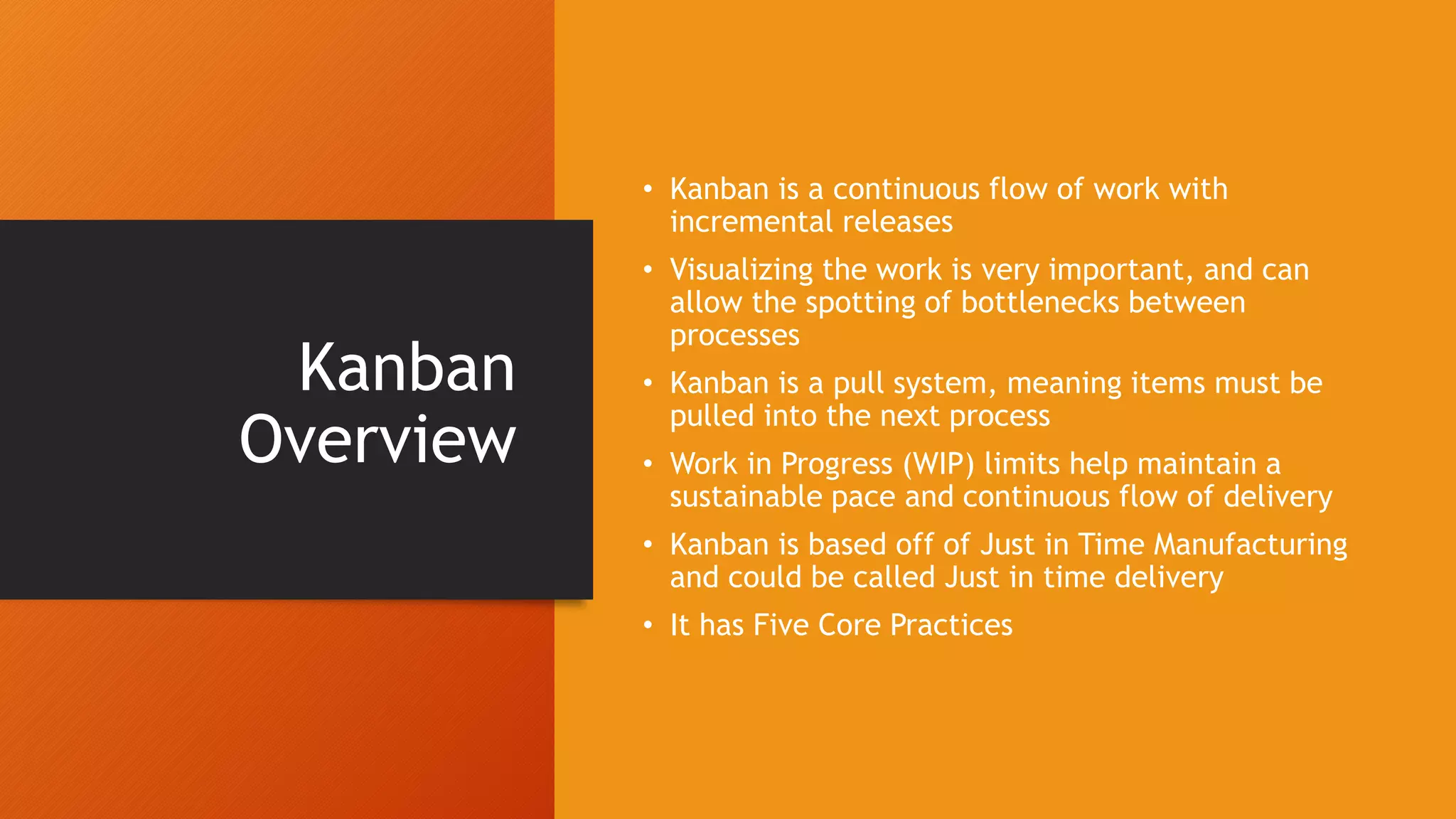

Kanban
Overview
• Kanban is a continuous flow of work with
incremental releases
• Visualizing the work is very important, and can
allow the spotting of bottlenecks between
processes
• Kanban is a pull system, meaning items must be
pulled into the next process
• Work in Progress (WIP) limits help maintain a
sustainable pace and continuous flow of delivery
• Kanban is based off of Just in Time Manufacturing
and could be called Just in time delivery
• It has Five Core Practices
Queueing Theory and Little’s
Law
• The validity of Kanban has been
shown through the studying of lines
• WIP = Throughput * Cycle Time
• Named after John Little
• It defines the relationship between
inventory, the rate of flow, and the
time it takes to complete all the
processes in the flow.
Pull System
The rate of demand
from a process
controls the flow
Items are not
pushed forward to
the next process if
the demand is not
present
Each process works
as an on demand
supplier for the
process next in line

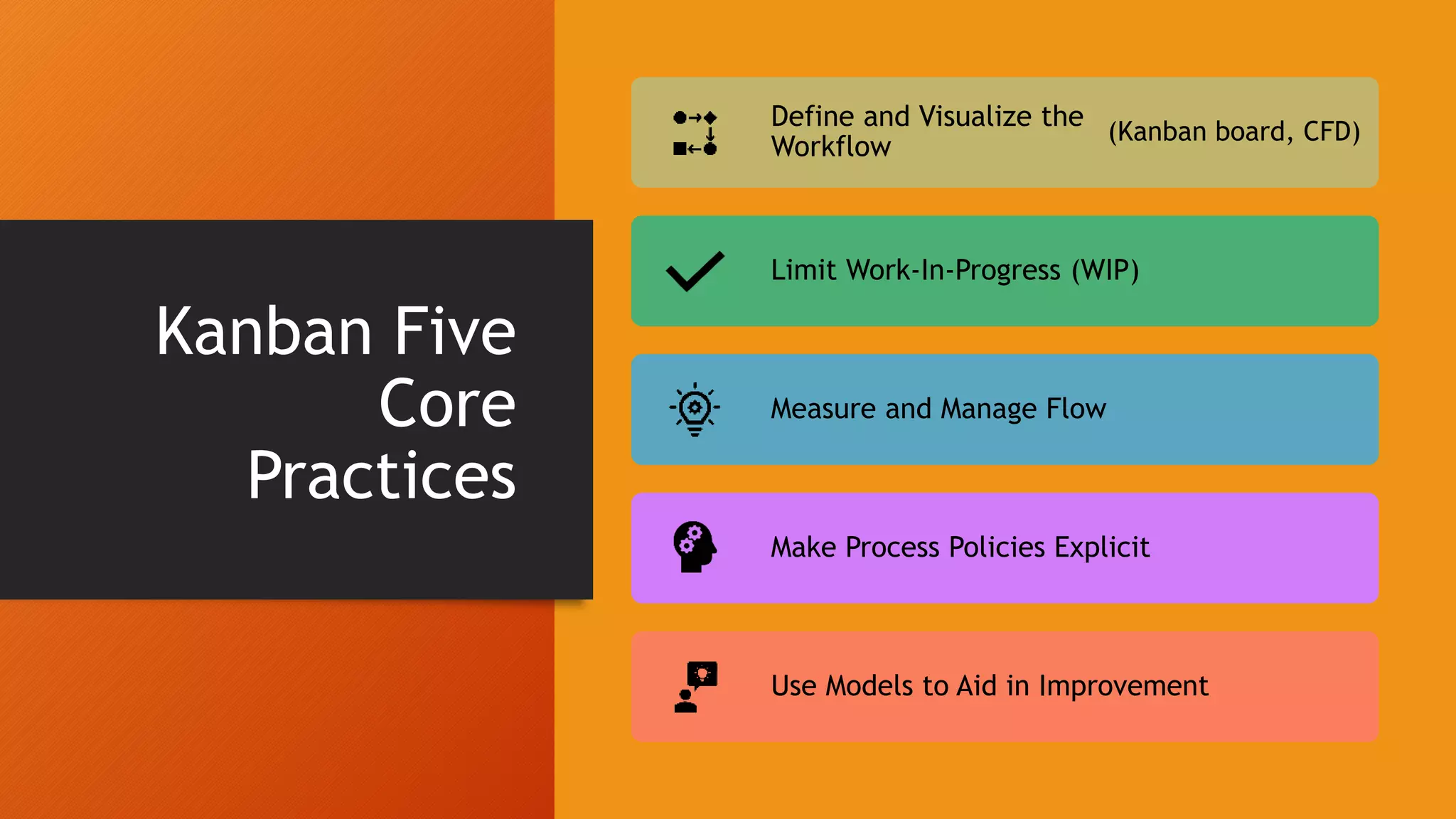

Kanban Five
Core
Practices
Define and Visualize the
Workflow
(Kanban board, CFD)
Limit Work-In-Progress (WIP)
Measure and Manage Flow
Make Process Policies Explicit
Use Models to Aid in Improvement

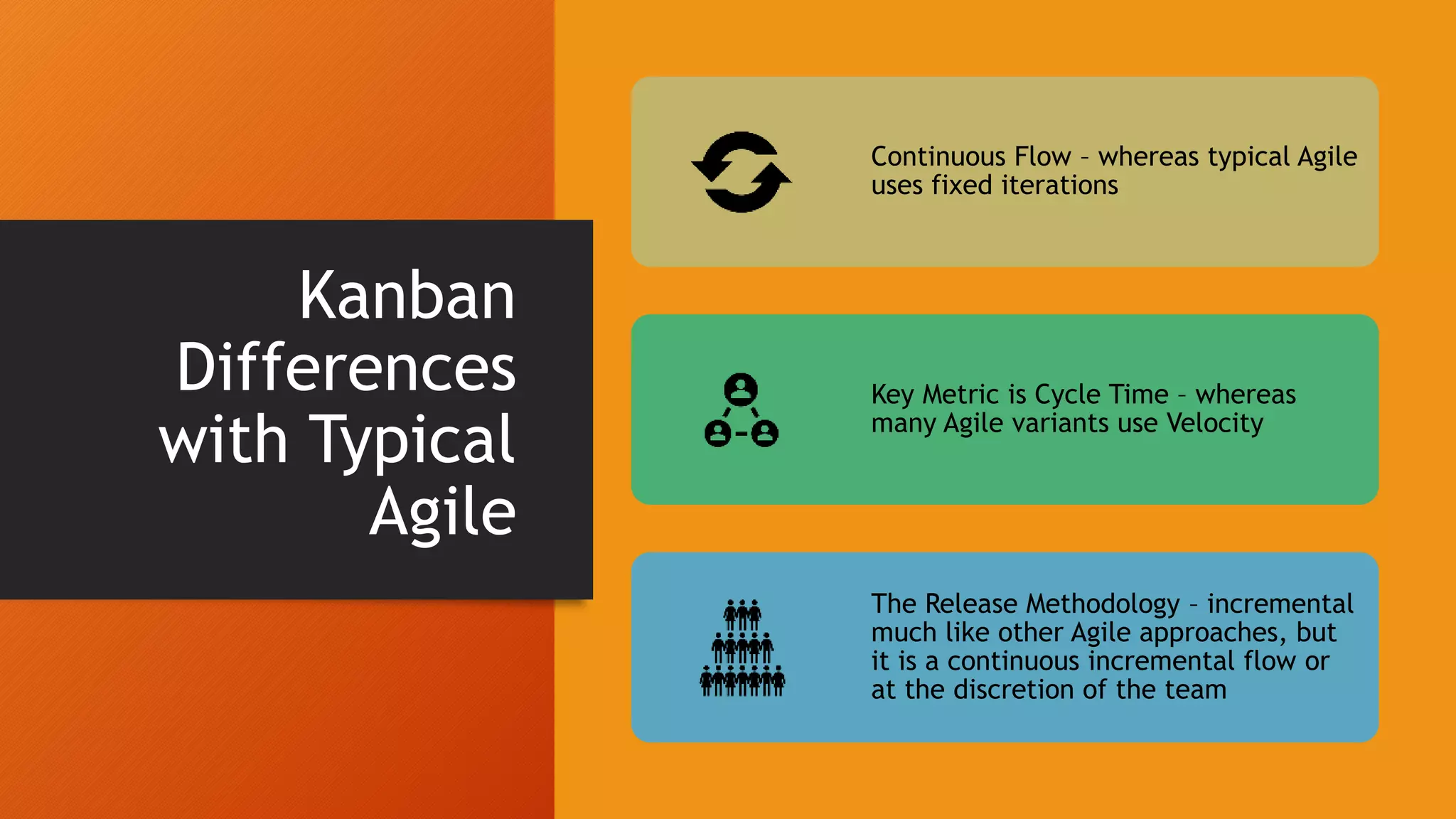

Kanban
Differences
with Typical
Agile
Continuous Flow – whereas typical Agile
uses fixed iterations
Key Metric is Cycle Time – whereas
many Agile variants use Velocity
The Release Methodology – incremental
much like other Agile approaches, but
it is a continuous incremental flow or
at the discretion of the team
Extreme
Programming(XP)
XP Overview
XP focuses on
technical best
practices
Five Core
Values
Twelve
Practices

Four Roles

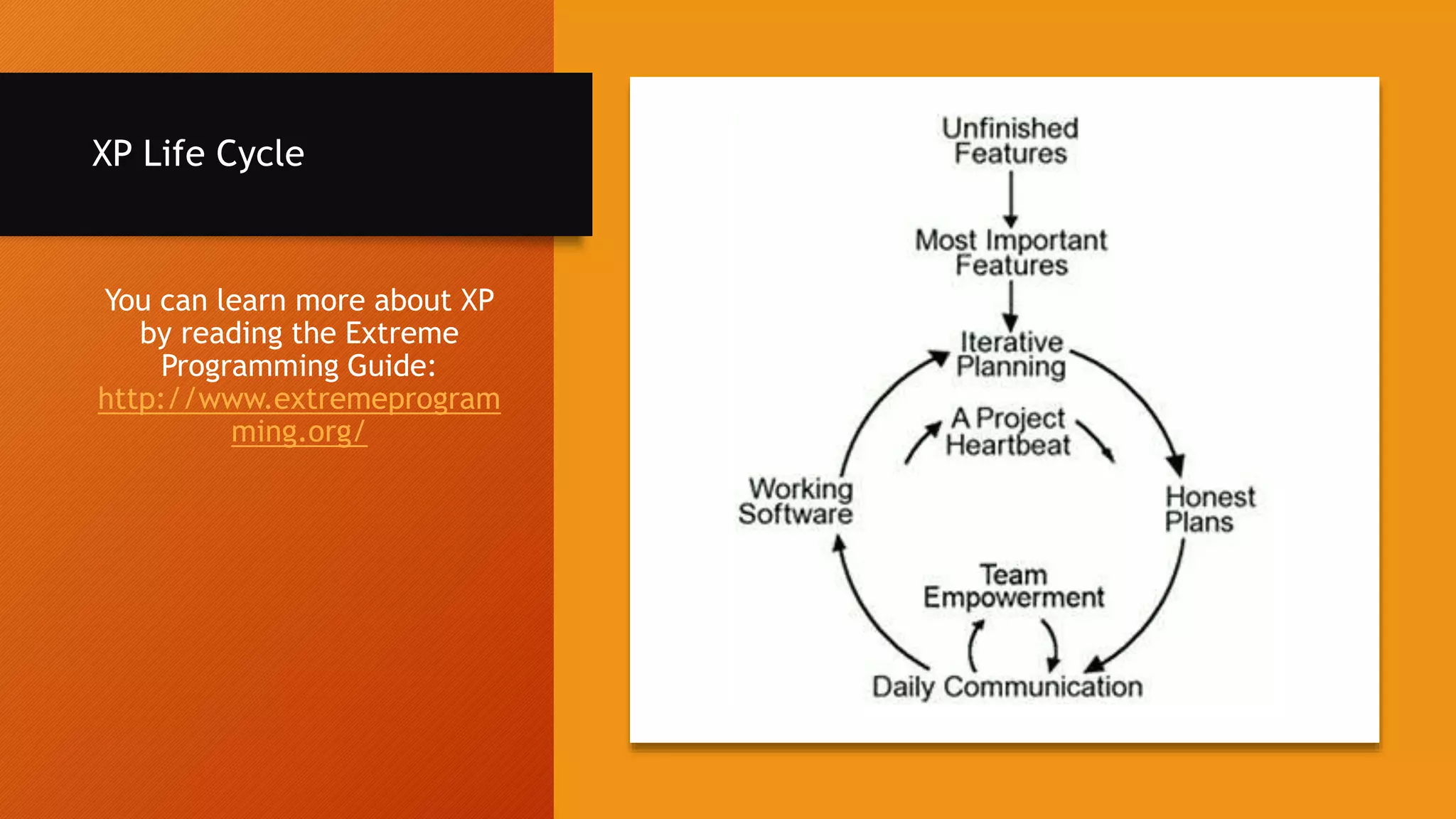

XP Life Cycle
You can learn more about XP
by reading the Extreme
Programming Guide:
http://www.extremeprogram
ming.org/

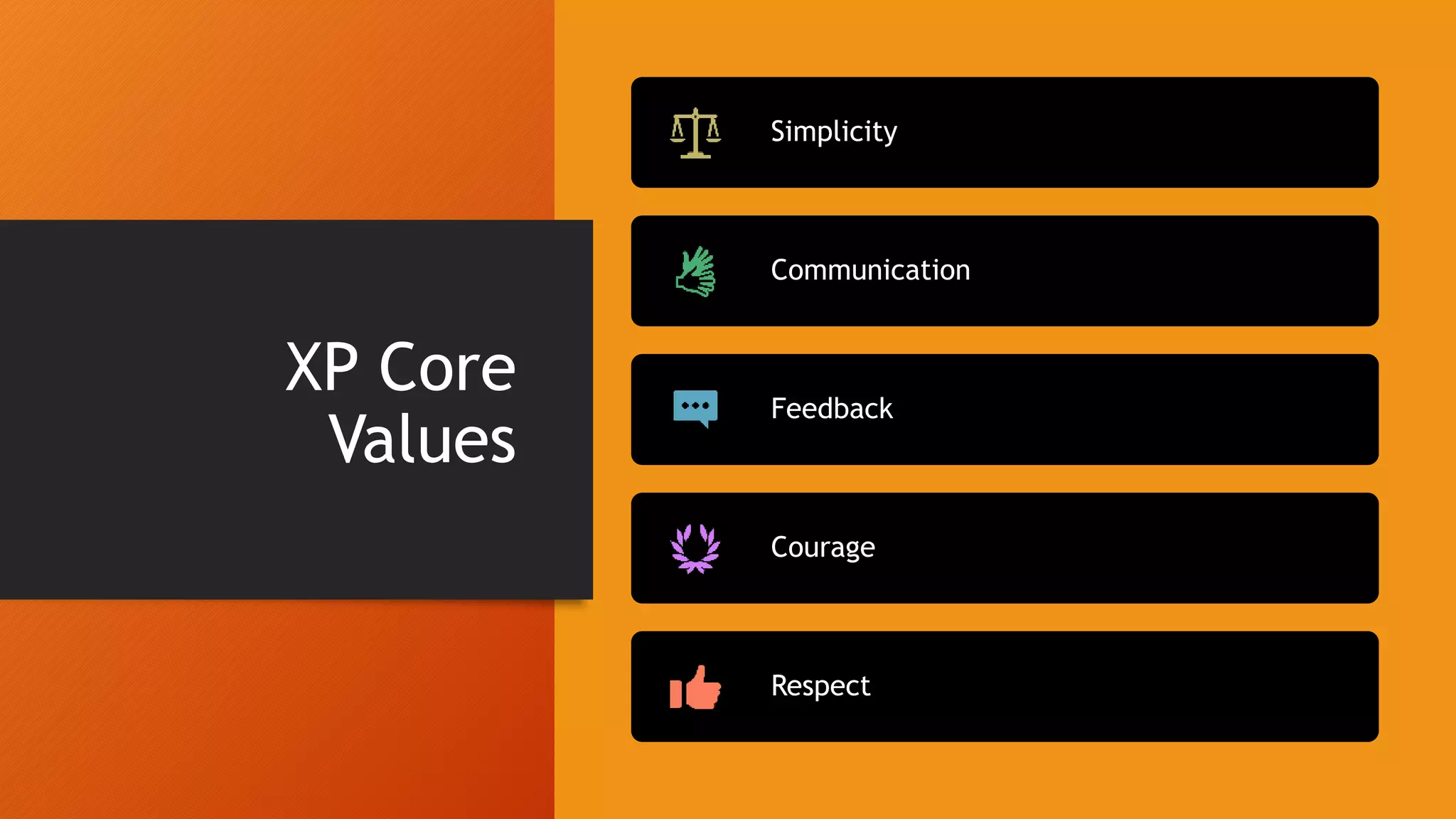

XP Core
Values
Simplicity
Communication
Feedback
Courage
Respect
XP 12
Practices
Pair
Programming
Planning
Game
Test Driven
Development
(TDD)
Whole team
Continuous
Integration
Refactoring
Small
Releases
Sustainable
Pace
Collective
Code
Ownership
Coding
Standard
Simple
Design
System
Metaphor
XP 12
Practices:

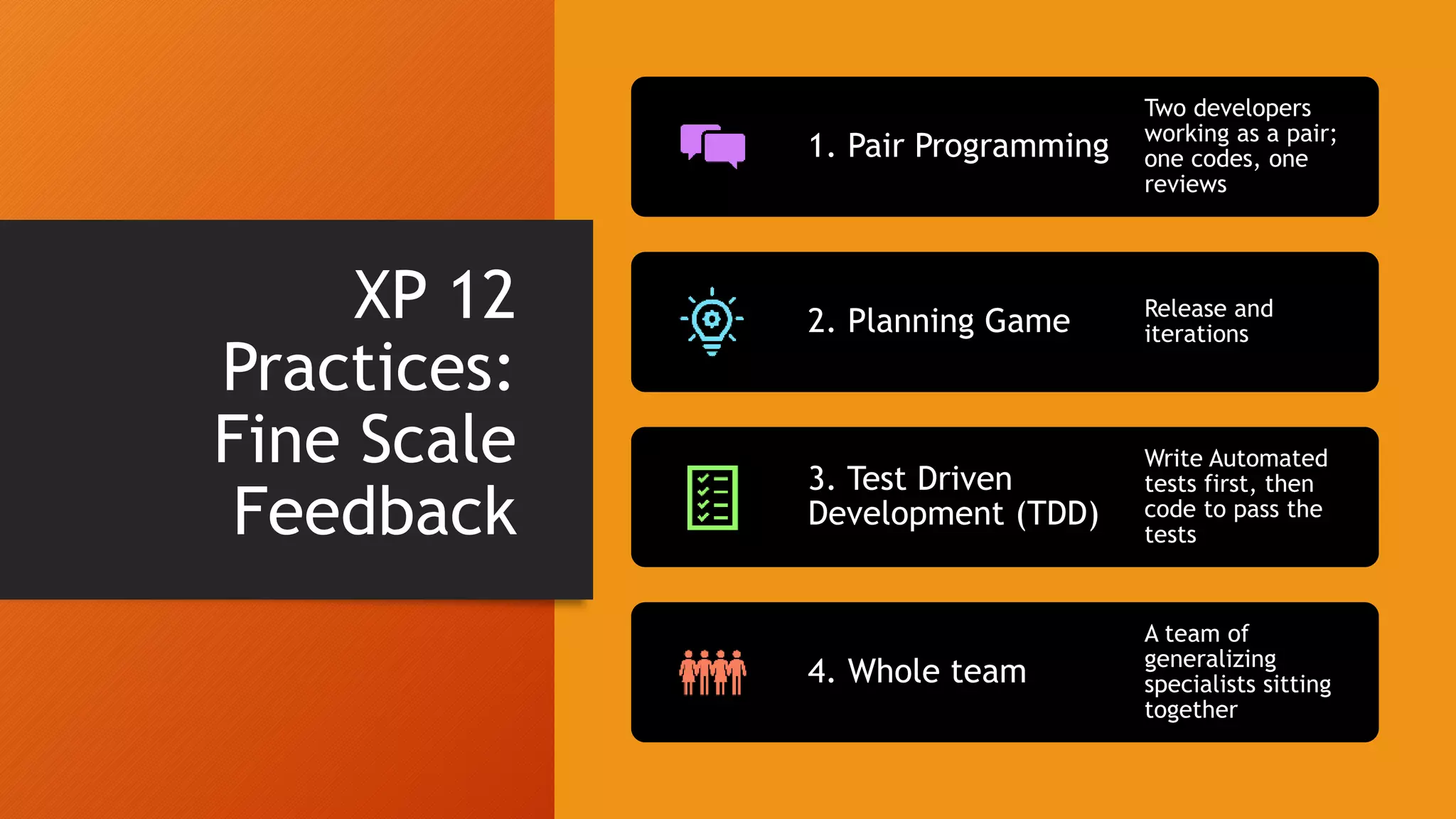

Fine Scale
Feedback
1. Pair Programming
Two developers
working as a pair;
one codes, one
reviews
2. Planning Game Release and
iterations
3. Test Driven
Development (TDD)
Write Automated
tests first, then
code to pass the
tests
4. Whole team
A team of
generalizing
specialists sitting
together

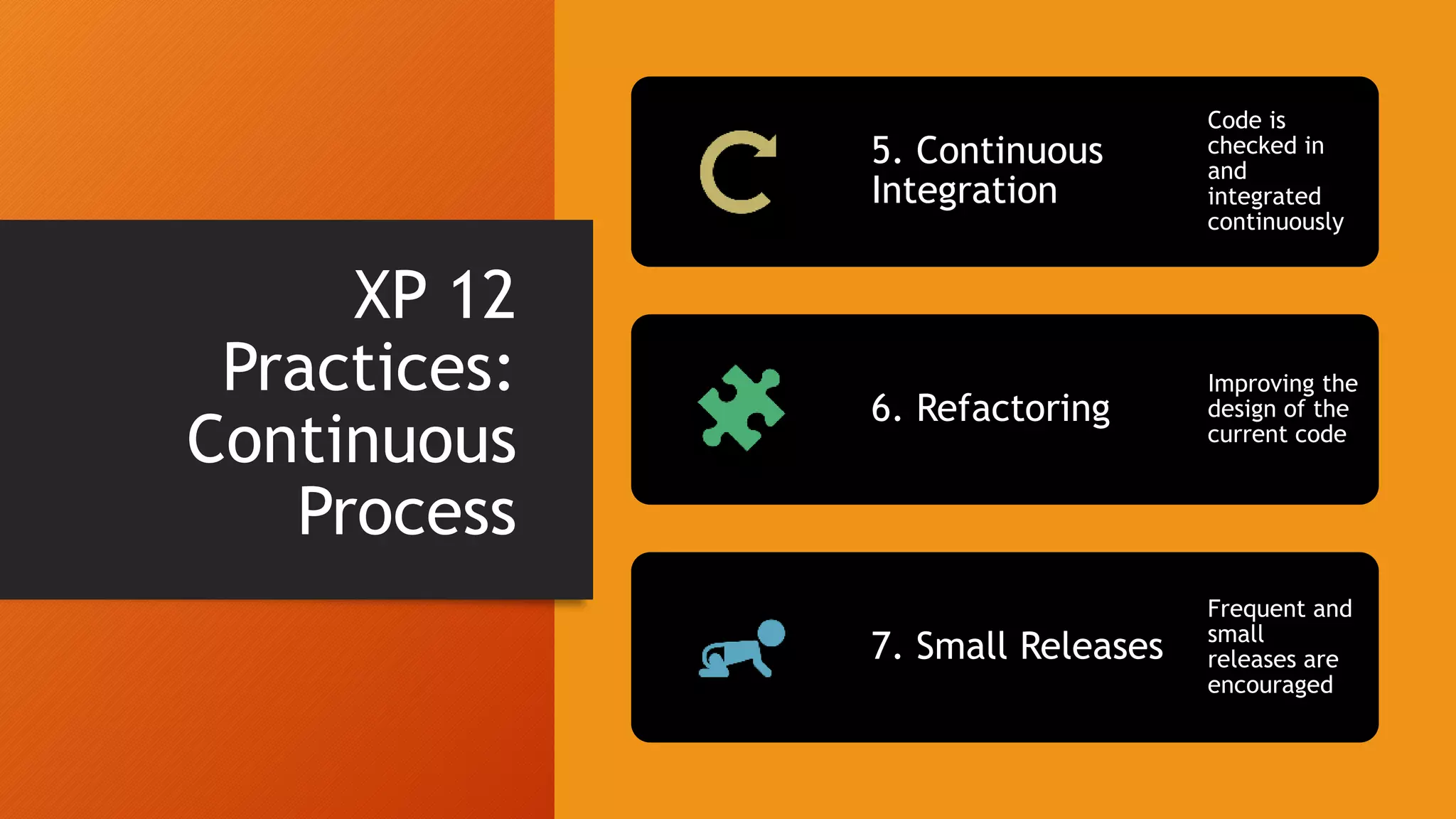

XP 12
Practices:
Continuous
Process
5. Continuous
Integration
Code is
checked in
and
integrated
continuously
6. Refactoring
Improving the
design of the
current code
7. Small Releases
Frequent and
small
releases are
encouraged

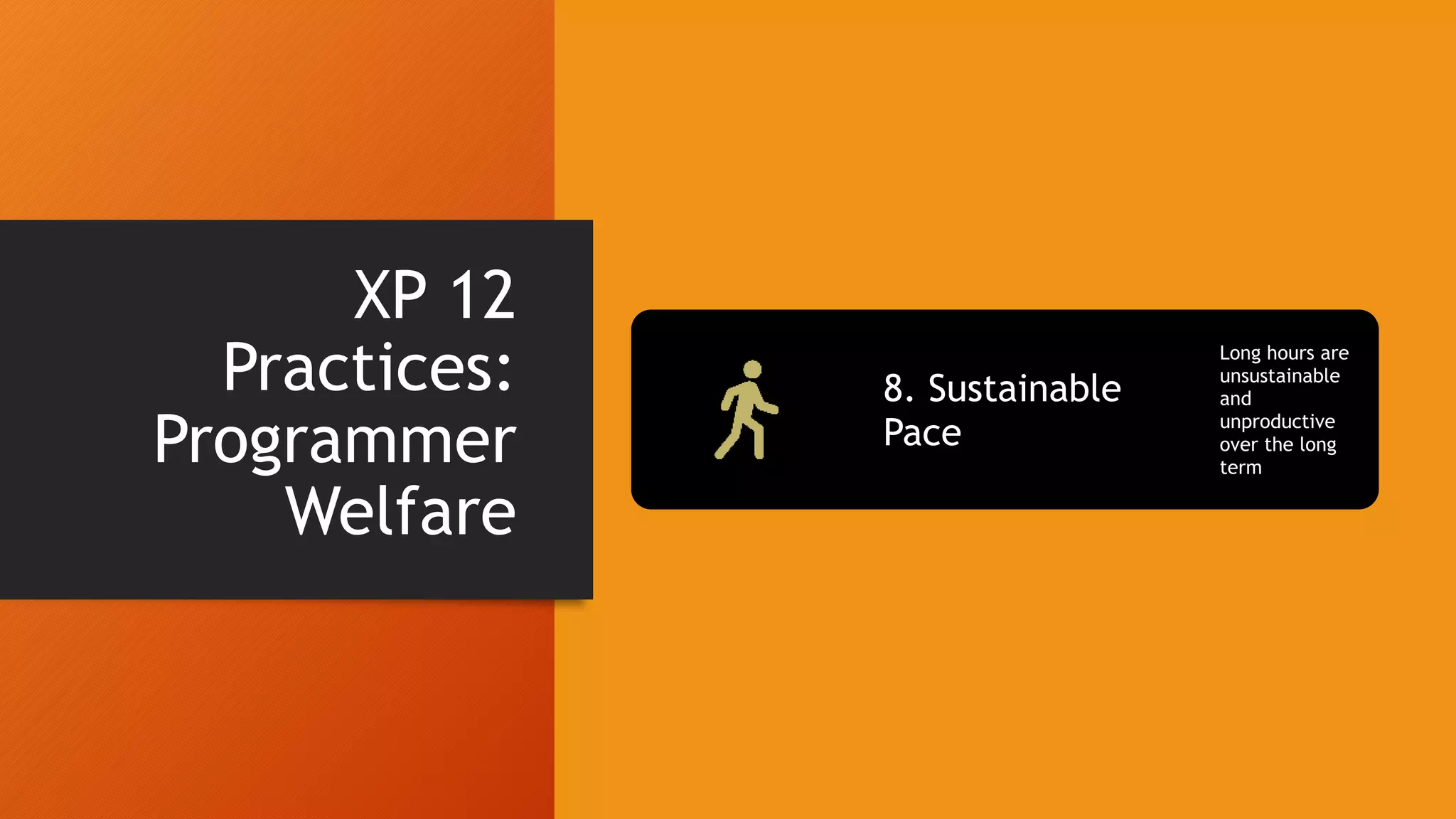

XP 12
Practices:
Programmer
Welfare
8. Sustainable
Pace
Long hours are
unsustainable
and
unproductive
over the long
term
XP 12
Practices:
Shared
Understanding
9. Collective Code
Ownership
Team responsibility for
code
10. Coding Standard Minimize issues with
different approaches
11. Simple Design what Is the simplest
thing that could work
12. System
Metaphor
Tool to create a
shared understanding
for the team
XP Roles
Coach – Mentor and
facilitator to the team
Customer – Business
Representative who
determines priorities and
requirements for tasks
Developers – Develop the
software
Testers – Test the
software
XP Common
Practices
User Stories – Feature requirements
from the perspective of a user
Common Format: As a user, I want
_____, so that I can ______.
Spikes – Reduce risk and uncertainty.
Tests or modeling to learn or
understand something
Architectural Spike – Iteration to
prove a technical approach. Helps
understand how the product should
be built
Feature-Driven
Development(FDD)
FDD Overview
Older Agile
Methodology
01
Five Main Steps,
with iterative
period being
steps 4 and 5
02
Built on a set of
best practices
aimed at
optimizing
value
03
Two week
implementation
period
04
FDD Five
Main Steps
Develop an Overall
Model
Output: High Level Object
Model and Notes
Build a Features List
Output: List of Features
grouped into sets and
subject areas
Plan By Feature Output: Development Plan
and Feature Set Owners
Design By Feature Output: Design Package
Build The Feature Output: Programming,
Testing, Packaging
FDD Best
Practices
Visibility of
Progress and
Results
Transparency of the system
Regular Build Ensures there is always an up to date build
Configuration
Management
History of changes kept
Inspection Code and product should be regularly inspected
Feature TeamsFeature Teams
Individual Code
Ownership
Code is assigned to an individual, and that individual is responsible
Developing By
Feature
Developing By
Feature
Domain Object
Modeling
Modeling the feature
Dynamic Systems
Development
Methodology (DSDM)
DSDM
Overview
A Robust and Comprehensive Approach
One of the oldest known forms of Agile, dating
back before the Agile Manifesto was created
Eight Core Principles
Utilizes a MoSCoW approach (Must Have, Should
Have, Could Have, Won’t Have)
More dedicated roles than other Agile
Methodologies, more suitable to larger projects
DSDM Philosophy
“best business value emerges when
projects are aligned to clear
business goals, deliver frequently
and involve the collaboration of
motivated and empowered
people.” – Agile Business
Consortium
DSDM 8 Principles
FOCUS ON THE
BUSINESS NEED
1
DELIVER ON
TIME
2
COLLABORATE
3
NEVER
COMPROMISE
QUALITY
4
BUILD
INCREMENTALLY
FROM FIRM
FOUNDATIONS
5
DEVELOP
ITERATIVELY
6
COMMUNICATE
CONTINUOUSLY
AND CLEARLY
7
DEMONSTRATE
CONTROL
8
DSDM
MoSCoW
prioritization
Must Have – In order to meet
requirements (Customer
Demands, Legal Obligations, this
is what the release MUST HAVE)
Should Have - Extra features it
should have but the features are
not vital or important
Could Have - Wanted or desirable
but less impact if not included
Won’t Have - Will not be
delivered within the timeframe
DSDM Life Cycle
D S D M includes phases for pre and post
project. The Evolutionary Development
phase is where the project work gets
conducted.
More information on DSDM and the
Project Life Cycle can be found at
https://www.agilebusiness.org

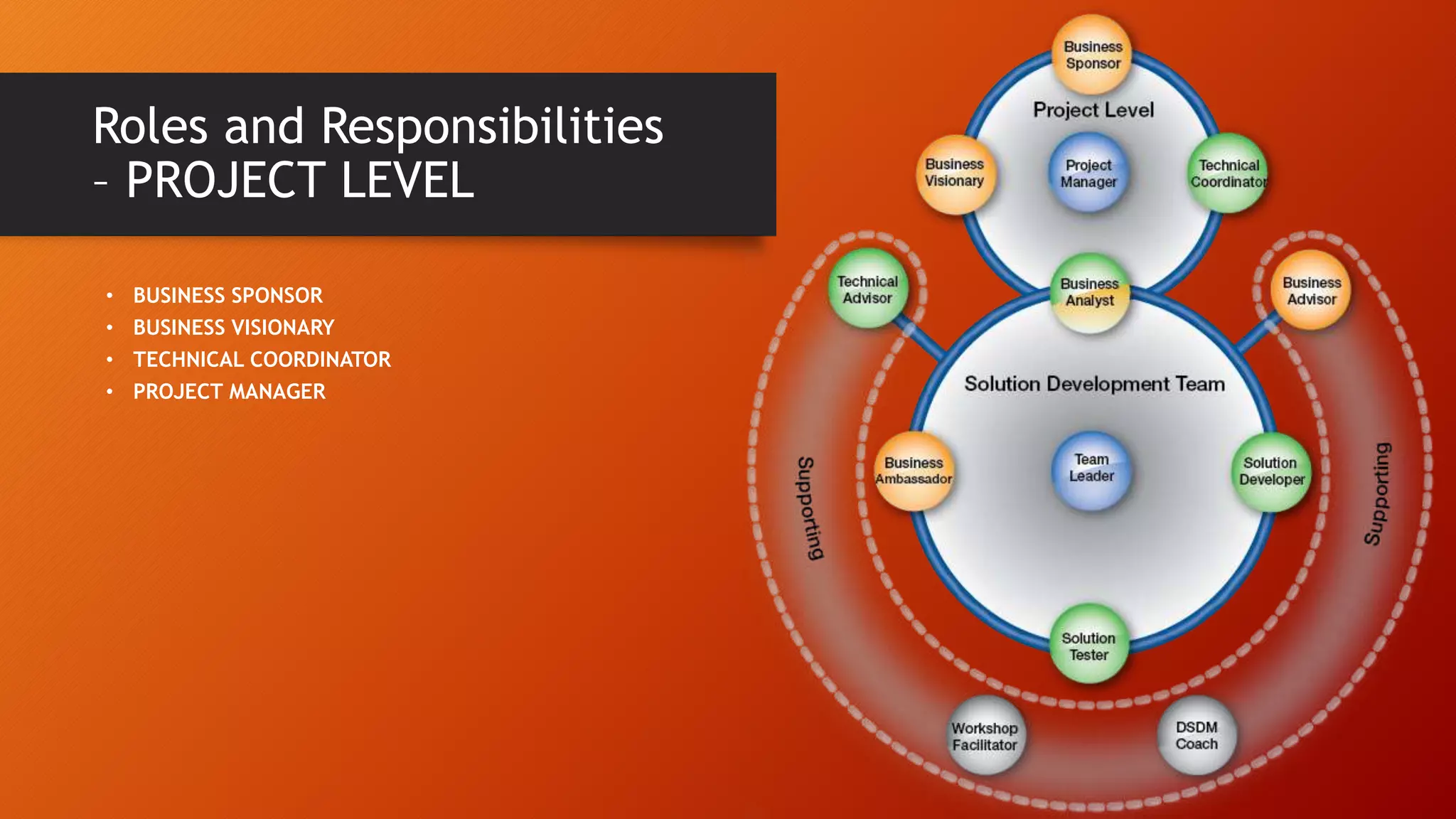

• BUSINESS SPONSOR
• BUSINESS VISIONARY
• TECHNICAL COORDINATOR
• PROJECT MANAGER
Roles and Responsibilities
– PROJECT LEVEL

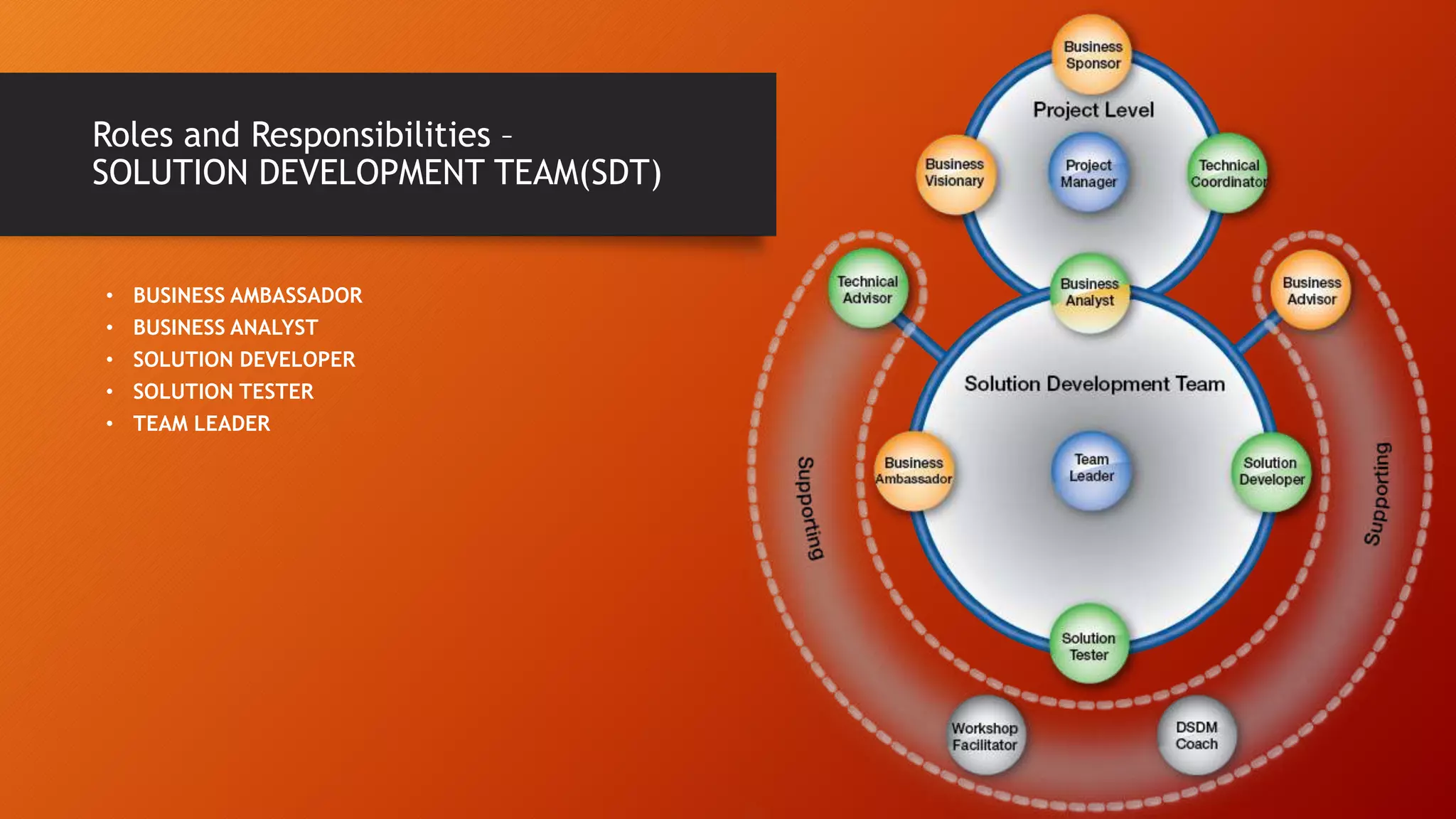

• BUSINESS AMBASSADOR
• BUSINESS ANALYST
• SOLUTION DEVELOPER
• SOLUTION TESTER
• TEAM LEADER
Roles and Responsibilities –
SOLUTION DEVELOPMENT TEAM(SDT)
• BUSINESS ADVISOR
• TECHNICAL ADVISOR
• WORKSHOP FACILITATOR
• DSDM COACH
Roles and Responsibilities
– SUPPORTING STAFF
More Information
• Agile Business Consortium DSDM Handbook:
https://www.agilebusiness.org/resources/dsdm-
handbooks
• Extreme Programming:
http://www.extremeprogramming.org/
• The Scrum Guide:
https://www.scrumguides.org/
• Comprehensive List of Agile Frameworks:
https://agile-mercurial.com/2019/02/06/agile-
frameworks-fact-sheet/
• PMI and Agile Alliance (2017) Agile Practice
Guide
PMI-ACP Domain 1: Agile Principles and
Mindset
By Joshua Render
https://agile-mercurial.com

PMI-ACP Domain 1 Agile Principles and Mindset

  • 1.
    PMI-ACP Domain 1 AgilePrinciples and Mindset
  • 2.
  • 3.
    Traditional Scope is fixed Costand schedule are usually variable
  • 4.
    Agile Cost and schedule becomefixed The scope becomes variable
  • 5.
  • 6.
    Project Life Cycles •Predictive, Traditional, or Waterfall – work is segmented and sequenced in a predictable flow • Iterative – allows feedback on work that is not completed so that improvements can be made to that work • Incremental – releases of partial work product so that value can be delivered quicker and ongoing work can be used • Adaptive – developed feedback loops, such as iterative, and early value releases, such as incremental, to adapt to changes as the project progresses. Planning is done using progressive elaboration.
  • 7.
  • 8.
    Lean Overview Lean is notan Agile project approach but a set of philosophies that can guide Agile Used heavily in Manufacturing - Lean Manufacturing Consists of Eight Types of Waste Consists of Seven Core Concepts
  • 9.
  • 10.
    Lean/Agile Relationship With this model,we can visualize how Agile relates to Lean and what we can learn from Lean to improve Agile
  • 12.
    Lean Seven CoreConcepts Eliminate Waste •Maximize value by minimizing waste Amplify Learning •Facilitate Communication and elicit feedback Decide Later •Defer Decisions as long as Responsibly Possible Deliver Fast •Maximize Return by gaining value quicker Empower the Team •Give them the knowledge, tools, and environment to do their work Build Integrity In •Test throughout the process See The Whole •Be Aware of the entire system, not just the individual parts
  • 13.
  • 14.
    Lean Examples ofWaste Motion – Poor communication within the processes Over processing – Processes that add no value but only add time; bureaucratic processes Over Production – Building features that no one asked for Transportation – Being assigned to different projects, or multitasking Waiting – Waiting for tools, project sign-offs, resources Skills Underutilized – Too many specialists on the team Defects – Bugs in the code Inventory – Creating more documentation than can possible be useful
  • 15.
  • 16.
    Scrum Overview Lightweight Framework fordeveloping and sustaining complex products Lightweight; Simple to understand; difficult to master Three Pillars to Scrum Philosophy Five Values Three roles on the Scrum team
  • 17.
    Scrum: The Three Pillars TRANSPARENCY– Information should be readily available. Information should also not be hidden from stakeholders INSPECTION – The team and other stakeholders should be able to inspect the ‘DONE’ product and make adjustments to the product or process in order to be successful ADAPTATION – The team should be able to adapt to changes or adapt to issues/flaws found during inspection
  • 18.
  • 19.
  • 20.
  • 21.
    Scrum Team Self Organizing– Team will determine the best way to do the work Cross Functional – Team has all the skills needed to perform the work Deliver Product – Product is delivered in functional pieces iteratively and incrementally
  • 22.
    Scrum Role: Product Owner Product Owner– Responsible for maximizing the value of the product and the work of the development team. They are accountable for the Product Backlog and ensuring that the most valuable items are at the top of the list.
  • 23.
    Scrum Role: Development Team Development Team– The people who do the actual work of creating and delivering a potentially releasable increment of a DONE product. They have no titles other than “Development Team” and the accountability of creating a DONE increment belongs to the team. There are 3-9 people on a Scrum Development Team.
  • 24.
    Scrum Role: Scrum Master Scrum Master– Responsible for ensuring the team understands Scrum. They are servant leader that works to empower the team. They remove blockers or impediments for the development team and facilitate Scrum Events. They support Scrum Adoption and sharing of Scrum Practices throughout the organization.
  • 25.
    Scrum Artifacts Product Backlog– An ordered list of what is currently expected to be included in the product. It can change and evolve as new information becomes known. Sprint Backlog – This contains the current product backlog items that are being worked on in the current sprint Increment – The potentially releasable product at the end of a Sprint. It is all of the items in the Sprint Backlog that were brought to a “Done” state.
  • 26.
    Definition of DONE(DoD) • This defines when an item from the backlog has been completed • Once it is DONE, it becomes useable • If not defined by the development organization, the Development Team must define it • This should include all things that must go into ensuring that the potentially releasable increment is of high quality and works with all previously released increments, this includes testing
  • 27.
    Scrum Events The Sprint 01 Sprint Planning 02 DailyScrum (Daily Standup Meeting) 03 Sprint Review 04 Sprint Retrospective 05
  • 28.
    Scrum: The Sprint • Time-boxedto one month or less • DONE and potentially releasable product increment is created • Sprint lengths should be consistent • New Sprint begins immediately after the previous one ends • Scope may be clarified as more is learned • If a goal becomes obsolete; only the Product Owner may cancel the Sprint
  • 29.
    Scrum: Sprint Planning • A ceremonyto plan the work to be completed within the Sprint • Time-Boxed to a maximum of 8 hours for a 1 month Sprint, this can be less time for shorter sprints • THE WHAT – What will be worked on? • The Product Owner will discuss what they would like to achieve as the Sprint Goal, but only the Development Team decides on what can be accomplished. • This will form the Sprint Goal • THE HOW – How will this be accomplished? • The team will discuss how they plan to achieve the Sprint Goal
  • 30.
    Scrum: Daily Scrum • 15minute time-boxed ceremony to coordinate and collaborate • Some Agile variants call it the Daily Standup meeting • Three Main Questions • What did I accomplish yesterday? • What am I going to accomplish today? • What are potential impediments or blockers? • Scrum Master ensures the team has the meeting but does not have to attend and does not lead the meeting • It is the Development Teams responsibility to conduct and lead the Daily Scrum • People not on the Development Team are discouraged from attending
  • 31.
    Scrum: Sprint Review • This isa 4 hour time-boxed ceremony for one-month Sprints. It can be shorter if the Sprint is shorter. • This provides an opportunity for stakeholders to Inspect the Increment and adapt any changes the product backlog • The Development Team demonstrates what is DONE and receives feedback from the Product Owner, Customers, and other Stakeholders • It occurs near the end of the Sprint
  • 32.
    Scrum: Sprint Retrospective • Thisis a 3 Hour time-boxed ceremony for a month long Sprint. It can be shorter if the Sprint is shorter. • It is held at the end of the Sprint: After the Sprint Review, but before Sprint Planning • The purpose is to Inspect how the Sprint went • Identify what went well and what didn’t go well • Create a plan for improving what didn’t go well and decide on how best to implement the improvement • The team should identify some improvements that can be implemented in the next Sprint
  • 33.
  • 34.
    Kanban Overview • Kanban isa continuous flow of work with incremental releases • Visualizing the work is very important, and can allow the spotting of bottlenecks between processes • Kanban is a pull system, meaning items must be pulled into the next process • Work in Progress (WIP) limits help maintain a sustainable pace and continuous flow of delivery • Kanban is based off of Just in Time Manufacturing and could be called Just in time delivery • It has Five Core Practices
  • 35.
    Queueing Theory andLittle’s Law • The validity of Kanban has been shown through the studying of lines • WIP = Throughput * Cycle Time • Named after John Little • It defines the relationship between inventory, the rate of flow, and the time it takes to complete all the processes in the flow.
  • 36.
    Pull System The rateof demand from a process controls the flow Items are not pushed forward to the next process if the demand is not present Each process works as an on demand supplier for the process next in line
  • 37.
    Kanban Five Core Practices Define andVisualize the Workflow (Kanban board, CFD) Limit Work-In-Progress (WIP) Measure and Manage Flow Make Process Policies Explicit Use Models to Aid in Improvement
  • 38.
    Kanban Differences with Typical Agile Continuous Flow– whereas typical Agile uses fixed iterations Key Metric is Cycle Time – whereas many Agile variants use Velocity The Release Methodology – incremental much like other Agile approaches, but it is a continuous incremental flow or at the discretion of the team
  • 39.
  • 40.
    XP Overview XP focuseson technical best practices Five Core Values Twelve Practices Four Roles
  • 41.
    XP Life Cycle Youcan learn more about XP by reading the Extreme Programming Guide: http://www.extremeprogram ming.org/
  • 42.
  • 43.
    XP 12 Practices Pair Programming Planning Game Test Driven Development (TDD) Wholeteam Continuous Integration Refactoring Small Releases Sustainable Pace Collective Code Ownership Coding Standard Simple Design System Metaphor
  • 44.
    XP 12 Practices: Fine Scale Feedback 1.Pair Programming Two developers working as a pair; one codes, one reviews 2. Planning Game Release and iterations 3. Test Driven Development (TDD) Write Automated tests first, then code to pass the tests 4. Whole team A team of generalizing specialists sitting together
  • 45.
    XP 12 Practices: Continuous Process 5. Continuous Integration Codeis checked in and integrated continuously 6. Refactoring Improving the design of the current code 7. Small Releases Frequent and small releases are encouraged
  • 46.
    XP 12 Practices: Programmer Welfare 8. Sustainable Pace Longhours are unsustainable and unproductive over the long term
  • 47.
    XP 12 Practices: Shared Understanding 9. CollectiveCode Ownership Team responsibility for code 10. Coding Standard Minimize issues with different approaches 11. Simple Design what Is the simplest thing that could work 12. System Metaphor Tool to create a shared understanding for the team
  • 48.
    XP Roles Coach –Mentor and facilitator to the team Customer – Business Representative who determines priorities and requirements for tasks Developers – Develop the software Testers – Test the software
  • 49.
    XP Common Practices User Stories– Feature requirements from the perspective of a user Common Format: As a user, I want _____, so that I can ______. Spikes – Reduce risk and uncertainty. Tests or modeling to learn or understand something Architectural Spike – Iteration to prove a technical approach. Helps understand how the product should be built
  • 50.
  • 51.
    FDD Overview Older Agile Methodology 01 FiveMain Steps, with iterative period being steps 4 and 5 02 Built on a set of best practices aimed at optimizing value 03 Two week implementation period 04
  • 52.
    FDD Five Main Steps Developan Overall Model Output: High Level Object Model and Notes Build a Features List Output: List of Features grouped into sets and subject areas Plan By Feature Output: Development Plan and Feature Set Owners Design By Feature Output: Design Package Build The Feature Output: Programming, Testing, Packaging
  • 53.
    FDD Best Practices Visibility of Progressand Results Transparency of the system Regular Build Ensures there is always an up to date build Configuration Management History of changes kept Inspection Code and product should be regularly inspected Feature TeamsFeature Teams Individual Code Ownership Code is assigned to an individual, and that individual is responsible Developing By Feature Developing By Feature Domain Object Modeling Modeling the feature
  • 54.
  • 55.
    DSDM Overview A Robust andComprehensive Approach One of the oldest known forms of Agile, dating back before the Agile Manifesto was created Eight Core Principles Utilizes a MoSCoW approach (Must Have, Should Have, Could Have, Won’t Have) More dedicated roles than other Agile Methodologies, more suitable to larger projects
  • 56.
    DSDM Philosophy “best businessvalue emerges when projects are aligned to clear business goals, deliver frequently and involve the collaboration of motivated and empowered people.” – Agile Business Consortium
  • 57.
    DSDM 8 Principles FOCUSON THE BUSINESS NEED 1 DELIVER ON TIME 2 COLLABORATE 3 NEVER COMPROMISE QUALITY 4 BUILD INCREMENTALLY FROM FIRM FOUNDATIONS 5 DEVELOP ITERATIVELY 6 COMMUNICATE CONTINUOUSLY AND CLEARLY 7 DEMONSTRATE CONTROL 8
  • 58.
    DSDM MoSCoW prioritization Must Have –In order to meet requirements (Customer Demands, Legal Obligations, this is what the release MUST HAVE) Should Have - Extra features it should have but the features are not vital or important Could Have - Wanted or desirable but less impact if not included Won’t Have - Will not be delivered within the timeframe
  • 59.
    DSDM Life Cycle DS D M includes phases for pre and post project. The Evolutionary Development phase is where the project work gets conducted. More information on DSDM and the Project Life Cycle can be found at https://www.agilebusiness.org
  • 60.
    • BUSINESS SPONSOR •BUSINESS VISIONARY • TECHNICAL COORDINATOR • PROJECT MANAGER Roles and Responsibilities – PROJECT LEVEL
  • 61.
    • BUSINESS AMBASSADOR •BUSINESS ANALYST • SOLUTION DEVELOPER • SOLUTION TESTER • TEAM LEADER Roles and Responsibilities – SOLUTION DEVELOPMENT TEAM(SDT)
  • 62.
    • BUSINESS ADVISOR •TECHNICAL ADVISOR • WORKSHOP FACILITATOR • DSDM COACH Roles and Responsibilities – SUPPORTING STAFF
  • 63.
    More Information • AgileBusiness Consortium DSDM Handbook: https://www.agilebusiness.org/resources/dsdm- handbooks • Extreme Programming: http://www.extremeprogramming.org/ • The Scrum Guide: https://www.scrumguides.org/ • Comprehensive List of Agile Frameworks: https://agile-mercurial.com/2019/02/06/agile- frameworks-fact-sheet/ • PMI and Agile Alliance (2017) Agile Practice Guide
  • 64.
    PMI-ACP Domain 1:Agile Principles and Mindset By Joshua Render https://agile-mercurial.com
