Agile Project Management: Introduction to AGILE - The Basic 101
The document provides an introduction to Agile project management, outlining its principles, process, and a comparison with traditional methods. It includes guidelines for transitioning to Agile and lists practical steps for application, such as empowering team members and prioritizing deliverables. Additionally, it presents a sample project utilizing Agile methods, highlighting decision logs, commitment logs, and risk management strategies.
Introduction to Agile in project management; overview of contents including project management, Agile principles, process flow, and Q&A.
Overview of project management; emphasizes resource, time, quality in traditional methods vs Agile methodology, highlighting issues and inefficiencies.
Defines Agile as a flexible project management approach focusing on quality, team autonomy, quick responses to changes, and metrics comparison against traditional methods.
Discussion of the standard Agile process flow; revision sources illustrate adaptation and roles within Agile frameworks enhancing project execution.
Outlines the shift from traditional to Agile project management with key steps for successful adaptation, focusing on team empowerment and continuous updates.
Practical application of Agile principles; real project examples showing documentation, decision logs, meeting notes, commitments, risks, and timelines.
Final Q&A slide and references for further reading on Agile project management methodologies and practices.
Agile Project Management: Introduction to AGILE - The Basic 101
1.
Introduction to AGILE– The Basic 101
Nurul Haszeli Ahmad
4th December 2015
AGILE PROJECT MANAGEMENT
2.
CONTENTS
1 Project Management
2AGILE
3 AGILE Project Management Process Flow
4 Transition from Traditional to Agile
5 Applying Agile
6 Q & A
3.

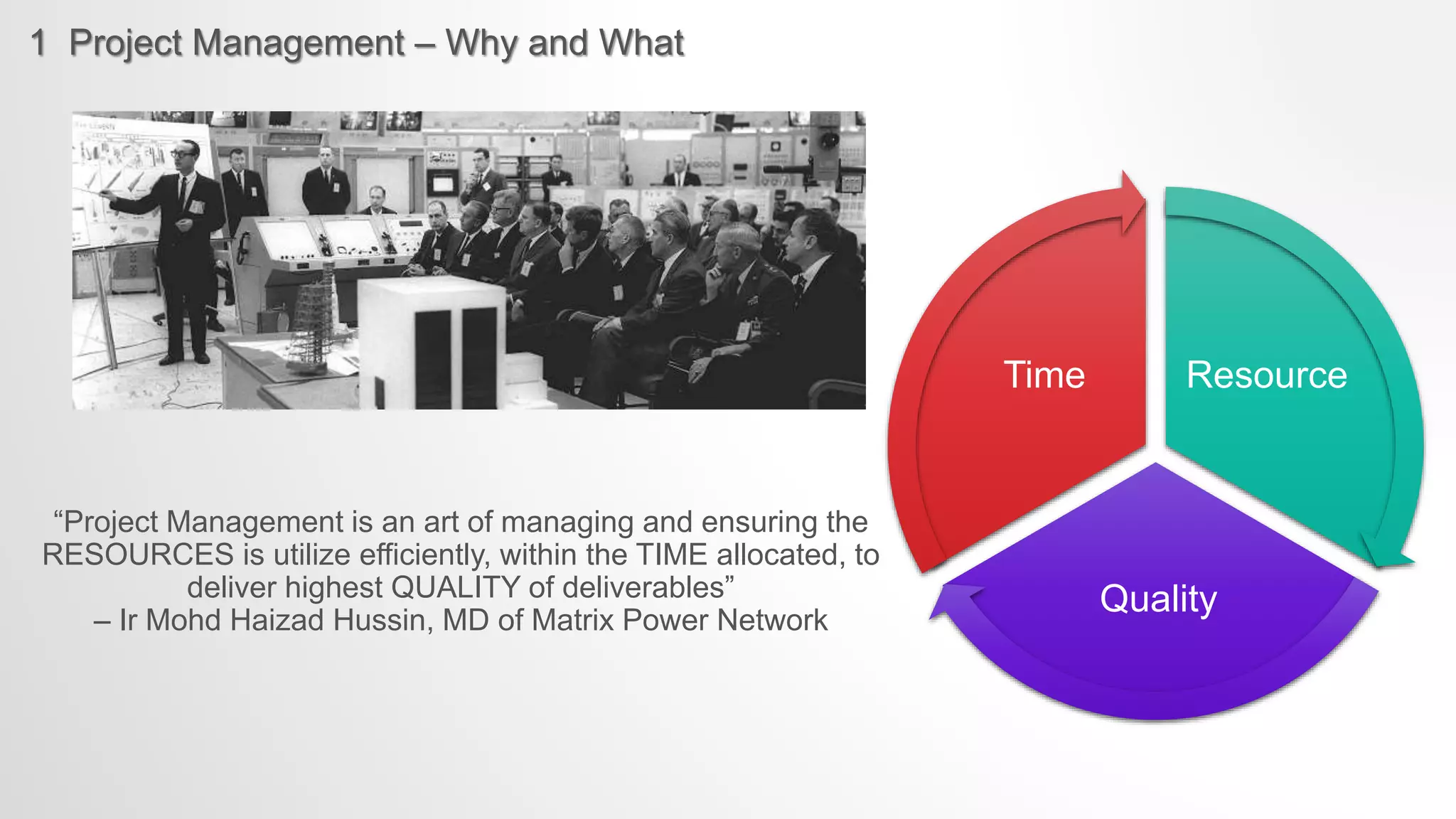

1 Project Management– Why and What
Resource
Quality
Time
“Project Management is an art of managing and ensuring the
RESOURCES is utilize efficiently, within the TIME allocated, to
deliver highest QUALITY of deliverables”
– Ir Mohd Haizad Hussin, MD of Matrix Power Network

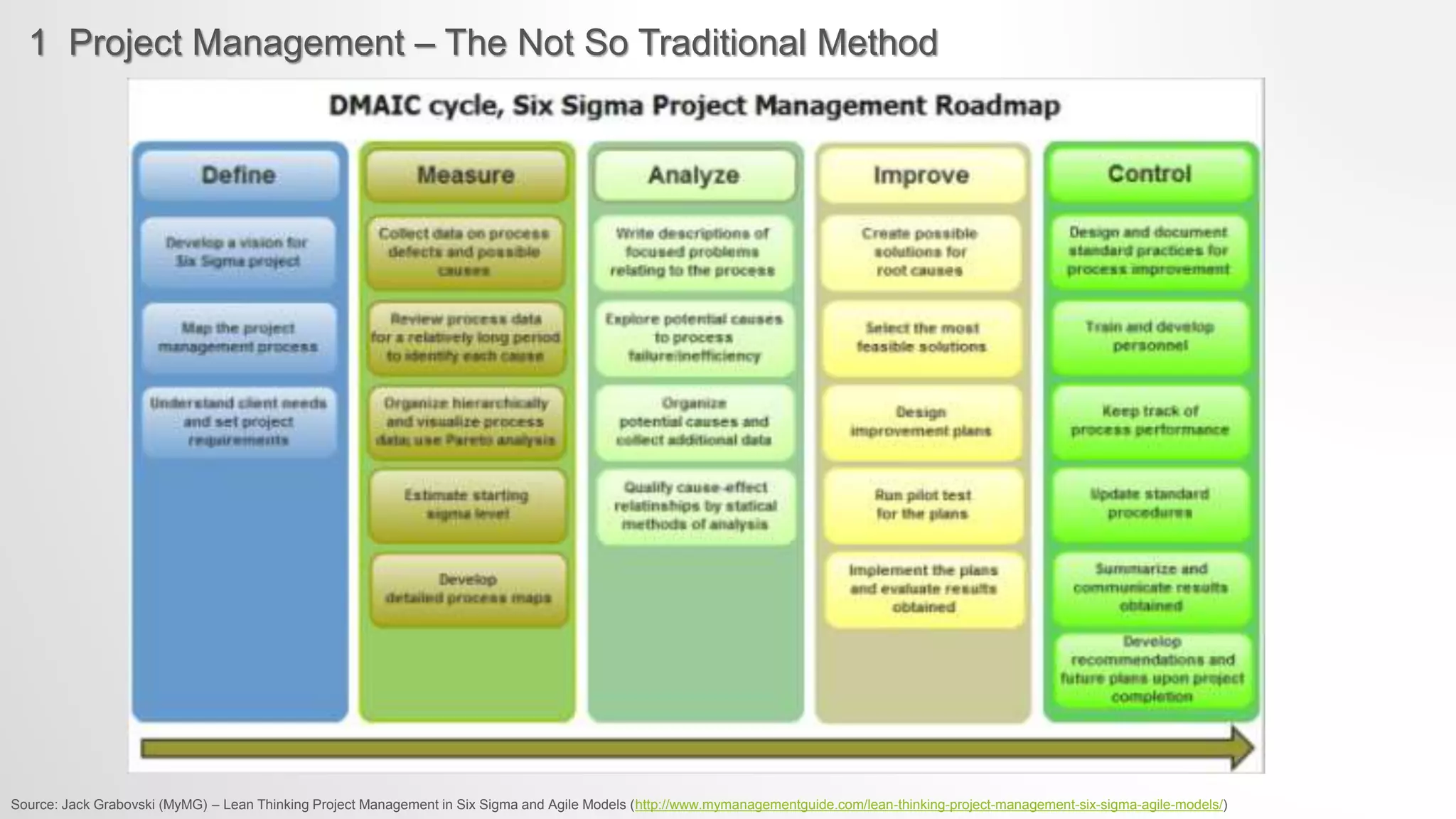

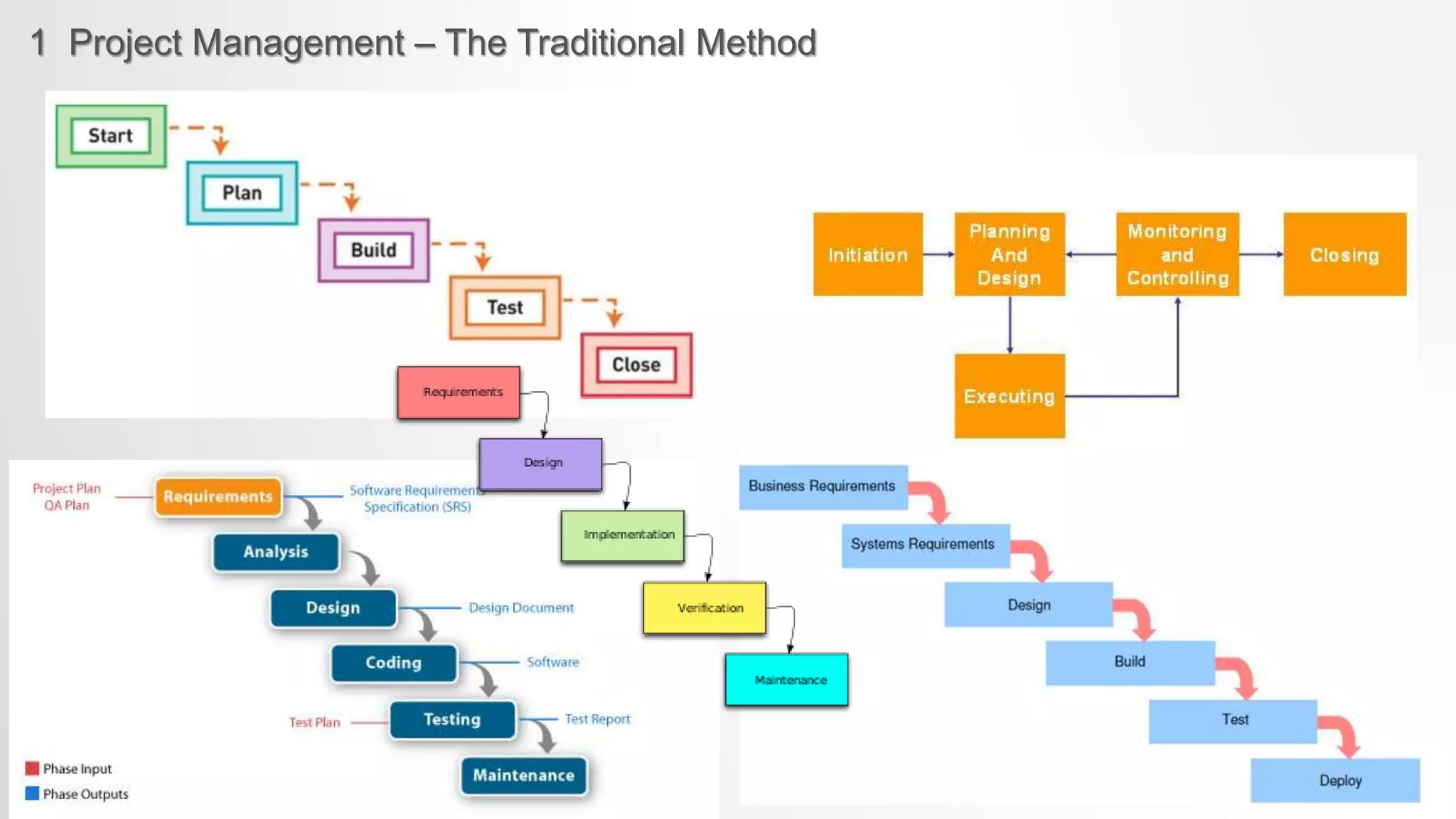

1 Project Management– The Not So Traditional Method
Source: Jack Grabovski (MyMG) – Lean Thinking Project Management in Six Sigma and Agile Models (http://www.mymanagementguide.com/lean-thinking-project-management-six-sigma-agile-models/)
6.

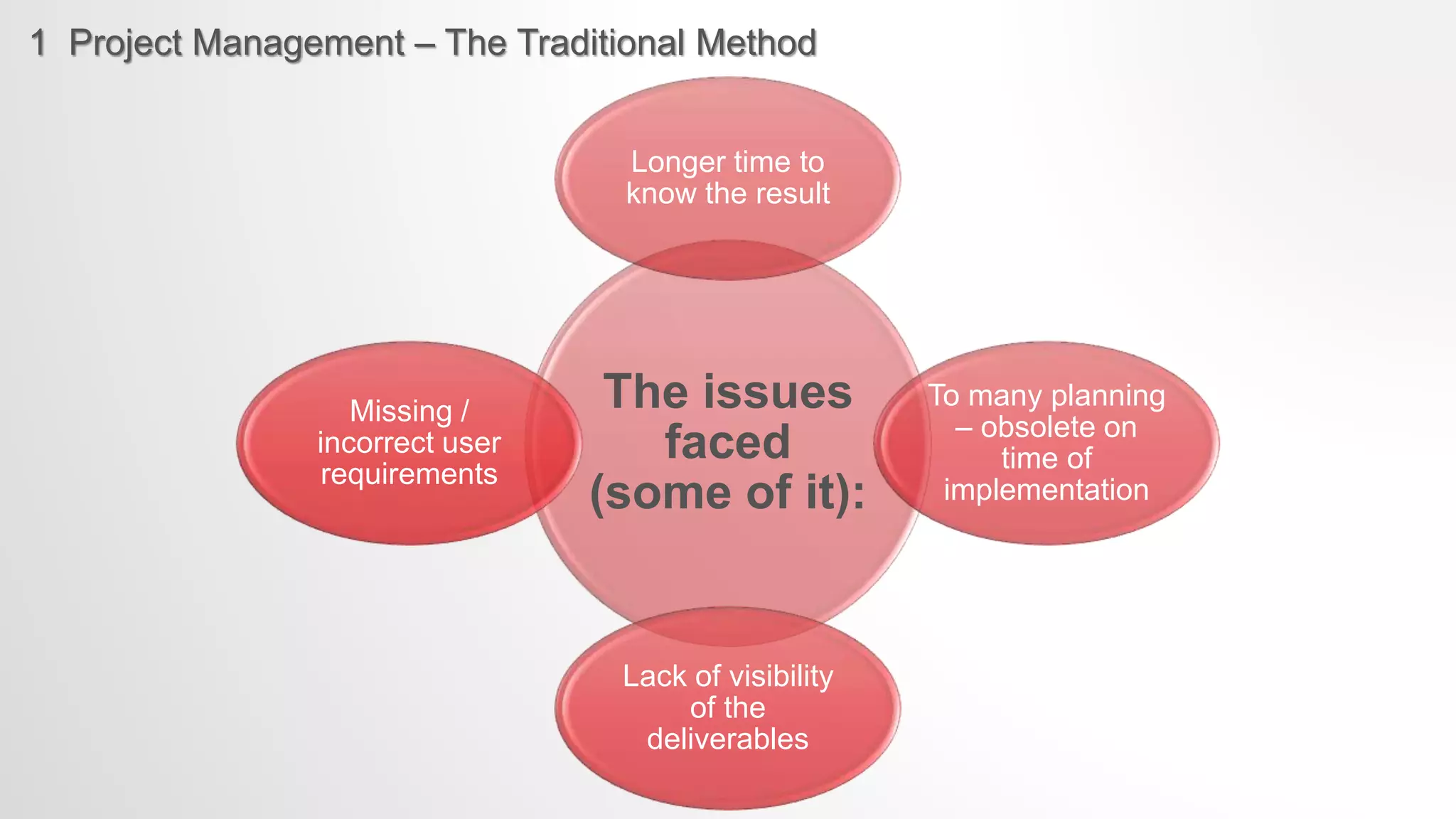

1 Project Management– The Traditional Method
The issues
faced
(some of it):
Longer time to
know the result
To many planning
– obsolete on
time of
implementation
Lack of visibility
of the
deliverables
Missing /
incorrect user
requirements
7.
1 Project Management– The Traditional Method
Source: Scrum Master – The ‘Old’ Waterfall Method (http://www.agile-scrum-master-training.com/agile-project-management/)
8.
2 AGILE –What is?
NO PLANNING * NO DOCUMENTATION * JUST DO IT

9.
2 AGILE –What is?
1. It is a project management with high quality control management.
2. Implies leadership philosophy but at the same time support team work, self control,
organization and accountability.
3. A set of engineering best practices that allow for rapid delivery of high-quality
product/project.
4. A business framework that align development with business/customer/company envision.
Images courtesy Dilbert(R) by Scott Adams
10.
2 AGILE –What is?

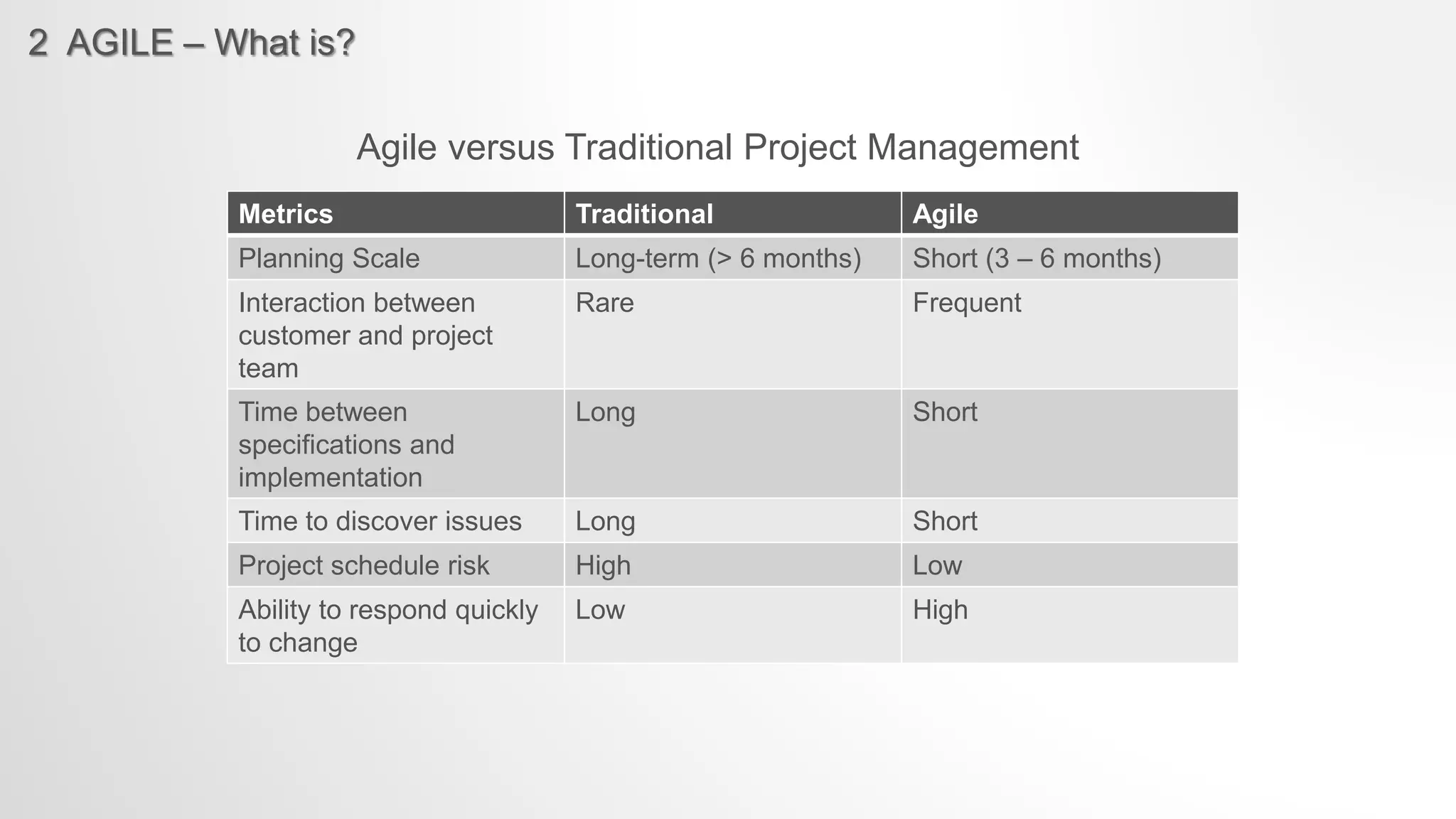

Metrics Traditional Agile
Planning Scale Long-term (> 6 months) Short (3 – 6 months)
Interaction between
customer and project
team
Rare Frequent
Time between
specifications and
implementation
Long Short
Time to discover issues Long Short
Project schedule risk High Low
Ability to respond quickly
to change
Low High
Agile versus Traditional Project Management
11.

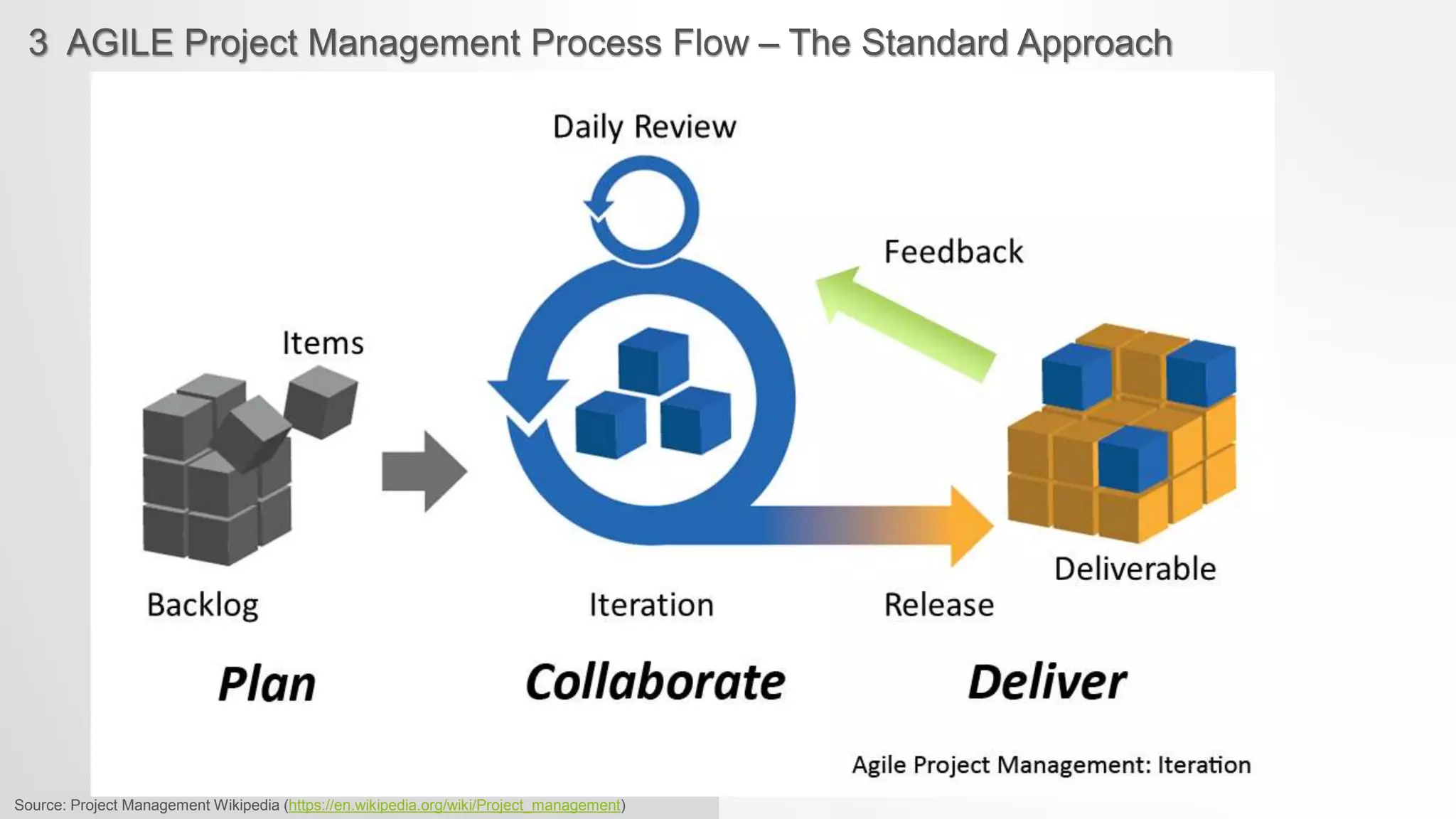

3 AGILE ProjectManagement Process Flow – The Standard Approach
Source: Project Management Wikipedia (https://en.wikipedia.org/wiki/Project_management)
12.

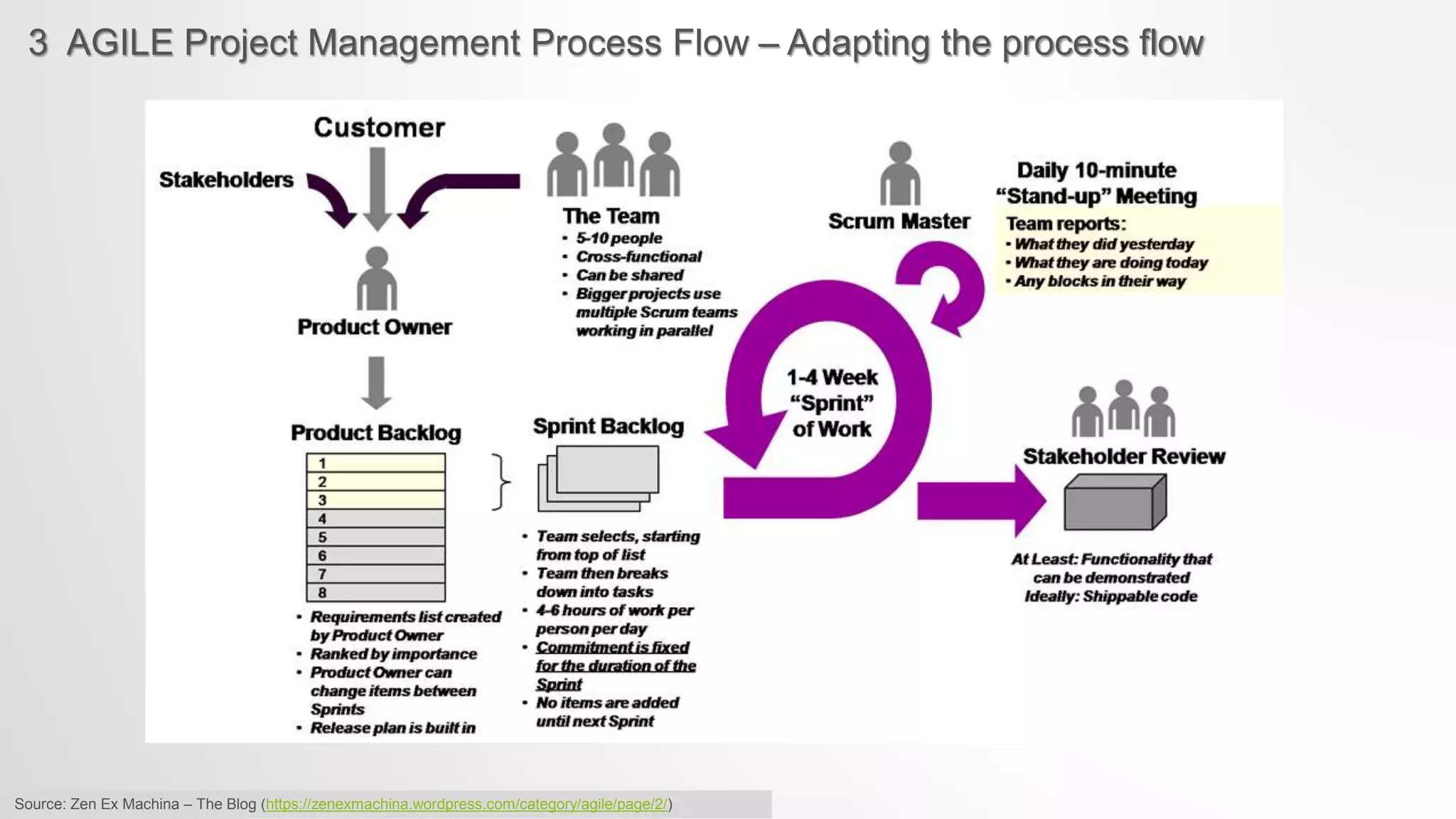

3 AGILE ProjectManagement Process Flow – Adapting the process flow
Source: Zen Ex Machina – The Blog (https://zenexmachina.wordpress.com/category/agile/page/2/)

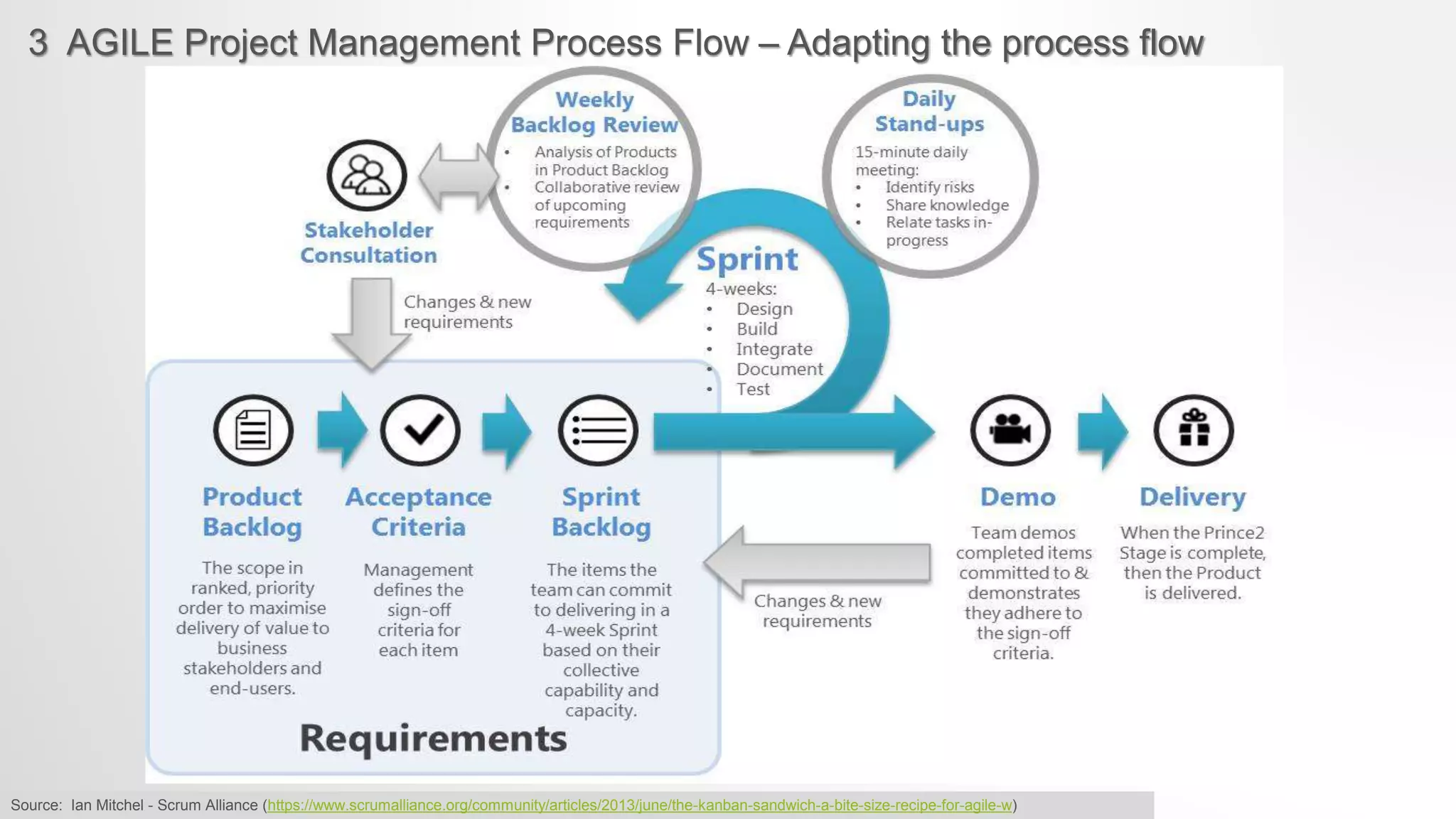

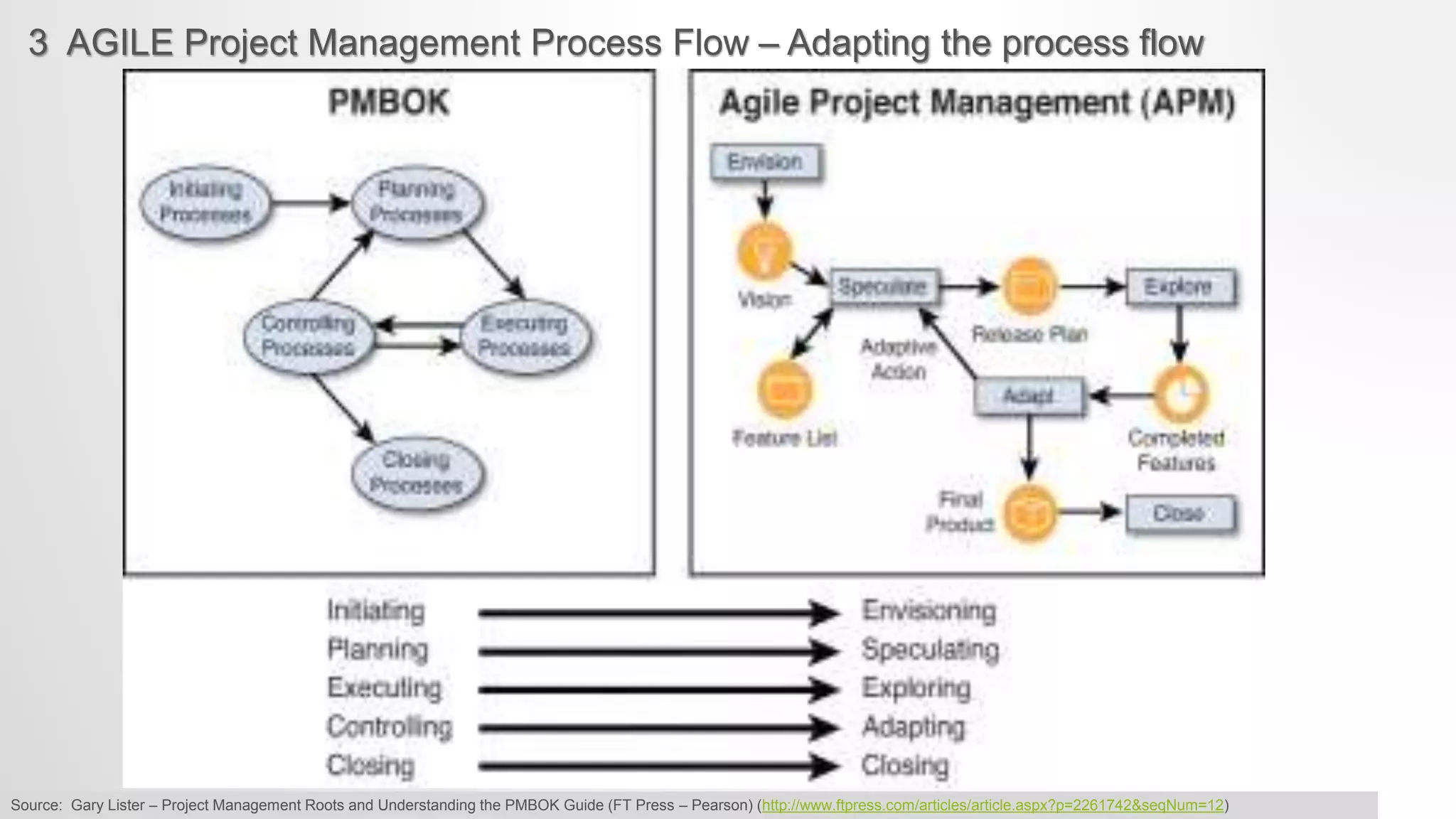

13.
3 AGILE ProjectManagement Process Flow – Adapting the process flow
Source: Ian Mitchel - Scrum Alliance (https://www.scrumalliance.org/community/articles/2013/june/the-kanban-sandwich-a-bite-size-recipe-for-agile-w)
14.

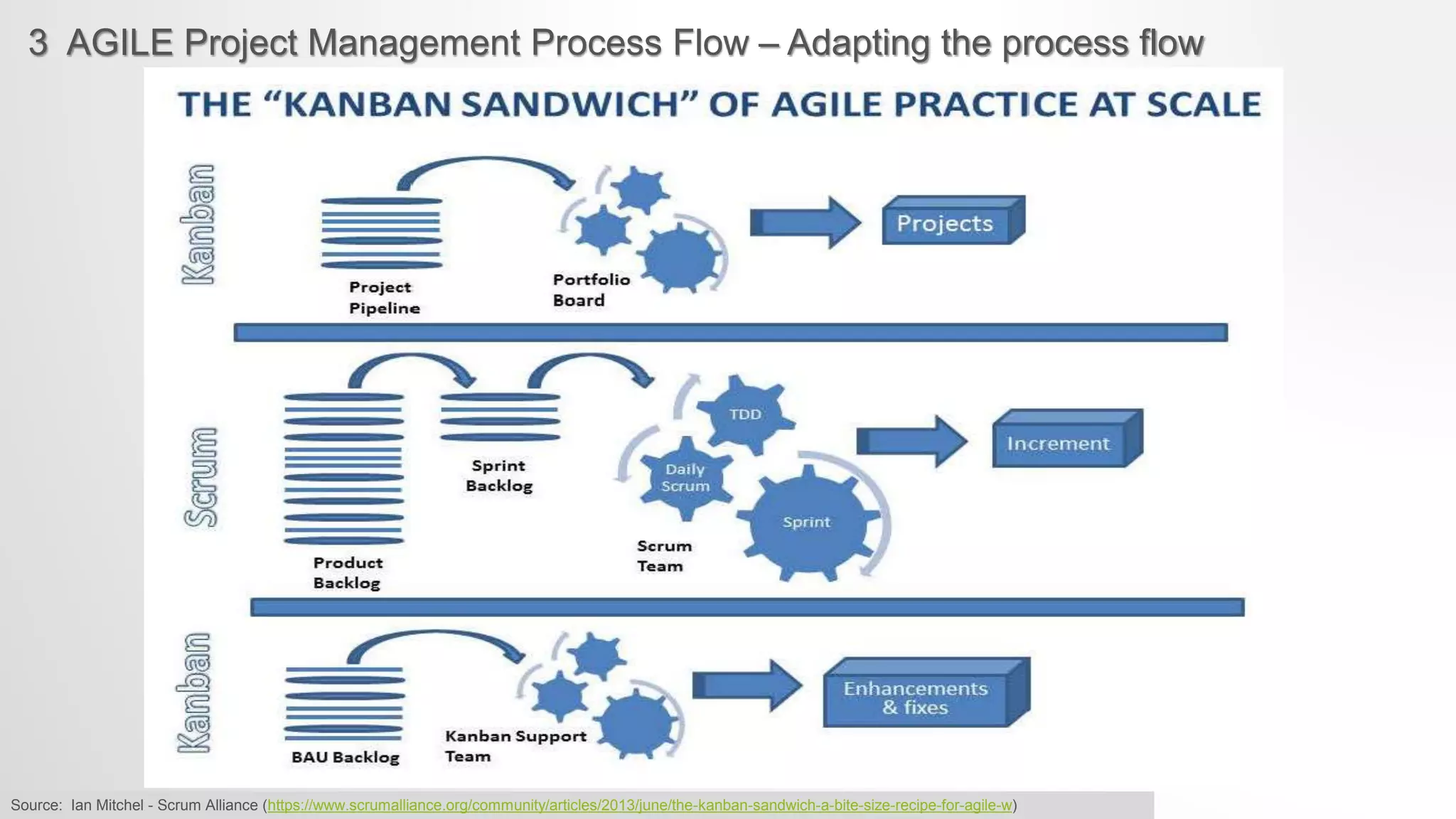

3 AGILE ProjectManagement Process Flow – Adapting the process flow
Source: Ian Mitchel - Scrum Alliance (https://www.scrumalliance.org/community/articles/2013/june/the-kanban-sandwich-a-bite-size-recipe-for-agile-w)
15.
3 AGILE ProjectManagement Process Flow – Adapting the process flow
Source: Gary Lister – Project Management Roots and Understanding the PMBOK Guide (FT Press – Pearson) (http://www.ftpress.com/articles/article.aspx?p=2261742&seqNum=12)

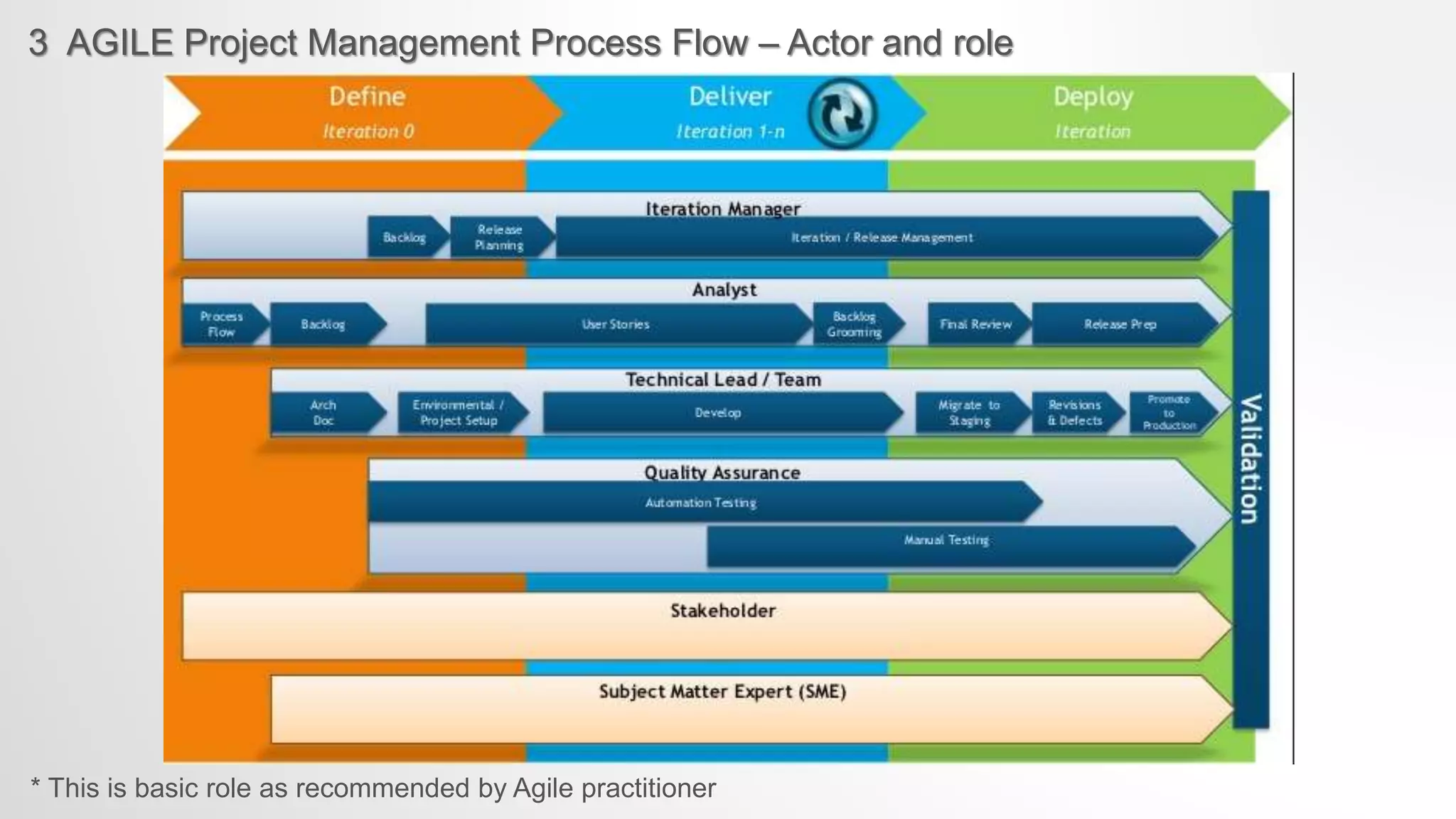

16.
3 AGILE ProjectManagement Process Flow – Actor and role
* This is basic role as recommended by Agile practitioner

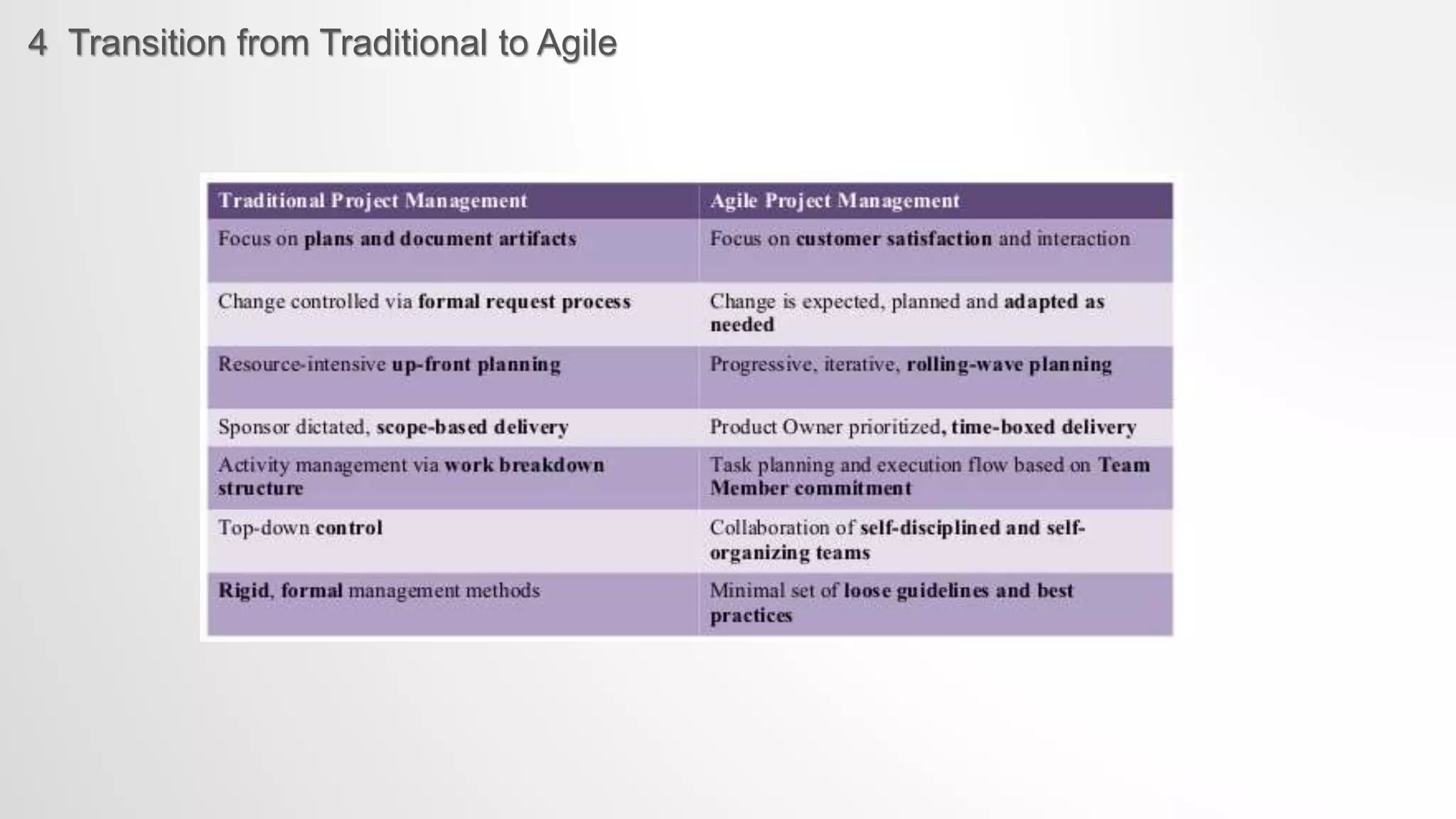

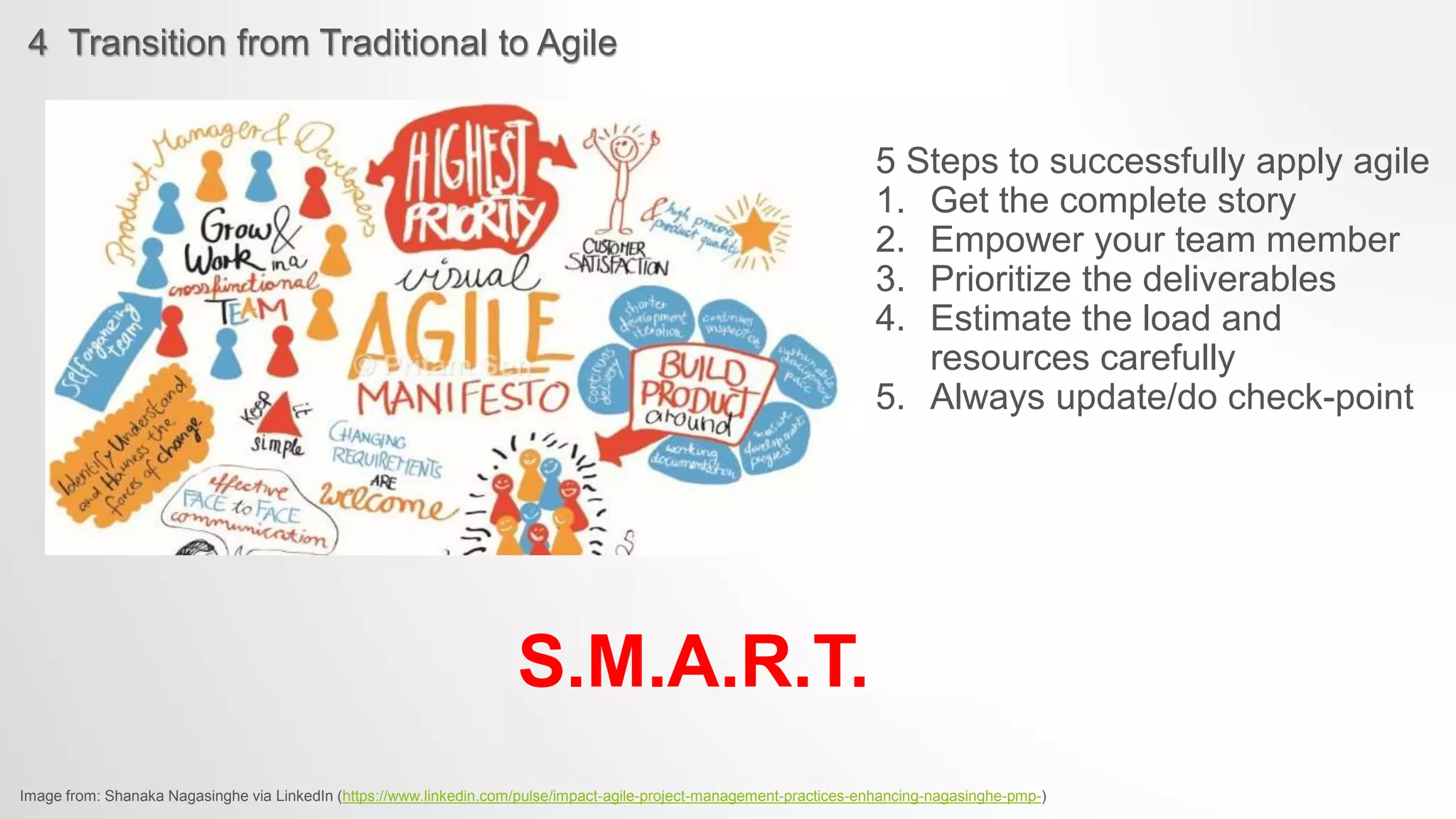

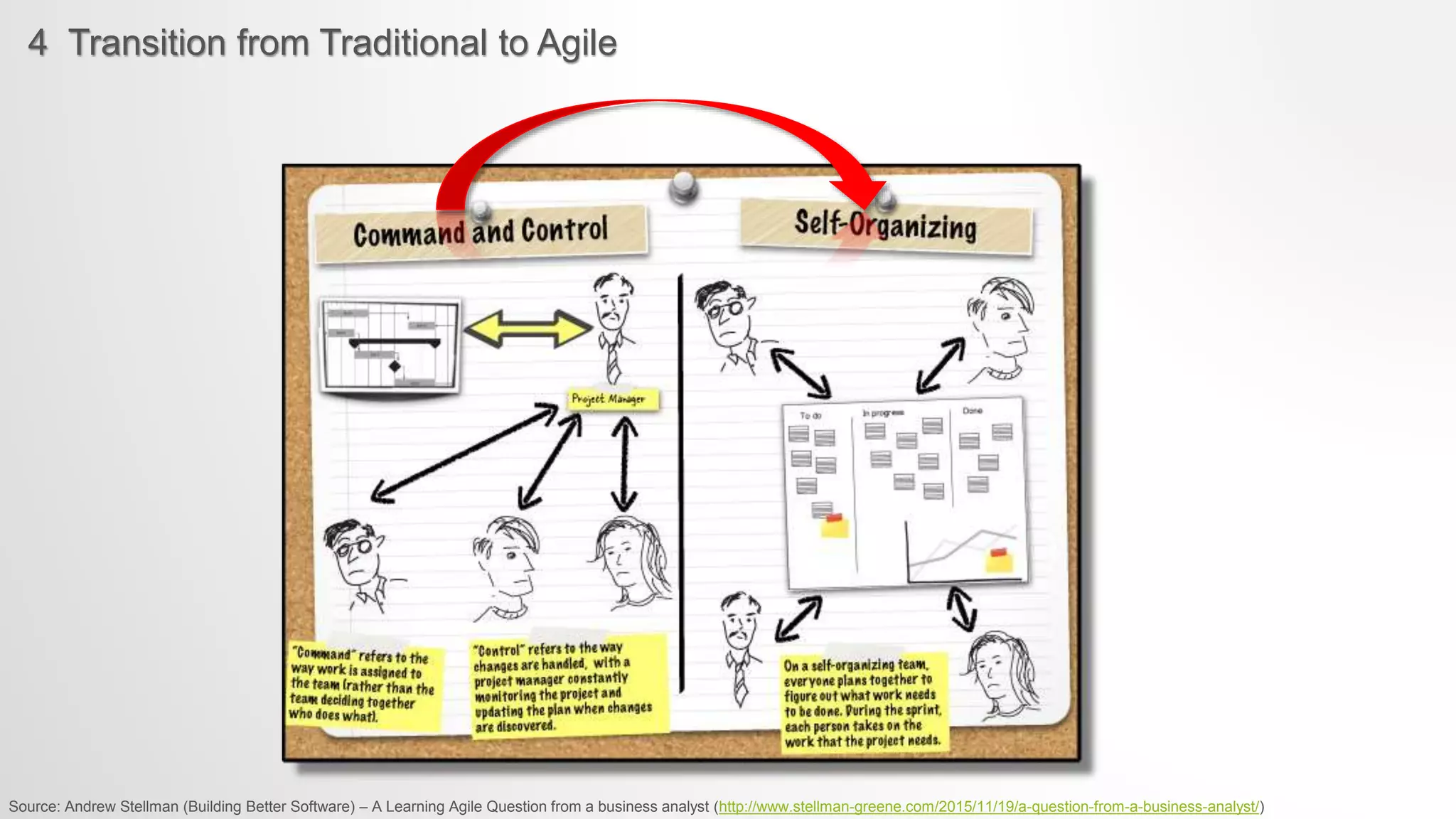

4 Transition fromTraditional to Agile
Source: Andrew Stellman (Building Better Software) – A Learning Agile Question from a business analyst (http://www.stellman-greene.com/2015/11/19/a-question-from-a-business-analyst/)
4 Transition fromTraditional to Agile
5 Steps to successfully apply agile
1. Get the complete story
2. Empower your team member
3. Prioritize the deliverables
4. Estimate the load and
resources carefully
5. Always update/do check-point
S.M.A.R.T.
Image from: Shanaka Nagasinghe via LinkedIn (https://www.linkedin.com/pulse/impact-agile-project-management-practices-enhancing-nagasinghe-pmp-)
21.

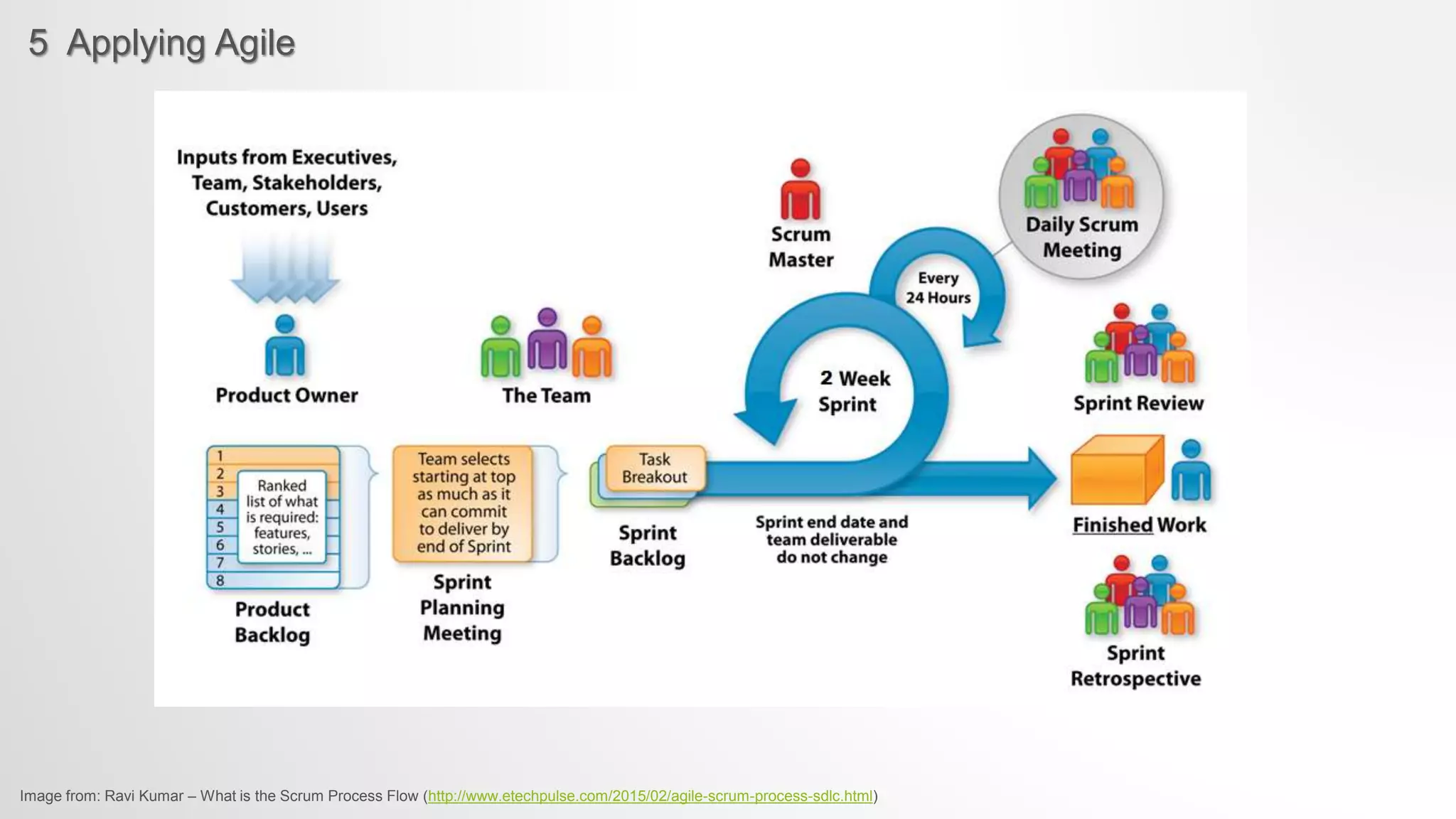

5 Applying Agile
Imagefrom: Ravi Kumar – What is the Scrum Process Flow (http://www.etechpulse.com/2015/02/agile-scrum-process-sdlc.html)
22.

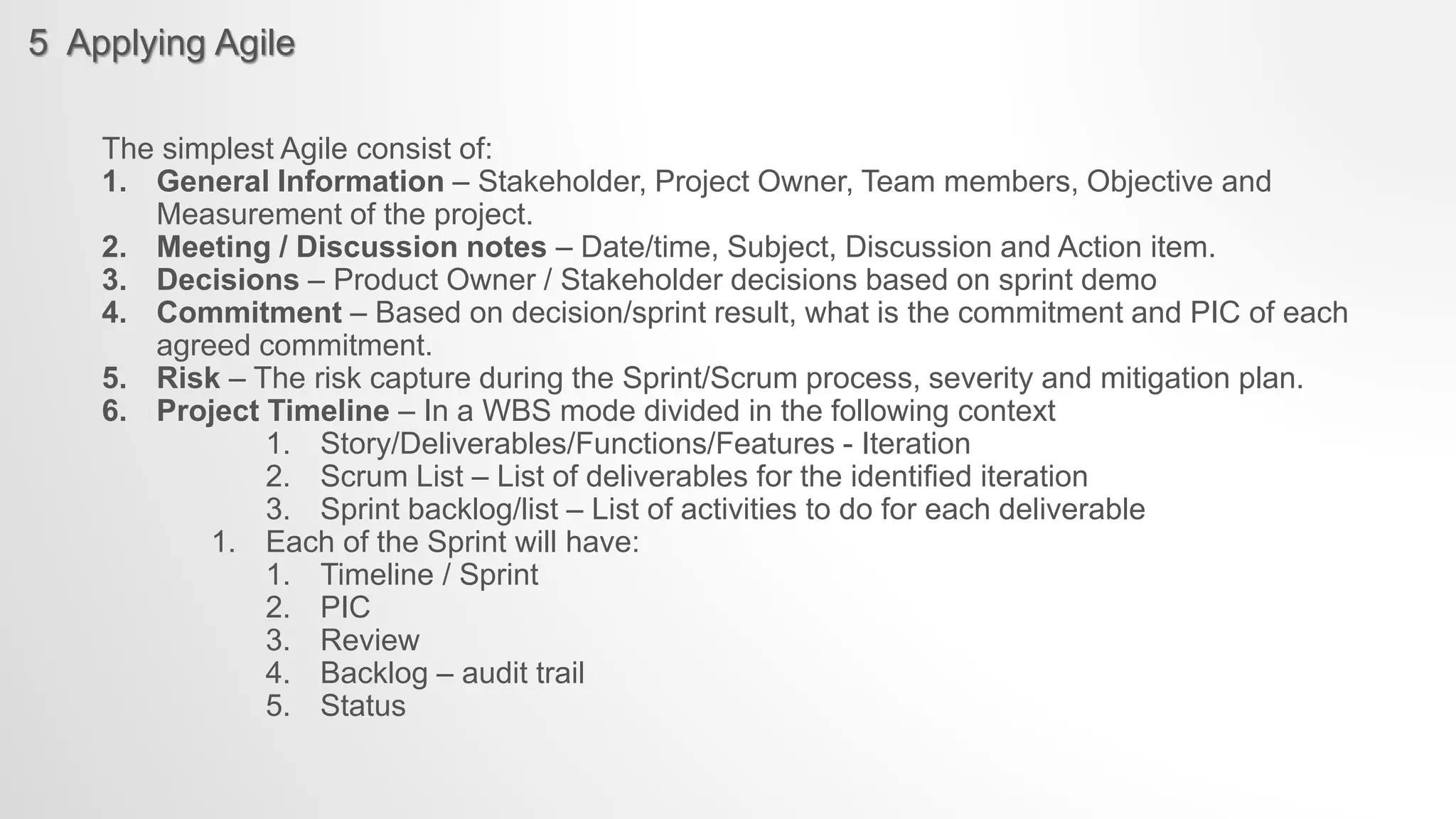

5 Applying Agile

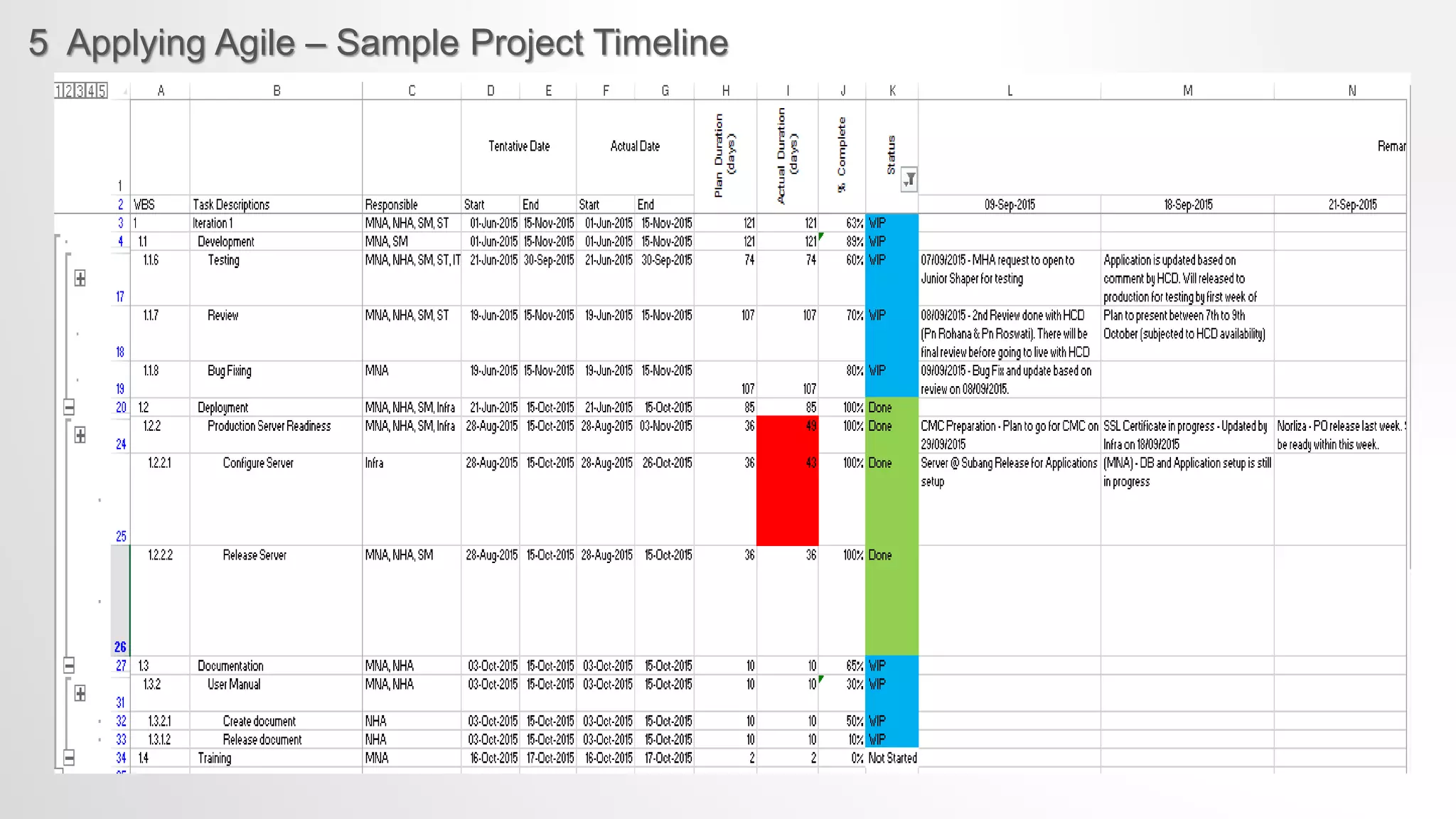

Thesimplest Agile consist of:
1. General Information – Stakeholder, Project Owner, Team members, Objective and
Measurement of the project.
2. Meeting / Discussion notes – Date/time, Subject, Discussion and Action item.
3. Decisions – Product Owner / Stakeholder decisions based on sprint demo
4. Commitment – Based on decision/sprint result, what is the commitment and PIC of each
agreed commitment.
5. Risk – The risk capture during the Sprint/Scrum process, severity and mitigation plan.
6. Project Timeline – In a WBS mode divided in the following context
1. Story/Deliverables/Functions/Features - Iteration
2. Scrum List – List of deliverables for the identified iteration
3. Sprint backlog/list – List of activities to do for each deliverable
1. Each of the Sprint will have:
1. Timeline / Sprint
2. PIC
3. Review
4. Backlog – audit trail
5. Status
23.

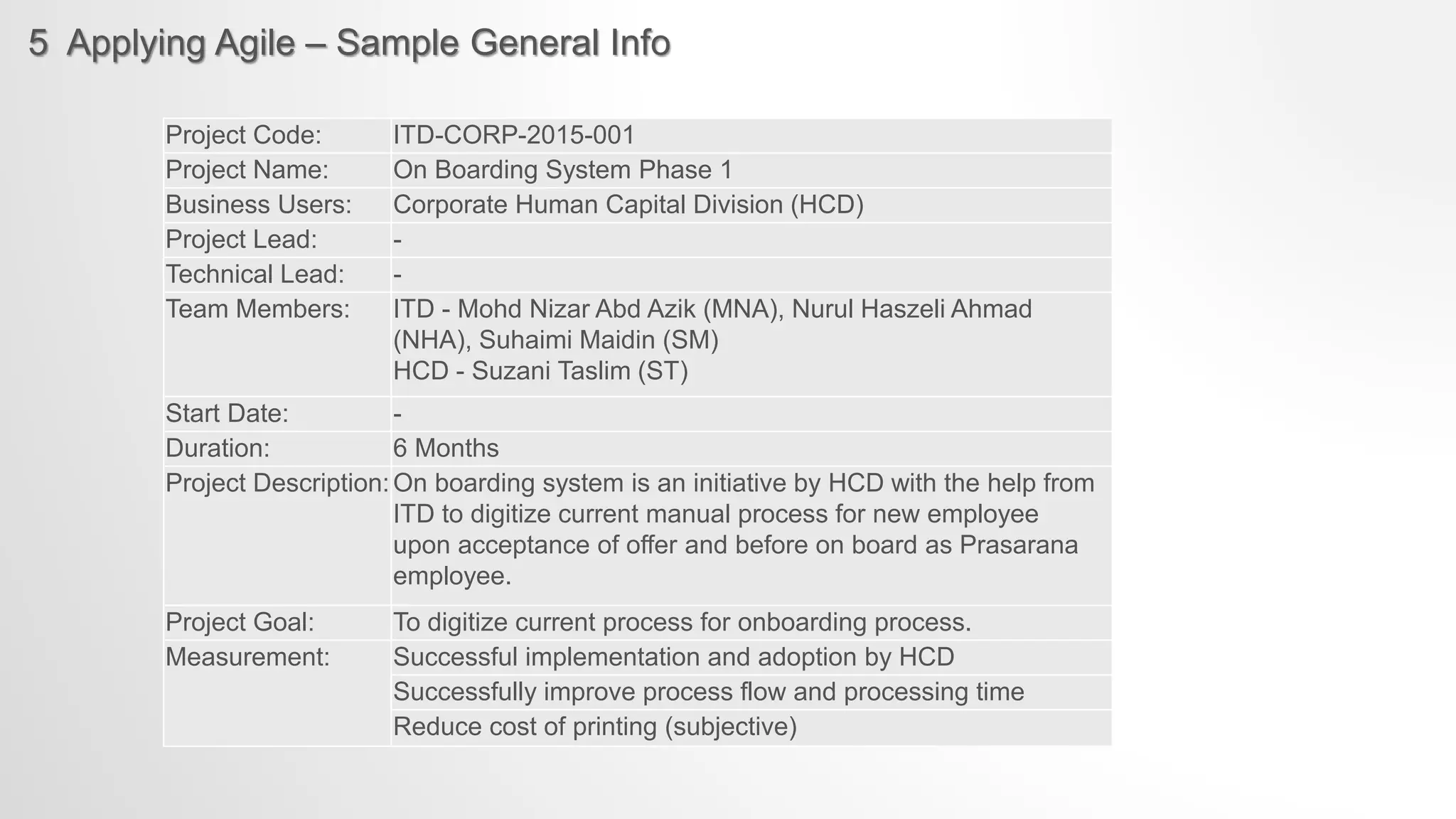

5 Applying Agile– Sample General Info
Project Code: ITD-CORP-2015-001
Project Name: On Boarding System Phase 1
Business Users: Corporate Human Capital Division (HCD)
Project Lead: -
Technical Lead: -
Team Members: ITD - Mohd Nizar Abd Azik (MNA), Nurul Haszeli Ahmad
(NHA), Suhaimi Maidin (SM)
HCD - Suzani Taslim (ST)
Start Date: -
Duration: 6 Months
Project Description:On boarding system is an initiative by HCD with the help from
ITD to digitize current manual process for new employee
upon acceptance of offer and before on board as Prasarana
employee.
Project Goal: To digitize current process for onboarding process.
Measurement: Successful implementation and adoption by HCD
Successfully improve process flow and processing time
Reduce cost of printing (subjective)
24.

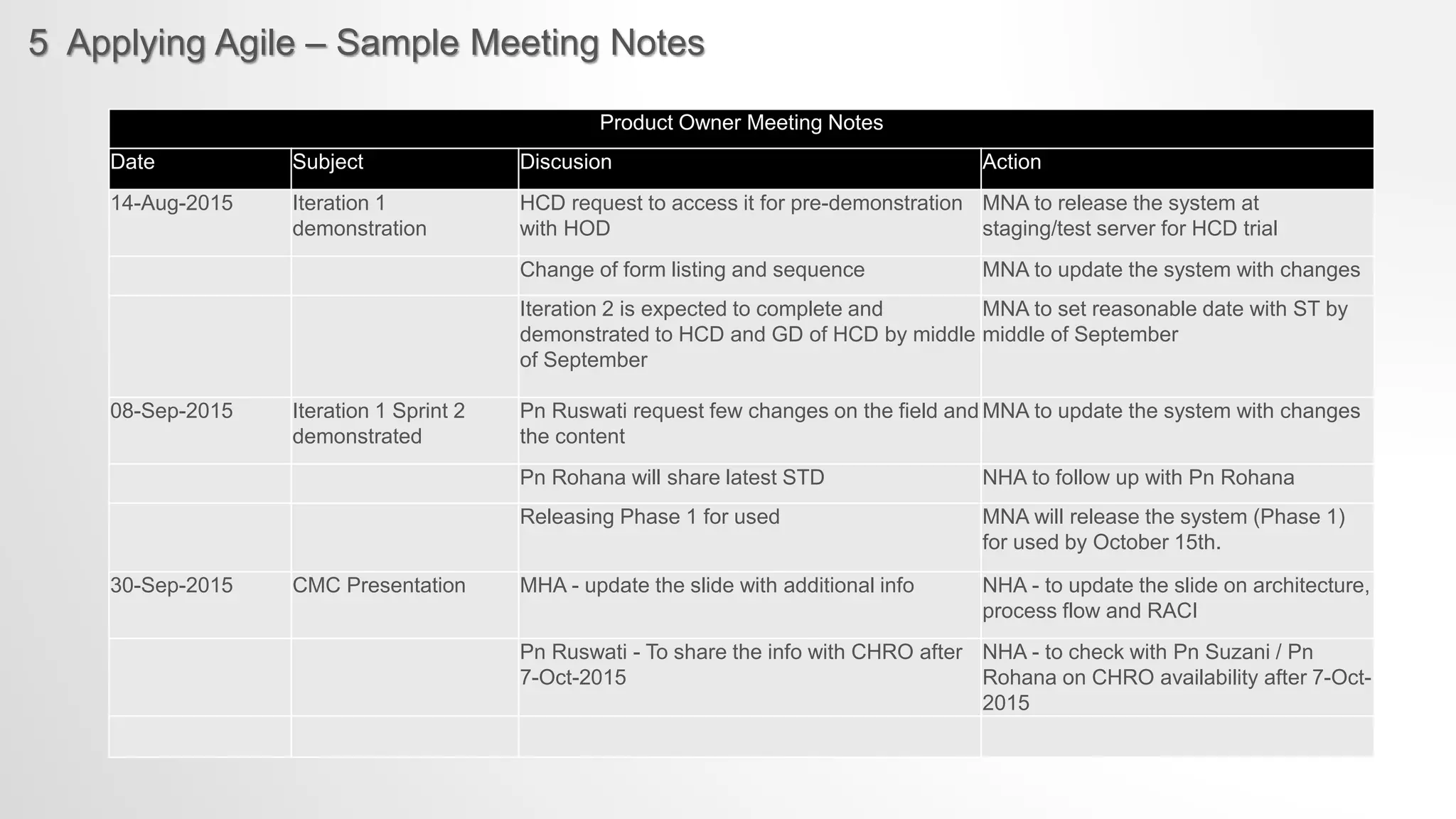

5 Applying Agile– Sample Meeting Notes
Product Owner Meeting Notes
Date Subject Discusion Action
14-Aug-2015 Iteration 1
demonstration
HCD request to access it for pre-demonstration
with HOD
MNA to release the system at
staging/test server for HCD trial
Change of form listing and sequence MNA to update the system with changes
Iteration 2 is expected to complete and
demonstrated to HCD and GD of HCD by middle
of September
MNA to set reasonable date with ST by
middle of September
08-Sep-2015 Iteration 1 Sprint 2
demonstrated
Pn Ruswati request few changes on the field and
the content
MNA to update the system with changes
Pn Rohana will share latest STD NHA to follow up with Pn Rohana
Releasing Phase 1 for used MNA will release the system (Phase 1)
for used by October 15th.
30-Sep-2015 CMC Presentation MHA - update the slide with additional info NHA - to update the slide on architecture,
process flow and RACI
Pn Ruswati - To share the info with CHRO after
7-Oct-2015
NHA - to check with Pn Suzani / Pn
Rohana on CHRO availability after 7-Oct-
2015
25.

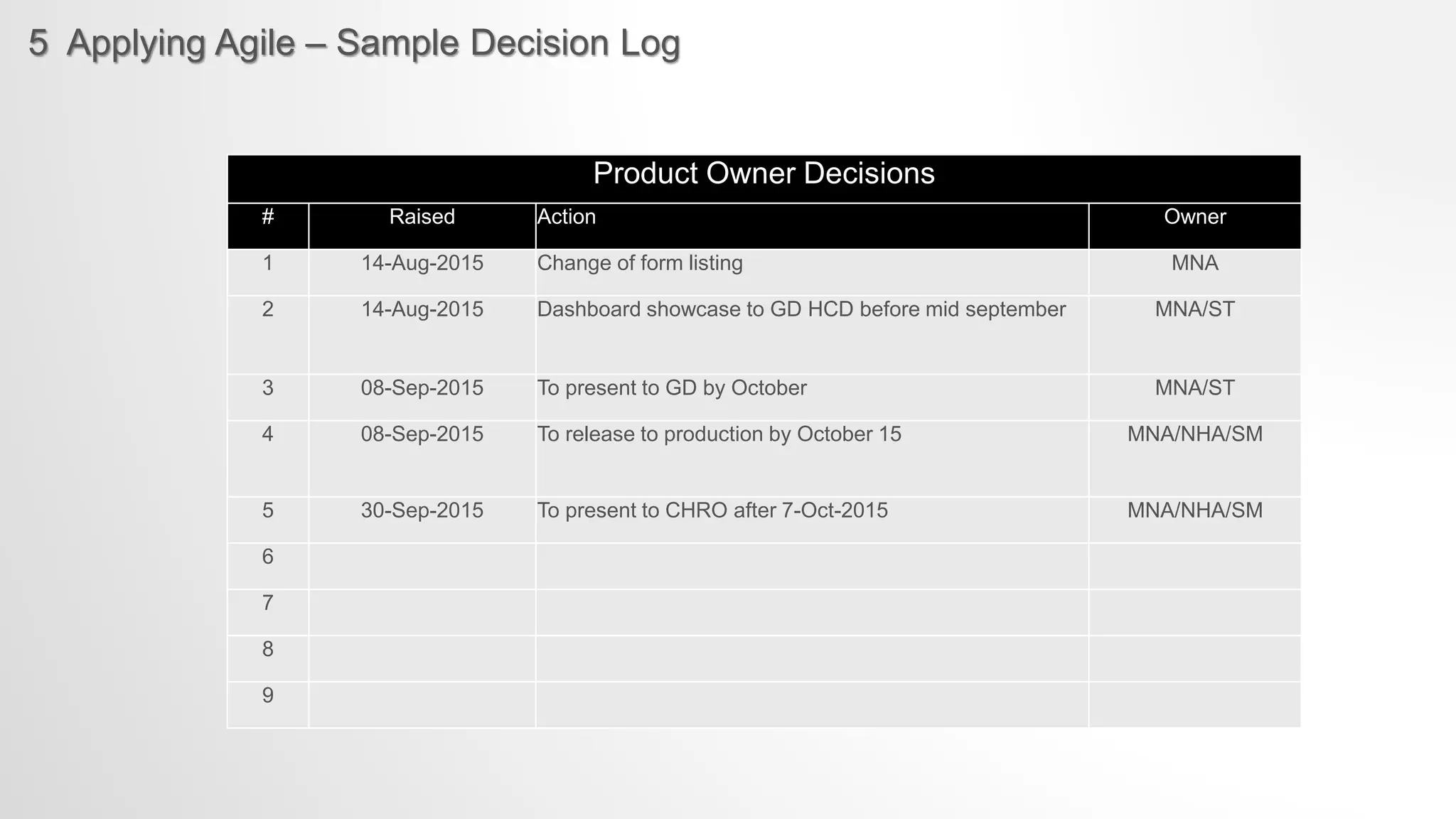

5 Applying Agile– Sample Decision Log
Product Owner Decisions
# Raised Action Owner
1 14-Aug-2015 Change of form listing MNA
2 14-Aug-2015 Dashboard showcase to GD HCD before mid september MNA/ST
3 08-Sep-2015 To present to GD by October MNA/ST
4 08-Sep-2015 To release to production by October 15 MNA/NHA/SM
5 30-Sep-2015 To present to CHRO after 7-Oct-2015 MNA/NHA/SM
6
7
8
9
26.

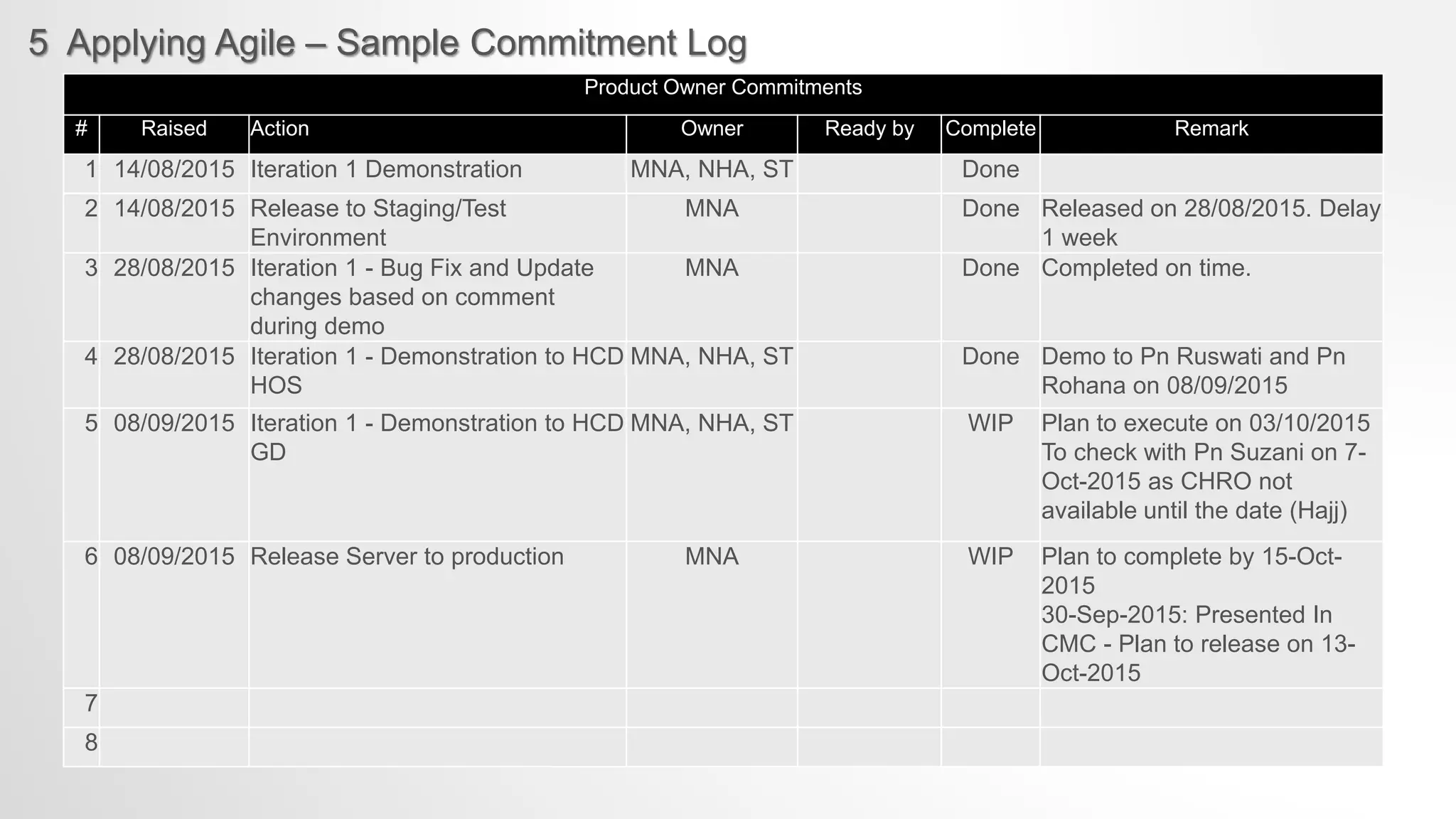

5 Applying Agile– Sample Commitment Log
Product Owner Commitments
# Raised Action Owner Ready by Complete Remark
1 14/08/2015 Iteration 1 Demonstration MNA, NHA, ST Done
2 14/08/2015 Release to Staging/Test
Environment
MNA Done Released on 28/08/2015. Delay
1 week
3 28/08/2015 Iteration 1 - Bug Fix and Update
changes based on comment
during demo
MNA Done Completed on time.
4 28/08/2015 Iteration 1 - Demonstration to HCD
HOS
MNA, NHA, ST Done Demo to Pn Ruswati and Pn
Rohana on 08/09/2015
5 08/09/2015 Iteration 1 - Demonstration to HCD
GD
MNA, NHA, ST WIP Plan to execute on 03/10/2015
To check with Pn Suzani on 7-
Oct-2015 as CHRO not
available until the date (Hajj)
6 08/09/2015 Release Server to production MNA WIP Plan to complete by 15-Oct-
2015
30-Sep-2015: Presented In
CMC - Plan to release on 13-
Oct-2015
7
8
27.

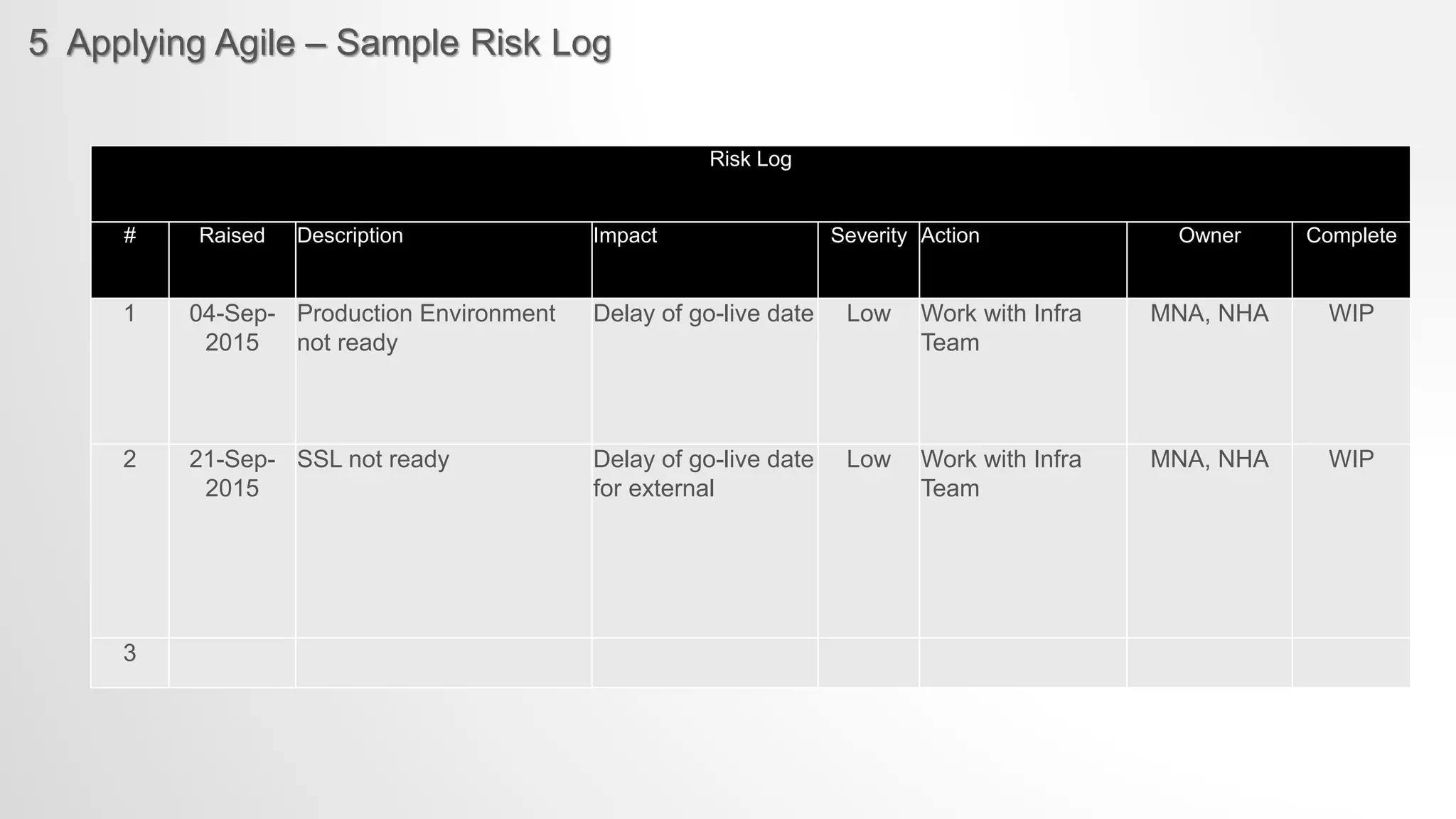

5 Applying Agile– Sample Risk Log
Risk Log
# Raised Description Impact Severity Action Owner Complete
1 04-Sep-
2015
Production Environment
not ready
Delay of go-live date Low Work with Infra
Team
MNA, NHA WIP
2 21-Sep-
2015
SSL not ready Delay of go-live date
for external
Low Work with Infra
Team
MNA, NHA WIP
3

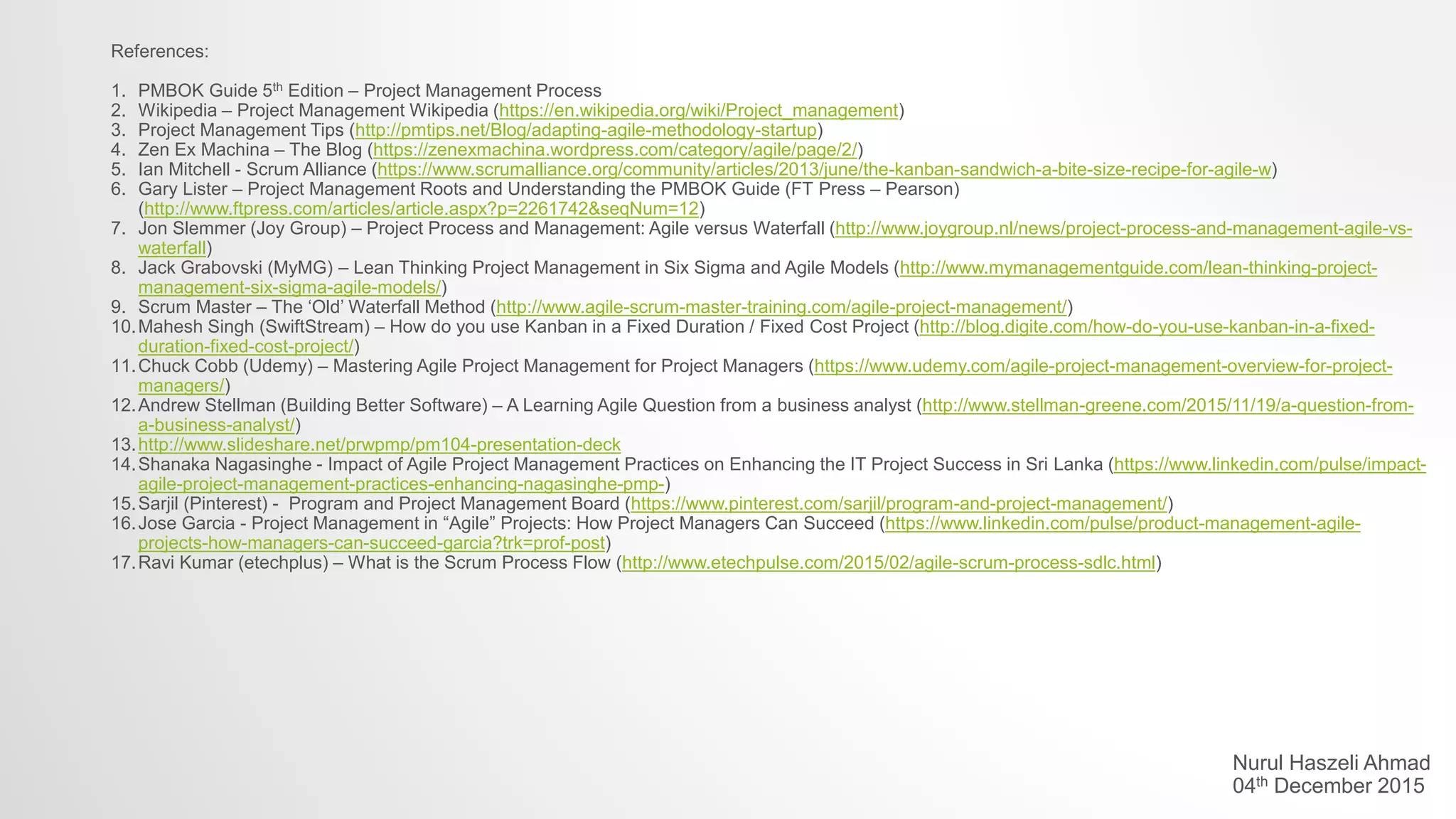

References:
1. PMBOK Guide5th Edition – Project Management Process
2. Wikipedia – Project Management Wikipedia (https://en.wikipedia.org/wiki/Project_management)
3. Project Management Tips (http://pmtips.net/Blog/adapting-agile-methodology-startup)
4. Zen Ex Machina – The Blog (https://zenexmachina.wordpress.com/category/agile/page/2/)
5. Ian Mitchell - Scrum Alliance (https://www.scrumalliance.org/community/articles/2013/june/the-kanban-sandwich-a-bite-size-recipe-for-agile-w)
6. Gary Lister – Project Management Roots and Understanding the PMBOK Guide (FT Press – Pearson)
(http://www.ftpress.com/articles/article.aspx?p=2261742&seqNum=12)
7. Jon Slemmer (Joy Group) – Project Process and Management: Agile versus Waterfall (http://www.joygroup.nl/news/project-process-and-management-agile-vs-
waterfall)
8. Jack Grabovski (MyMG) – Lean Thinking Project Management in Six Sigma and Agile Models (http://www.mymanagementguide.com/lean-thinking-project-
management-six-sigma-agile-models/)
9. Scrum Master – The ‘Old’ Waterfall Method (http://www.agile-scrum-master-training.com/agile-project-management/)
10.Mahesh Singh (SwiftStream) – How do you use Kanban in a Fixed Duration / Fixed Cost Project (http://blog.digite.com/how-do-you-use-kanban-in-a-fixed-
duration-fixed-cost-project/)
11.Chuck Cobb (Udemy) – Mastering Agile Project Management for Project Managers (https://www.udemy.com/agile-project-management-overview-for-project-
managers/)
12.Andrew Stellman (Building Better Software) – A Learning Agile Question from a business analyst (http://www.stellman-greene.com/2015/11/19/a-question-from-
a-business-analyst/)
13.http://www.slideshare.net/prwpmp/pm104-presentation-deck
14.Shanaka Nagasinghe - Impact of Agile Project Management Practices on Enhancing the IT Project Success in Sri Lanka (https://www.linkedin.com/pulse/impact-
agile-project-management-practices-enhancing-nagasinghe-pmp-)
15.Sarjil (Pinterest) - Program and Project Management Board (https://www.pinterest.com/sarjil/program-and-project-management/)
16.Jose Garcia - Project Management in “Agile” Projects: How Project Managers Can Succeed (https://www.linkedin.com/pulse/product-management-agile-
projects-how-managers-can-succeed-garcia?trk=prof-post)
17.Ravi Kumar (etechplus) – What is the Scrum Process Flow (http://www.etechpulse.com/2015/02/agile-scrum-process-sdlc.html)
Nurul Haszeli Ahmad
04th December 2015
#10 A project management process that encourages frequent inspection and adaptation
A leadership philosophy that encourages team work, self-organization and accountability
A set of engineering best practices that allow for rapid delivery of high-quality software
A business approach that aligns development with customer needs and company goals.
