Agile Estimating and Planning
Using Scrum

    Tommy Norman
    Systems Architect / Certified Scrum Master
Agenda
1. Introductions
2. Traditional Techniques
3. Research & Statistics
4. Scrum in 5 Minutes
5. Agile Estimation
6. Agile Planning Using Scrum
7. Q & A
                                2
Introductions

                3

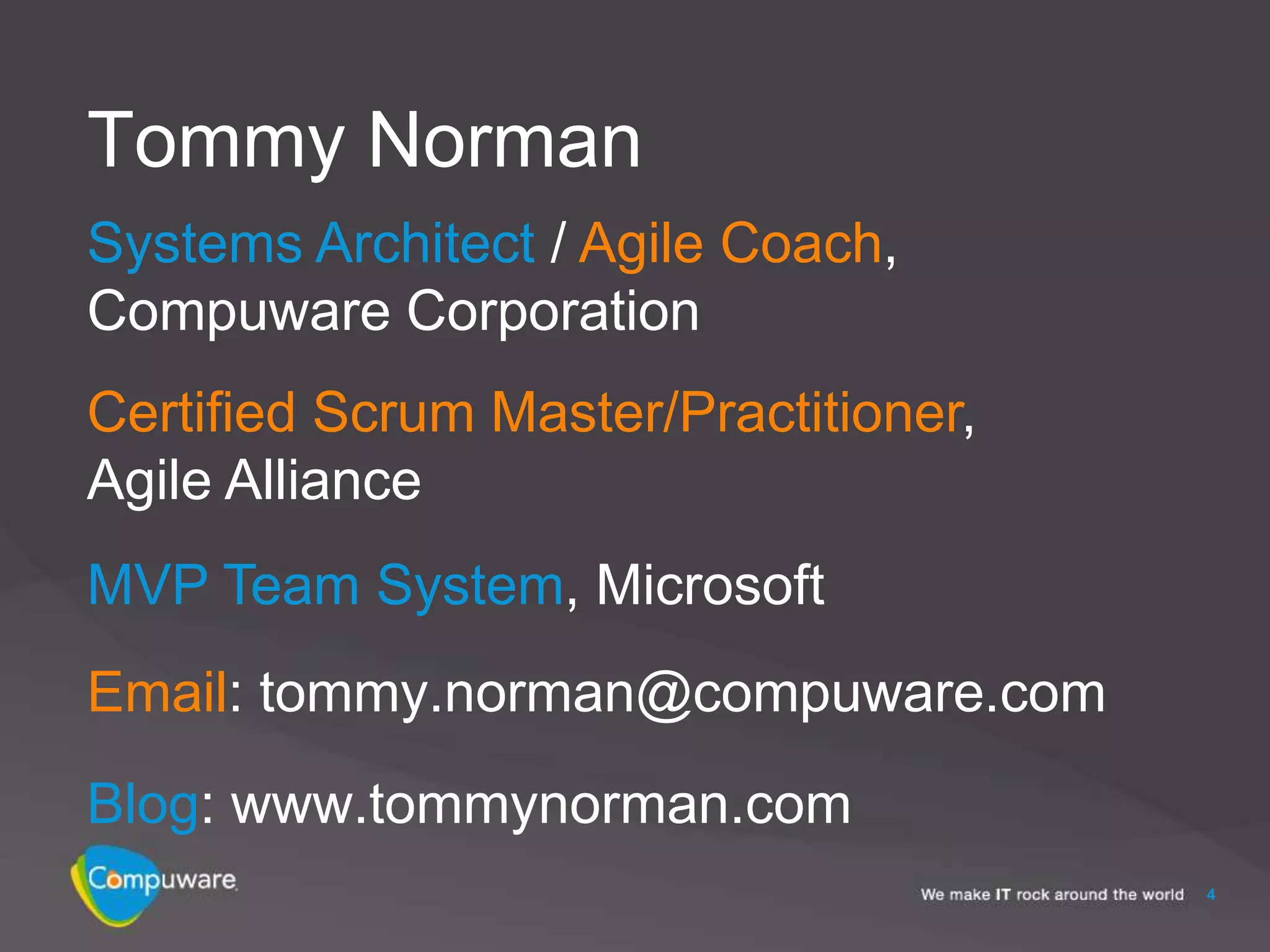

Tommy Norman
Systems Architect / Agile Coach,
Compuware Corporation
Certified Scrum Master/Practitioner,
Agile Alliance
MVP Team System, Microsoft
Email: tommy.norman@compuware.com
Blog: www.tommynorman.com
                                       4
There is no
Santa Claus.

                  The Easter
               Bunny is dead.

Agile is not a silver bullet.
Traditional
Techniques

              6

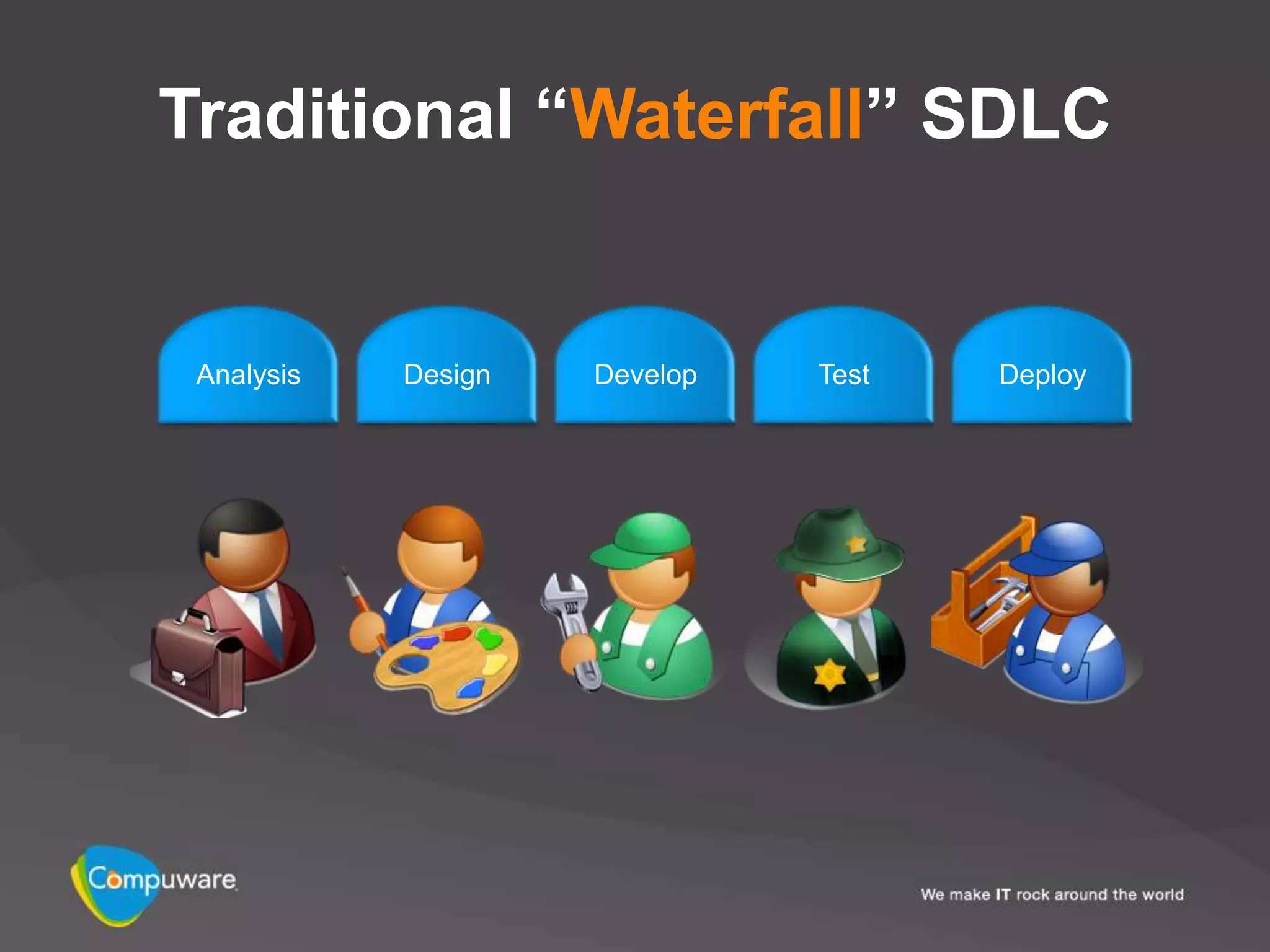

Traditional “Waterfall” SDLC

 Analysis   Design   Develop   Test   Deploy

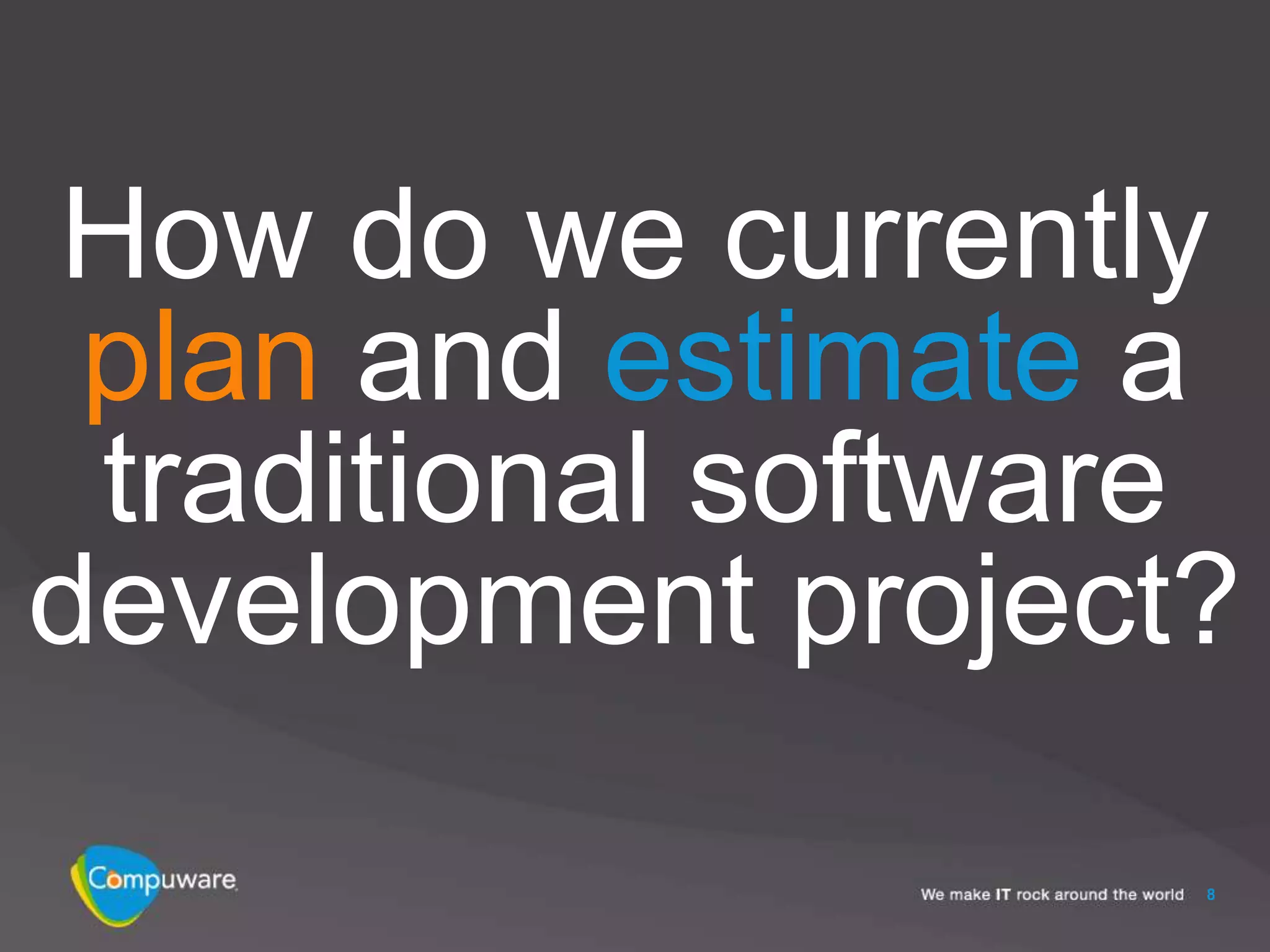

How do we currently
 plan and estimate a
 traditional software
development project?

                    8
Business Case

                Business
                 Owner

                           9
Business Case

Project Charter

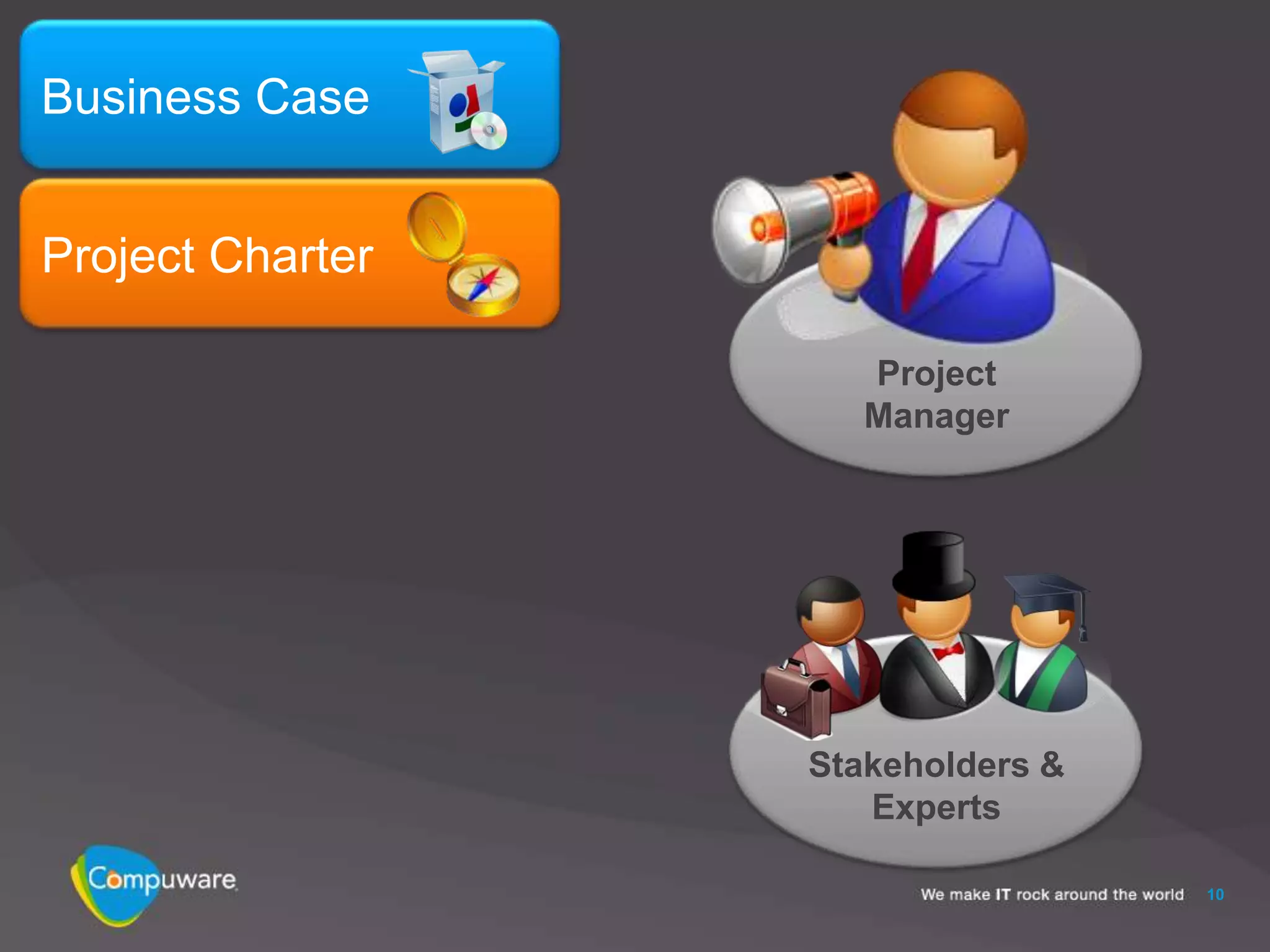

                     Project
                     Manager

                  Stakeholders &
                     Experts

                                   10

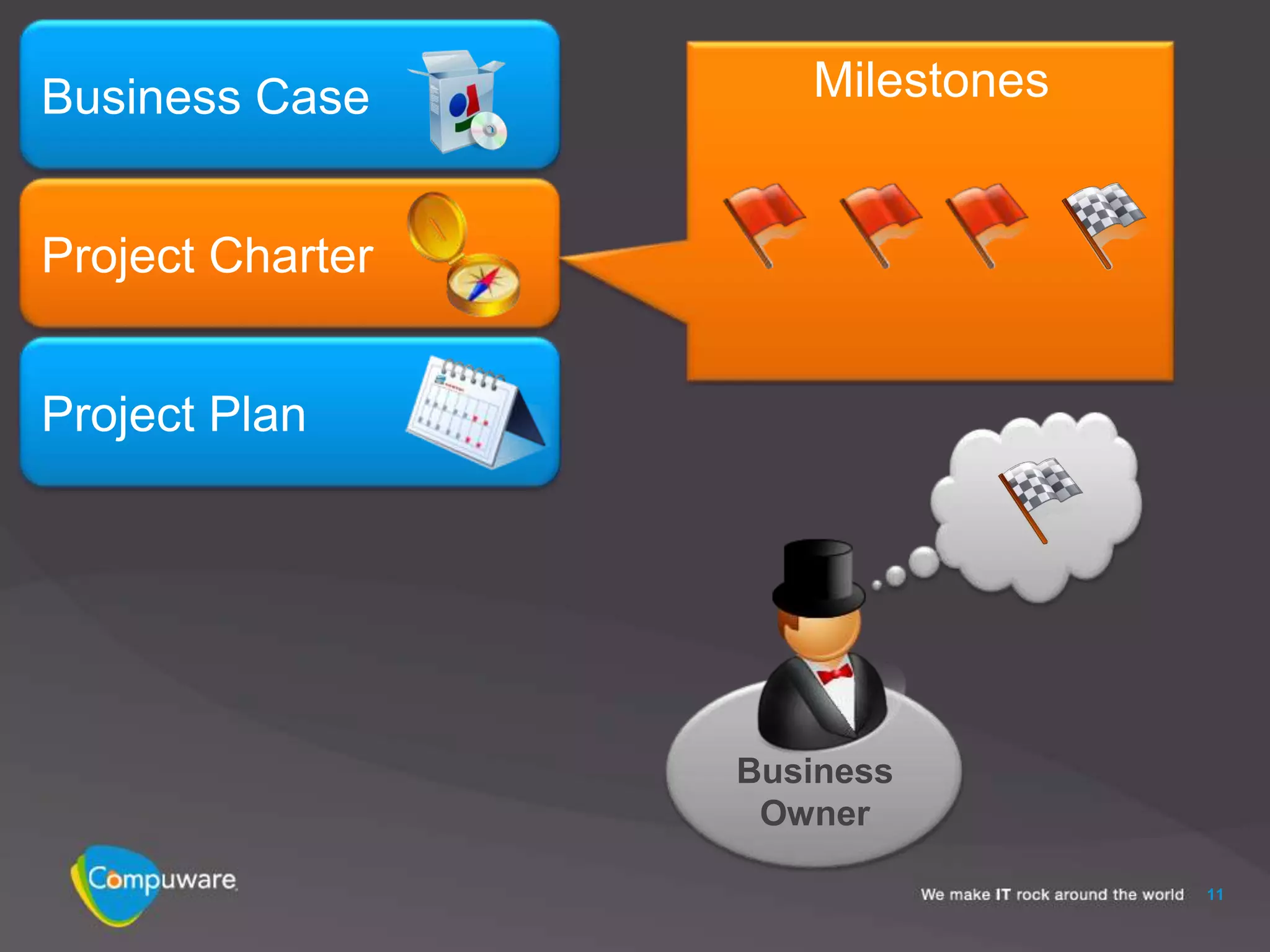

Business Case        Milestones

Project Charter

Project Plan

                  Business
                   Owner

                                  11

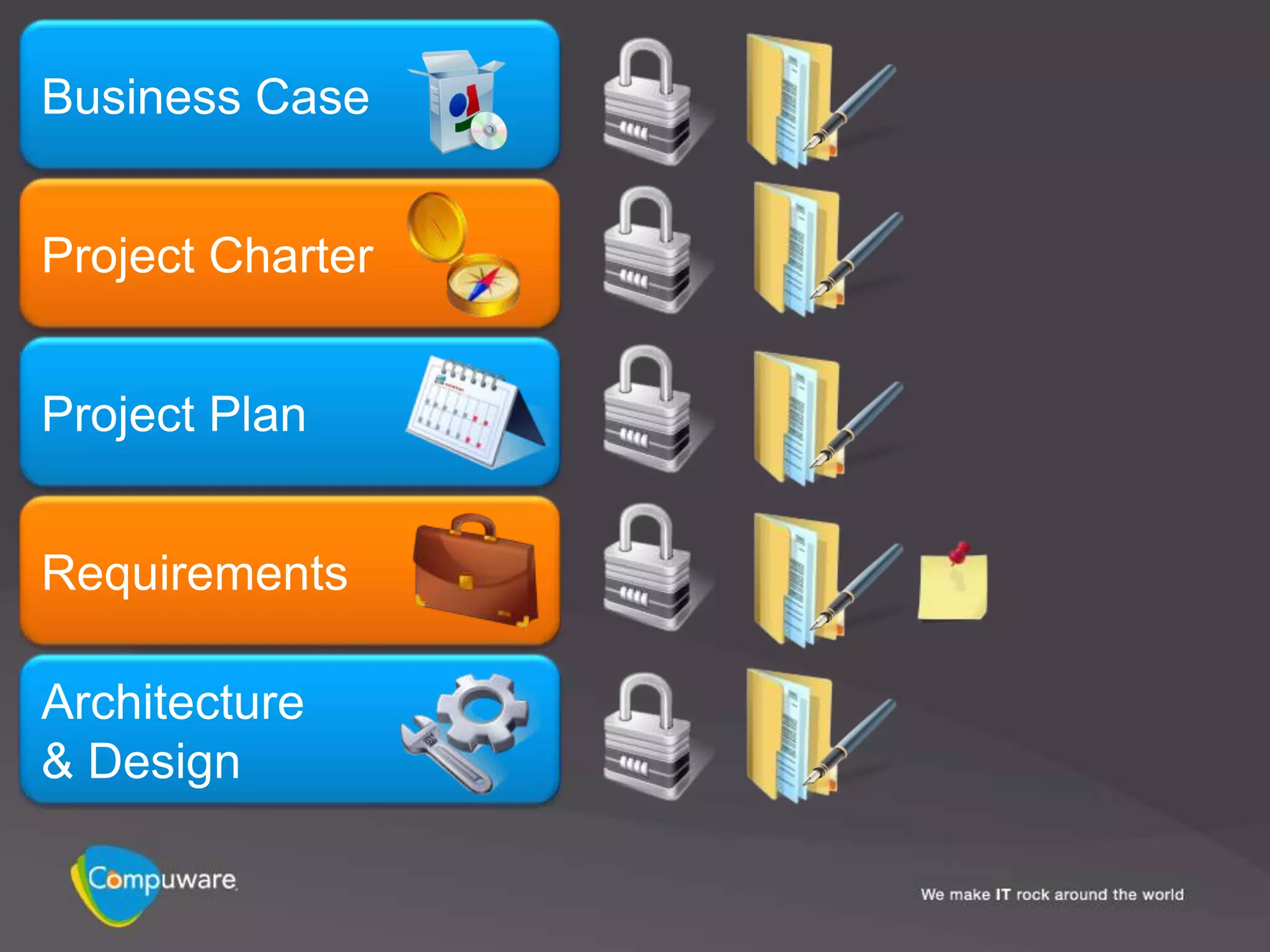

Business Case

Project Charter

Project Plan

                  12

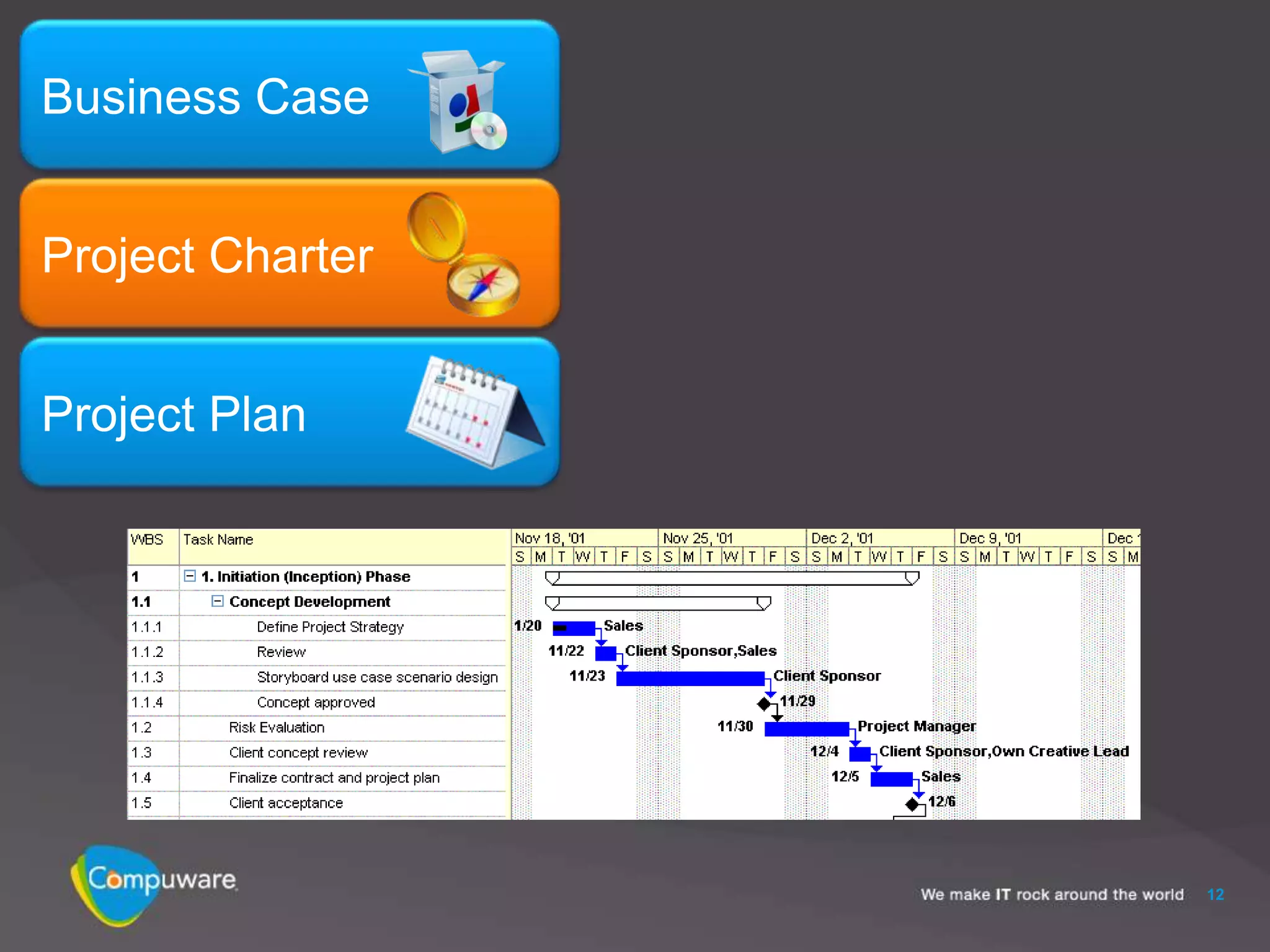

Business Case

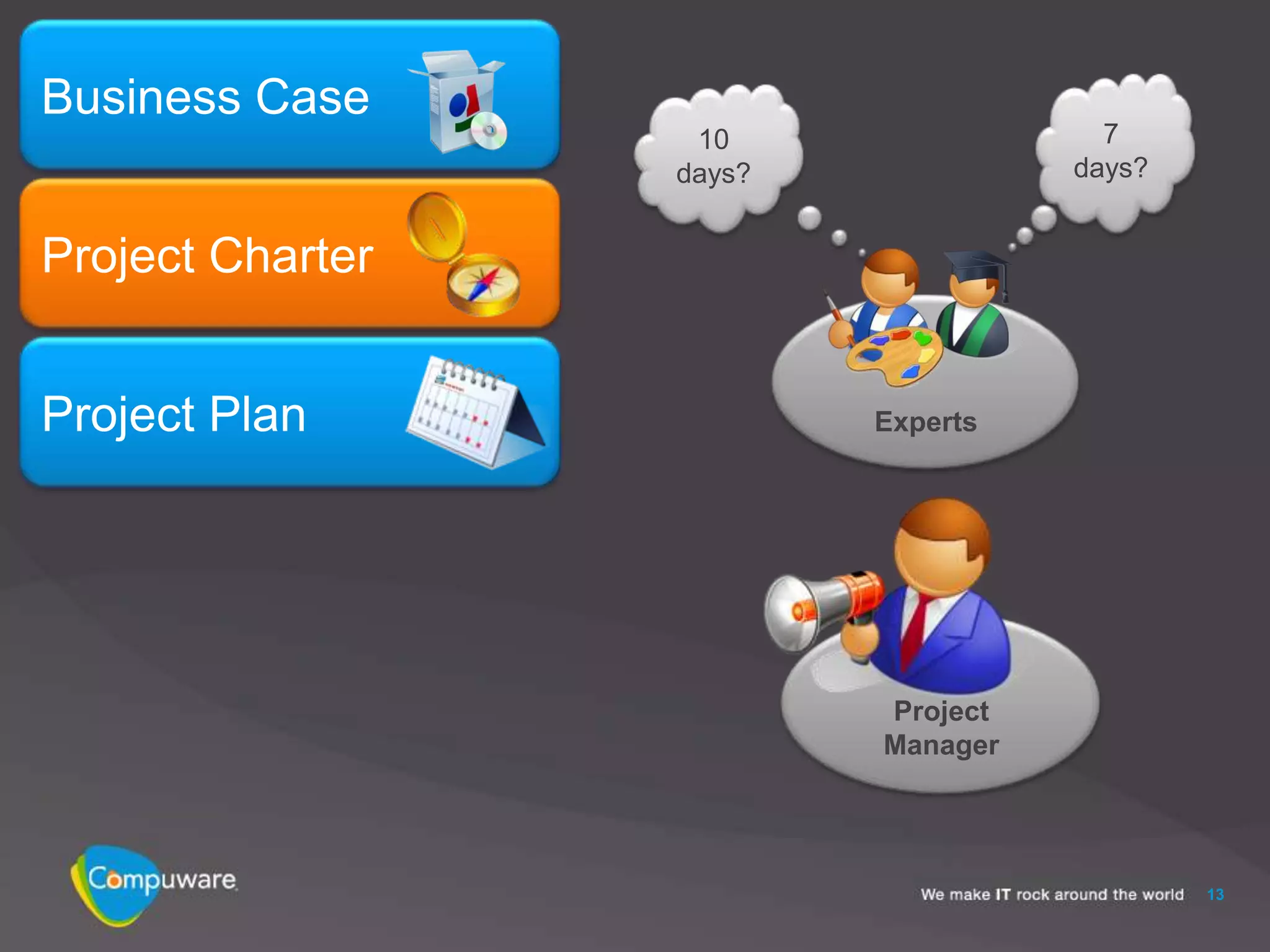

                   10                 7
                  days?             days?

Project Charter

Project Plan              Experts

                          Project
                          Manager

                                            13

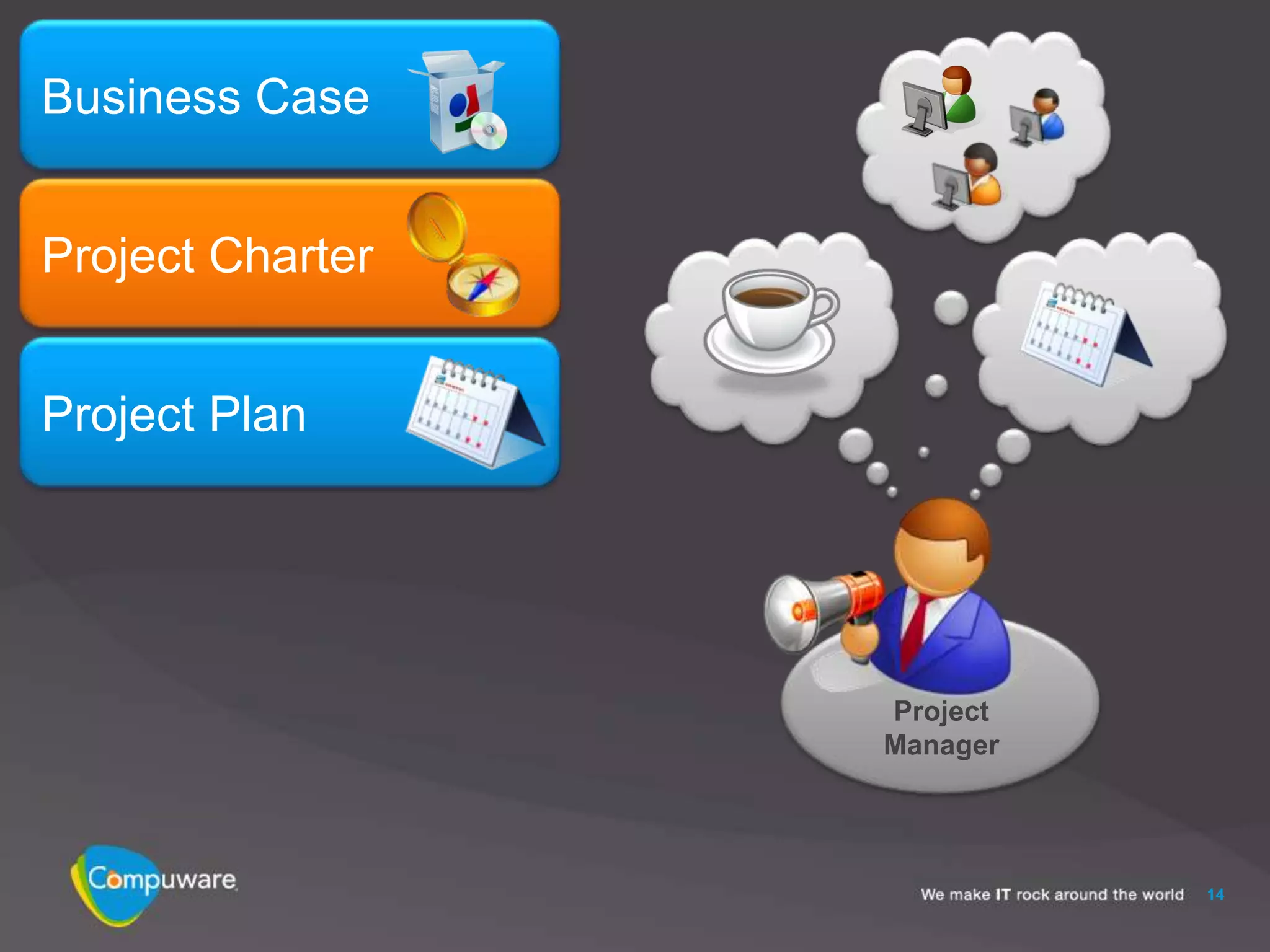

Business Case

Project Charter

Project Plan

                  Project
                  Manager

                            14

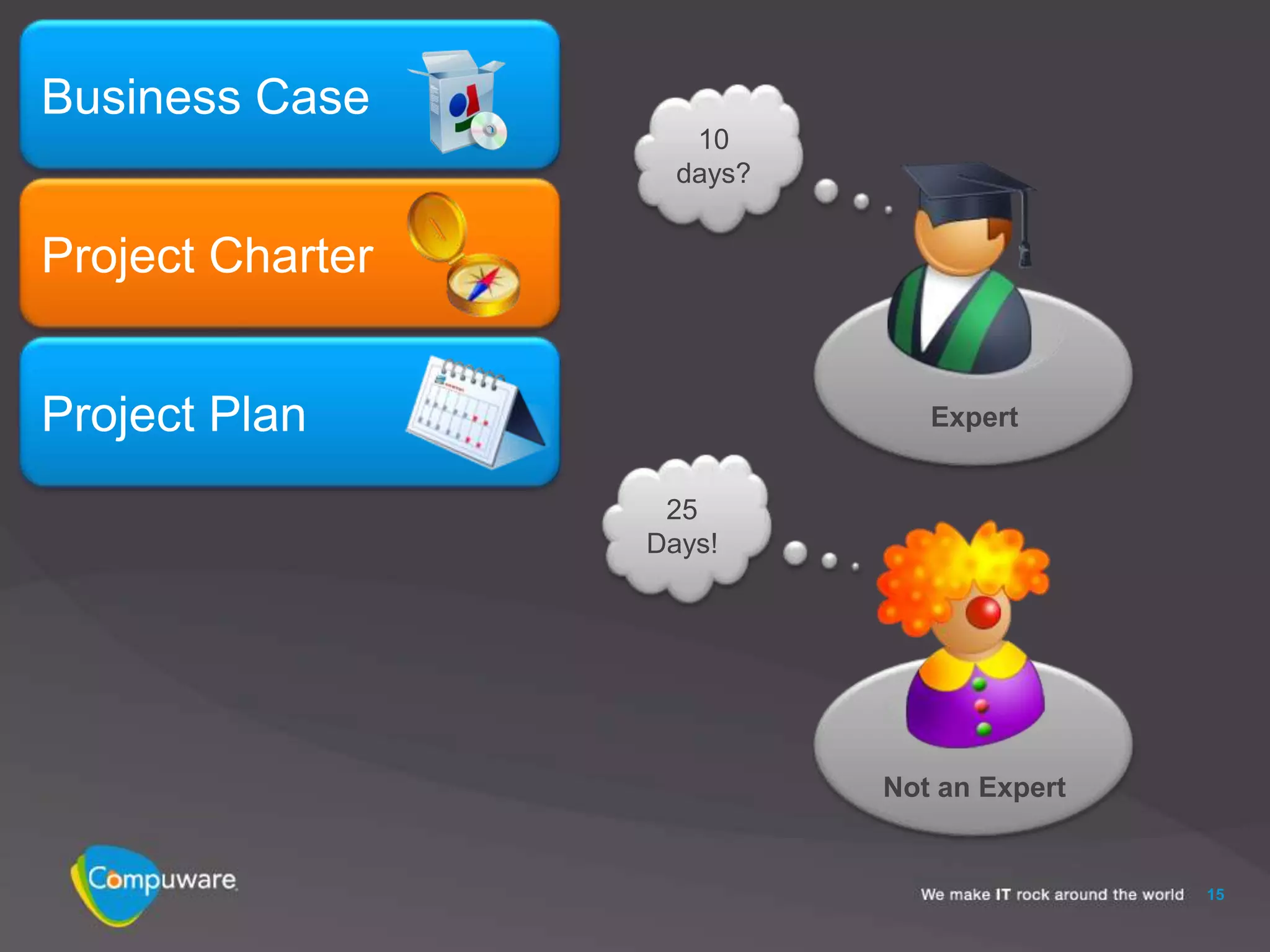

Business Case
                     10
                    days?

Project Charter

Project Plan                   Expert

                   25
                  Days!

                            Not an Expert

                                            15

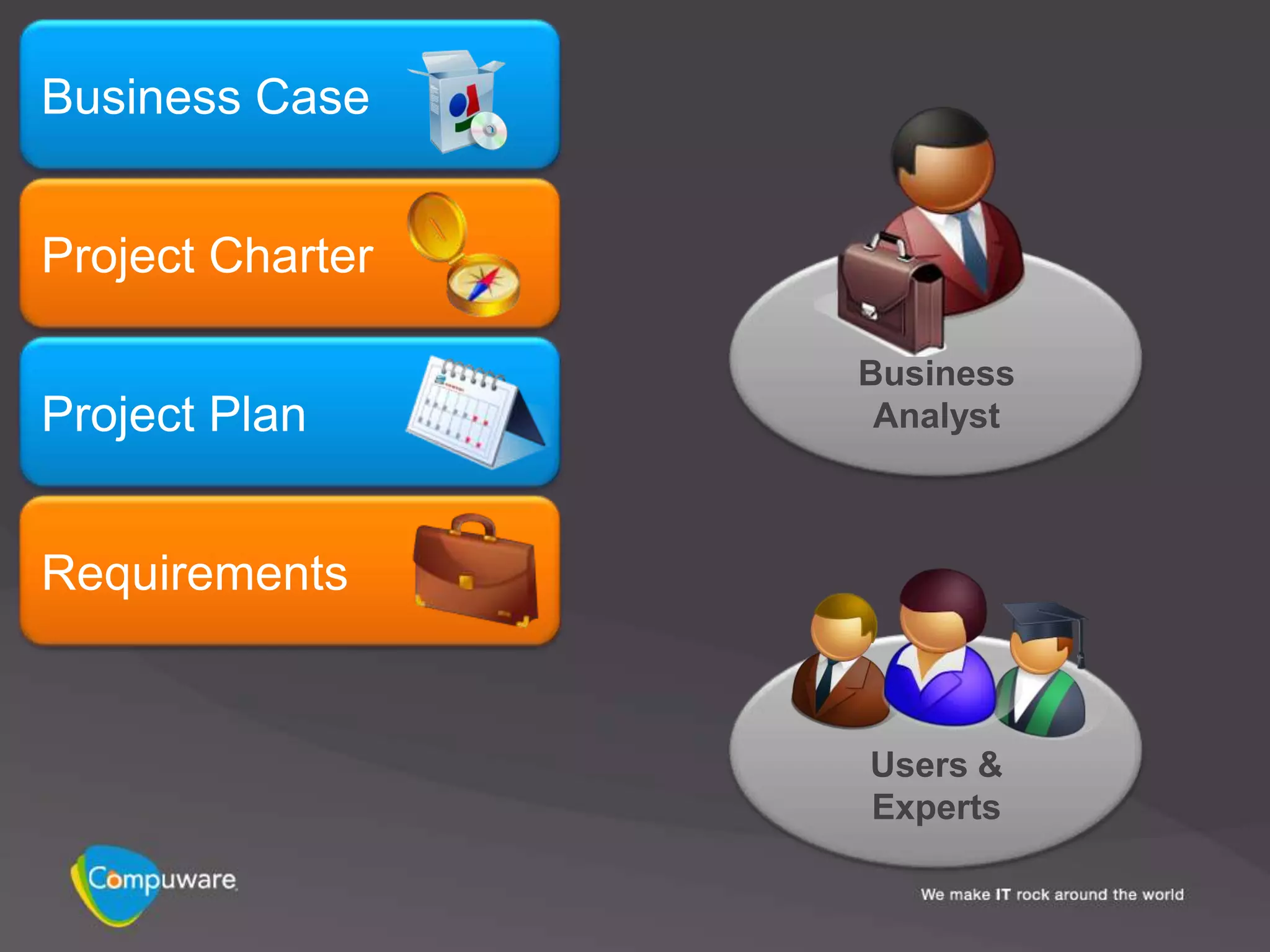

Business Case

Project Charter

                  Business
Project Plan       Analyst

Requirements

                  Users &
                  Experts
Business Case

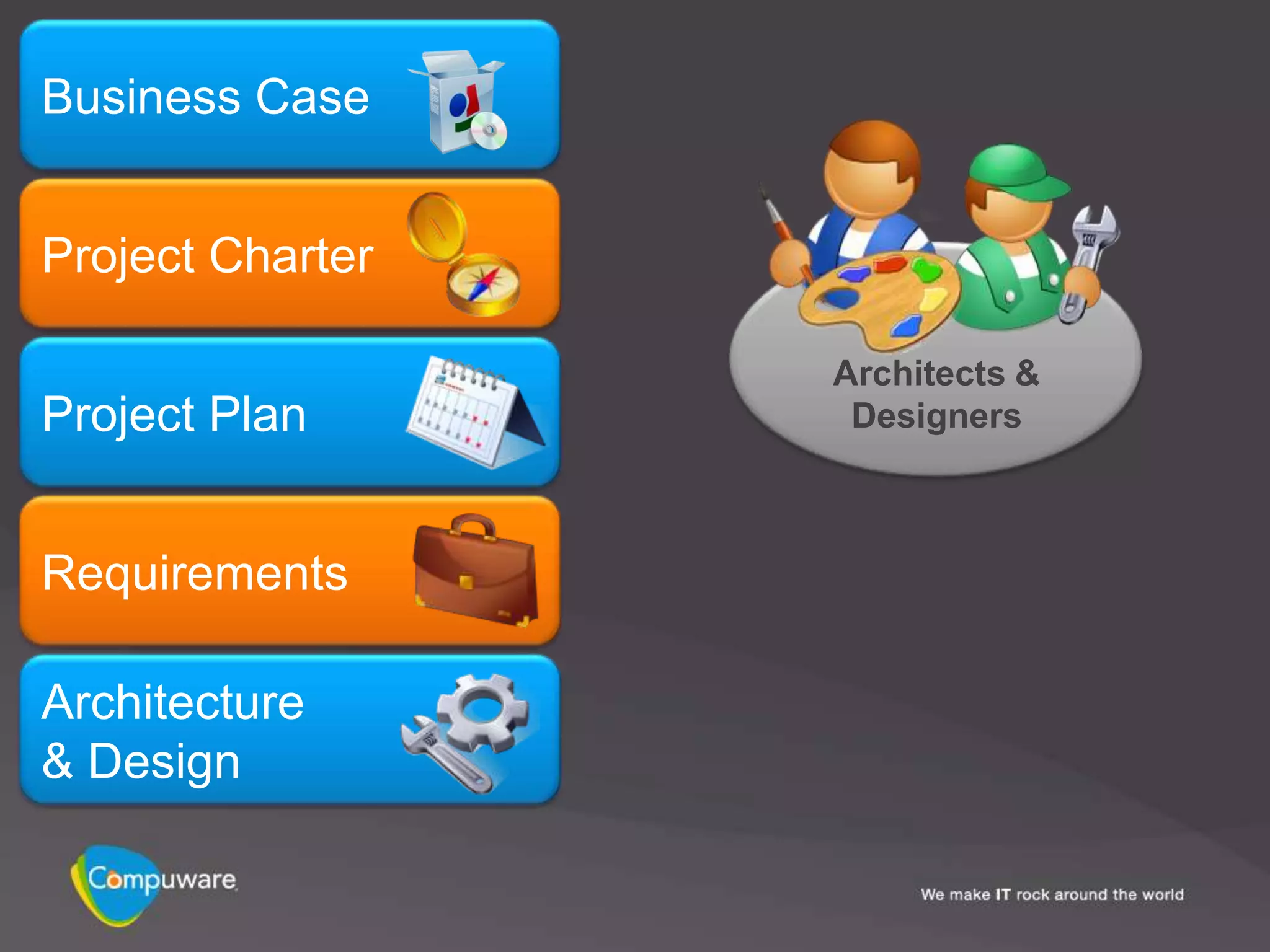

Project Charter

                  Architects &
Project Plan       Designers

Requirements

Architecture
& Design
Business Case

Project Charter

Project Plan

Requirements

Architecture
& Design

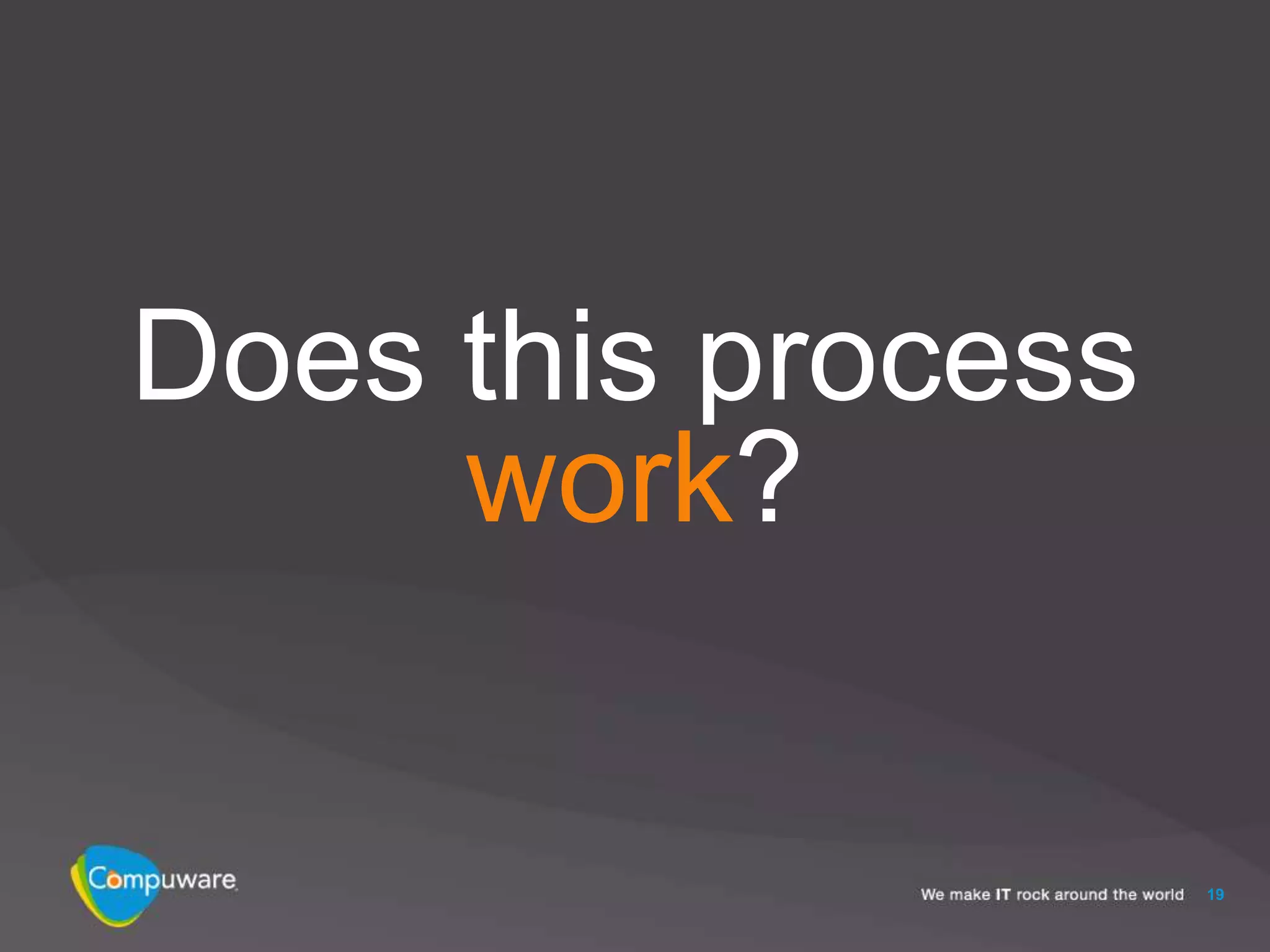

Does this process
     work?

                    19

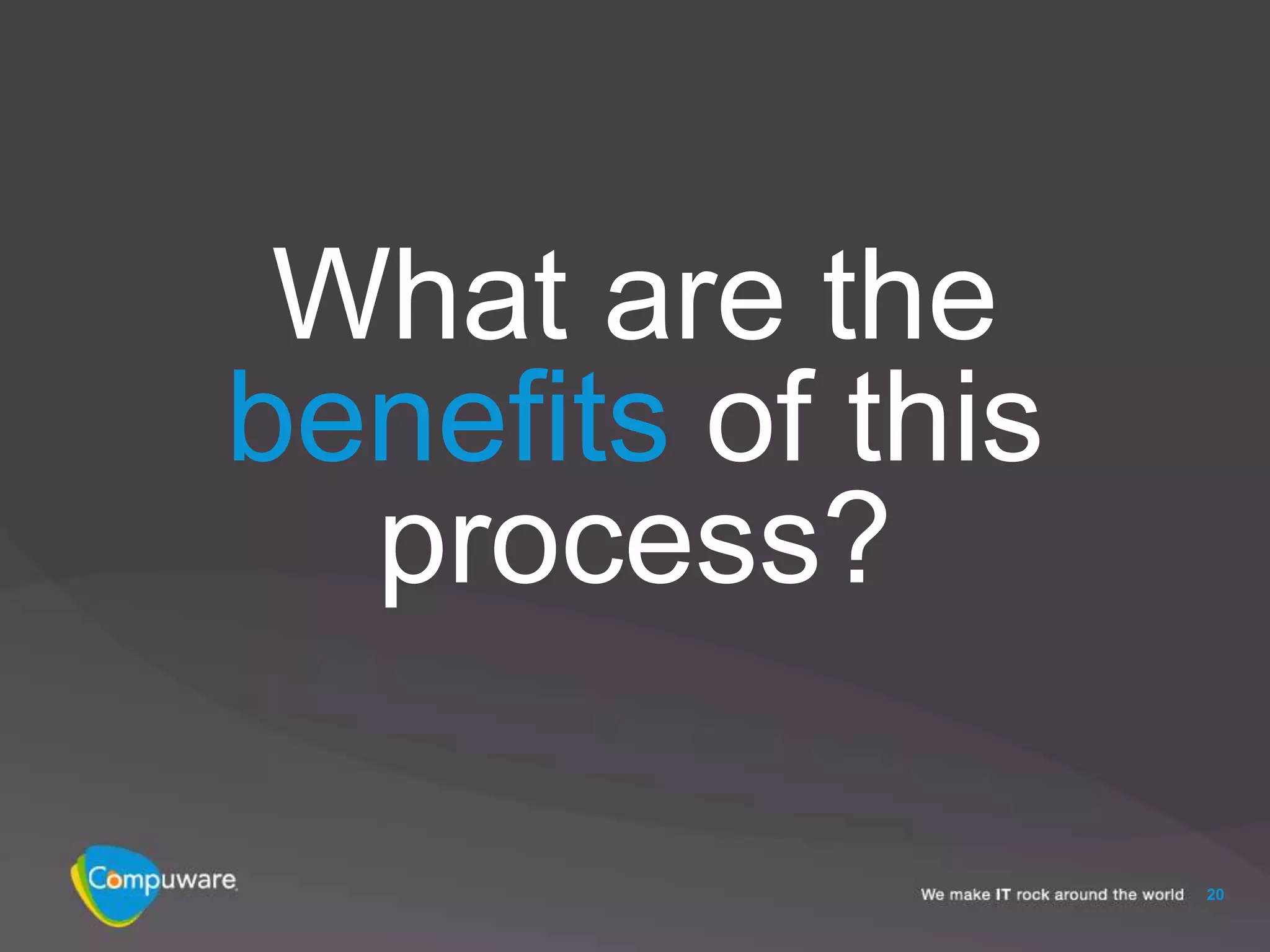

What are the
benefits of this
  process?

                   20
What are the

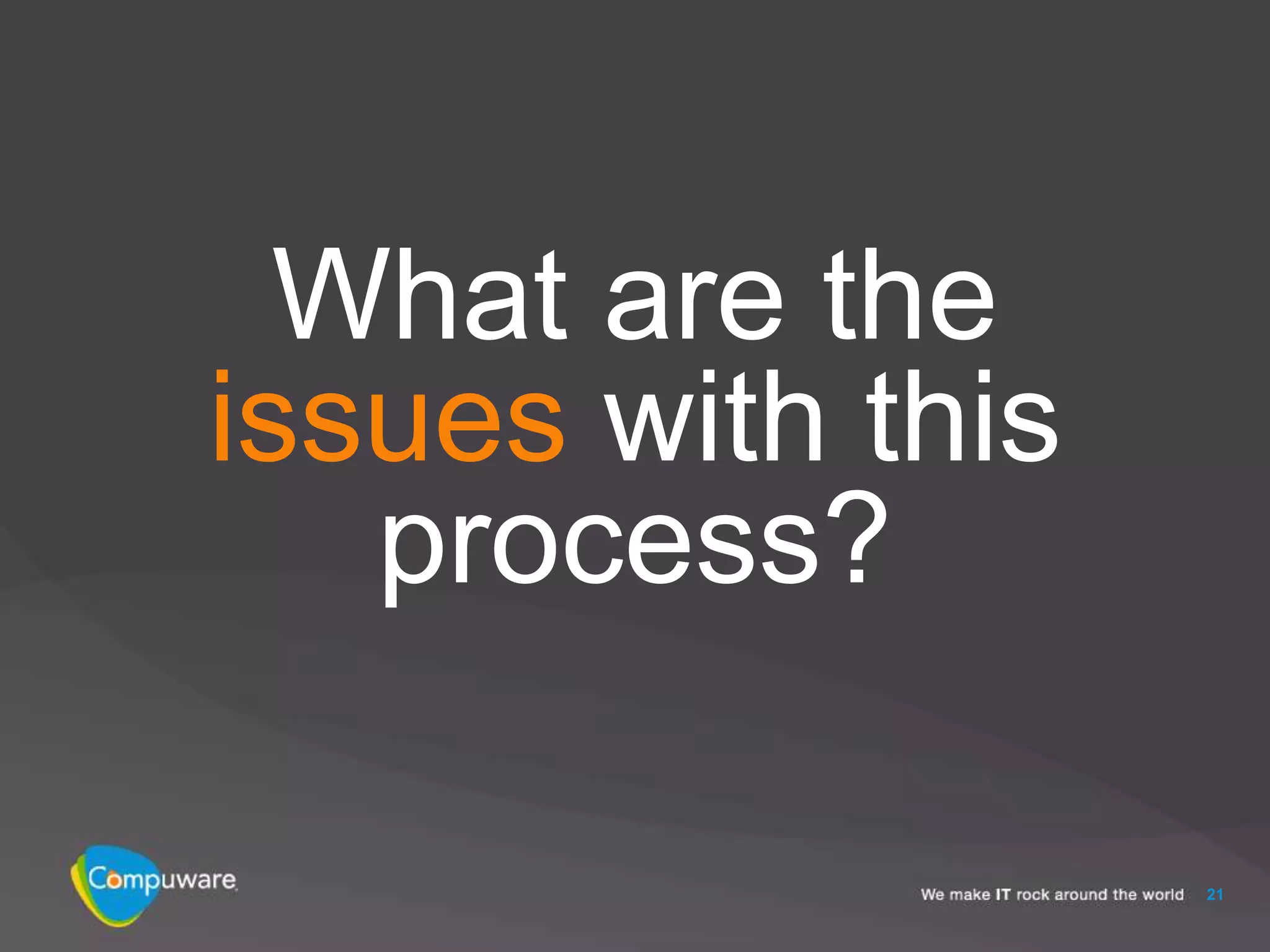

issues with this
   process?

                   21
Research &
Statistics

             22
Simula Research

                  23
IEEE Xplore

              24

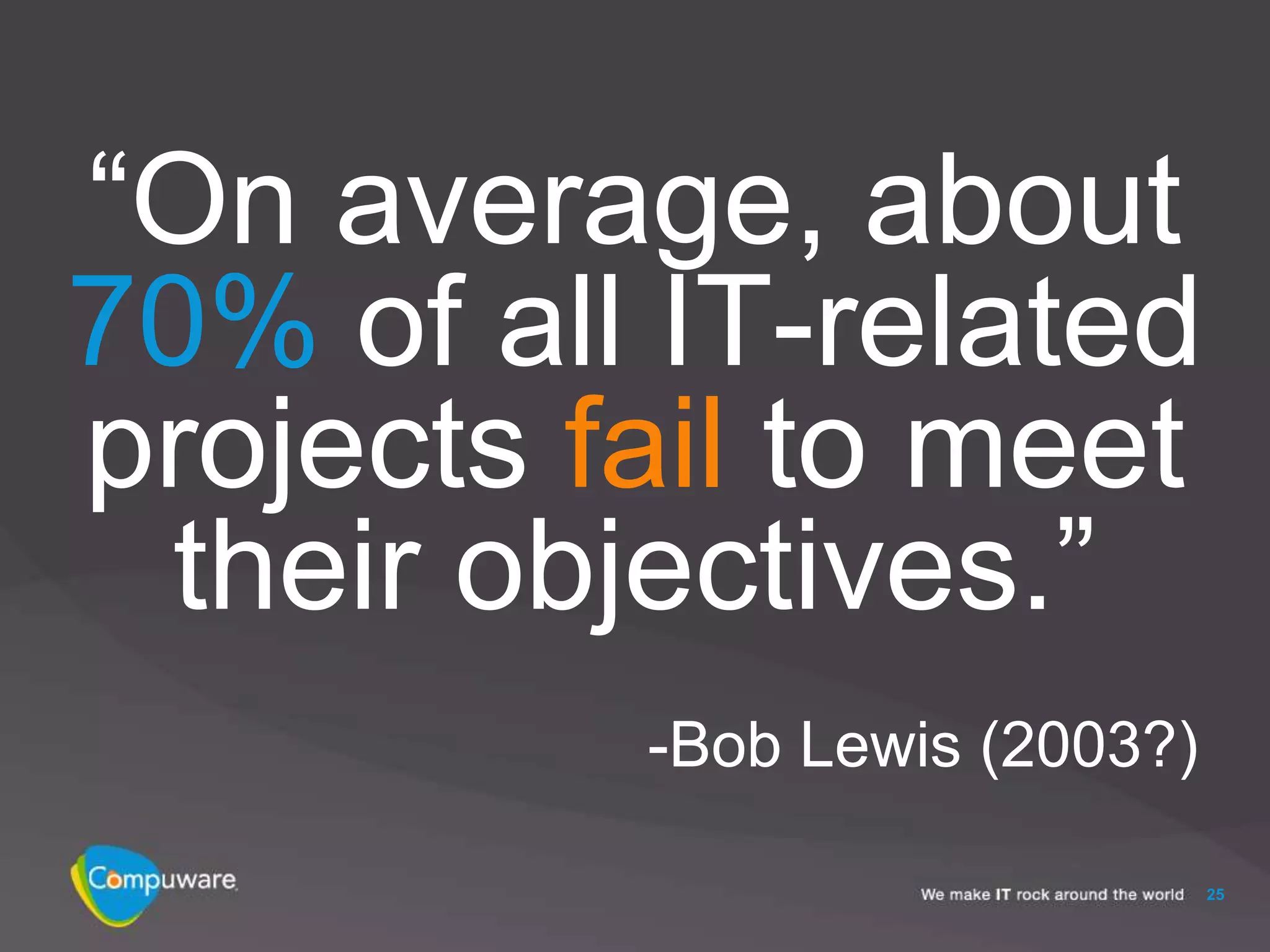

“On average, about
70% of all IT-related
projects fail to meet
 their objectives.”
          -Bob Lewis (2003?)

                               25

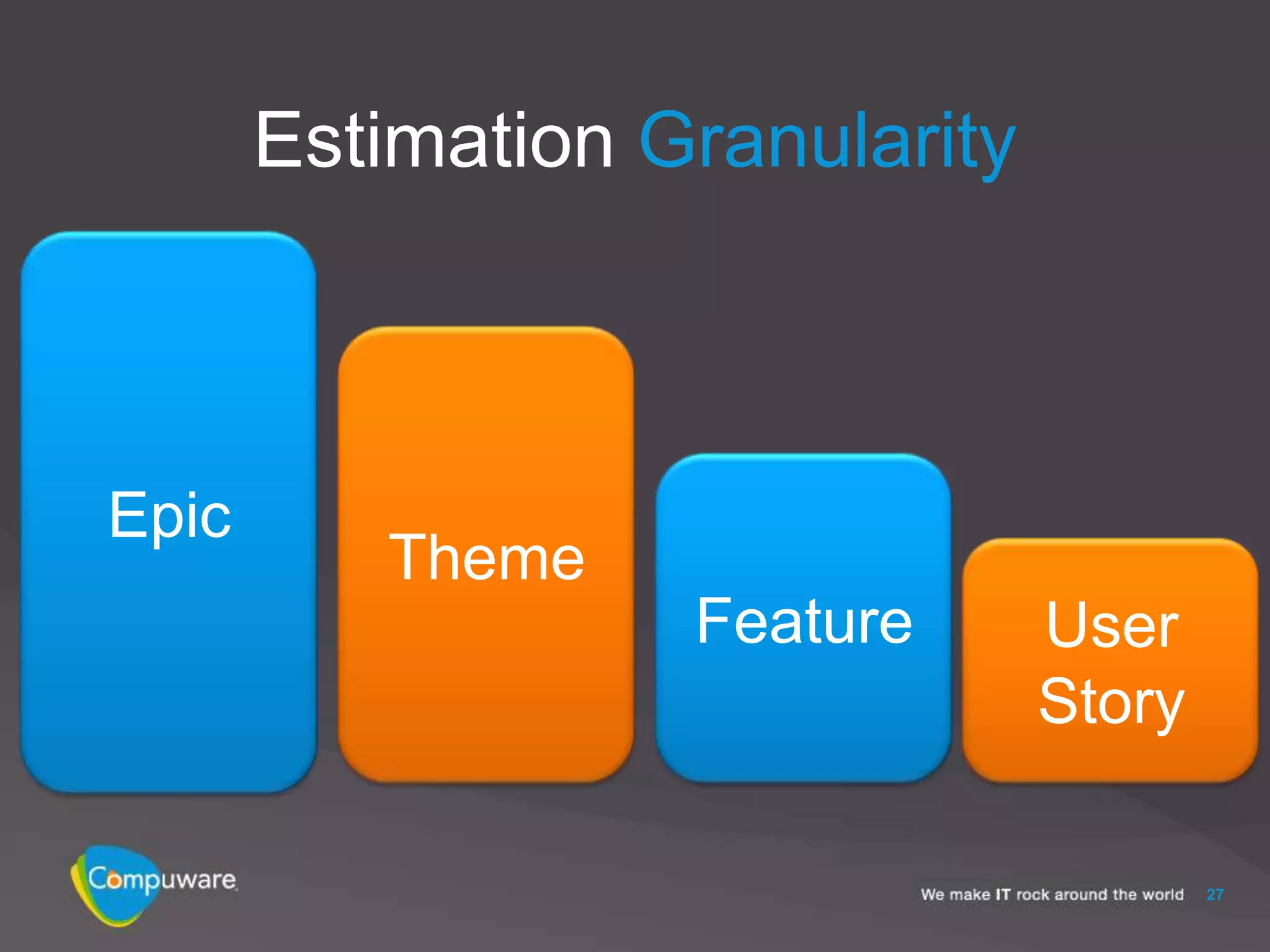

Estimation Granularity

                         26
Estimation Granularity

Epic
          Theme
                   Feature      User
                                Story

                                        27

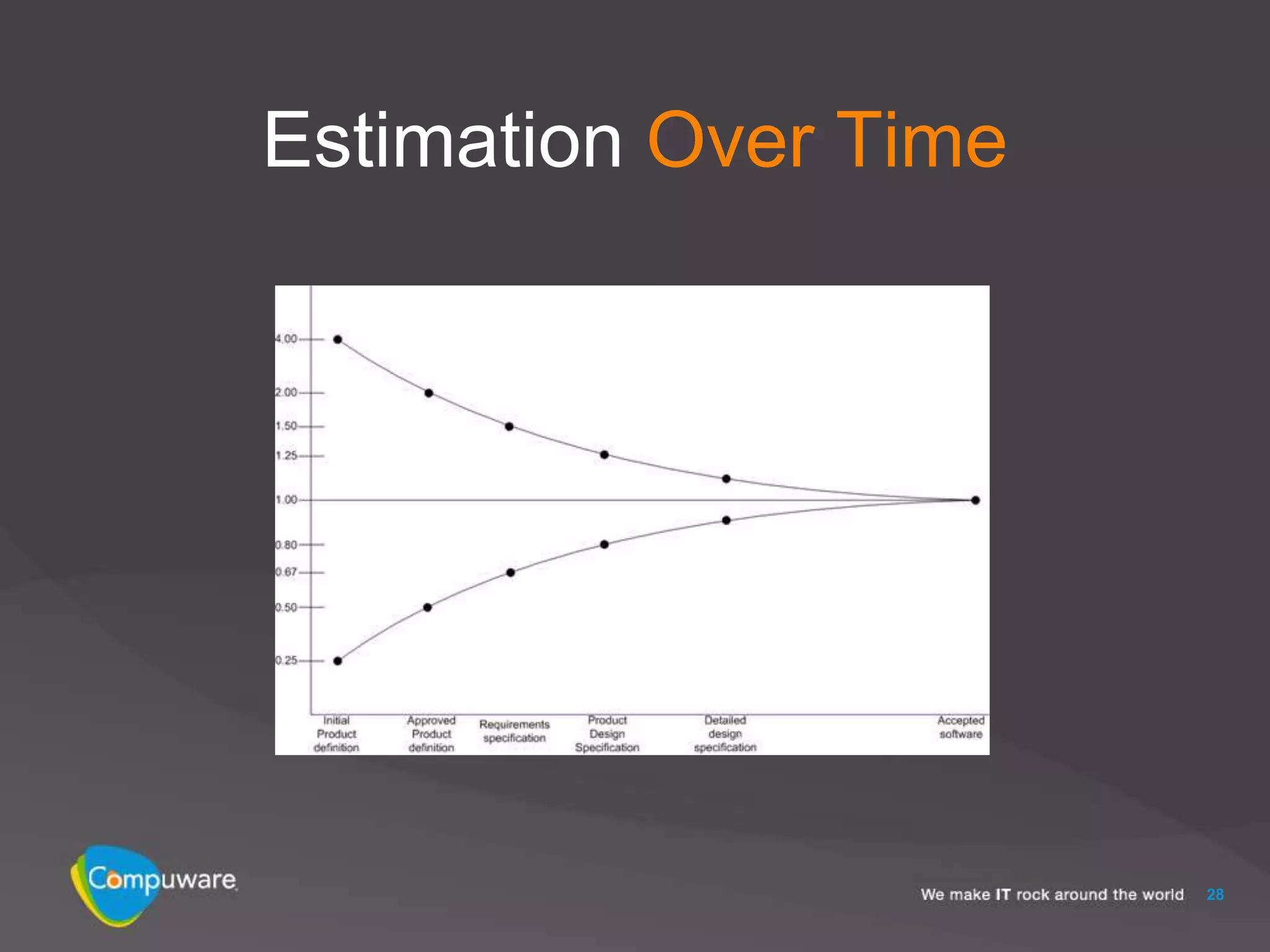

Estimation Over Time

                       28
Estimating Time Boxes

                        29

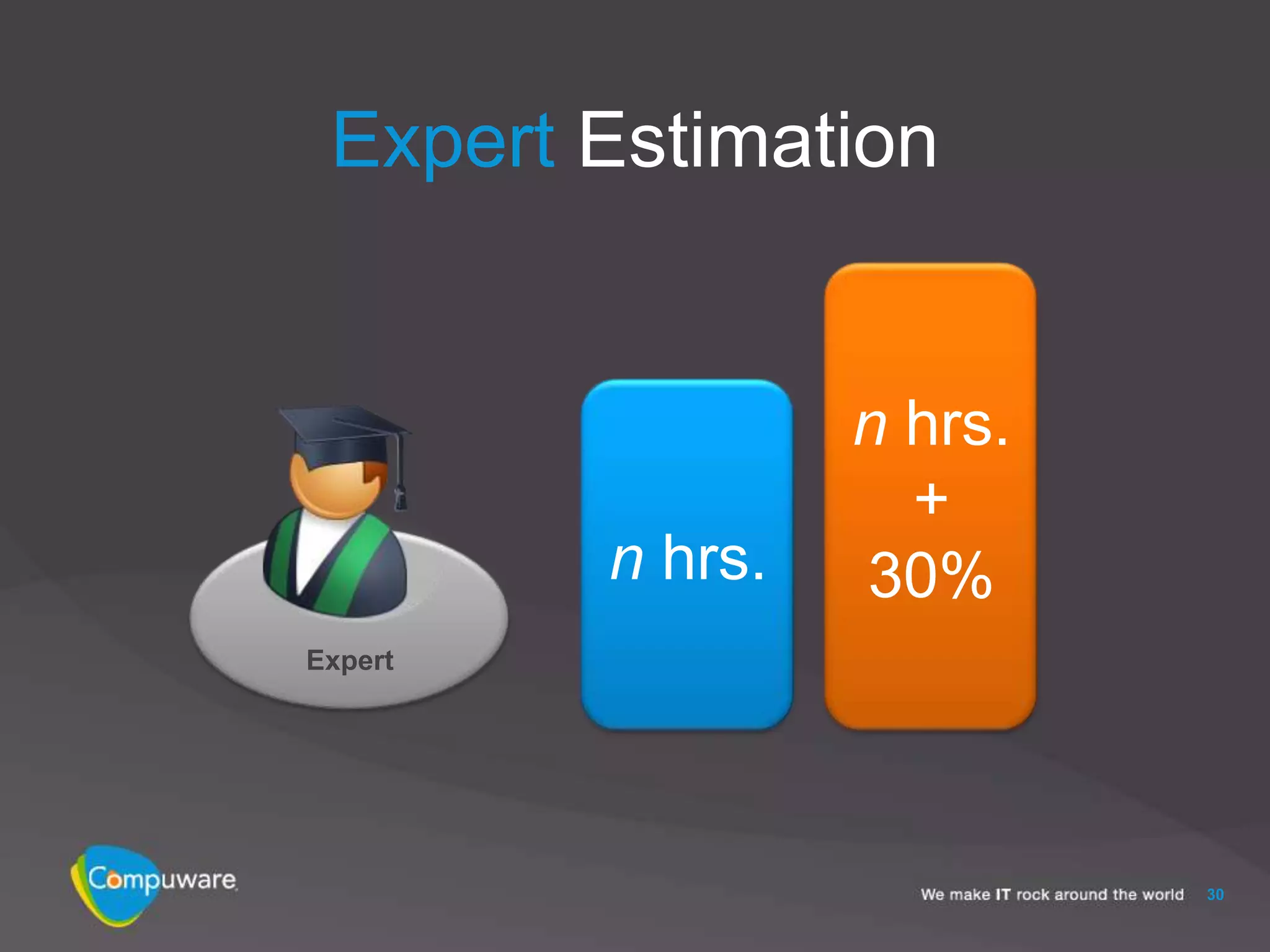

Expert Estimation

                  n hrs.
                    +
         n hrs.   30%
Expert

                           30
Magic Eight Ball
Scrum in 5
Minutes

             32

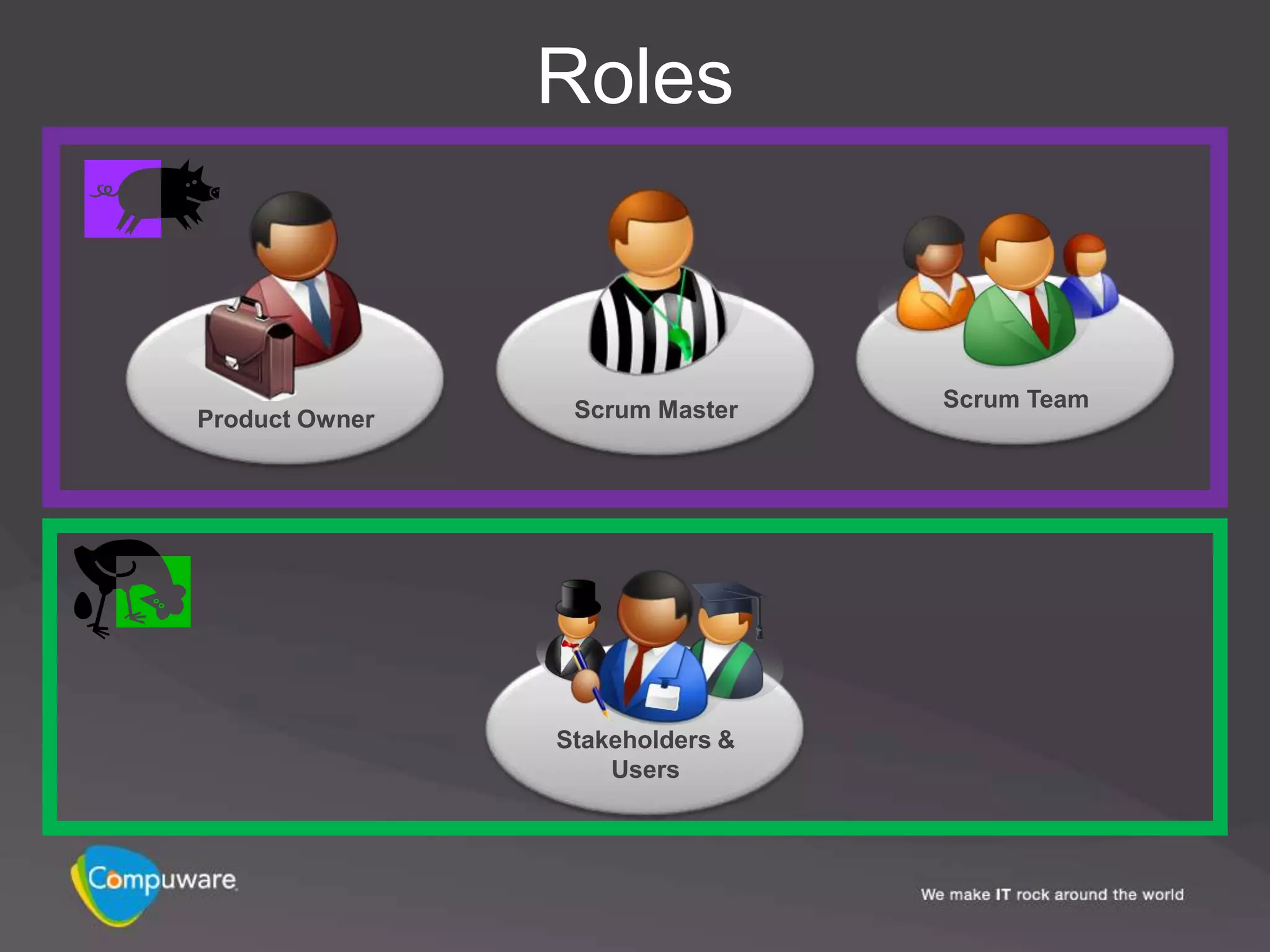

Roles

                 Scrum Master    Scrum Team
Product Owner

                Stakeholders &
                    Users

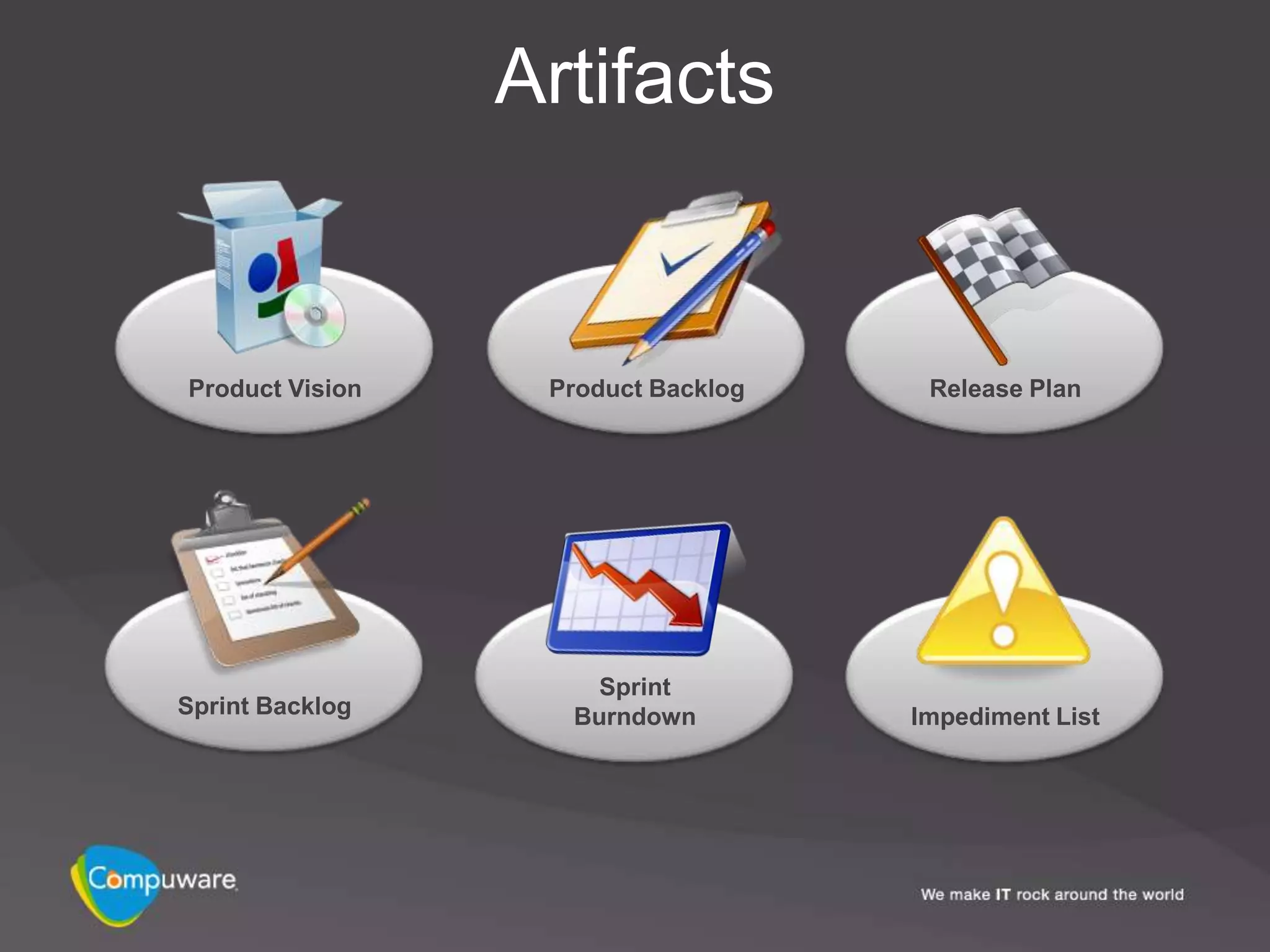

Artifacts

Product Vision    Product Backlog    Release Plan

                     Sprint
Sprint Backlog     Burndown         Impediment List

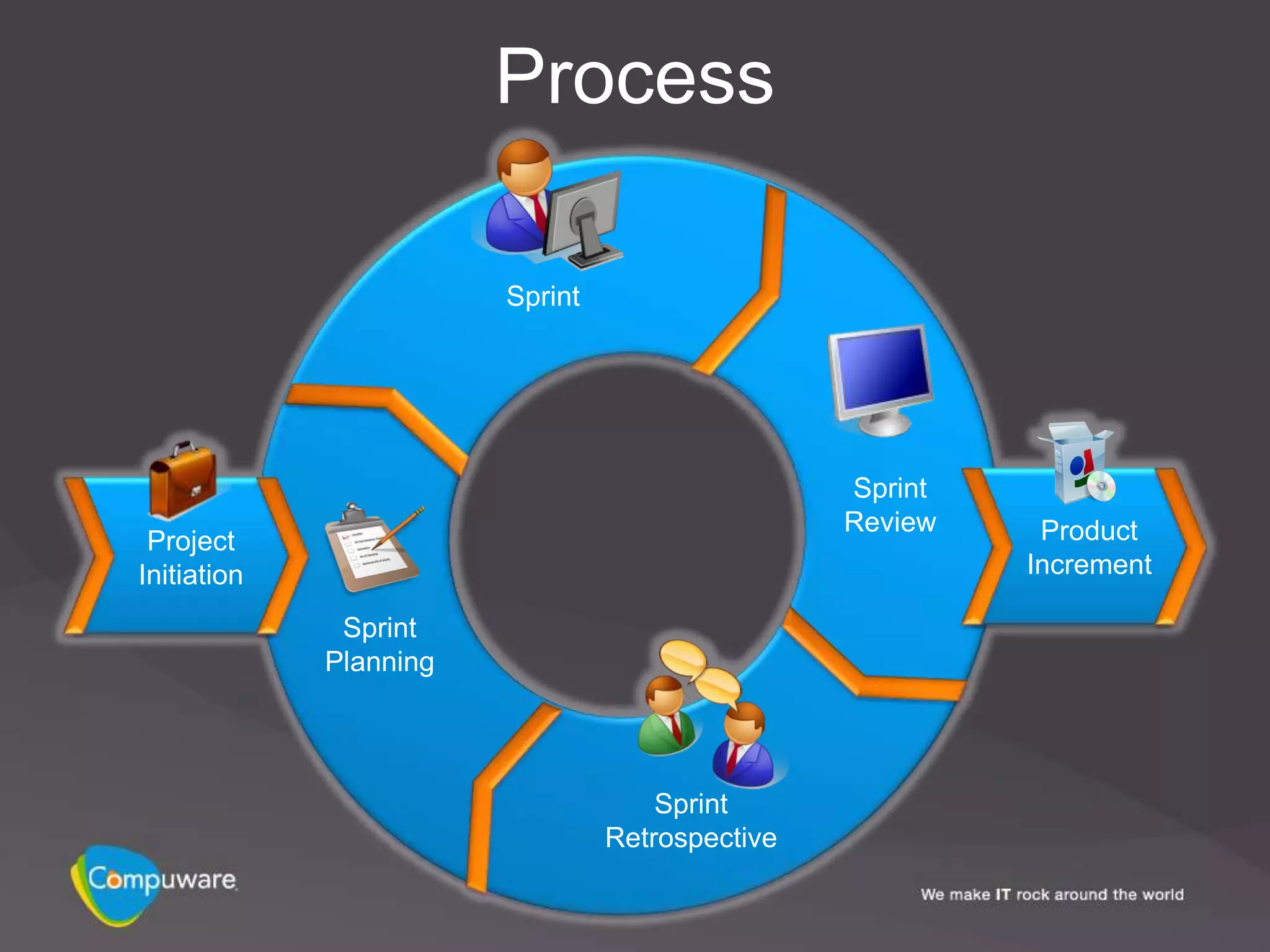

Process

                        Sprint

                                                 Sprint
                                                 Review    Product
 Project
Initiation                                                Increment

              Sprint
             Planning

                                     Sprint
                                 Retrospective
Agile
Estimating

             36
Product
Backlog

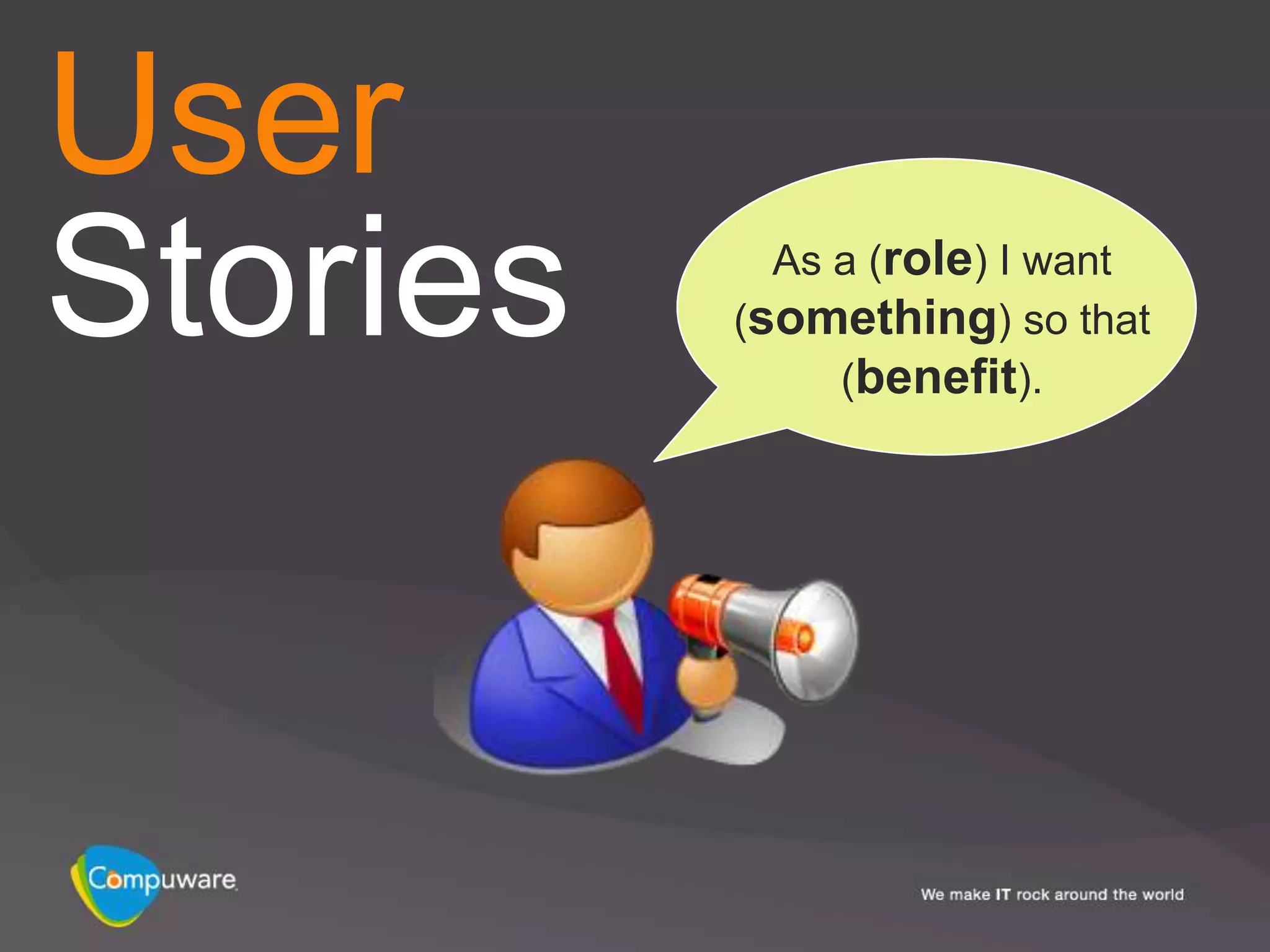

User
Stories     As a (role) I want
          (something) so that
               (benefit).

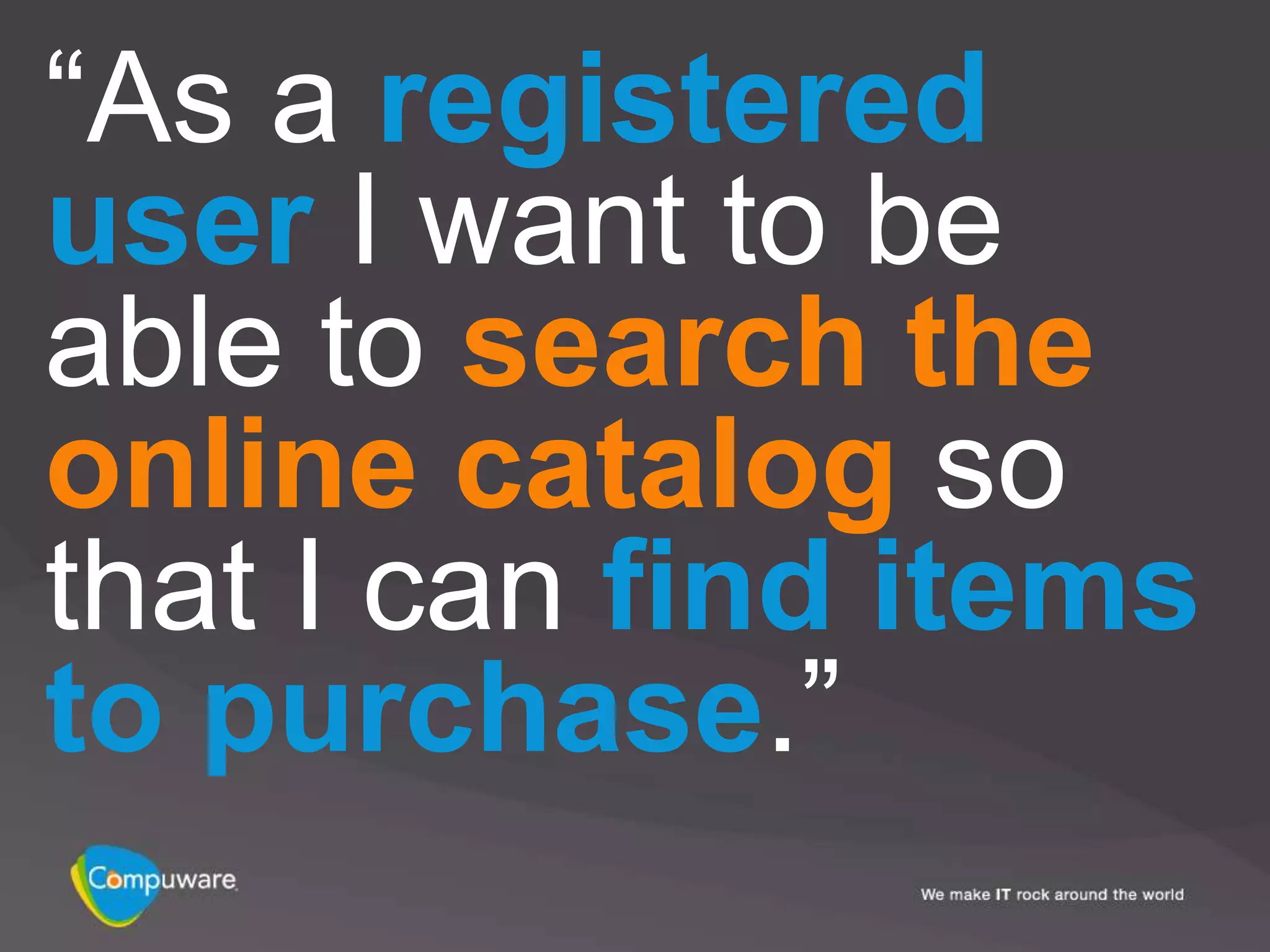

“As a registered
user I want to be
able to search the
online catalog so
that I can find items
to purchase.”

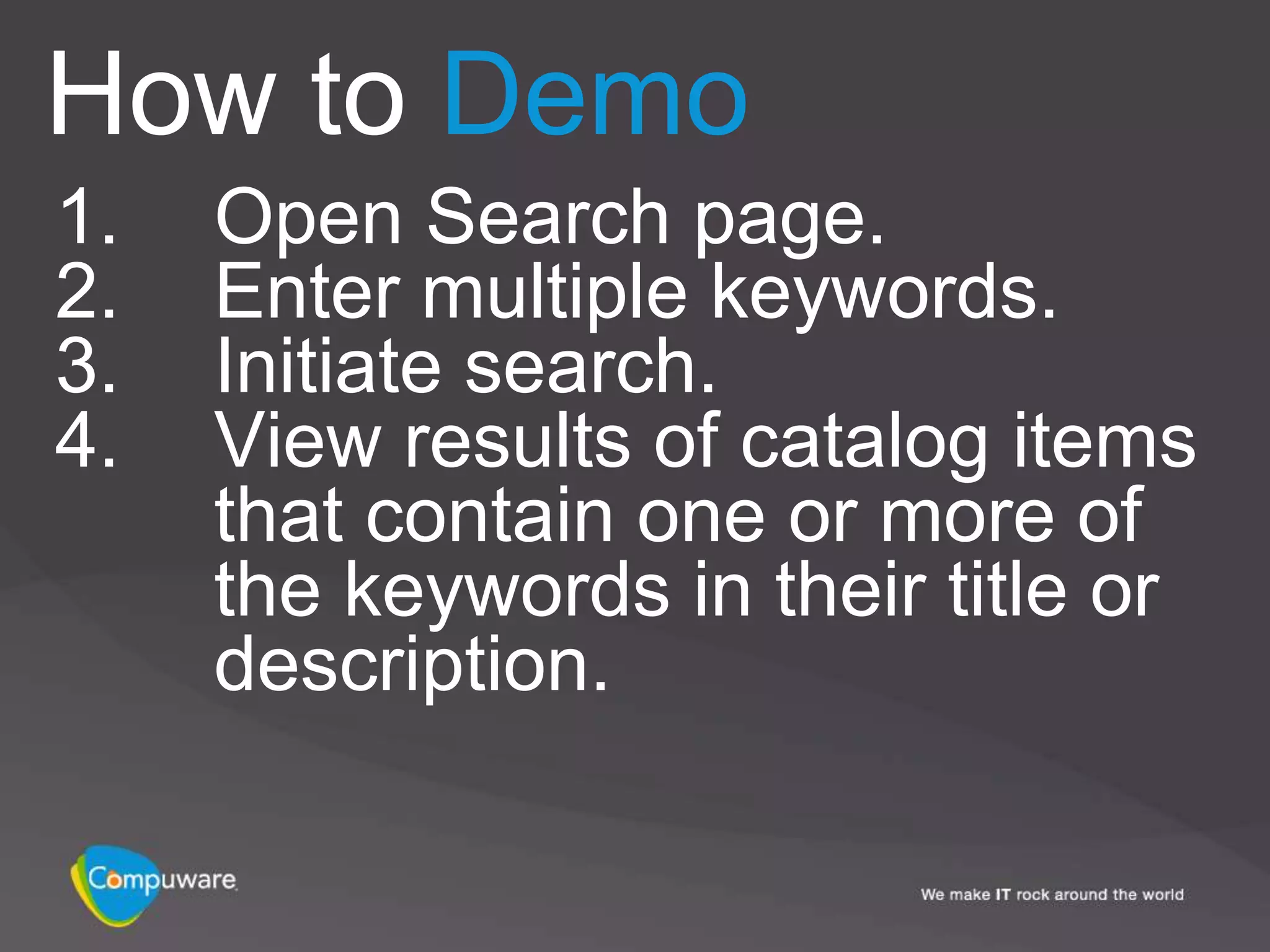

How to Demo
1.   Open Search page.
2.   Enter multiple keywords.
3.   Initiate search.
4.   View results of catalog items
     that contain one or more of
     the keywords in their title or
     description.

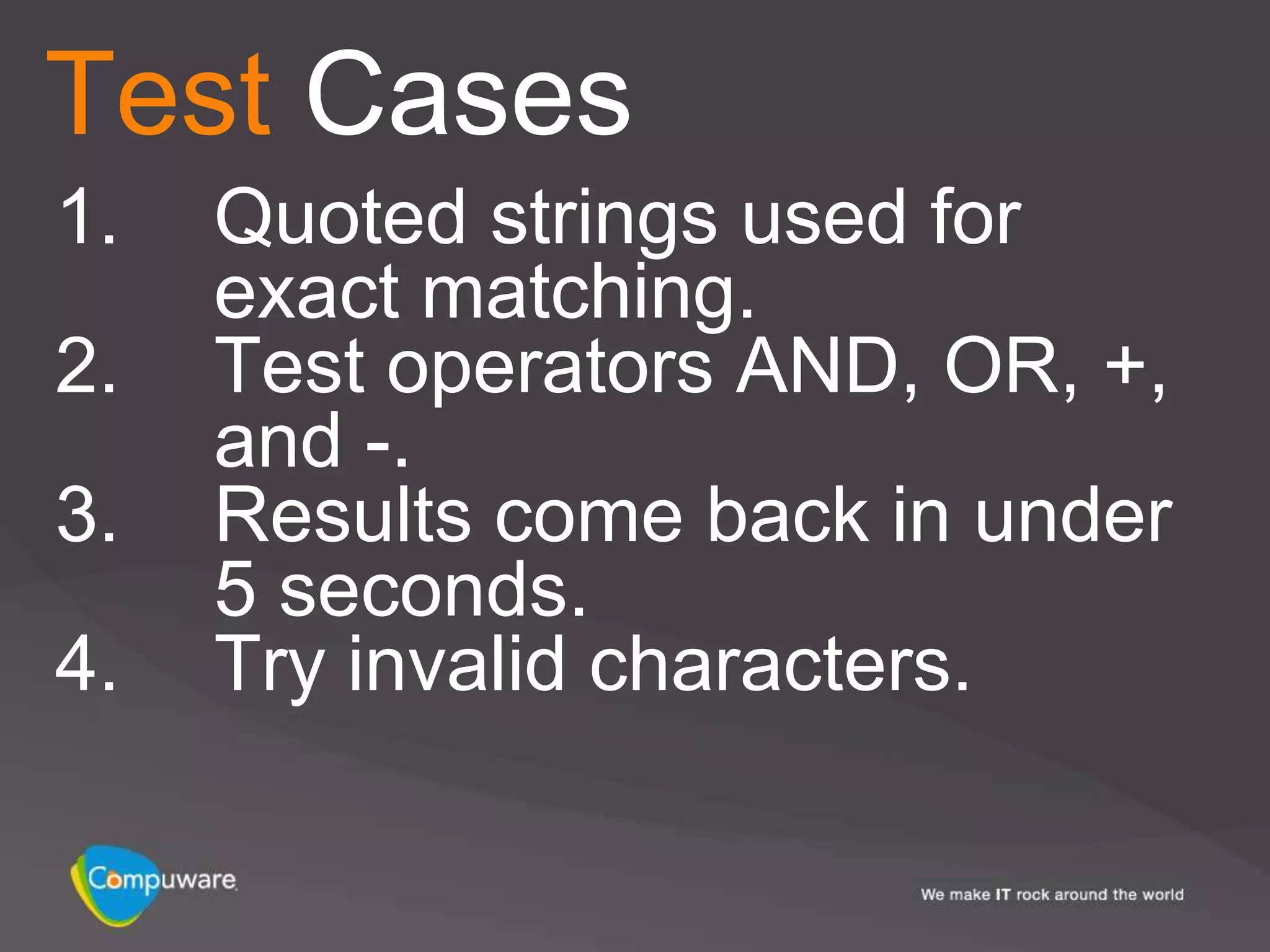

Test Cases
1.   Quoted strings used for
     exact matching.
2.   Test operators AND, OR, +,
     and -.
3.   Results come back in under
     5 seconds.
4.   Try invalid characters.

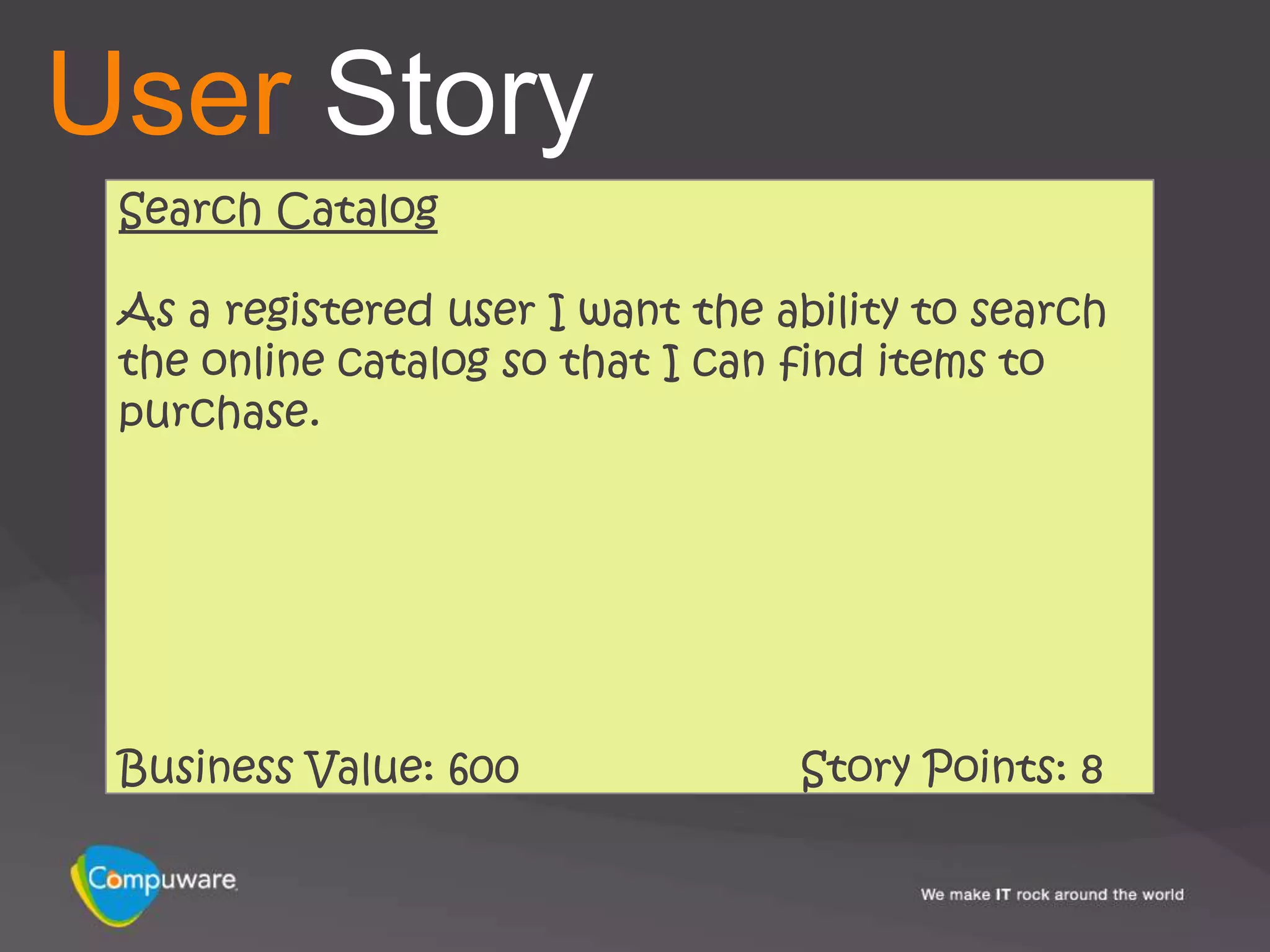

User Story
 Search Catalog

 As a registered user I want the ability to search
 the online catalog so that I can find items to
 purchase.

 Business Value: 600              Story Points: 8

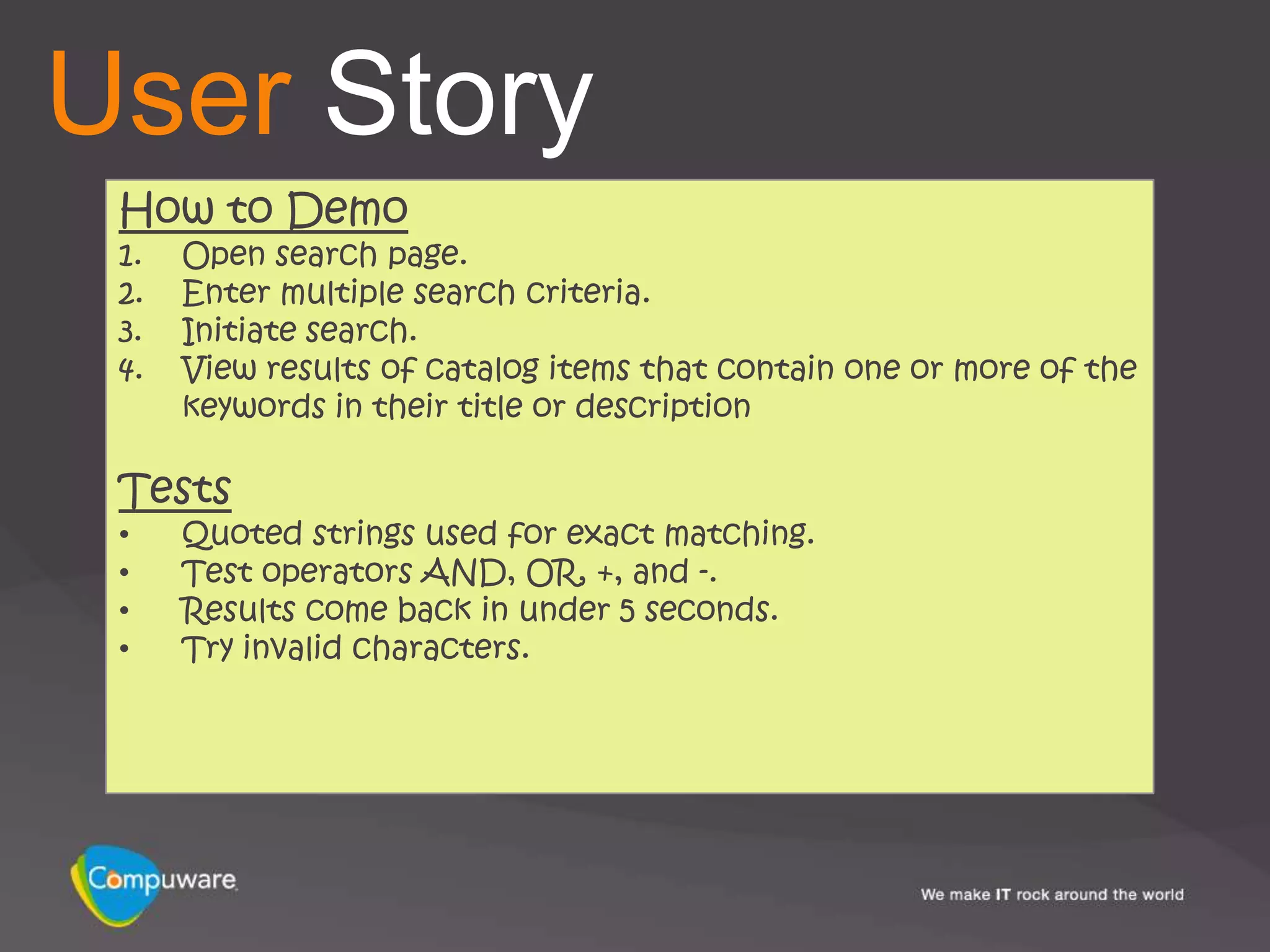

User Story
 How to Demo
 1.   Open search page.
 2.   Enter multiple search criteria.
 3.   Initiate search.
 4.   View results of catalog items that contain one or more of the
      keywords in their title or description

 Tests
 •    Quoted strings used for exact matching.
 •    Test operators AND, OR, +, and -.
 •    Results come back in under 5 seconds.
 •    Try invalid characters.
Story Wall
                    Register New User

                    As a role I want this ability for
                    this business value.

                    Business Value: 900

    Login

    As a role I want this ability for
    this business value. Catalog Items
                   Enter

                  As a roleSearch Catalog
                            I want this ability for
                  this business value.
                           As a registered user I want the
    Business Value: 700    ability to search the online
                           catalog so that I can find items to
                           purchase.
                  Business Value: 600

                           Business Value: 600
Zoo Points
Lion
Kangaroo
Rhinoceros
Bear
Giraffe
Gorilla
Hippopotamus
Tiger
Story Points
Story Points
Story Points

1     2   3    5    8

13   20   40 100    ?

Story Points
2                                  5                             8   10

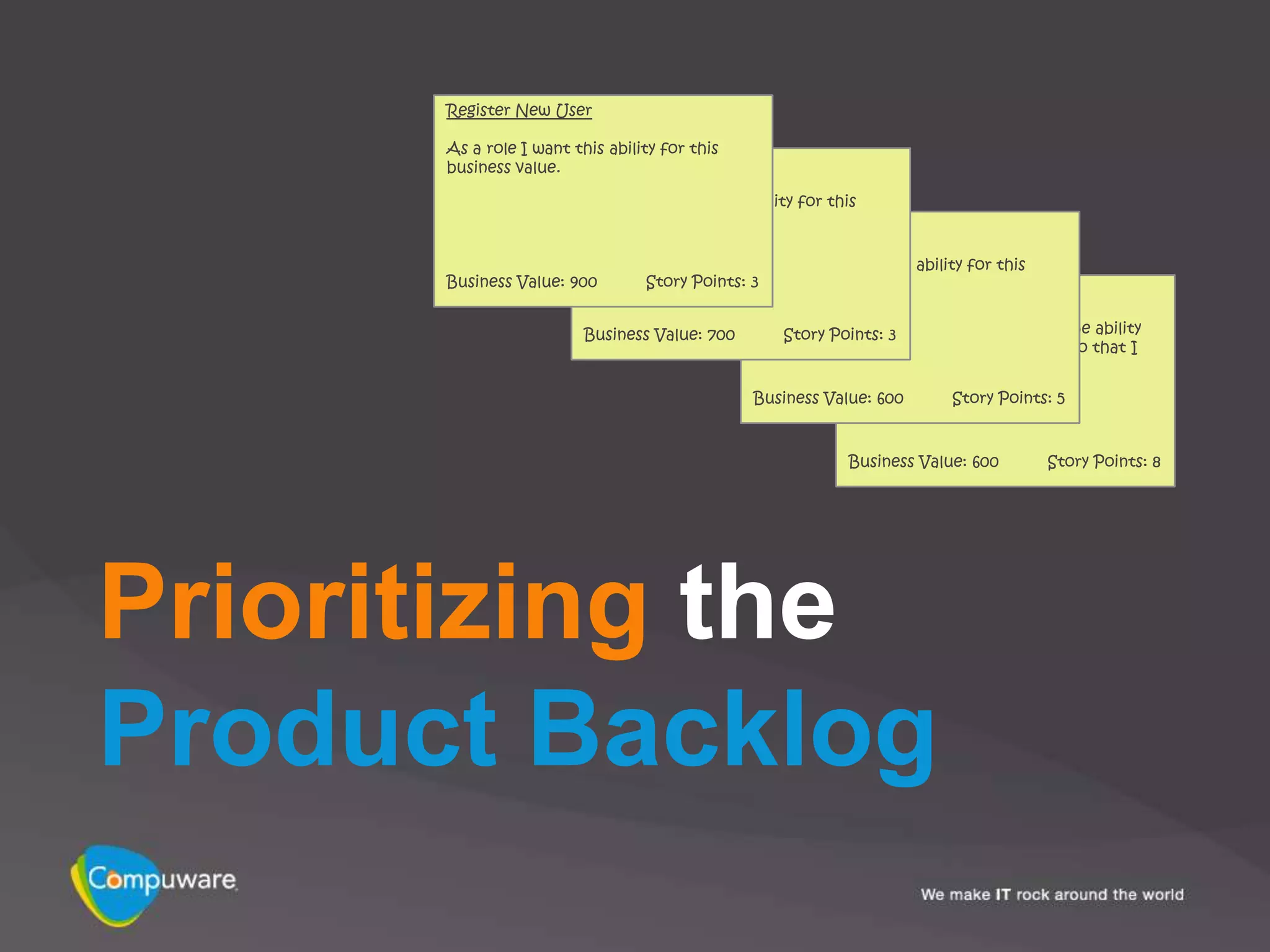

                    Register New User

                    As a role I want this ability for
                    this business value.

                    Business Value: 900

    Login

    As a role I want this ability for
    this business value. Catalog Items
                   Enter

                  As a roleSearch Catalog
                            I want this ability for
                  this business value.
                           As a registered user I want the
    Business Value: 700    ability to search the online
                           catalog so that I can find items to
                           purchase.
                  Business Value: 600

                           Business Value: 600

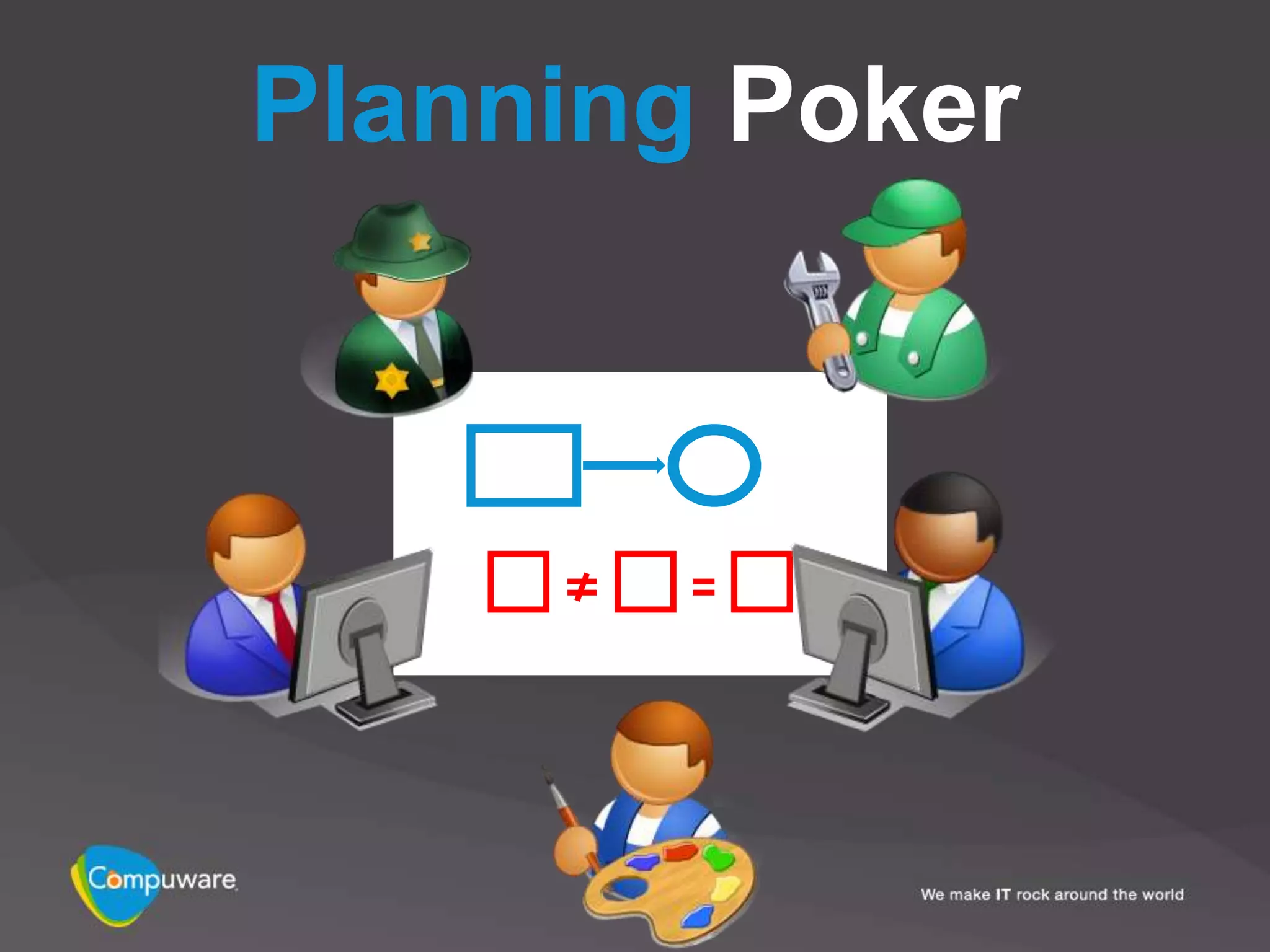

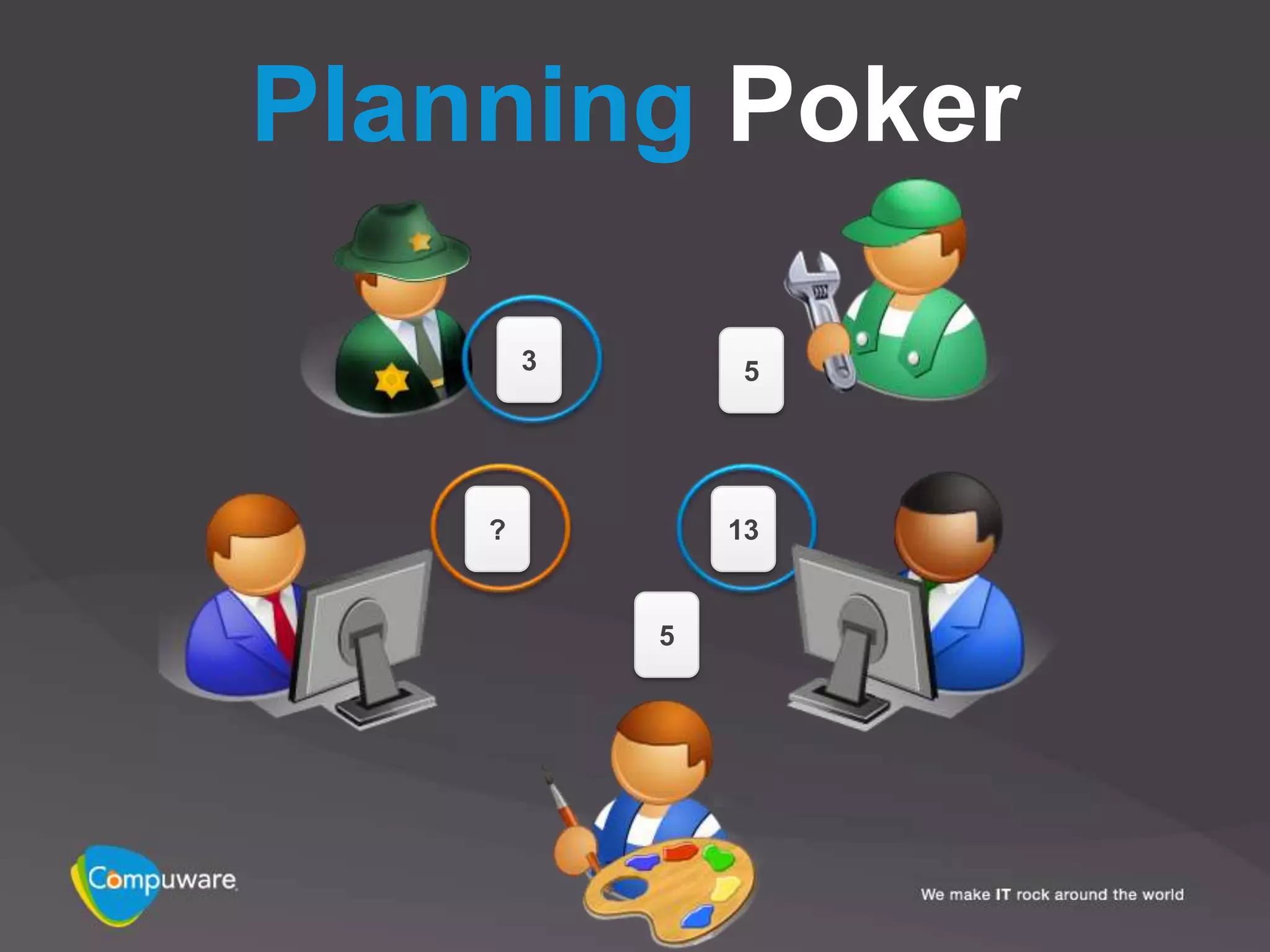

Planning Poker
Planning Poker
Planning Poker

        3        5

    ?           13

            5

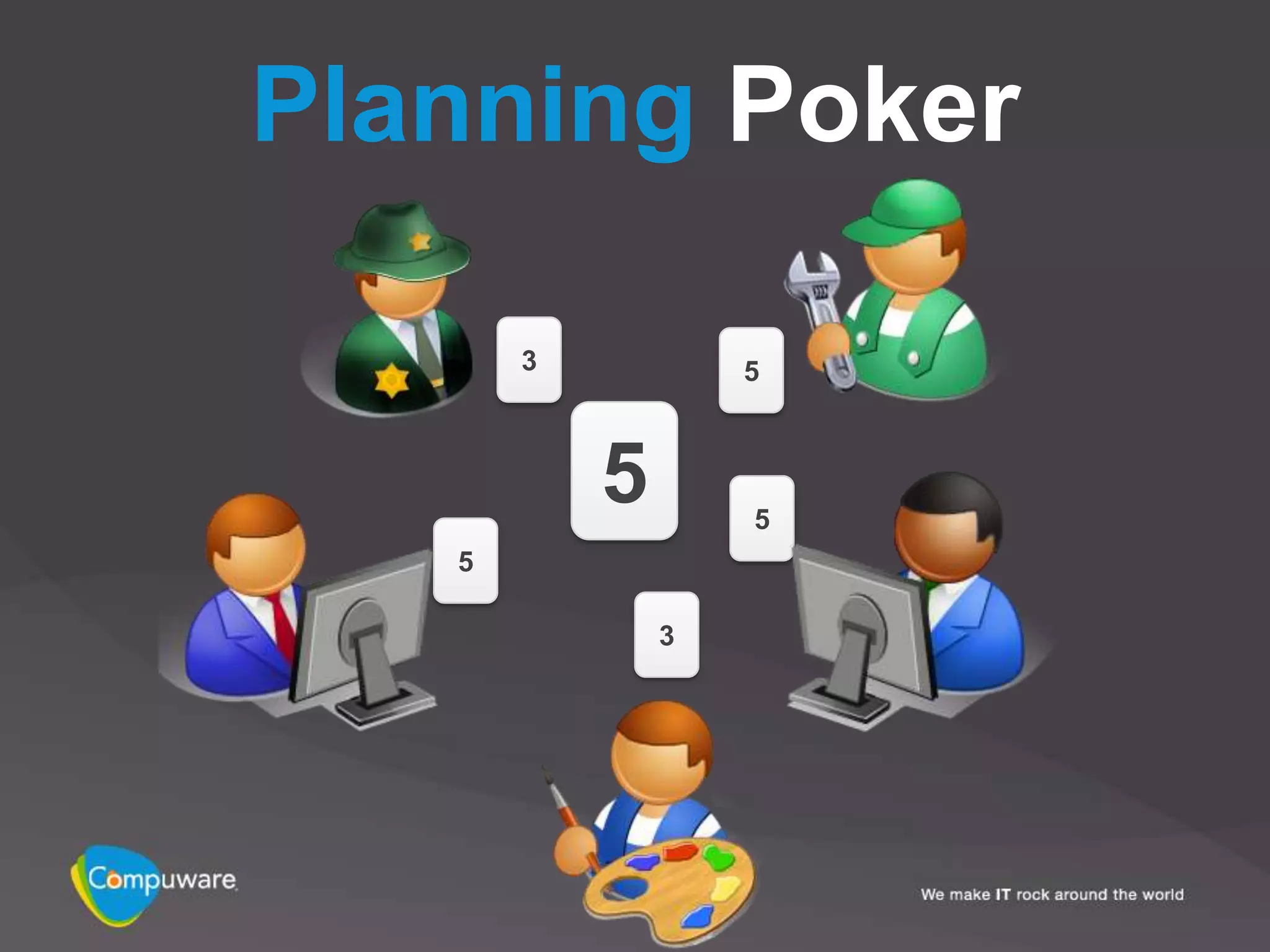

Planning Poker
Planning Poker

       3           5

           5       5
   5

               3
Agile Planning
with Scrum

                 56

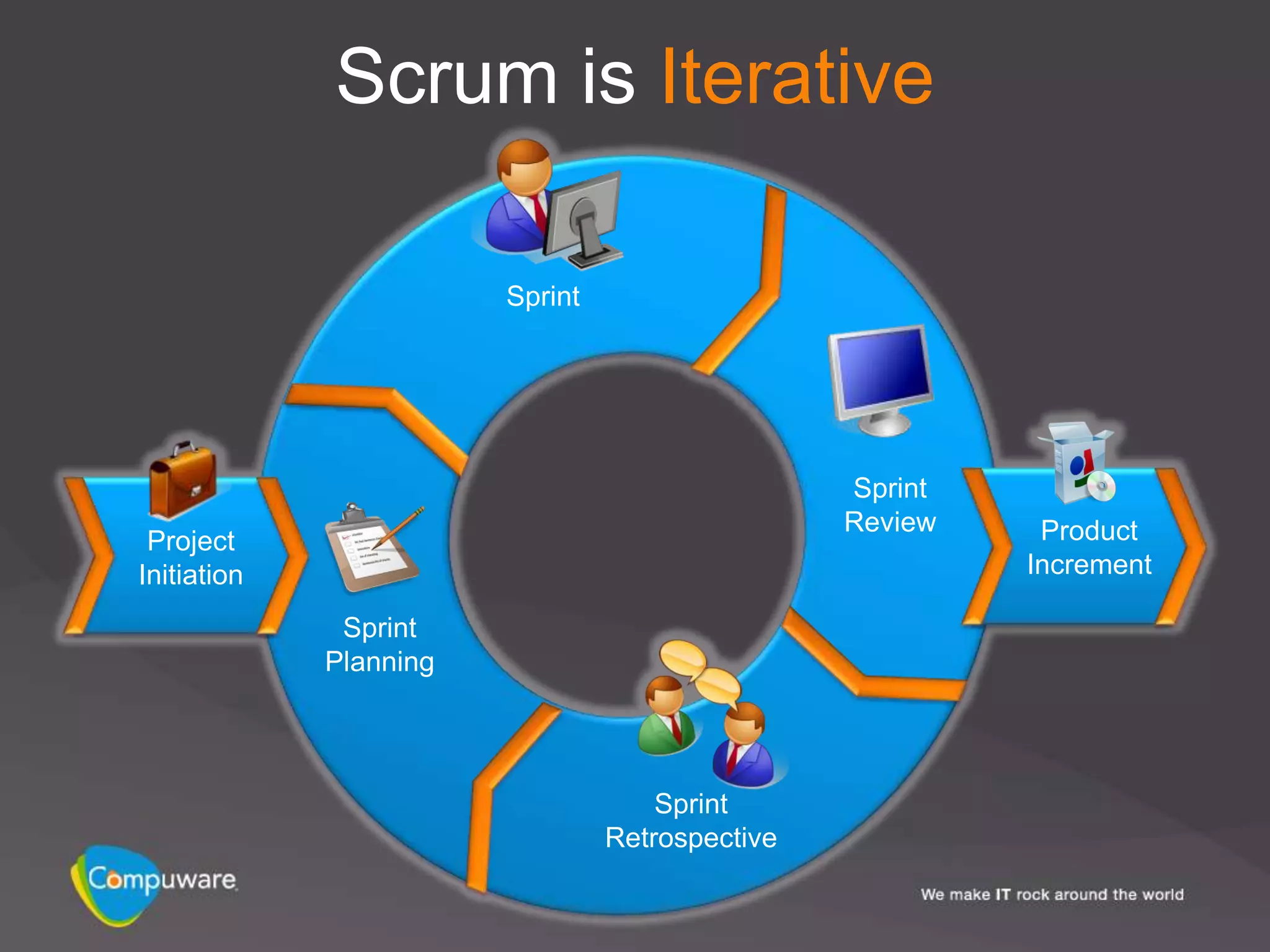

Scrum is Iterative

                        Sprint

                                                 Sprint
                                                 Review    Product
 Project
Initiation                                                Increment

              Sprint
             Planning

                                     Sprint
                                 Retrospective
“Planning is
essential,
the plan is
useless.”
Register New User

      As a role I want this ability for this
      business value. Login

                         As a role I want this ability for this
                         business value.        Enter Catalog Items

                                               As a role I want this ability for this
      Business Value: 900        Story Points: 3
                                               business value.
                                                            Search Catalog

                         Business Value: 700               As a registered user I want the ability
                                                   Story Points: 3
                                                           to search the online catalog so that I
                                                           can find items to purchase.

                                               Business Value: 600        Story Points: 5

                                                            Business Value: 600         Story Points: 8

Prioritizing the

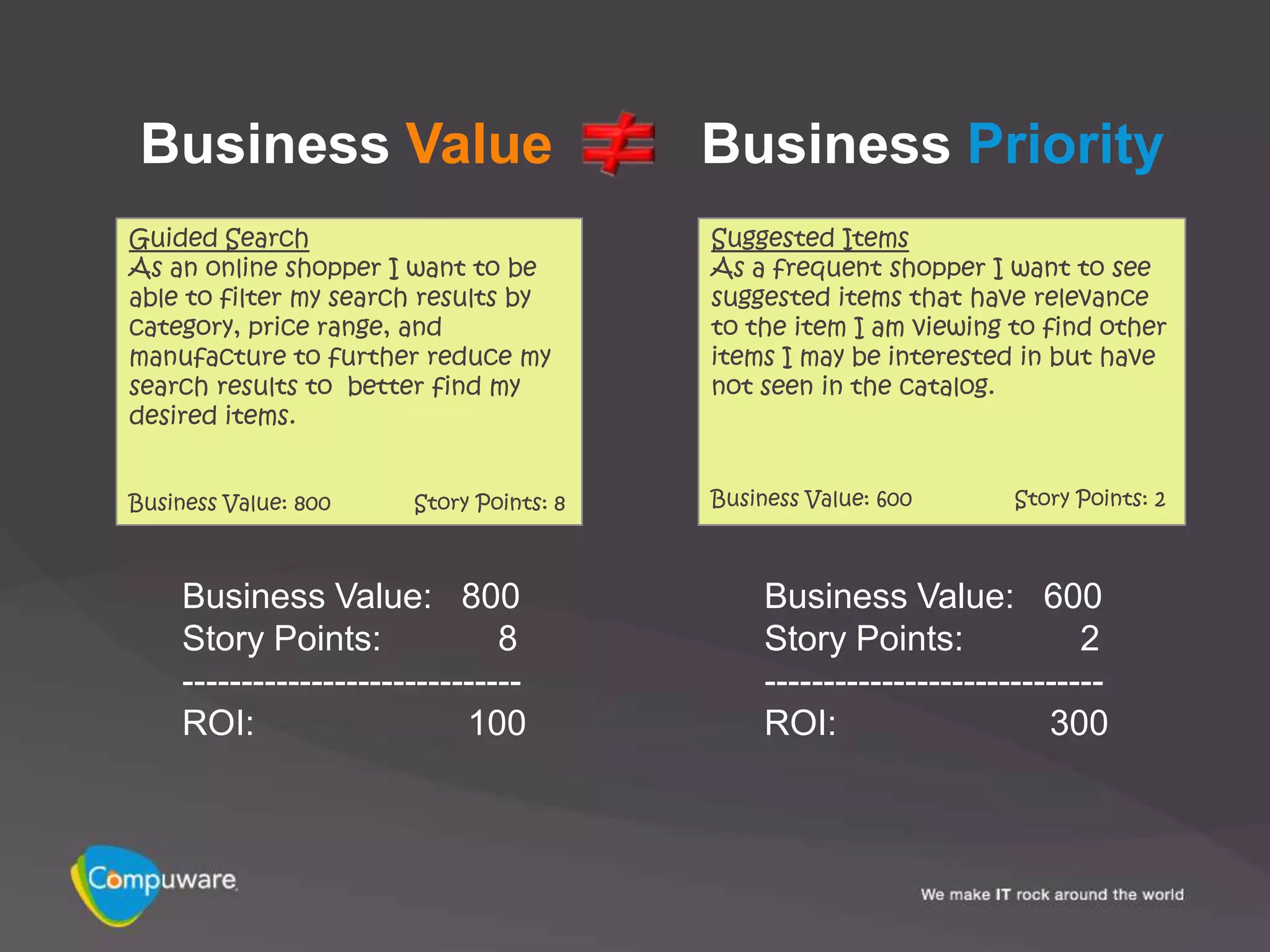

Product Backlog
Business Value                          Business Priority
Guided Search                            Suggested Items
As an online shopper I want to be        As a frequent shopper I want to see
able to filter my search results by      suggested items that have relevance
category, price range, and               to the item I am viewing to find other
manufacture to further reduce my         items I may be interested in but have
search results to better find my         not seen in the catalog.
desired items.

Business Value: 800    Story Points: 8   Business Value: 600       Story Points: 2

    Business Value: 800                       Business Value: 600
    Story Points:              8              Story Points:              2
    -----------------------------             -----------------------------
    ROI:                    100               ROI:                    300

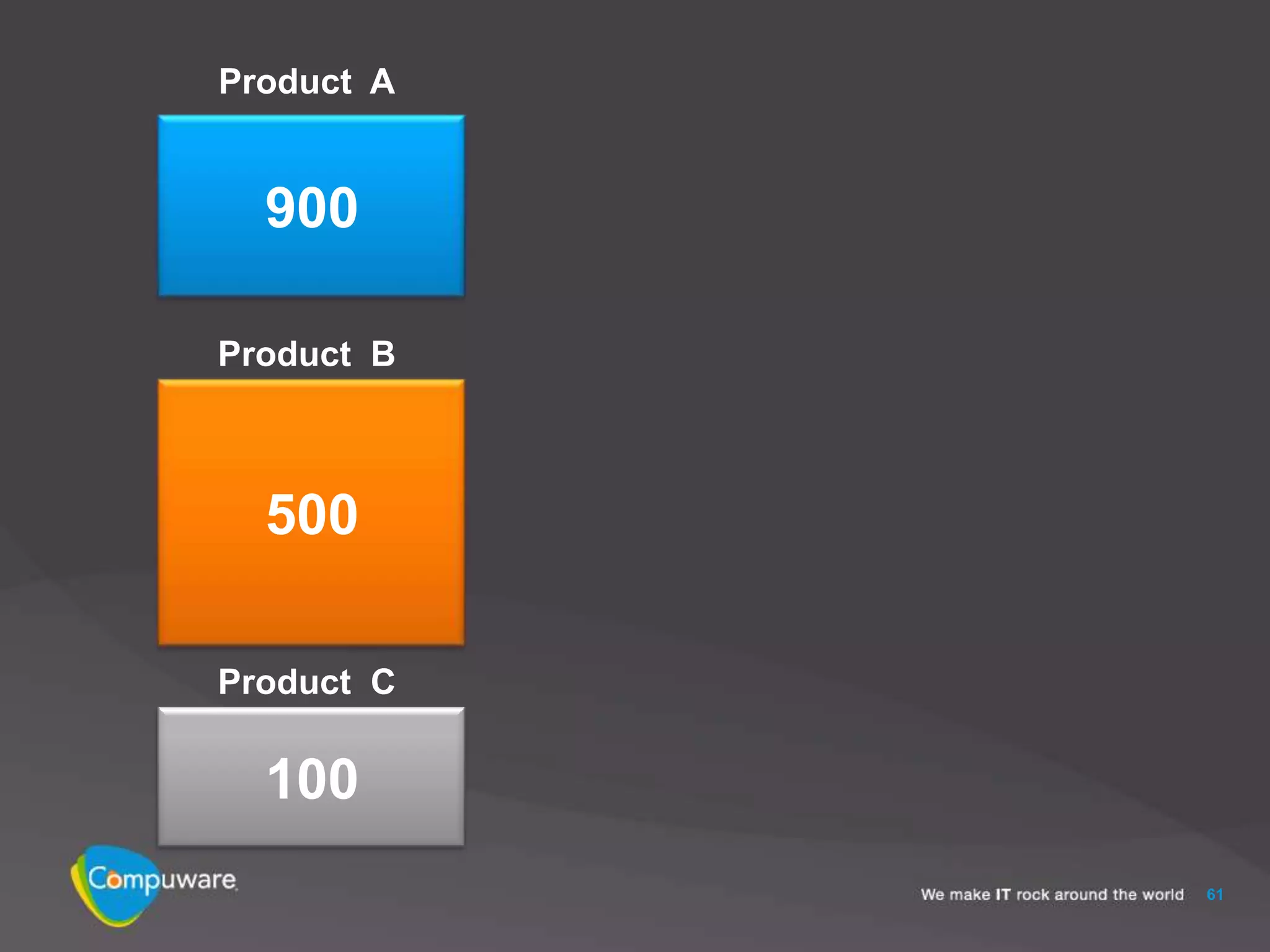

Product A

  900

Product B

  500

Product C

  100
            61

Product A      Enterprise
            Product Backlog

Product B

Product C

                              62

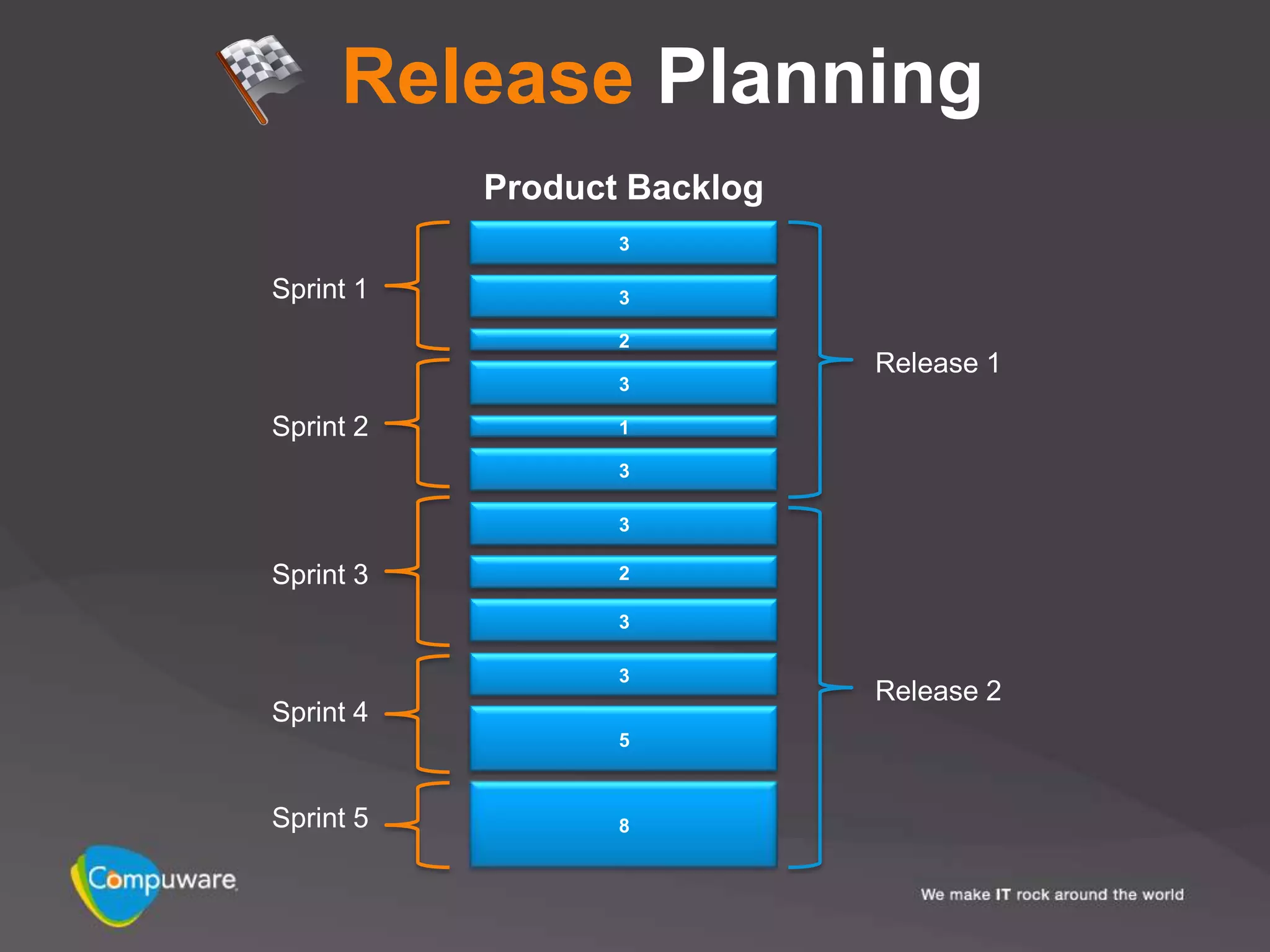

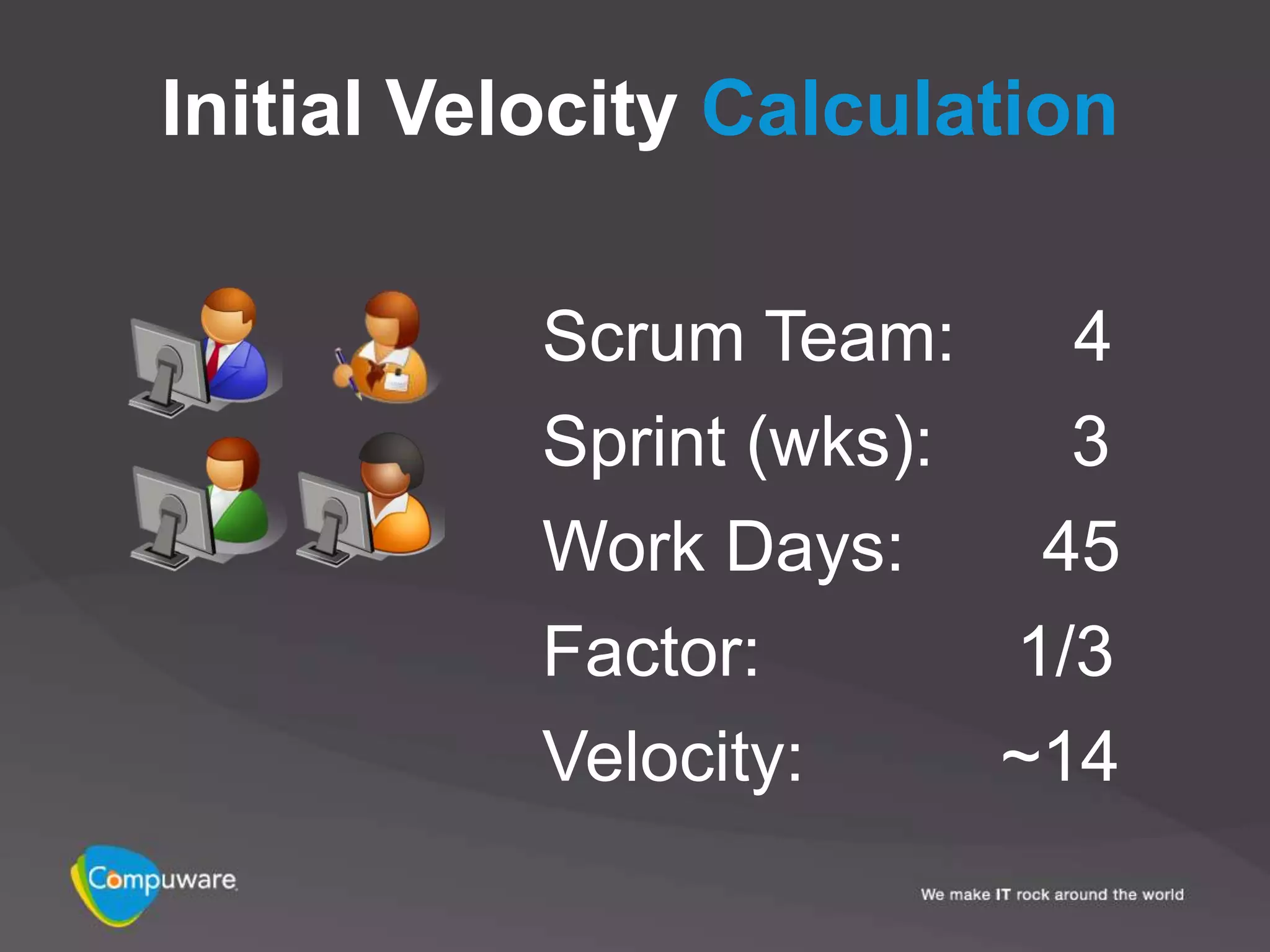

Release Planning
Initial Velocity Calculation

           Scrum Team:     4
           Sprint (wks):   3
           Work Days:     45
           Factor:       1/3
           Velocity:     ~14

Release Planning
           Product Backlog
                  3

Sprint 1          3

                  2
                             Release 1
                  3

Sprint 2          1

                  3

                  3

Sprint 3          2

                  3

                  3
                             Release 2
Sprint 4
                  5

Sprint 5          8

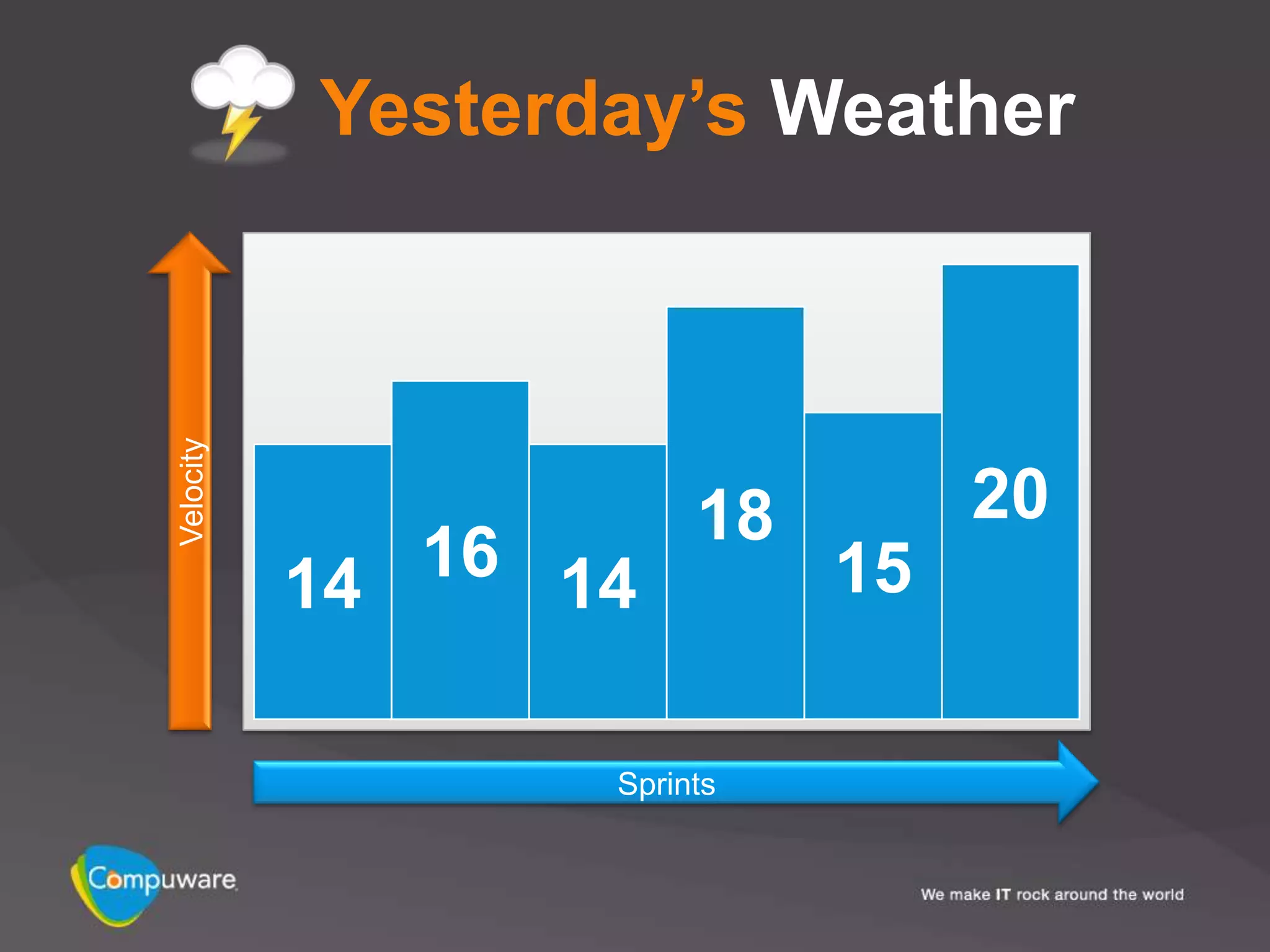

Yesterday’s Weather
Velocity

                       18        20
           14 16 14         15

                  Sprints
Yesterday’s Weather

               14
Velocity

                       18        20
           14 16 14         15

                  Sprints
Yesterday’s Weather

               18
Velocity

                       18        20
           14 16 14         15

                  Sprints
Release Planning
                                 Product Backlog
                                        3

                      Sprint 1          3
                                                   Sprint 1
                                        2
Worst Case Scenario

                                                              Best Case Scenario
                                        3

                      Sprint 2          1

                                        3
                                                   Sprint 2
                                        3

                      Sprint 3          2

                                        3

                                        3
                                                   Sprint 3
                      Sprint 4
                                        5

                      Sprint 5          8
Sprint
Planning

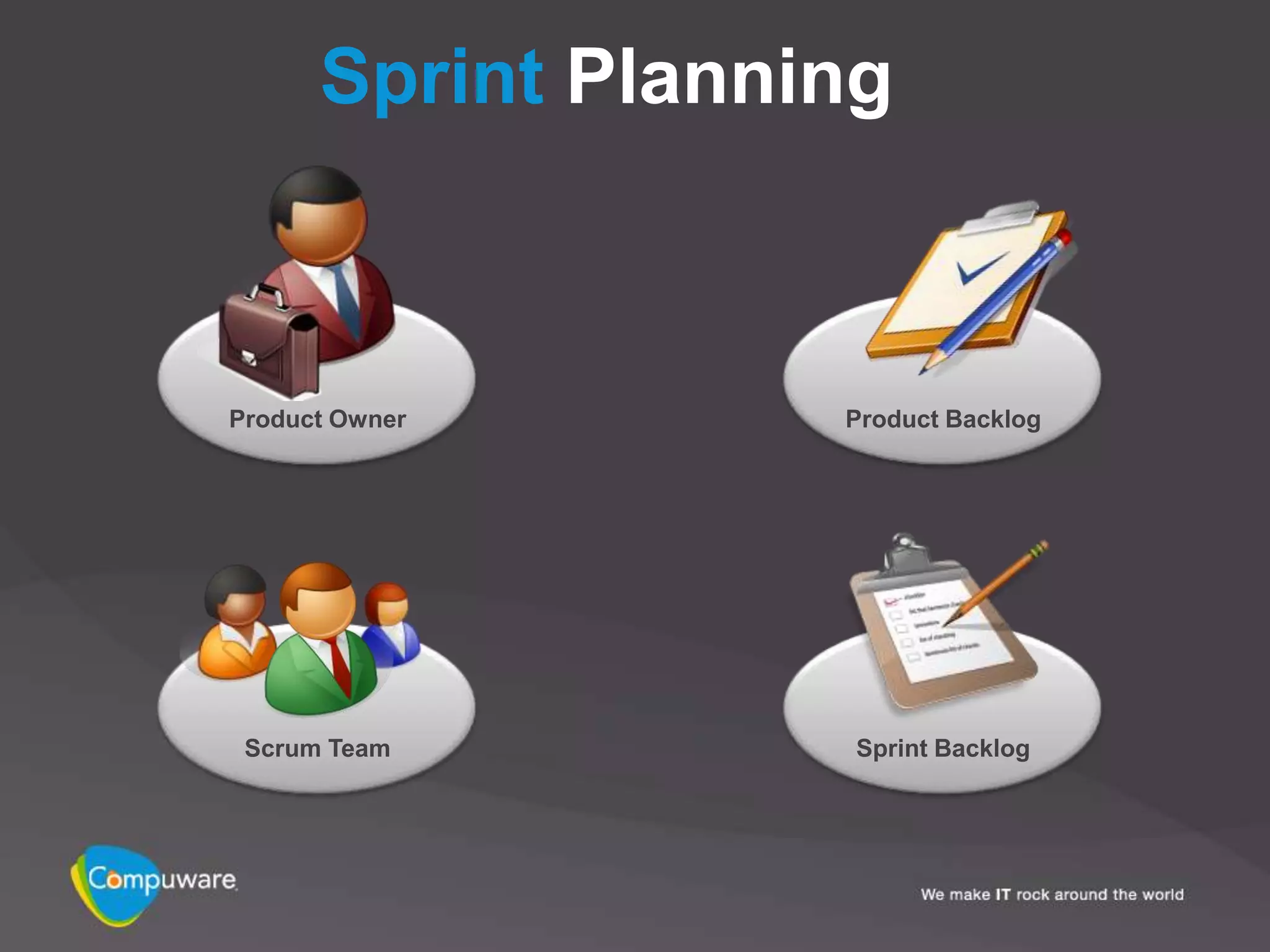

Sprint Planning

Product Owner      Product Backlog

 Scrum Team         Sprint Backlog

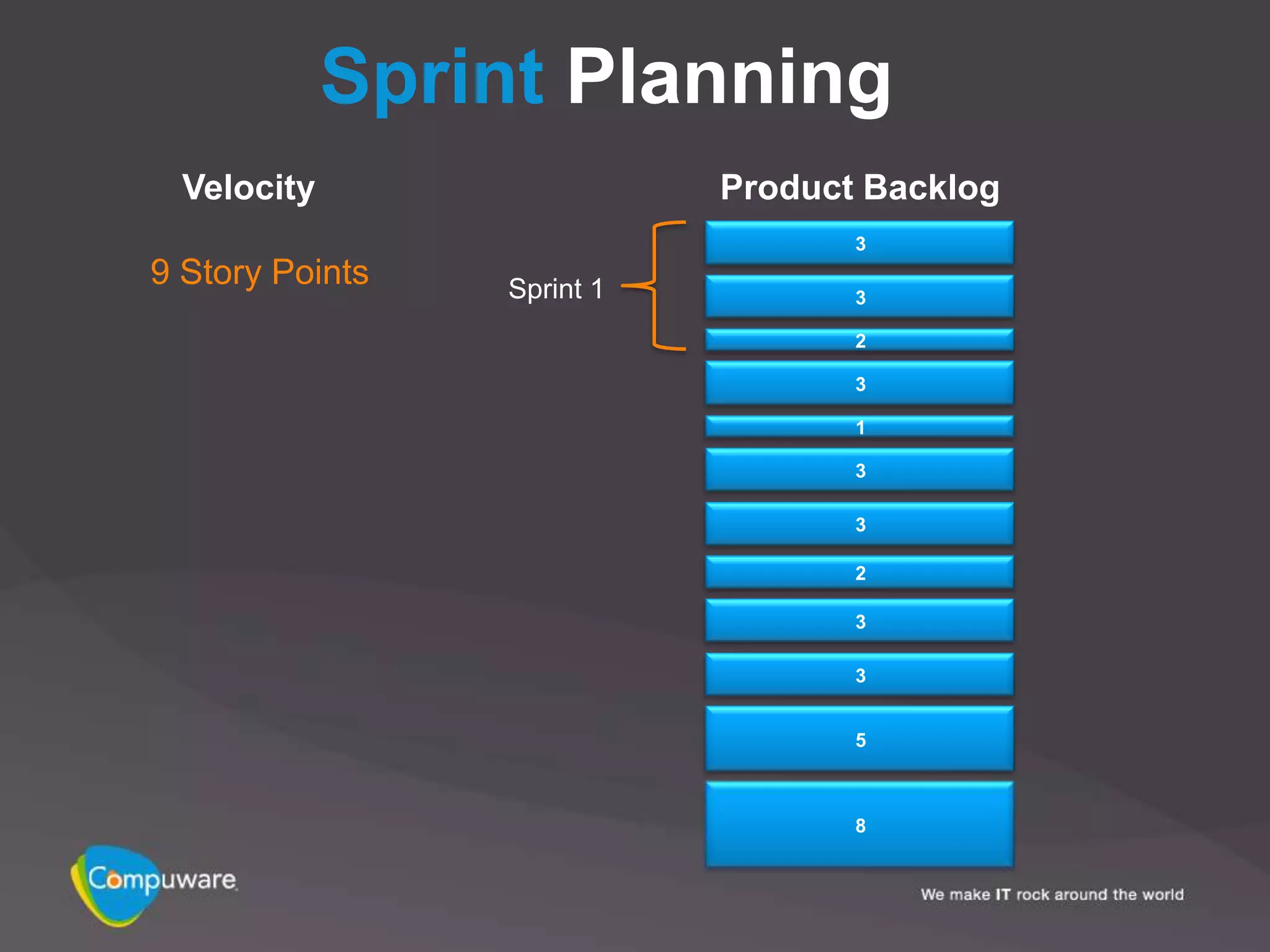

Sprint Planning
  Velocity                  Product Backlog
                                   3
9 Story Points   Sprint 1          3

                                   2

                                   3

                                   1

                                   3

                                   3

                                   2

                                   3

                                   3

                                   5

                                   8

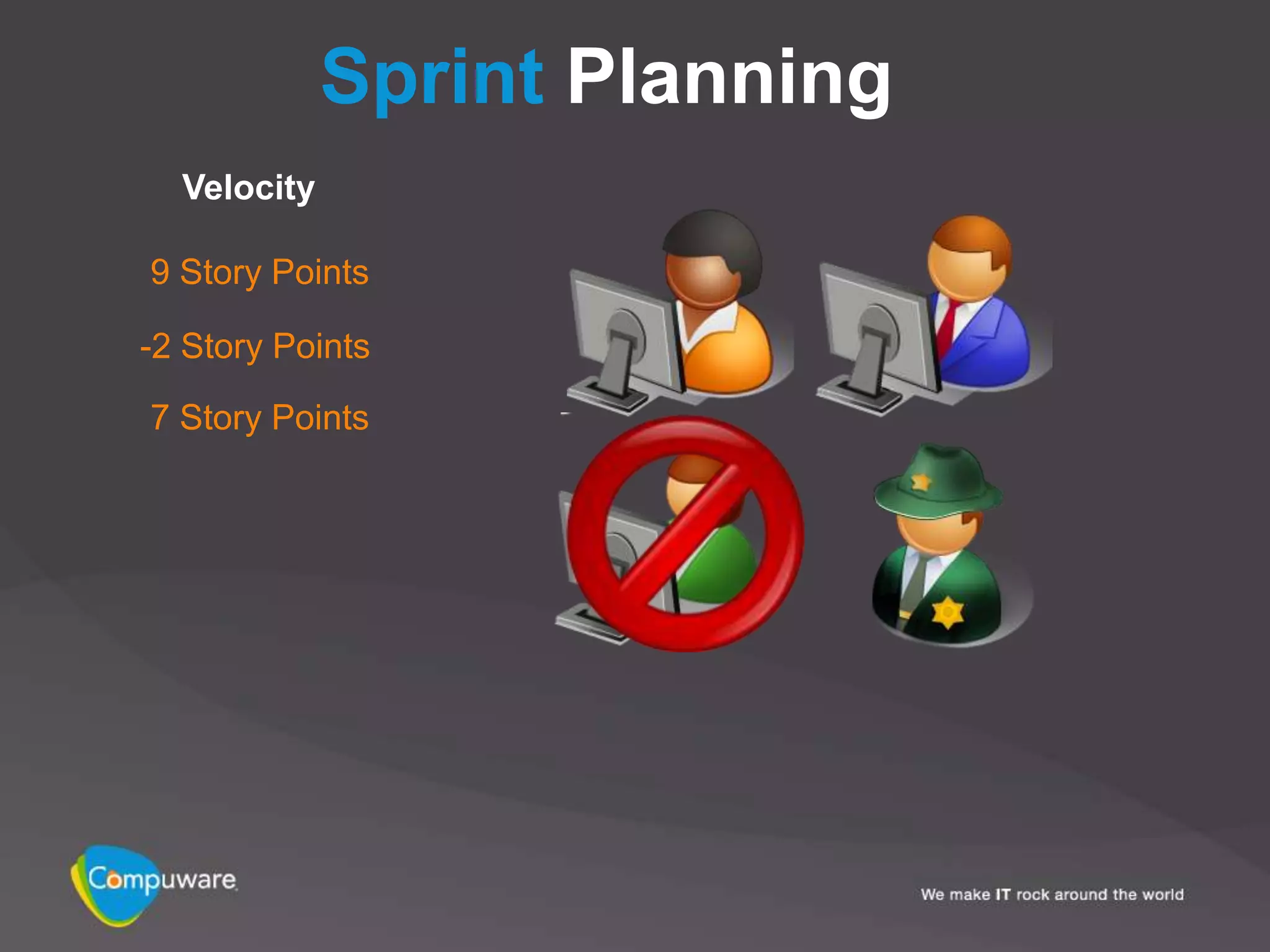

Sprint Planning
  Velocity

9 Story Points

-2 Story Points

7 Story Points
Sprint Planning

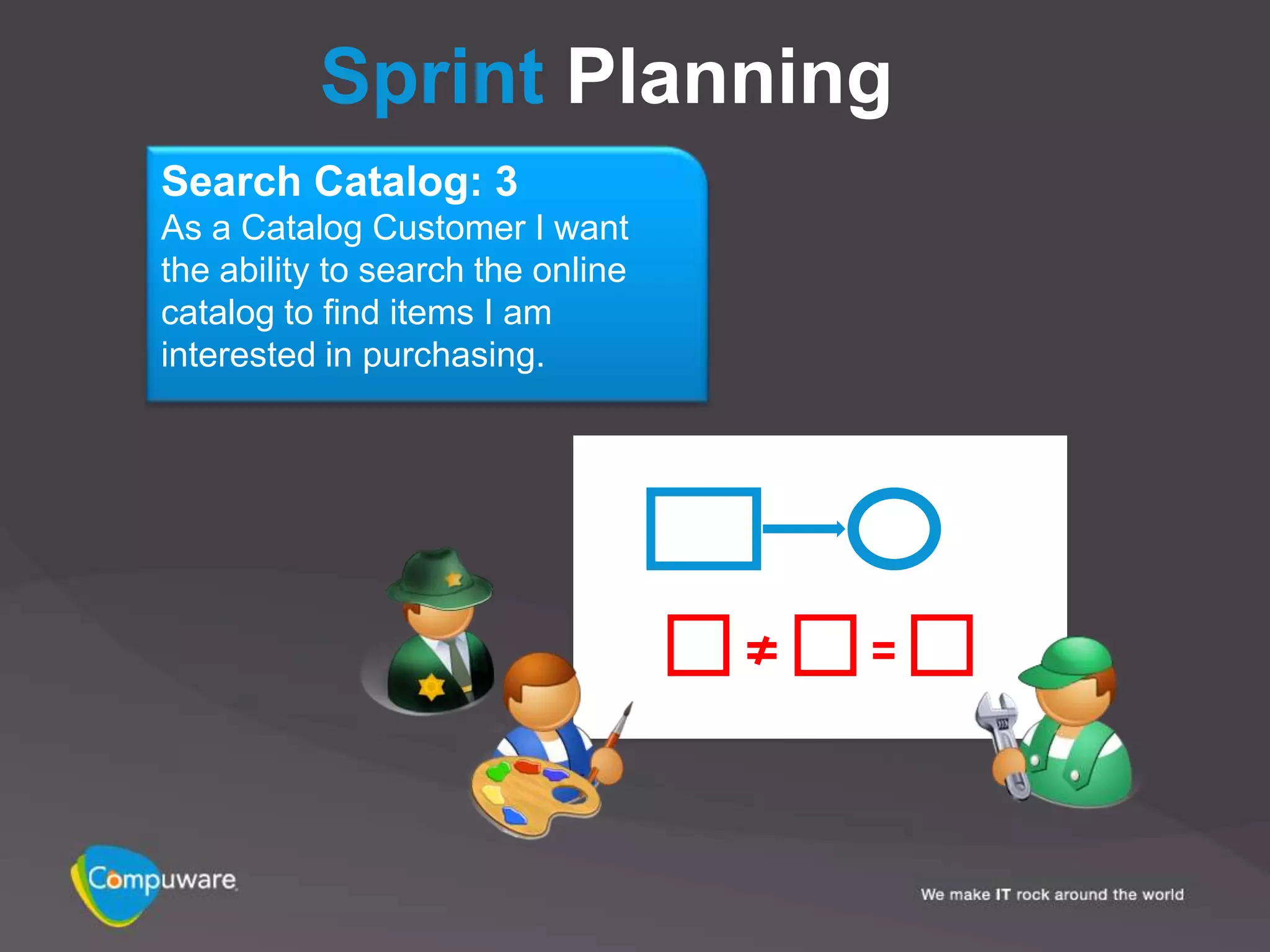

Search Catalog: 3
As a Catalog Customer I want
the ability to search the online
catalog to find items I am
interested in purchasing.

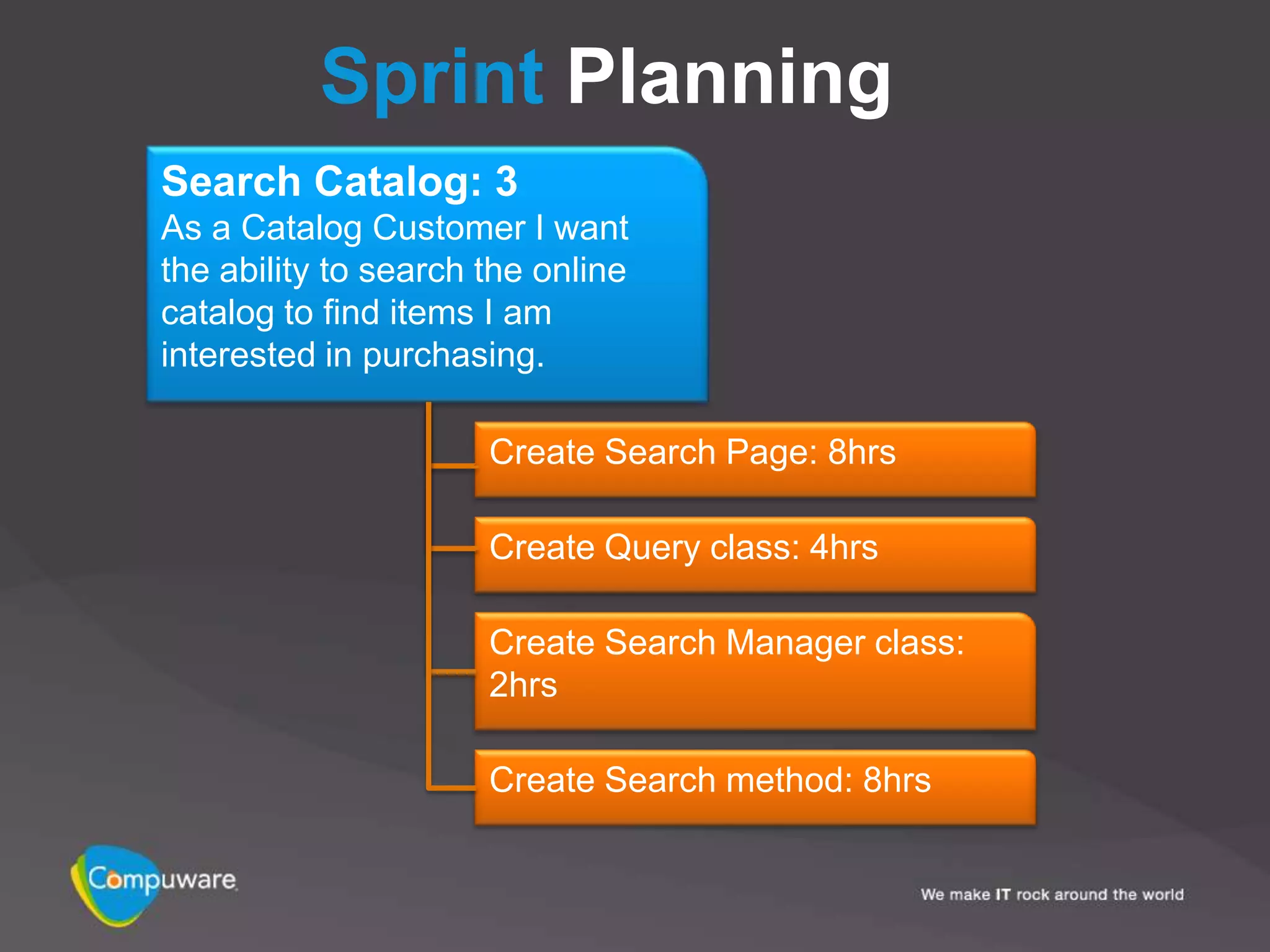

Sprint Planning
Search Catalog: 3
As a Catalog Customer I want
the ability to search the online
catalog to find items I am
interested in purchasing.

                      Create Search Page: 8hrs

                      Create Query class: 4hrs

                      Create Search Manager class:
                      2hrs

                      Create Search method: 8hrs

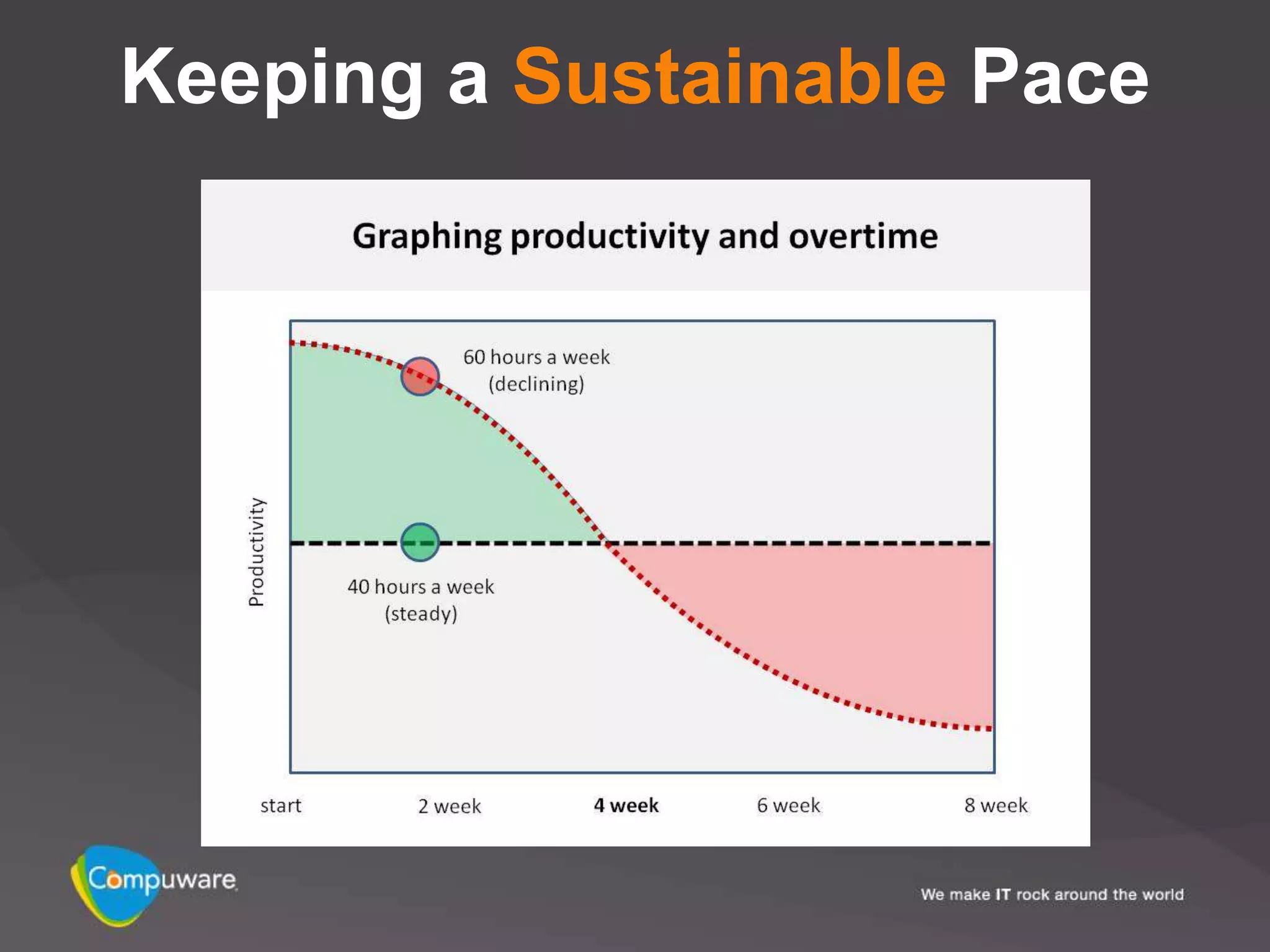

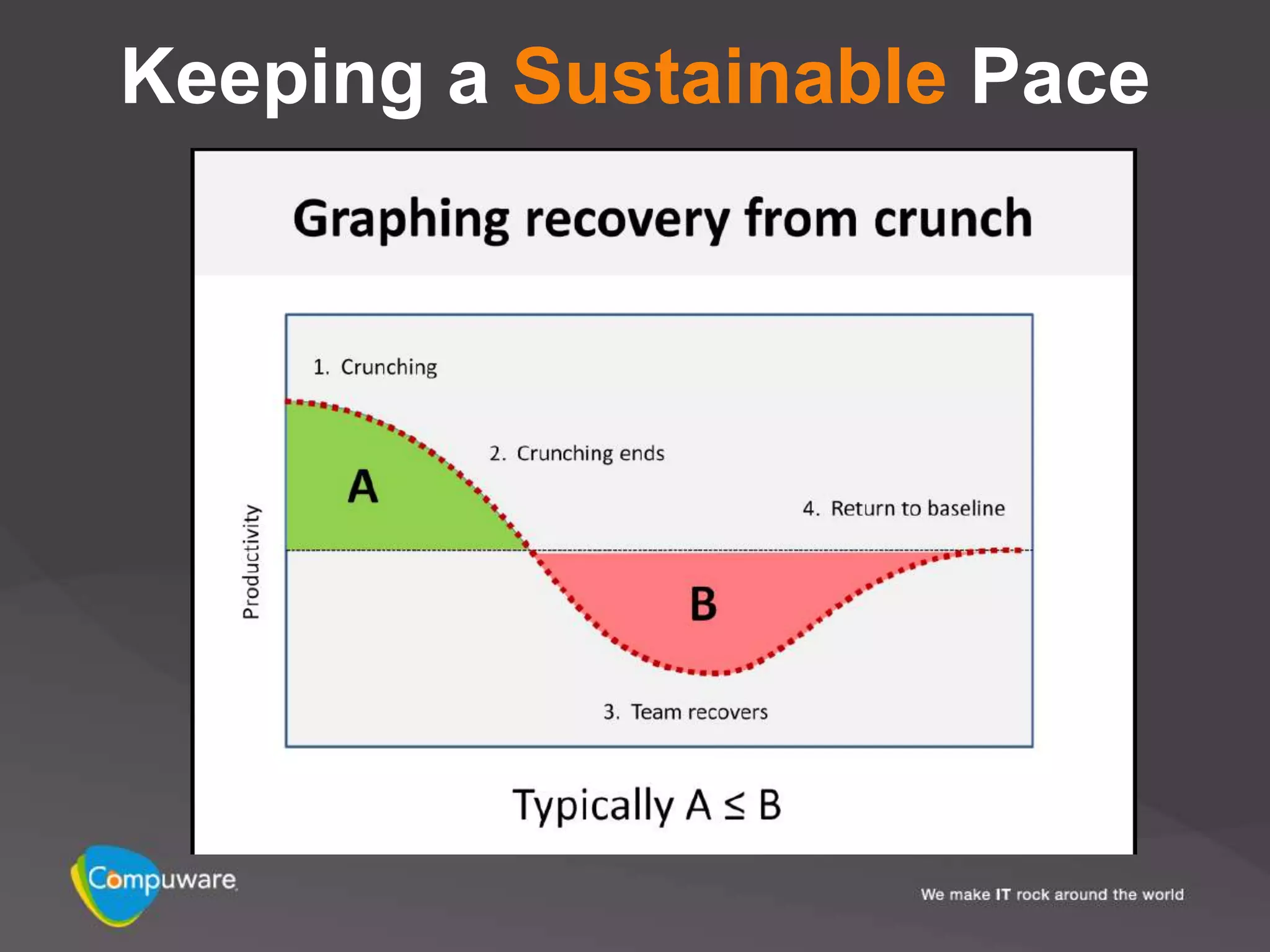

Keeping a Sustainable Pace
Keeping a Sustainable Pace
Sprint

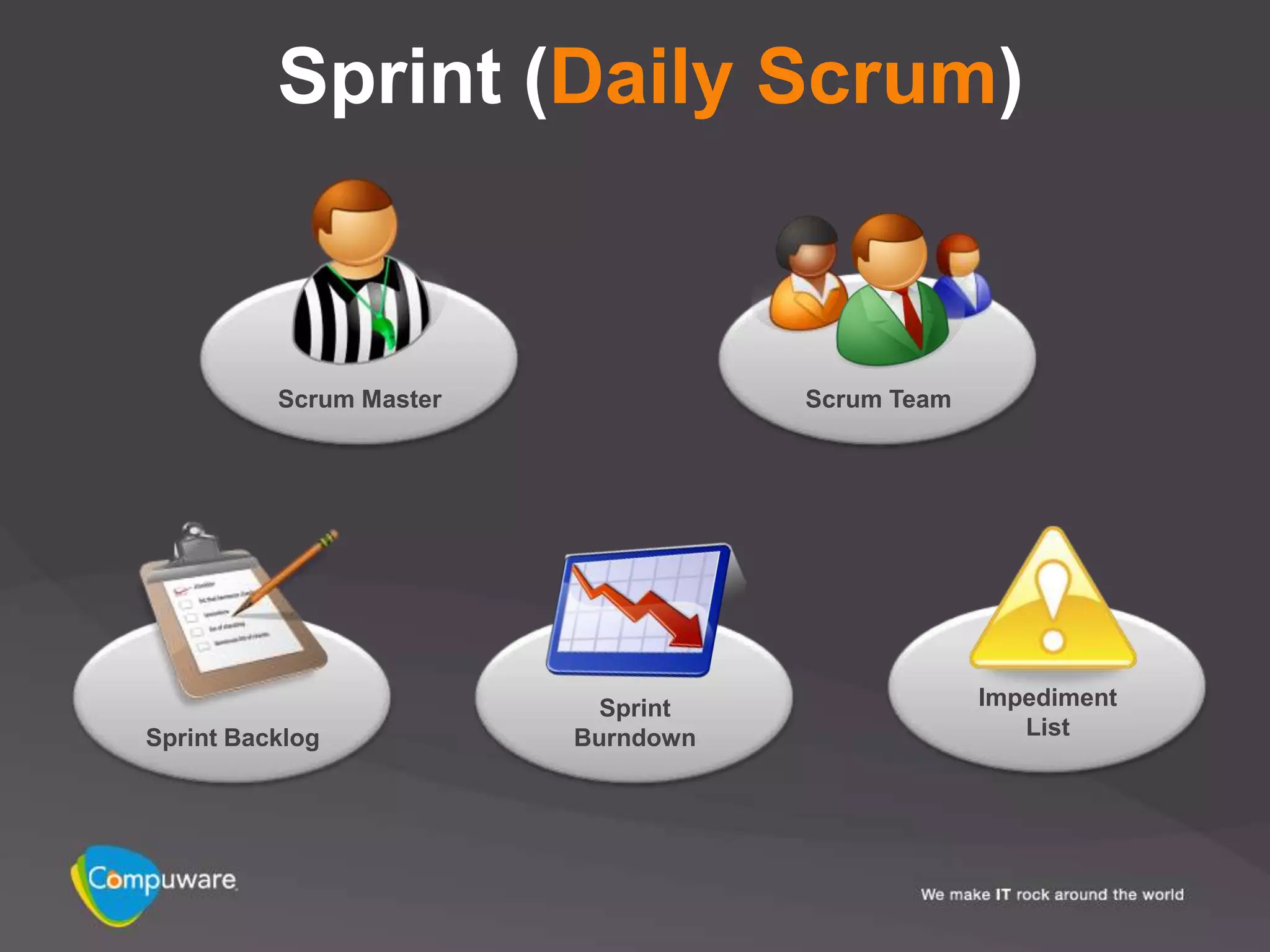

Sprint (Daily Scrum)

          Scrum Master              Scrum Team

                           Sprint                Impediment
Sprint Backlog           Burndown                   List

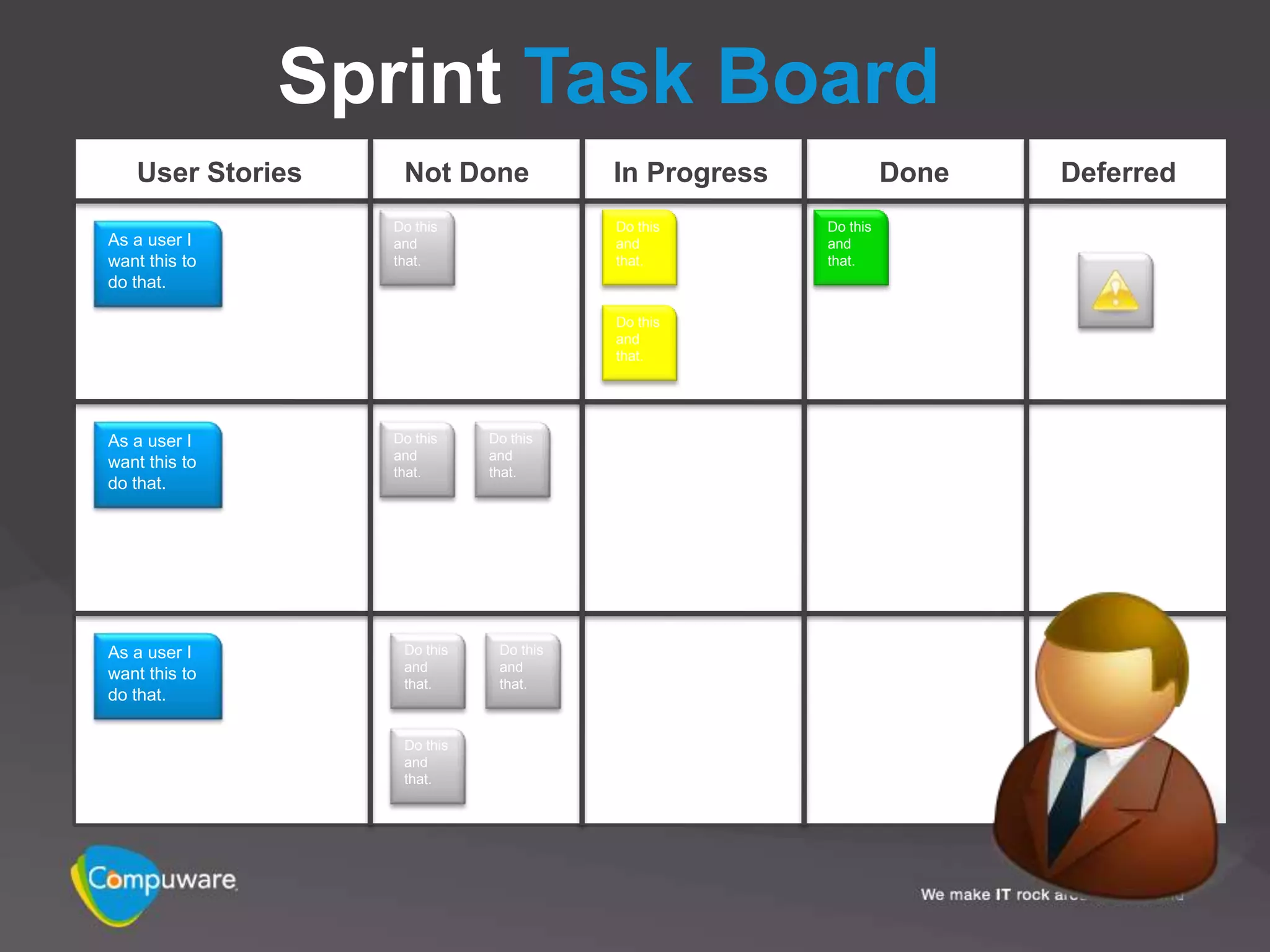

Sprint Task Board
   User Stories    Not Done             In Progress             Done   Deferred
                  Do this               Do this       Do this
As a user I       and                   and           and
want this to      that.                 that.         that.
do that.

                                        Do this
                                        and
                                        that.

As a user I       Do this    Do this
                  and        and
want this to
                  that.      that.
do that.

As a user I        Do this    Do this
                   and        and
want this to
                   that.      that.
do that.

                   Do this
                   and
                   that.

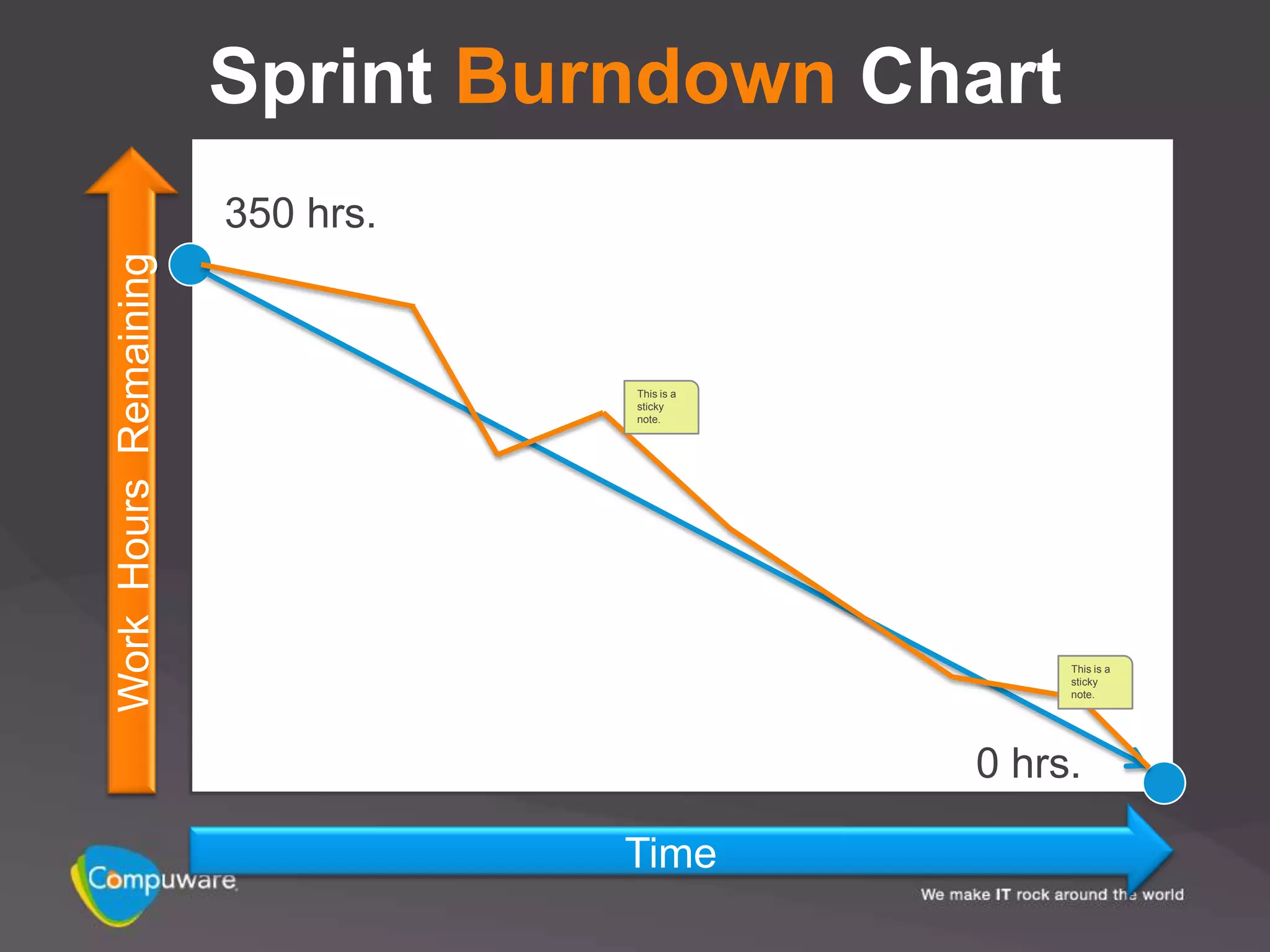

Sprint Burndown Chart
                       350 hrs.
Work Hours Remaining

                                  This is a
                                  sticky
                                  note.

                                                   This is a
                                                   sticky
                                                   note.

                                              0 hrs.

                                  Time
Sprint
Retrospective

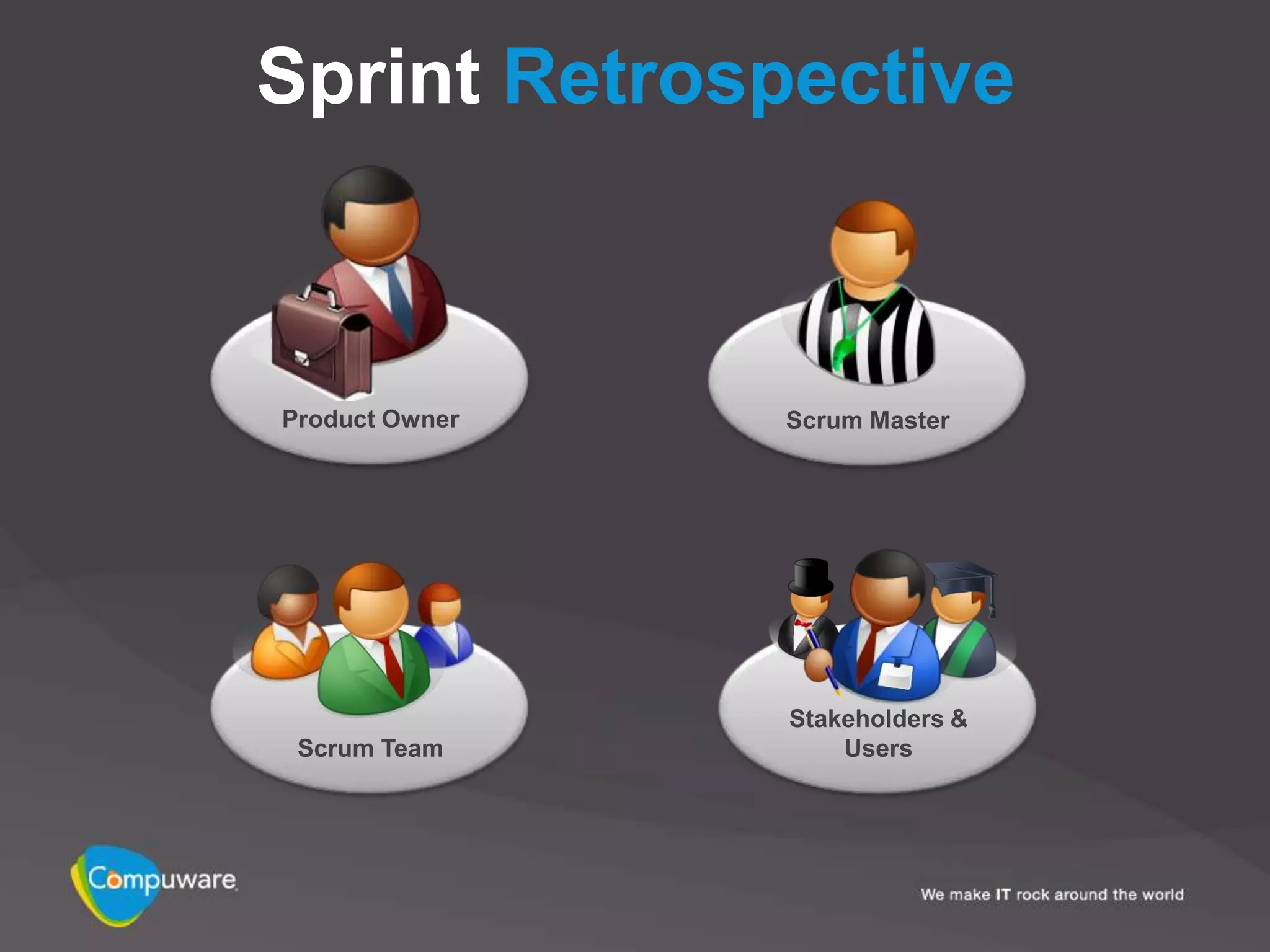

Sprint Retrospective

Product Owner   Scrum Master

                Stakeholders &
 Scrum Team         Users
“No plan of battle
ever survives
contact with
the enemy.”
Scrum is Iterative

                        Sprint

                                                 Sprint
                                                 Review    Product
 Project
Initiation                                                Increment

              Sprint
             Planning

                                     Sprint
                                 Retrospective
“The plan is meaningless..”
Questions?

             87
THANK
YOU
89

© 2008 Compuware Corporation — All Rights Reserved

Agile Estimating and Planning Using Scrum
